Billing system getting paid on a government contract 16 april 2014

BILLING SYSTEM:Getting Paid on a Government Contract16 April 2014

Announcements

ANNOUNCEMENTS

Billing system getting paid on a government contract 16 april 2014

Trish Carlin, CPASr. Consultant, Carlin Consulting GroupJoshua HarlorSupervisory Auditor, Defense Contract Audit AgencyLinda HildebrantDirector of CAS Compliance, Morpho DetectionDale EnglishSupervisory Contract Specialist, NAVFAC SW

Billing system getting paid on a government contract 16 april 2014

BILLING CYCLE

Billing system getting paid on a government contract 16 april 2014

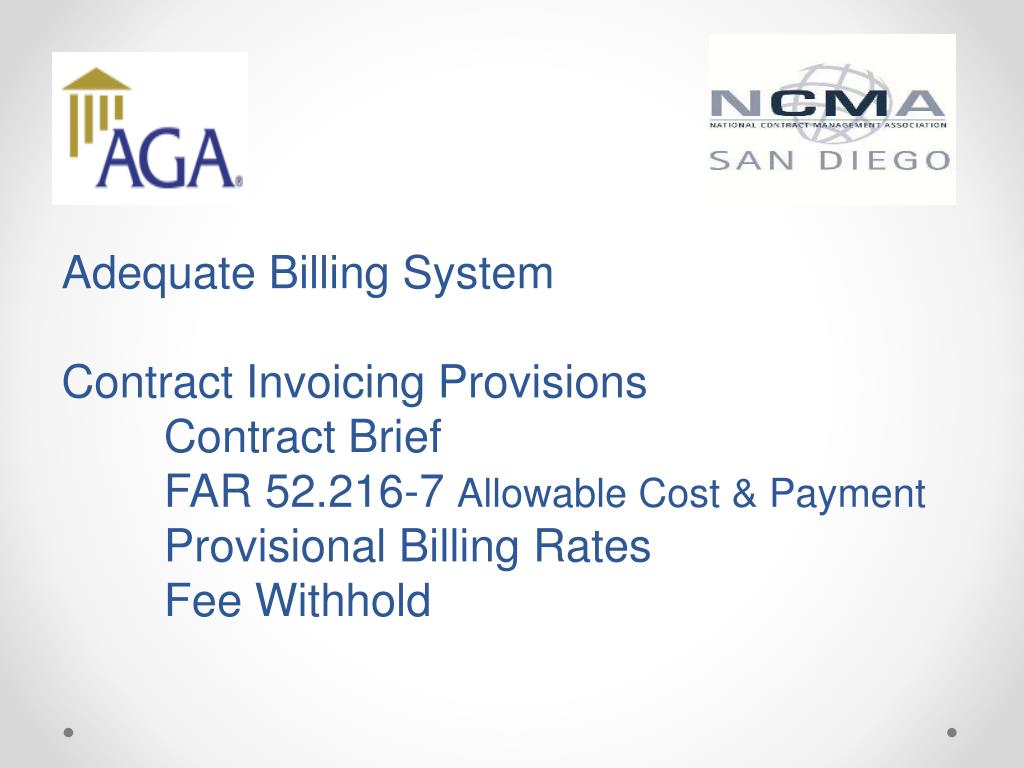

Adequate Billing SystemContract Invoicing ProvisionsContract BriefFAR 52.216-7 Allowable Cost & PaymentProvisional Billing RatesFee Withhold

Billing system getting paid on a government contract 16 april 2014

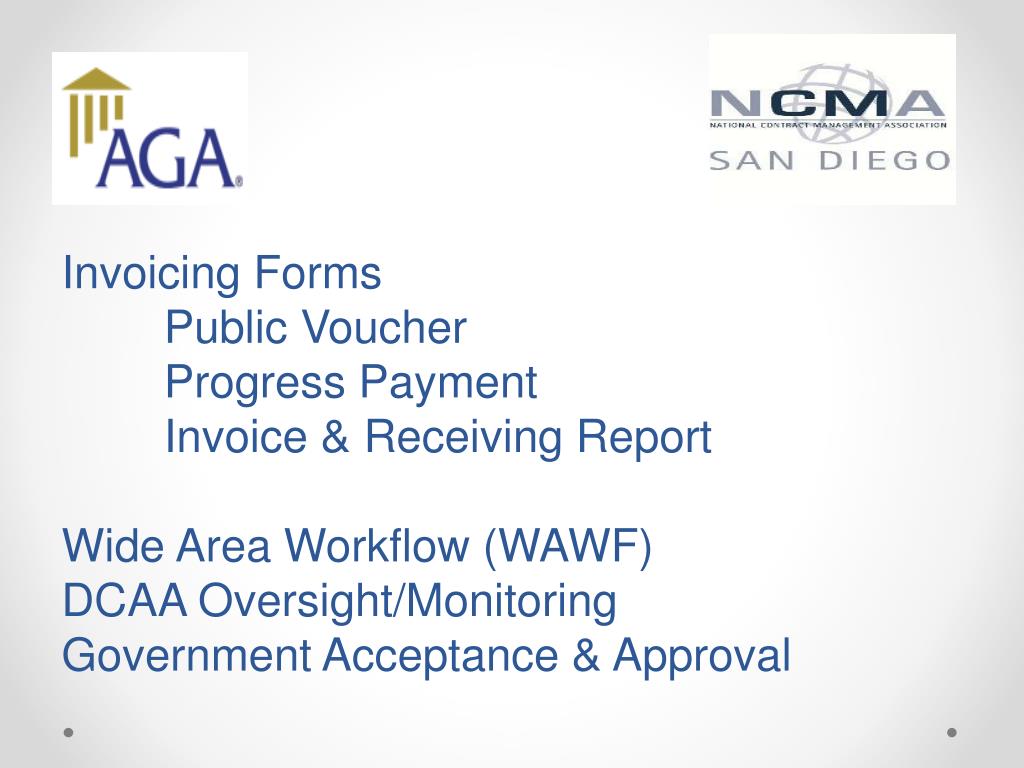

Invoicing FormsPublic VoucherProgress PaymentInvoice & Receiving ReportWide Area Workflow (WAWF)DCAA Oversight/MonitoringGovernment Acceptance & Approval

Adequate billing system

Adequate Billing System

Dfars business system final rule dfars 252 242 7005

DFARS Business System Final RuleDFARS 252.242-7005

Elements of an adequate billing system dcaa contract audit manual 5 1100

Elements of an Adequate Billing SystemDCAA Contract Audit Manual 5-1100

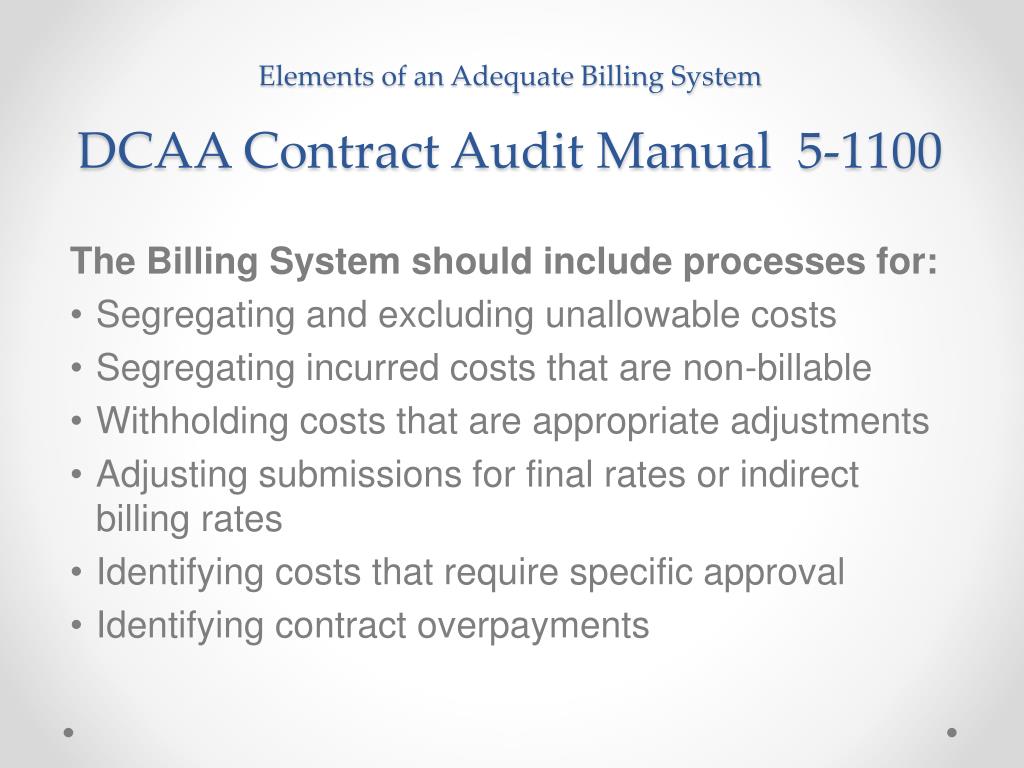

BillingSystemshould provide reasonable assurance that billings applicable to Government contracts are prepared in accordance with applicable laws and regulations, and contract terms; and that material misstatements are prevented, or detected and corrected in a timely manner.

Elements of an adequate billing system dcaa contract audit manual 5 11001

Elements of an Adequate Billing SystemDCAA Contract Audit Manual 5-1100

The Billing System should include processes for:

  • Segregating and excluding unallowable costs

  • Segregating incurred costs that are non-billable

  • Withholding costs that are appropriate adjustments

  • Adjusting submissions for final rates or indirect billing rates

  • Identifying costs that require specific approval

  • Identifying contract overpayments

Elements of an adequate billing system dcaa contract audit manual 5 11002

Elements of an Adequate Billing SystemDCAA Contract Audit Manual 5-1100

Key Processes Include:

Billing system policies and procedures

Billing reviews and approvals

Training of employees

Contract briefings

Elements of an adequate billing system dcaa contract audit manual 5 11003

Elements of an Adequate Billing SystemDCAA Contract Audit Manual 5-1100

Key Processes Include

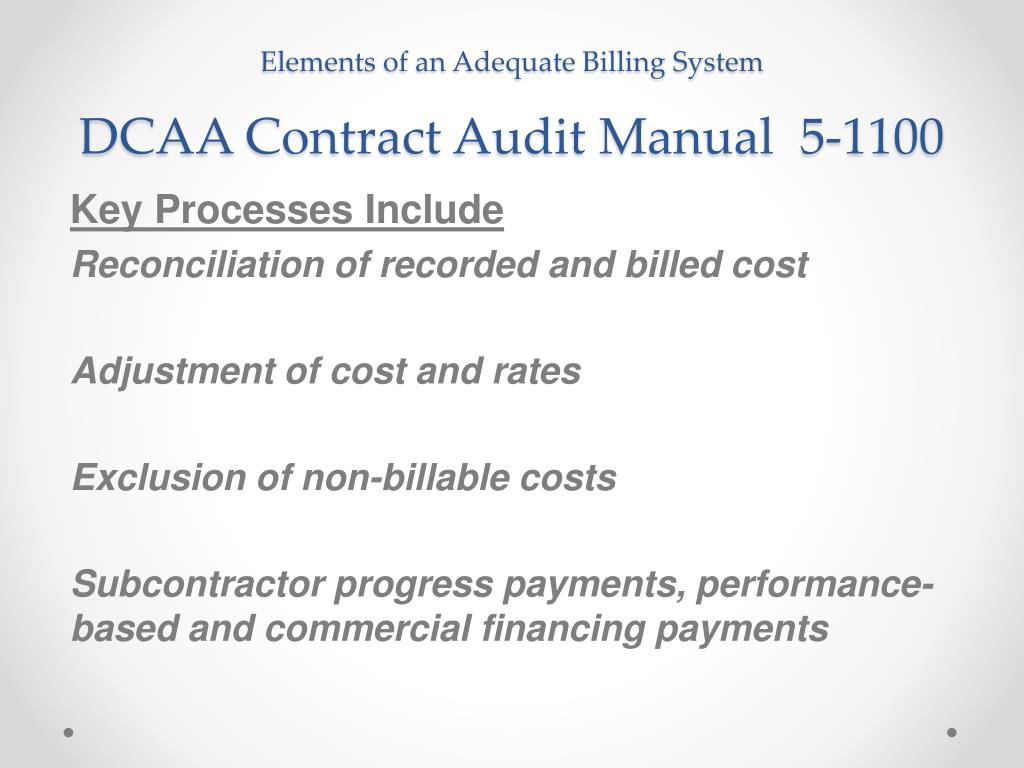

Reconciliation of recorded and billed cost

Adjustment of cost and rates

Exclusion of non-billable costs

Subcontractor progress payments, performance-based and commercial financing payments

Elements of an adequate billing system dcaa contract audit manual 5 11004

Elements of an Adequate Billing SystemDCAA Contract Audit Manual 5-1100

Key Processes Include

Estimate to complete, estimate of costs of delivered/invoiced items

Loss contract procedures

Contract overpayments, refunds and offsets

Billing system – IT system internal controls

Contract brief dcaa contract brief guidance dcaa contract brief templates

Contract BriefDCAA Contract brief guidanceDCAA Contract brief templates

Billing system getting paid on a government contract 16 april 2014

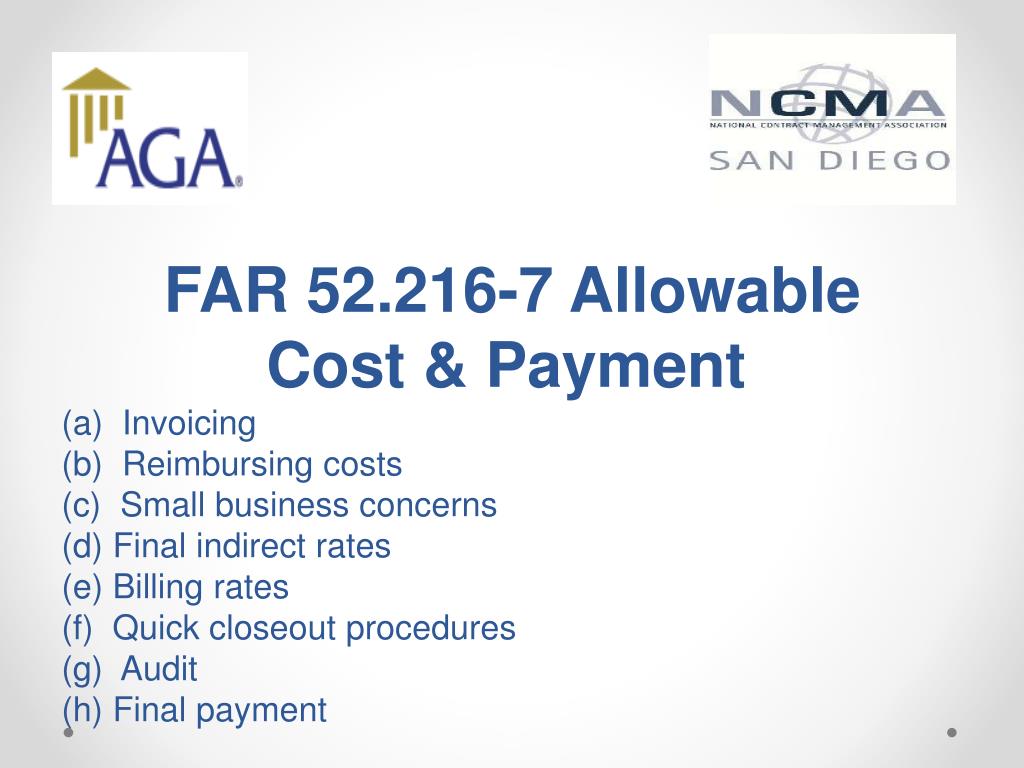

FAR 52.216-7 Allowable Cost & Payment(a) Invoicing(b) Reimbursing costs(c) Small business concerns(d) Final indirect rates(e) Billing rates(f) Quick closeout procedures(g) Audit(h) Final payment

Billing system getting paid on a government contract 16 april 2014

Provisional Billing RatesPurpose of Provisional Billing Rates (PBRs)What are the procedures for establishing PBRs?When should we submit?What information should we provide?DCAA reviewMonitoringCommon deficienciesFrequently asked questions

Purpose of pbrs

Purpose of PBRs

One criterion for an adequate accounting system is that it provide for billings that can be reconciled to the cost accounts for both current and cumulative amounts claimed and comply with contract terms. Interim payments on cost-type contracts are allowed as specified in the contract provisions.

Reimbursement of indirect costs in these interim payments is generally made through provisional billing rates.

Provisional Billing Rates are established to approximate the contractor’s final year-end rates, as adjusted for any unallowable costs.

Provisional Billing Rates are used for interim purposes until settlement is reached on the final indirect rates for the contractor’s fiscal year.

FAR 42.704-Billing Rates-provides procedures and guidance for establishing PBRs.

Reasons for contractor submission

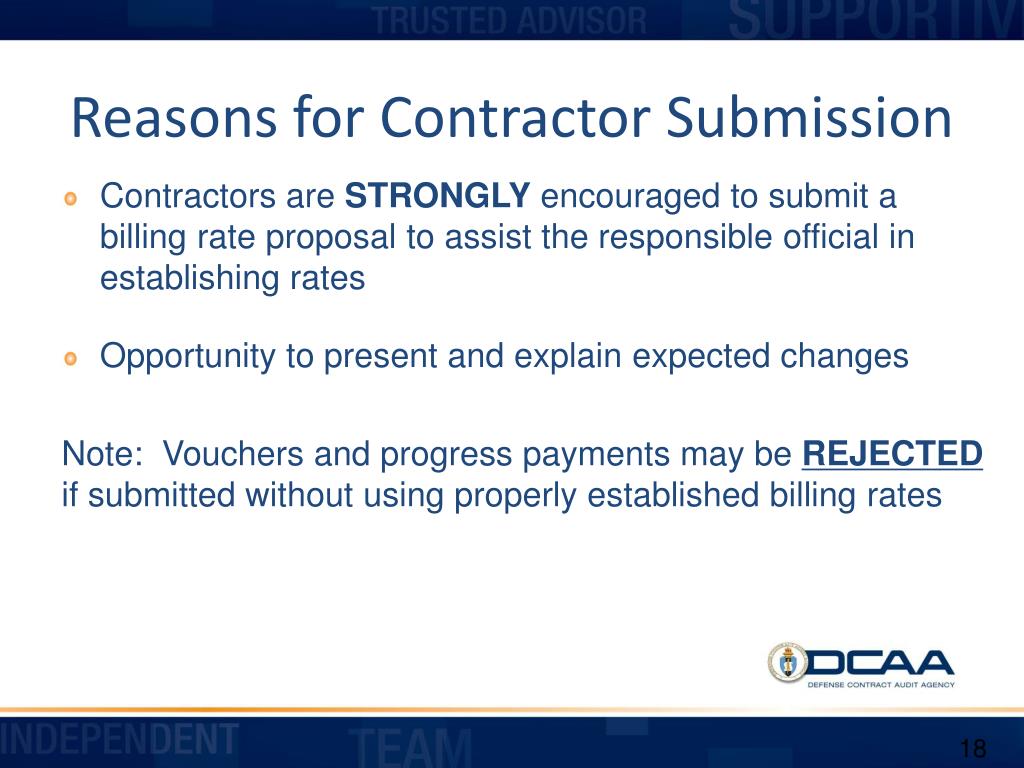

Reasons for Contractor Submission

  • Contractors are STRONGLY encouraged to submit a billing rate proposal to assist the responsible official in establishing rates

  • Opportunity to present and explain expected changes

    Note: Vouchers and progress payments may be REJECTEDif submitted without using properly established billing rates

Procedures for establishing billing rates

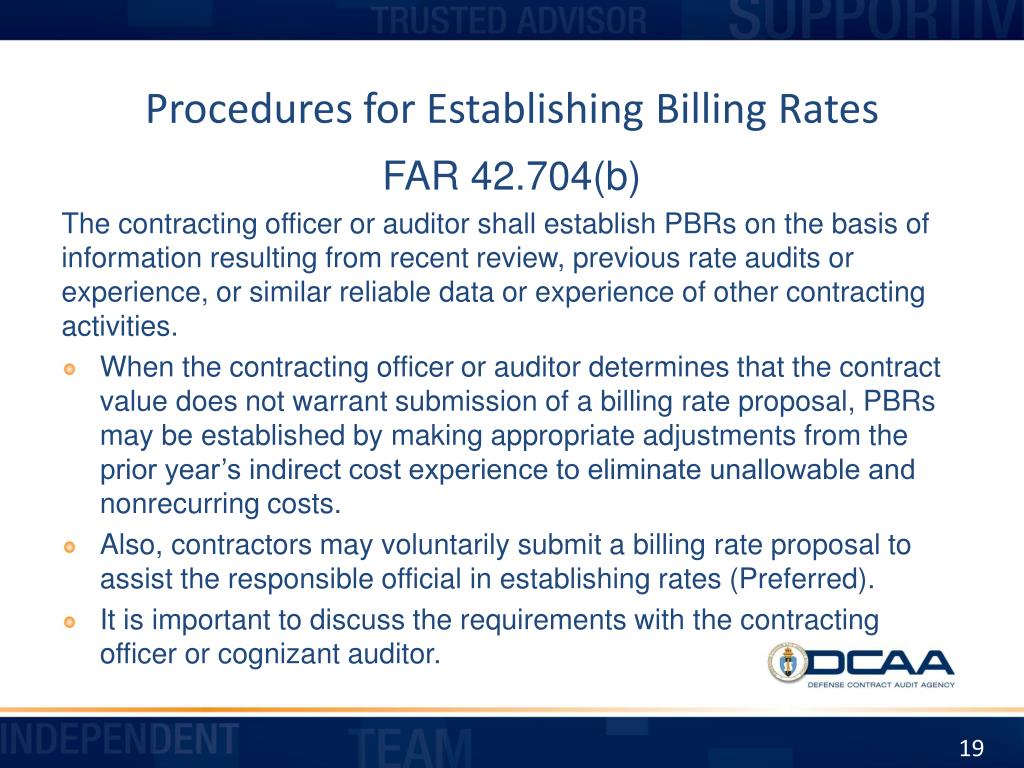

Procedures for Establishing Billing Rates

FAR 42.704(b)

The contracting officer or auditor shall establish PBRs on the basis of information resulting from recent review, previous rate audits or experience, or similar reliable data or experience of other contracting activities.

When the contracting officer or auditor determines that the contract value does not warrant submission of a billing rate proposal, PBRs may be established by making appropriate adjustments from the prior year’s indirect cost experience to eliminate unallowable and nonrecurring costs.

Also, contractors may voluntarily submit a billing rate proposal to assist the responsible official in establishing rates (Preferred).

It is important to discuss the requirements with the contracting officer or cognizant auditor.

Procedures for submission

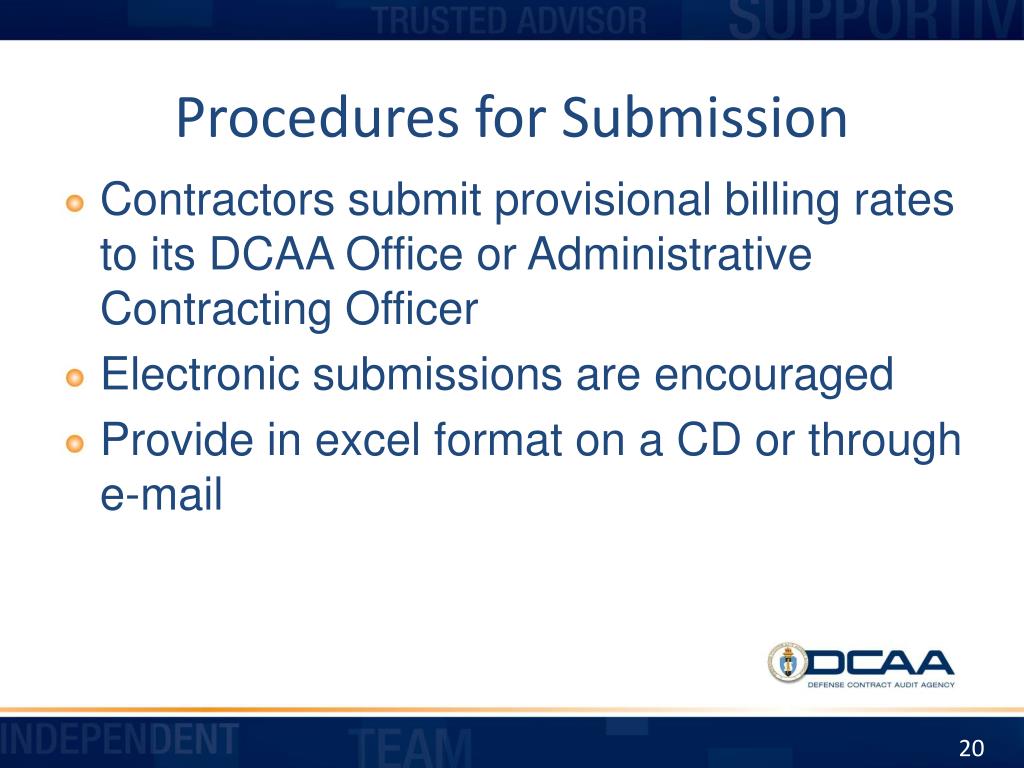

Procedures for Submission

Contractors submit provisional billing rates to its DCAA Office or Administrative Contracting Officer

Electronic submissions are encouraged

Provide in excel format on a CD or through e-mail

When should we submit

When Should We Submit?

Prior to the beginning of the fiscal year (once budgets are complete) or when the established billing rates are no longer representative of final year end rates due to unforeseen events or circumstances.

The PBRs should represent a 12-month period (the contractor’s fiscal year).

PBRs should be submitted at least annually

Vouchers and progress payments can be returned if submitted without properly established billing rates.

What should we provide in a pbr proposal

What Should We Provide in a PBR Proposal?

Proposed billing rate calculations (Pool and Base) with brief rationale

Prior fiscal year (FY) pool and base

Current FY to date pool and base

Current FY budget pool and base, if available

Comparative analysis withexplanation of any significant differences

Dcaa review

DCAA Review

  • Some example procedures DCAA may perform include the following:

    • Compare proposed pool and base to prior year and year-to-date pool and bases.

    • Review trend of questioned costs in relevant incurred cost audits and consider an adjustment for unallowable expenses in calculating current year provisional billing rates.

Monitoring

Monitoring

  • PBRs should be monitored:

    • Throughout the year

    • Immediately after year-end

    • Upon submission of the final indirect rate proposal

  • PBRs may be adjusted by either party at any time to prevent substantial under or over payment – FAR 42.704(c).

  • If PBRs are adjusted, the contractor should submit adjustment vouchers accordingly.

Adjustment

Adjustment

  • Submit a letter with new rates, an explanation as to what caused the change, and with supporting data

  • If DCAA/DCMA has NOT issued a memo:

    • Begin using the new rates immediately

  • If DCAA/DCMA HAS issued a memo:

    • Continue using the rates as listed on the memo unless you receive a new memo from DCAA/DCMA

      • Please contact your cognizant office if you have concerns

        NOTE: If PBRs are adjusted, use the new rate on the current year cumulative expenses

  • Common deficiencies

    Common Deficiencies

    • Failure to remove unallowable costs from the billing rate projections.

    • Failure to adjust provisional billing rates based on actual experience:

      • Before year end, if there are known or reasonably anticipated significant variances.

      • After year end once actual rates, net of unallowable expenses, are calculated.

    Frequently asked questions

    Frequently Asked Questions

    • Do I submit the Provisional Billing Rate Proposal to the ACO or DCAA Office?

      • FAR 42.704 indicates the office responsible for final indirect cost rates also establishes provisional billing rates.

      • If final rates are ACO determined, submit to that office.

      • If final rates are audit determined, submit to local DCAA Office.

    Frequently asked questions1

    Frequently Asked Questions

    • Can I use just use the most recent FY ended rates for provisional billing purposes?

      • No. However, the responsible official may establish the billing rates based on prior year history less unallowable costs.

      • If budgetary data is available, your proposed billing rates may be based on the budget less the estimated unallowable costs.

    • Once provisional billing rates are established with DCAA or the ACO, do I need to submit proposed changes based on new information?

      • YES. The contractor should submit new proposed billing rates when known or reasonably anticipated significant variances have occurred.

    Billing system getting paid on a government contract 16 april 2014

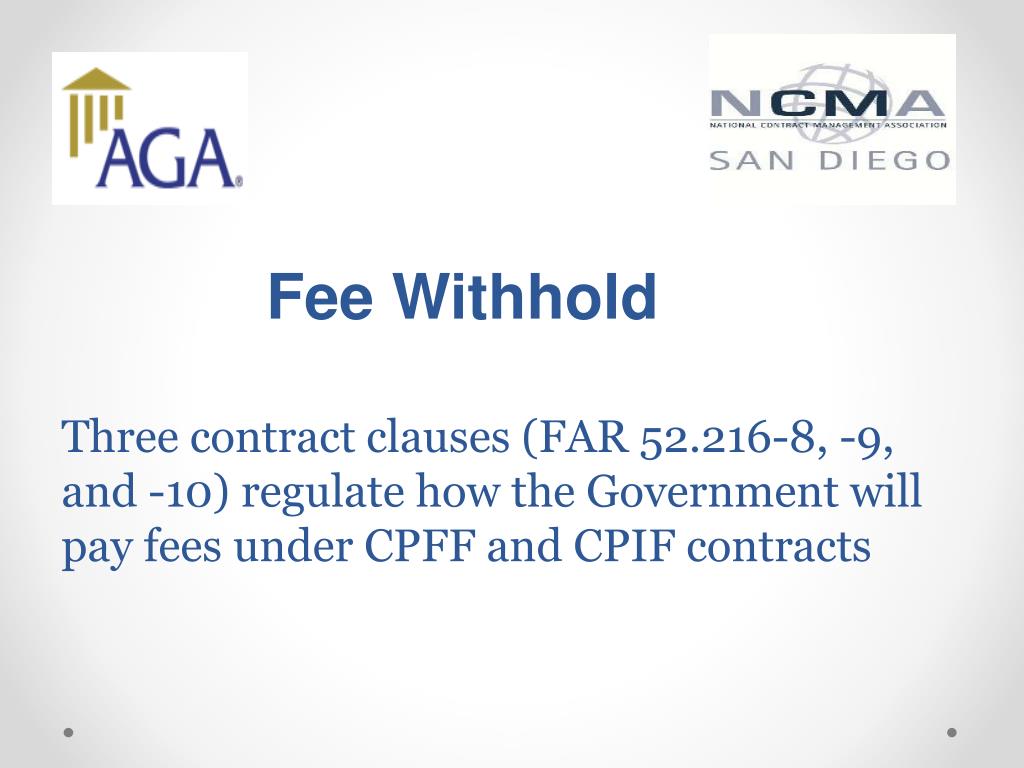

    Fee WithholdThree contract clauses (FAR 52.216-8, -9, and -10) regulate how the Government will pay fees under CPFF and CPIF contracts

    Billing system getting paid on a government contract 16 april 2014

    Public VoucherContractor ResponsibilitiesPreparation of VouchersElectronic Submission of VouchersCommon Deficiencies

    Contractor responsibilities

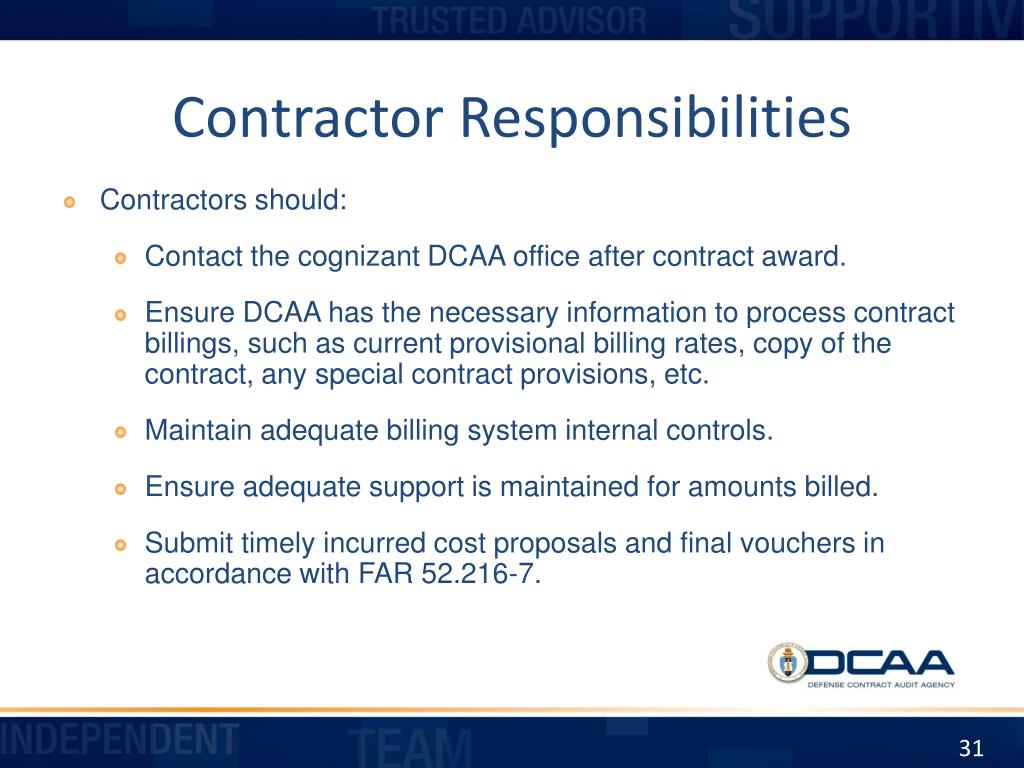

    Contractor Responsibilities

    • Contractors should:

      • Contact the cognizant DCAA office after contract award.

      • Ensure DCAA has the necessary information to process contract billings, such as current provisional billing rates, copy of the contract, any special contract provisions, etc.

      • Maintain adequate billing system internal controls.

      • Ensure adequate support is maintained for amounts billed.

      • Submit timely incurred cost proposals and final vouchers in accordance with FAR 52.216-7.

    Preparation of vouchers

    Preparation of Vouchers

    • The contractor is responsible for preparing and submitting claims for reimbursement according to the terms of the contract.

    • Vouchers should not be submitted more than once every two weeks.

    • Public voucher claims for reimbursement must be prepared on the prescribed Government forms:

      • First voucher on a contract is an interim voucher, as are all subsequent vouchers prior to the final voucher.

      • Final voucher will not be submitted until all contract work is completed. The auditor may provide advice concerning the format for preparing public vouchers and financial representations.

    Electronic submission of interim vouchers

    Electronic Submission of Interim Vouchers

    • Electronic Submission of Interim Vouchers

      • All vouchers should be submitted through WAWF unless contract terms require hard copy vouchers to be submitted.

      • In WAWF, the “Cost Voucher” is the equivalent of the SF 1034. Data equivalent to the SF 1035 must be included in a separate electronic file and attached to the cost voucher in WAWF.

      • Vouchers must be prepared and submitted in accordance with the terms of the contract, including any special billing or payment instructions.

      • Guidance and training for completing a cost voucher invoice can be obtained from the WAWF website at https://wawf.eb.mil.

    Electronic submission of interim vouchers1

    Electronic Submission of Interim Vouchers

    • Electronic Submission of Interim V ouchers examples from DCAA Manual 7641.90, Information for Contractors, located at: http://www.dcaa.mil/DCAAM_7641.90.pdf

    Electronic submission of interim vouchers2

    Electronic Submission of Interim Vouchers

    • Final voucher:

      • Last voucher to be submitted on a contract.

      • A separate completion voucher will be submitted for each individual project or task order for which a separate series of public vouchers has been submitted.

      • In accordance with FAR 52.216-7(d)(5).

    Common deficiencies1

    Common Deficiencies

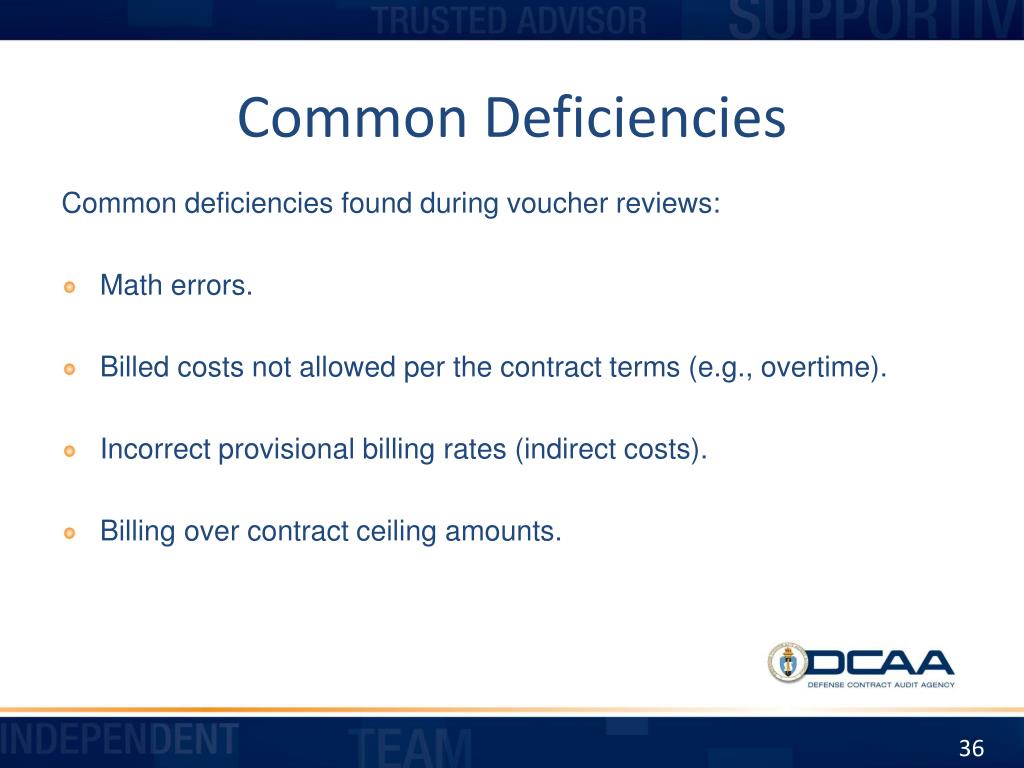

    Common deficiencies found during voucher reviews:

    • Math errors.

    • Billed costs not allowed per the contract terms (e.g., overtime).

    • Incorrect provisional billing rates (indirect costs).

    • Billing over contract ceiling amounts.

    Billing system getting paid on a government contract 16 april 2014

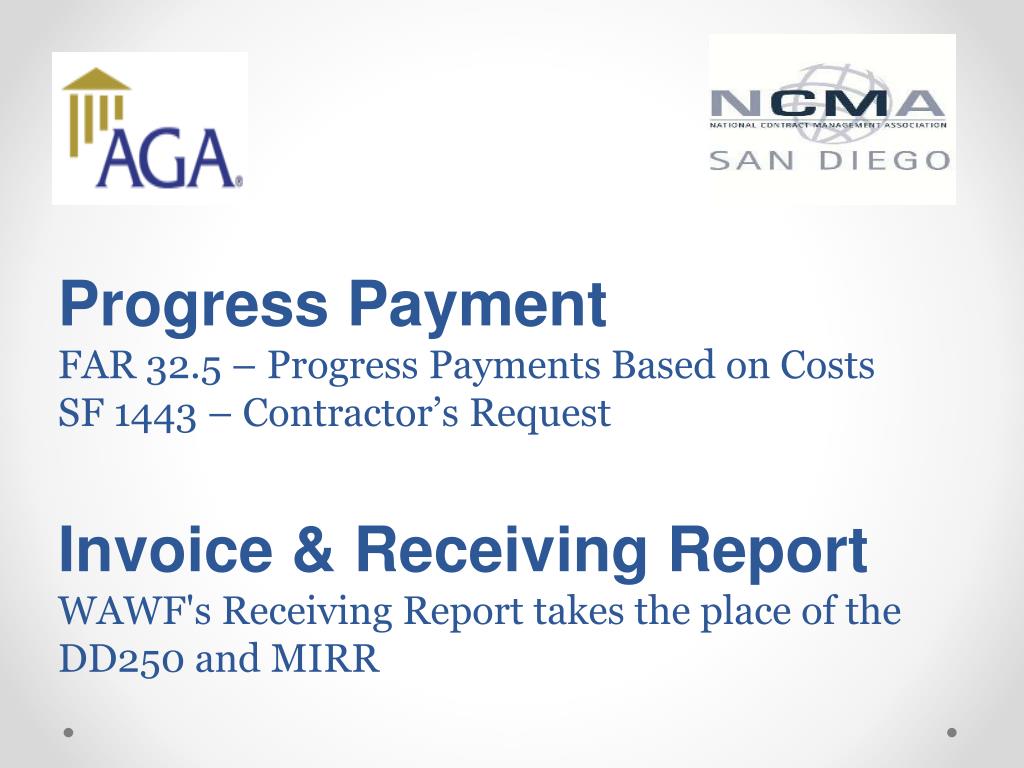

    Progress PaymentFAR 32.5 – Progress Payments Based on CostsSF 1443 – Contractor’s RequestInvoice & Receiving ReportWAWF's Receiving Report takes the place of the DD250 and MIRR

    Wide area workflow wawf

    Wide Area Workflow (WAWF)

    Wide area workflow wawf1

    Wide Area Workflow (WAWF)

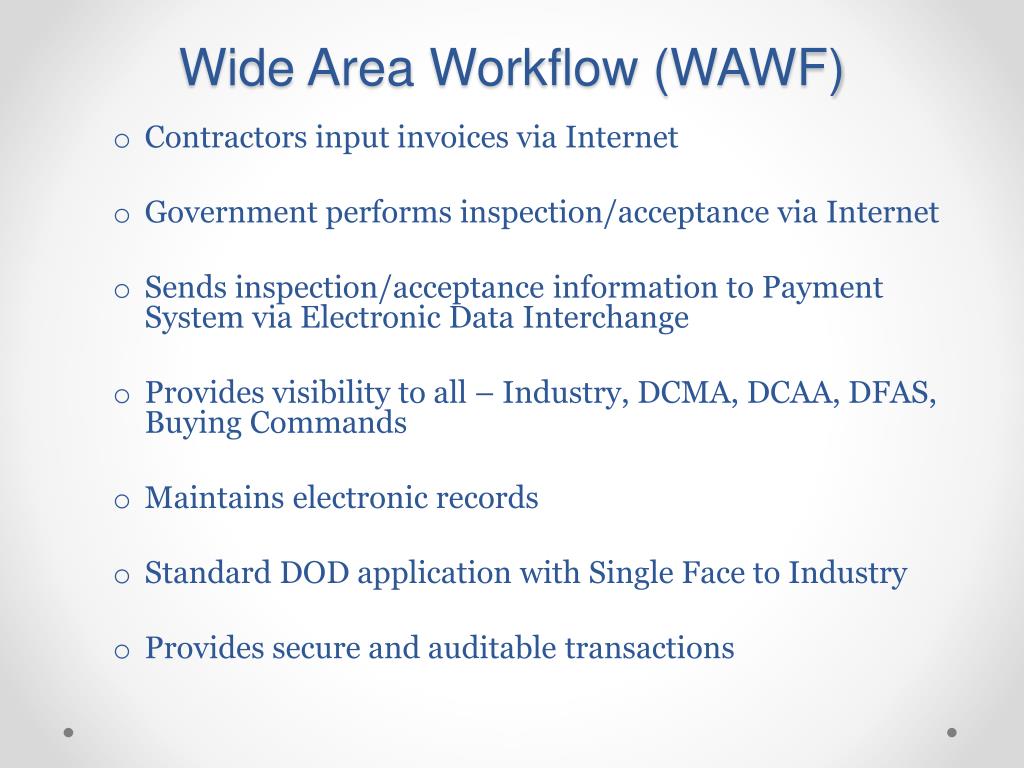

    • Contractors input invoices via Internet

    • Government performs inspection/acceptance via Internet

    • Sends inspection/acceptance information to Payment System via Electronic Data Interchange

    • Provides visibility to all – Industry, DCMA, DCAA, DFAS, Buying Commands

    • Maintains electronic records

    • Standard DOD application with Single Face to Industry

    • Provides secure and auditable transactions

    Wide area workflow wawf2

    Wide Area Workflow (WAWF)

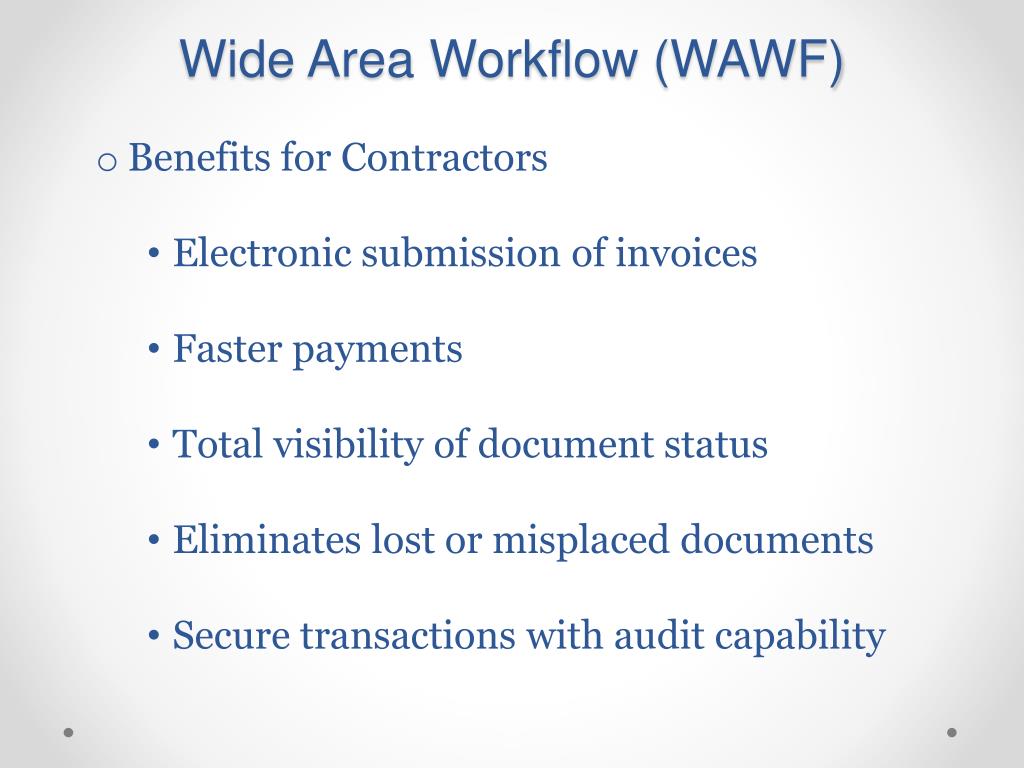

    • Benefits for Contractors

      • Electronic submission of invoices

      • Faster payments

      • Total visibility of document status

      • Eliminates lost or misplaced documents

      • Secure transactions with audit capability

    Billing system getting paid on a government contract 16 april 2014

    Wide Area Workflow (WAWF)Document types used to create, submit, inspect, accept, certify, or process payment on the following document types:Invoice Document Types (Seven)Receiving Report Document Types (Six)Receiving Report and Invoice Document Types (Four)Financing Document Types (Three)Voucher Document Types (Five)Property Document Type (One)

    Billing system getting paid on a government contract 16 april 2014

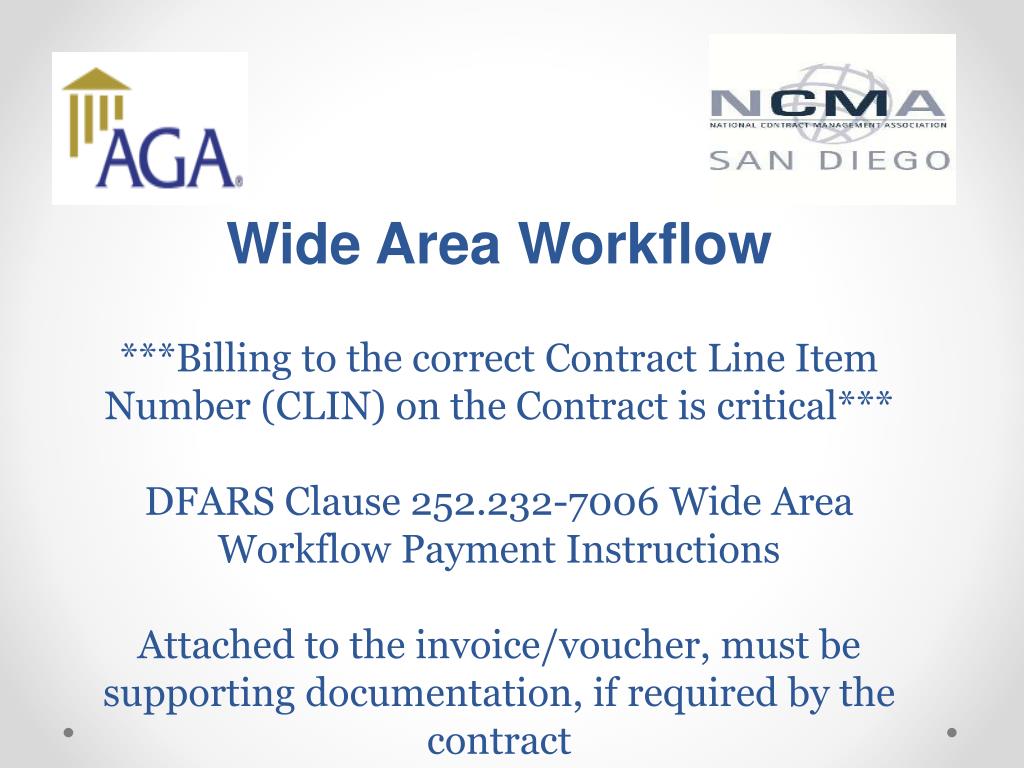

    Wide Area Workflow***Billing to the correct Contract Line Item Number (CLIN) on the Contract is critical***DFARS Clause 252.232-7006 Wide Area Workflow Payment InstructionsAttached to the invoice/voucher, must be supporting documentation, if required by the contract

    Billing system getting paid on a government contract 16 april 2014

    DCAA Oversight/MonitoringPeriodic Audits by DCAA. When contract financing is cost-based, such as interim cost reimbursement (interim vouchers) or cost based progress payments, the billing system and the contract costs are subject to periodic audits by DCAA. DCAA will, at a minimum, verify that the costs billed have been incurred in performance of the contract, that they are in agreement with the accounting records, and that they are in accordance with the contract terms.

    Wide area workflow wawf3

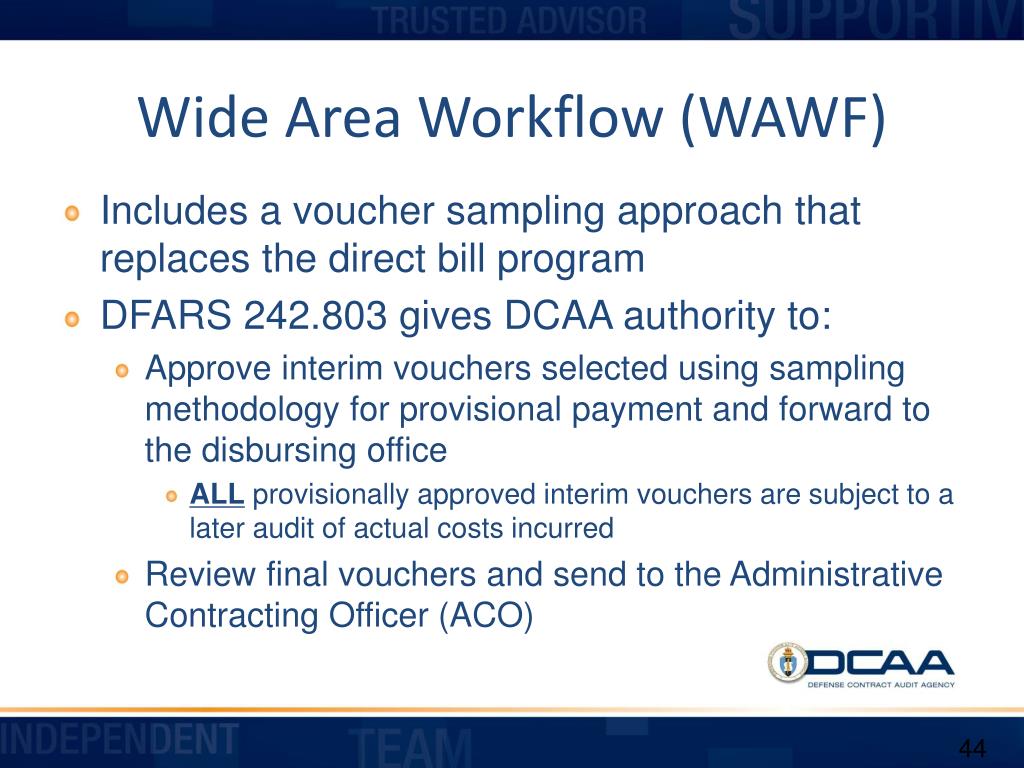

    Wide Area Workflow (WAWF)

    • Includes a voucher sampling approach that replaces the direct bill program

    • DFARS 242.803 gives DCAA authority to:

      • Approve interim vouchers selected using sampling methodology for provisional payment and forward to the disbursing office

        • ALL provisionally approved interim vouchers are subject to a later audit of actual costs incurred

      • Review final vouchers and send to the Administrative Contracting Officer (ACO)

    Government acceptance approval

    Government Acceptance & Approval

    Billing system getting paid on a government contract 16 april 2014

    Vendor

    Bank

    WAWF

    Application

    Submits Shipping

    Reports & Invoices

    WAWF transmits payment actions EDI 810C, 856, & 861 via GEX to DoD pay system

    EDI

    FTP Data Upload

    EFT

    Web Input using Web Forms

    DoD Pay

    Systems

    Internet

    Internet

    Authorize transfer of funds

    Via EFT to Vendor’s bank

    Inspecting Activity

    Payment Office

    Local Processing Office

    • Receives email notificationof awaiting actions

    • Inspects / rejects using Web Forms online in WAWF

    Accepting / Receiving Activity

    • Receives email notificationof awaiting actions

    • Pays or rejects invoicesusing Web Forms onlinein WAWF

    • Receives email notificationof awaiting actions

    • Certifies invoices ready for payment in WAWF

    • Receives email notificationof awaiting actions

    • Accepts / rejects using Web Forms online in WAWF

    Billing system getting paid on a government contract 16 april 2014

    Invoice requirements are listed in The Federal Acquisition Regulations (FAR) (FAR Part 32.905).  Company must be registered in System for Award Management to receive electronic payments (EFT) (https://sam.gov)Federal Agencies use different electronic payment systems such as: - Wide Area Work Flow (WAWF) - DoD- PayWeb - ONR -Payment Management System (PMS) – DHHS

    Billing system getting paid on a government contract 16 april 2014

    Be proactive before submitting invoice:- Read your contract- Understand your contract- Ask questions of your Contract Specialist- Follow the invoicing instructions- Know who is responsible for actions needed- Monitor your invoices progress

    Billing system getting paid on a government contract 16 april 2014

    For more information about our organizations visit

    www.sdaga.org

    www.ncmasd.org

  • Login
