1 / 4

Brief Hardware Status

A. Maciel 02-07-01. Brief Hardware Status. receivers. FIC. Simple hardware and firmware corrections implemented Just arrived from Saclay, under tests now at L2 test stand. CIC. One passes tests, one borderline (w/ cable length) New battery of BIST tests (F.Ends) thru Sunday.

sheri
Download Presentation

Brief Hardware Status

An Image/Link below is provided (as is) to download presentation Download Policy: Content on the Website is provided to you AS IS for your information and personal use and may not be sold / licensed / shared on other websites without getting consent from its author. Content is provided to you AS IS for your information and personal use only. Download presentation by click this link. While downloading, if for some reason you are not able to download a presentation, the publisher may have deleted the file from their server. During download, if you can't get a presentation, the file might be deleted by the publisher.

E N D

Presentation Transcript


  1. A. Maciel 02-07-01 Brief Hardware Status receivers FIC • Simple hardware and firmware corrections implemented • Just arrived from Saclay, under tests now at L2 test stand CIC • One passes tests, one borderline (w/ cable length) • New battery of BIST tests (F.Ends) thru Sunday utilities • Seem to pass all tests – but need solid CIC before final acceptance • Likely to give go-ahead for bare boards on Monday SFO MBT • Hardware tests successful • Firmware under development • VME driver in its early stages processors SLIC • Hardware and firmware done and tested (board ready) • Management and trig. algorithm software in progress ALPHA • Five boards alive – all functions enabled • Finally a platform for software development • Bring remaining boards to life – component scans

  2. A. Maciel 02-07-01 TRIVIAL DATA CHAIN “phase-1” SLIC (4 chans) C I C M B T UAZ_tester (12 channels) SLIC (4 chans) Alpha SLIC (4 chans) DATA MODE; • no trigger, no SCL • UAZ_tester: • run_single_cycle • run_continuous • SLICs do Chan[i]  wDSP[i]  •  mDSP (sort channels)  out • MBT 3 mbt channels into alpha • Alpha pass-thru, write to file (VME) • Data carries origin signature and Byte ordering • Succession of “shorts” • Hi Byte is Channel # • Lo Byte is counter 0...7 • One muon-object length (2 ints) per channel • Each slic outputs four “objects” • Full header-trailer treatment everywhere • At least the most basic monitoring of board fns. • Check data integrity, ordering, endianess... • Run continuous w/ error counter

  3. A. Maciel 02-07-01 “phase-1” (cont.) • NEEDS; • All drivers in place • SLIC & Alpha on a pass-thru algorithm • DSP I/O & memory management in place • Alpha write-to-file (then error counter) • WHERE; • Test Stand, two separate crates • [ uaz+cic+slic] --- [mbt + alpha] • Then single crate, TCC style • Ready to move to MCH crate sep. drivers two alphas alpha driven • WHEN; ?? [1st crate] needs are; • uaz Xmit data (1 week) , CIC is ready • SLIC • DSP (I/O & memory) management • wDSP pass-thru, and DSP_5 full algo. • Download & Boot procedures • [1st crate]-only tests possible Done in ~ 6 weeks • MEANWHILE; • mbt + alpha can get indept.data (chan-16) • normal work towards L2 commissioning • is prioritized to enable a “minimal phase-2” • (no interference w/ overall L2 build) End of “Phase-1” ; except for SCL-related issues, ~all hardware and VME-driver problems solved

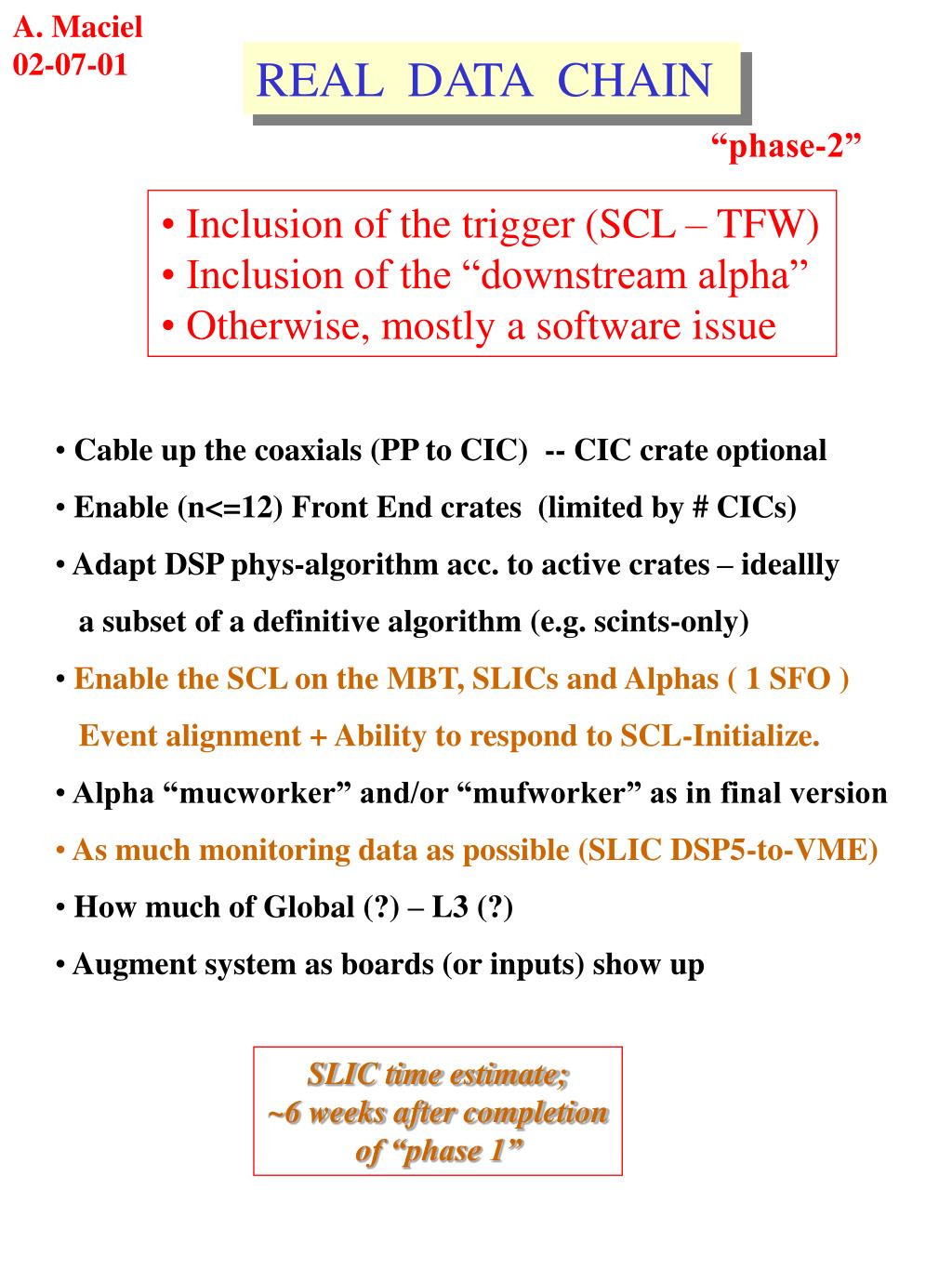

  4. A. Maciel 02-07-01 REAL DATA CHAIN “phase-2” • Inclusion of the trigger (SCL – TFW) • Inclusion of the “downstream alpha” • Otherwise, mostly a software issue • Cable up the coaxials (PP to CIC) -- CIC crate optional • Enable (n<=12) Front End crates (limited by # CICs) • Adapt DSP phys-algorithm acc. to active crates – ideallly • a subset of a definitive algorithm (e.g. scints-only) • Enable the SCL on the MBT, SLICs and Alphas ( 1 SFO ) • Event alignment + Ability to respond to SCL-Initialize. • Alpha “mucworker” and/or “mufworker” as in final version • As much monitoring data as possible (SLIC DSP5-to-VME) • How much of Global (?) – L3 (?) • Augment system as boards (or inputs) show up SLIC time estimate; ~6 weeks after completion of “phase 1”
