1 / 25

Optimally Scheduling Resource Constraint Project Using SAS/OR ®

Optimally Scheduling Resource Constraint Project Using SAS/OR ®. Jeff Cai Amgen Inc. SAS O peration R esearch. Project Management Bills of Material Processing Local Search Optimization Mathematical Programming QSIM Application Constraint Programming. Procedures in PM and CP.

Download Presentation

Optimally Scheduling Resource Constraint Project Using SAS/OR ®

An Image/Link below is provided (as is) to download presentation Download Policy: Content on the Website is provided to you AS IS for your information and personal use and may not be sold / licensed / shared on other websites without getting consent from its author. Content is provided to you AS IS for your information and personal use only. Download presentation by click this link. While downloading, if for some reason you are not able to download a presentation, the publisher may have deleted the file from their server. During download, if you can't get a presentation, the file might be deleted by the publisher.

E N D

Presentation Transcript


  1. Optimally Scheduling Resource Constraint Project Using SAS/OR® Jeff Cai Amgen Inc.

  2. SAS Operation Research • Project Management • Bills of Material Processing • Local Search Optimization • Mathematical Programming • QSIM Application • Constraint Programming

  3. Procedures in PM and CP • Project Management - CPM and PM procedures - NETDRAW procedure - GANTT procedure - DTREE procedure • Constraint Programming - CLP procedure

  4. Using the SAS System for Project Management

  5. Project Management Examples The Projman Application Web-Based Scheduling Systems

  6. Constraint Programming • Traditionally, Constraint programming can be used to resolve some problems known as Constraint Satisfaction Problems in areas such as artificial intelligence and operation research. • Mathematical models or techniques are used for optimally solving CSPs. • One of CSP is scheduling-constraint problem. • We can use this tool for project scheduling and resource forecasting on clinical programming projects.

  7. The Bridge Problem (Example) * The above graph is cited from SAS/OR 9.2 User’s Guide: Constraint Programming.

  8. Activity Data for Bridge Construction Temporal Constraints Resource Constraints

  9. Gantt Chart for the Bridge Construction Project * The above graph is cited from SAS/OR 9.2 User’s Guide: Constraint Programming.

  10. Data Flow for the Project Scheduling Activity - Input Data - Resource Constraints - Temporal Constraints ACTIVITY DATA SAS/OR PROC CLP SCHEDULE DATA

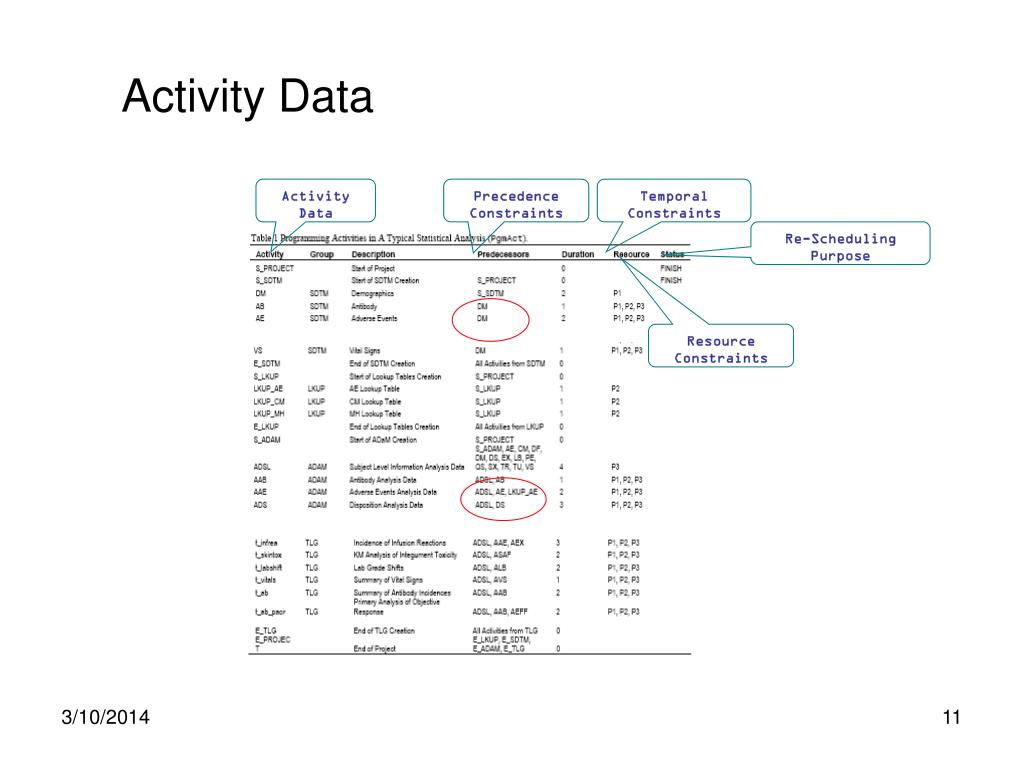

  11. Activity Data Activity Data Precedence Constraints Temporal Constraints Re-Scheduling Purpose Resource Constraints

  12. Network Diagram

  13. Data Flow for Project Scheduling SAS/OR® PROC CLP Resource constraint programming to reach the optimal project scheduling. ACTIVITY DATA SAS/OR PROC CLP SCHEDULE DATA

  14. Some key statements/options in Proc CLP PROC CLP ACTDATA=SCHEDDATA= ; • ACTIVITY specification <...> ; • REQUIRES specification <...> ; • RESOURCE specification <...> ; • SCHEDULE option(s) ; Activity input dataset Schedule output dataset Constraints in activity dataset Resource requirement specifications Resource specifications Optimal scheduling algorithm

  15. A clinical programming project example Input Activity Dataset proc clp actdata=actdata scheddata=scheddata; schedule edgefinder=first finish=60; resource (P1-P3); requires &req; run; %put &_ORCLP_; Output Scheduling Dataset Scheduling Algorithm Due Date Available SAS Programmer Resource Constraint for Each Activity # of Scheduling Solution

  16. Scenario 1 proc clp actdata= scheddata=; Schedule finish=60; resource (P1-P3); run; Scenario 1 Open Fixed Optimal Scheduling Solution

  17. Scenario 2 proc clp actdata= scheddata=; Schedule finish=60; resource (P1-P3); run; Scenario 2 Fixed Open Resource Forecasting

  18. Scenario 3 Reset proc clp actdata= scheddata=; schedule finish=60; resource (P1-P3); run; Scenario 3 Reset Reset Project Re-Scheduling

  19. Data Flow for Project Scheduling • Schedule -Output Data -Solution (0, 1, >=2) ACTIVITY DATA SAS/OR PROC CLP SCHEDULE DATA

  20. Output Schedule Data Activity Data Start and Finish Date Optimal Programmer Assigned

  21. Gantt Procedure GANTT chart Schedule Data Reference Line (Milestone: Completed SDTM, Completed ADaM, Completed TLG)

  22. Gantt Chart for SAS Programming Resource Scheduling GANTT chart

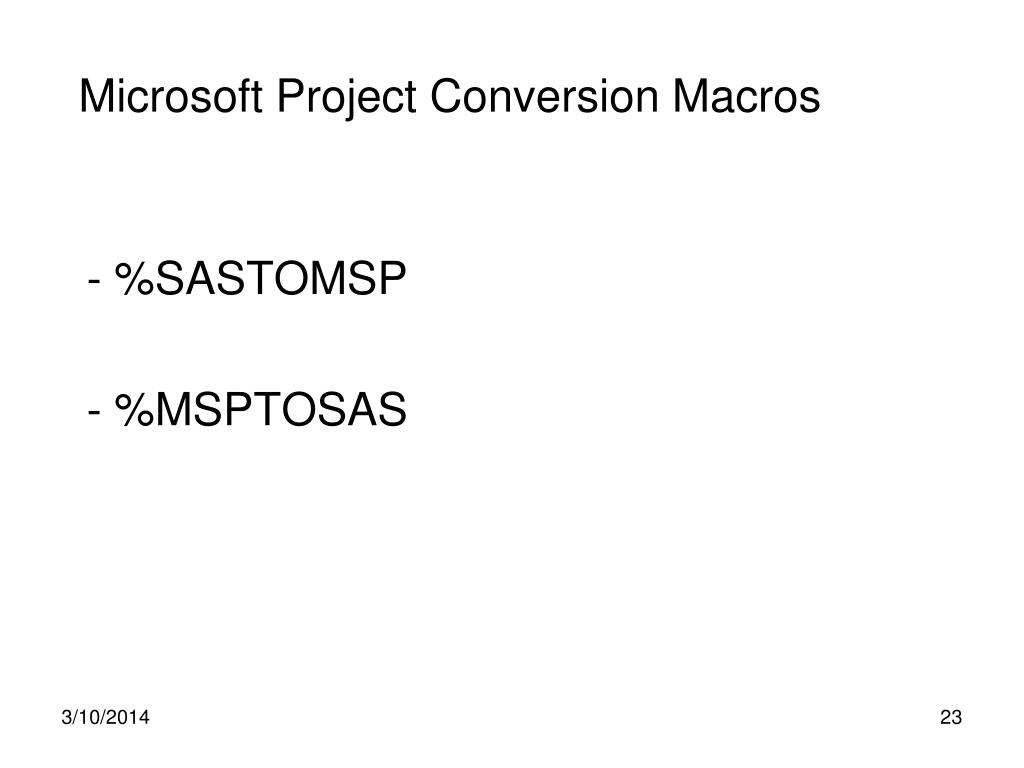

  23. Microsoft Project Conversion Macros - %SASTOMSP - %MSPTOSAS

  24. Summary - A useful tool for optimal project scheduling and project resource forecasting; - Each programmer may have each own schedule which can be displayed in Microsoft Project and populated into calendar/tasks in outlook; - The accuracy of resource forecasting and time management depends on the accurate planned duration associated with each activity;

  25. Optimally Scheduling Resource Constraint Project Using SAS/OR® • Thank you for attending ! CONTACT INFORMATION Jeff Cai Amgen Inc. 1120 Veterans Blvd, ASF3 South San Francisco, CA 94080 Work Phone: 650 244 2753 E-mail: jeff.cai@amgen.com Web: www.amgen.com
