An Image/Link below is provided (as is) to download presentation Download Policy: Content on the Website is provided to you AS IS for your information and personal use and may not be sold / licensed / shared on other websites without getting consent from its author. Content is provided to you AS IS for your information and personal use only. Download presentation by click this link. While downloading, if for some reason you are not able to download a presentation, the publisher may have deleted the file from their server. During download, if you can't get a presentation, the file might be deleted by the publisher.

E N D

Presentation Transcript

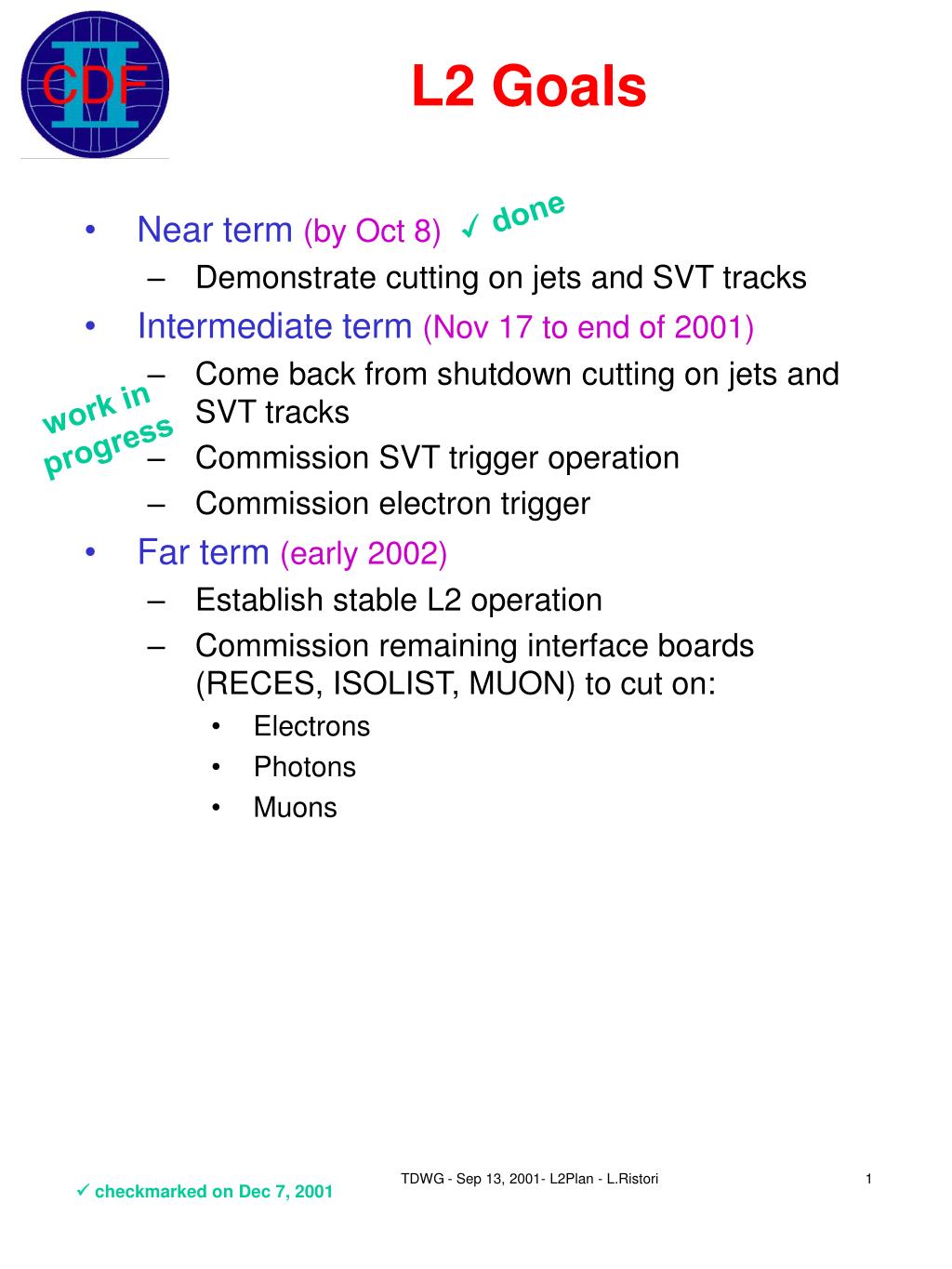

  1. L2 Goals  done • Near term (by Oct 8) • Demonstrate cutting on jets and SVT tracks • Intermediate term (Nov 17 to end of 2001) • Come back from shutdown cutting on jets and SVT tracks • Commission SVT trigger operation • Commission electron trigger • Far term (early 2002) • Establish stable L2 operation • Commission remaining interface boards (RECES, ISOLIST, MUON) to cut on: • Electrons • Photons • Muons work in progress TDWG - Sep 13, 2001- L2Plan - L.Ristori

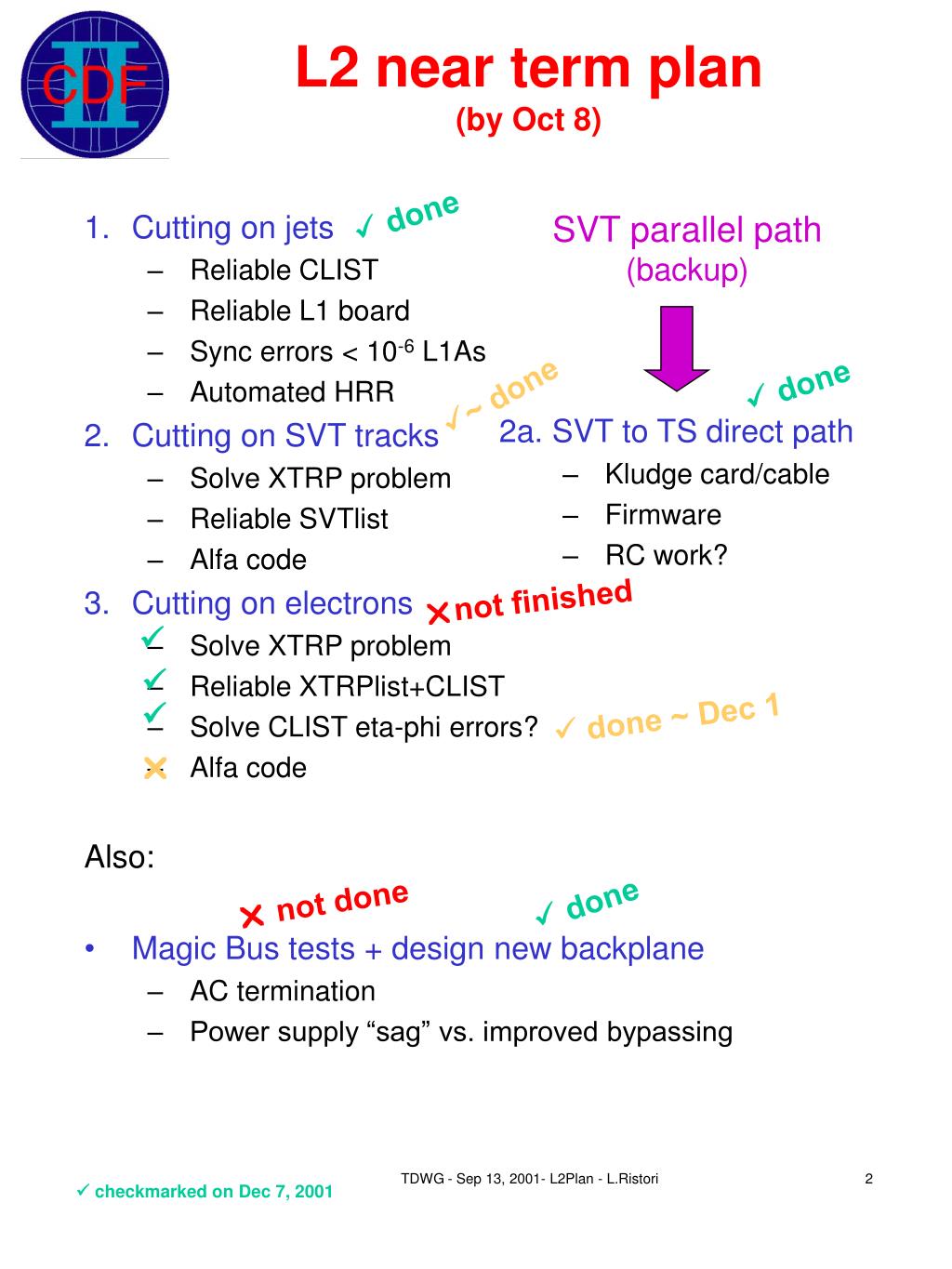

  2. Cutting on jets Reliable CLIST Reliable L1 board Sync errors < 10-6 L1As Automated HRR Cutting on SVT tracks Solve XTRP problem Reliable SVTlist Alfa code Cutting on electrons Solve XTRP problem Reliable XTRPlist+CLIST Solve CLIST eta-phi errors? Alfa code Also: Magic Bus tests + design new backplane AC termination Power supply “sag” vs. improved bypassing 2a. SVT to TS direct path Kludge card/cable Firmware RC work? L2 near term plan(by Oct 8)  done SVT parallel path (backup)  done ~ done • not finished     done ~ Dec 1   not done  done TDWG - Sep 13, 2001- L2Plan - L.Ristori

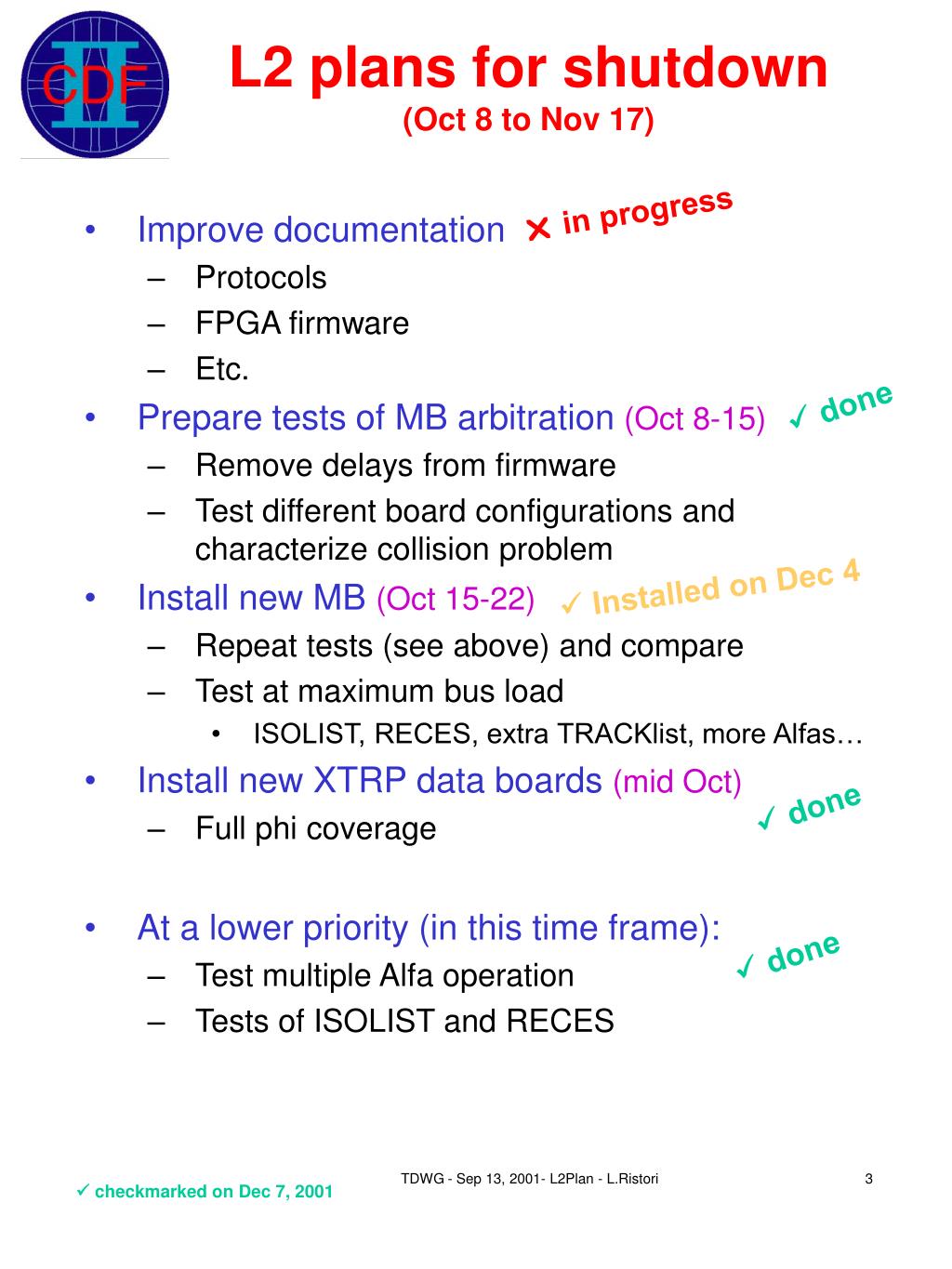

  3. L2 plans for shutdown(Oct 8 to Nov 17)  in progress • Improve documentation • Protocols • FPGA firmware • Etc. • Prepare tests of MB arbitration (Oct 8-15) • Remove delays from firmware • Test different board configurations and characterize collision problem • Install new MB (Oct 15-22) • Repeat tests (see above) and compare • Test at maximum bus load • ISOLIST, RECES, extra TRACKlist, more Alfas… • Install new XTRP data boards (mid Oct) • Full phi coverage • At a lower priority (in this time frame): • Test multiple Alfa operation • Tests of ISOLIST and RECES  done  Installed on Dec 4  done  done TDWG - Sep 13, 2001- L2Plan - L.Ristori

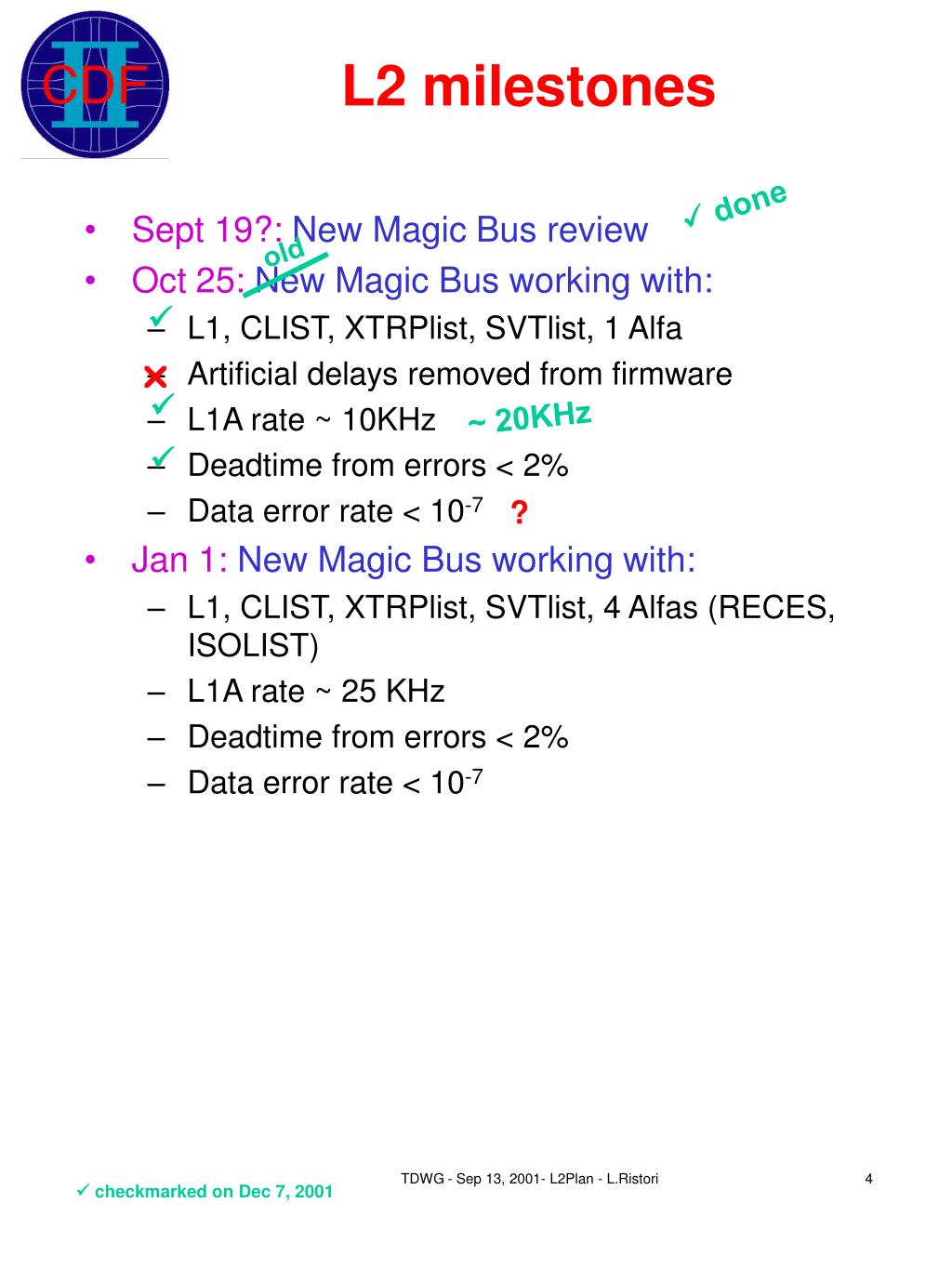

  4. L2 milestones  done • Sept 19?: New Magic Bus review • Oct 25: New Magic Bus working with: • L1, CLIST, XTRPlist, SVTlist, 1 Alfa • Artificial delays removed from firmware • L1A rate ~ 10KHz • Deadtime from errors < 2% • Data error rate < 10-7 • Jan 1: New Magic Bus working with: • L1, CLIST, XTRPlist, SVTlist, 4 Alfas (RECES, ISOLIST) • L1A rate ~ 25 KHz • Deadtime from errors < 2% • Data error rate < 10-7 old    ~ 20KHz  ? TDWG - Sep 13, 2001- L2Plan - L.Ristori

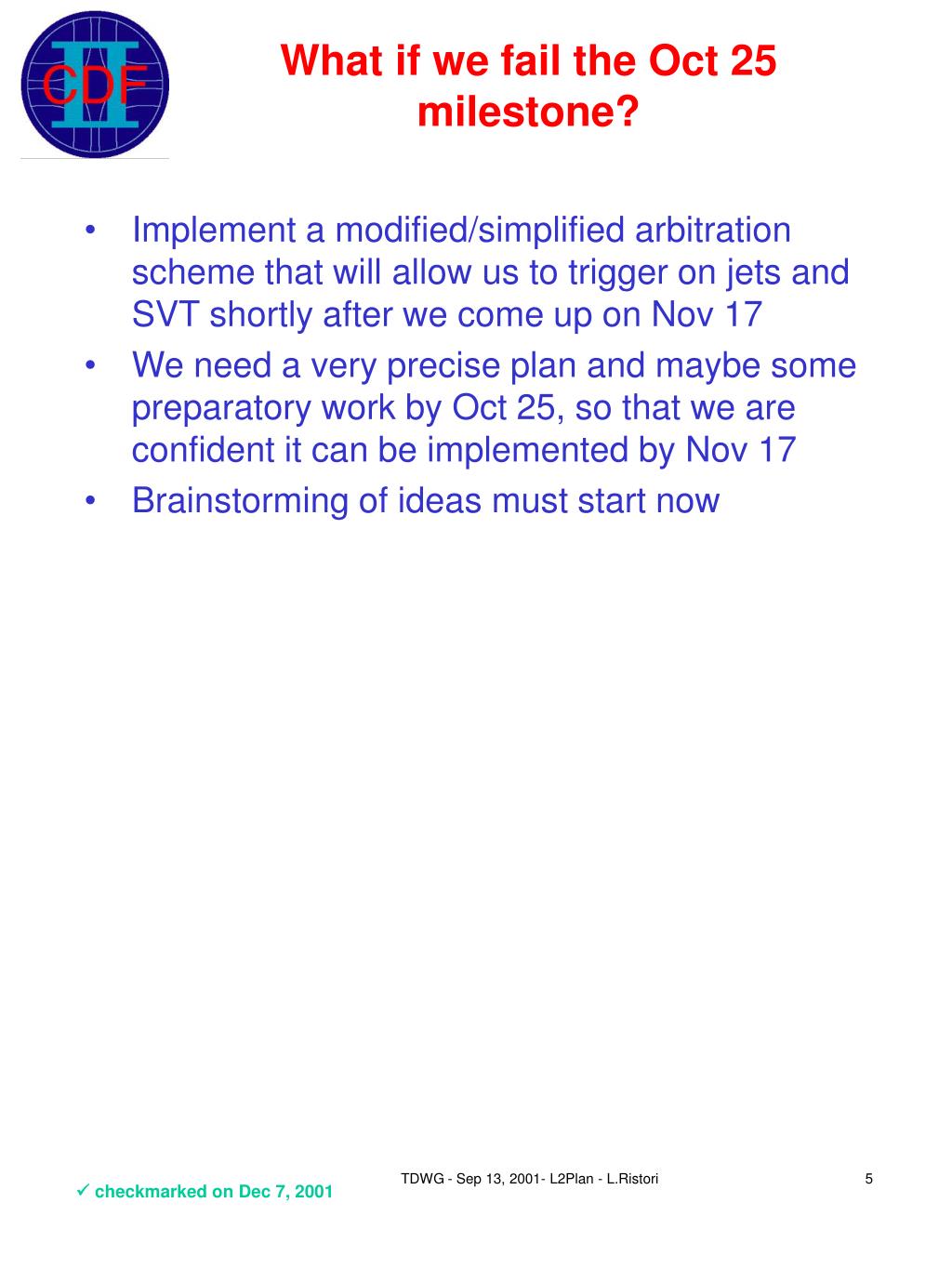

  5. What if we fail the Oct 25 milestone? • Implement a modified/simplified arbitration scheme that will allow us to trigger on jets and SVT shortly after we come up on Nov 17 • We need a very precise plan and maybe some preparatory work by Oct 25, so that we are confident it can be implemented by Nov 17 • Brainstorming of ideas must start now TDWG - Sep 13, 2001- L2Plan - L.Ristori
