Wind power and the crez case what s decided what s not what s next
Download
1 / 16

Wind Power and the CREZ Case: What s Decided, What s Not, What s Next - PowerPoint PPT Presentation


  • 288 Views
  • Uploaded on

Wind Power and the CREZ Case: What’s Decided, What’s Not, What’s Next. Patrick R. Cowlishaw Jackson Walker LLP SBOT Public Utility Law Section August 15, 2008. Background: The CREZ Mandate ( SB 20, 79 th Leg., 2005).

loader
I am the owner, or an agent authorized to act on behalf of the owner, of the copyrighted work described.
capcha
Download Presentation

PowerPoint Slideshow about 'Wind Power and the CREZ Case: What s Decided, What s Not, What s Next' - kat


An Image/Link below is provided (as is) to download presentation

Download Policy: Content on the Website is provided to you AS IS for your information and personal use and may not be sold / licensed / shared on other websites without getting consent from its author.While downloading, if for some reason you are not able to download a presentation, the publisher may have deleted the file from their server.


- - - - - - - - - - - - - - - - - - - - - - - - - - E N D - - - - - - - - - - - - - - - - - - - - - - - - - -
Presentation Transcript
Wind power and the crez case what s decided what s not what s next l.jpg

Wind Power and the CREZ Case: What’s Decided, What’s Not, What’s Next

Patrick R. Cowlishaw

Jackson Walker LLP

SBOT Public Utility Law Section

August 15, 2008


Background the crez mandate sb 20 79 th leg 2005 l.jpg
Background:The CREZ Mandate (SB 20, 79th Leg., 2005)

  • Rich Texas wind resources, but remote from population centers: development limited without transmission, transmission construction limited without wind development commitments

  • Legislature passed PURA 39.904(g); requires PUC to take 2 actions:

    • designate competitive renewable energy zones(CREZs) “throughout this state” in areas with sufficient energy resources and suitable land areas to develop generating capacity from renewable energy technologies, and considering level of generator financial commitment for each zone

    • develop a plan to construct transmission capacity necessary to deliver to electric customers, in a manner that is most beneficial and cost-effective to the customers, the electric output from renewable energy technologies in the CREZs


Background the crez rule l.jpg

Designating CREZ zones:

Contested cases (first in 2007, thereafter as PUC sees need)

Final order to contain, for each CREZ:

geographic extent of CREZ

major transmission improvements to deliver CREZ output to customers (voltage level, general description of interconnection to existing grid)

estimated maximum generating capacity the TM improvements can accommodate

other requirements considered appropriate by PUC under PURA

Other provisions:

generator financial commitment

implementing transmission plan

selecting TSPs

CCN proceedings

developer deposits

developer to operate within 1 year after CREZ TM is ready

PUC authority to limit interconnection to CREZ TM system, establish dispatch priorities to protect against excess development

PUC Subst. R. 25.174 (Project 31852)

Background:The CREZ Rule


Crez proceeding docket 33672 l.jpg
CREZ Proceeding: Docket 33672

Docket opened January 2007

  • ERCOT 2006 study

    • AWS: 25 top wind regions

    • Transmission options to deliver CREZ output to ERCOT customers

  • 65 parties, 20 CREZ nominations

  • Financial commitment testimony filed to support over 20,000 MW CREZ projects across 16 zones

  • Nominated capacity exceeded TM capacity in ERCOT study

  • Alternative transmission proposals from parties

  • SPP proposal to serve Panhandle

  • Ancillary services study proceeding in parallel


What s decided step 1 crez zones delineated l.jpg
What’s Decided:Step 1 -- CREZ Zones Delineated

Interim Order (Oct. 2007)

  • AWS study adequate to identify zones with sufficient resources/land

  • 5 CREZs: based on 8 study zones with greatest financial commitment, plus project adjustments

  • Specific findings for each developer who provided significant financial commitment for each selected zone


What s decided other interim order conclusions l.jpg
What’s Decided:Other Interim Order Conclusions

Reliability region issues

  • TM to be built to interconnect all CREZs with ERCOT

  • Upper PH interconnections to ERCOT (zones 1, 4) require FERC approval as in Cottonwood (FERC ¶ 61,198)

  • Simultaneous interconnection to ERCOT, SPP prohibited

  • Dissent: would require upper Panhandle CREZ areas (1,4) to deliver into SPP

  • Need additional ERCOT TM study

  • zones now known

  • optimize plans for four

  • alternative capacity levels

  • i.d. components required

  • independent of CREZ process

  • report 4/2/08, allow comment


What s decided step 2 transmission plan approved open meeting 7 17 08 order expected 8 14 08 l.jpg
What’s Decided:Step 2 – Transmission Plan Approved Open Meeting 7/17/08; Order Expected 8/14/08

  • Voted to select Scenario 2 (“middle case”)

  • 18,456 MW CREZ transfer capacity (11,553 new wind plus 6903 base)

  • Estimated cost = $ 4.93B + collection system ($ 580 – 820 MM)

  • Provides for 64,031 GWh wind generation at $38/MWh average fuel-cost savings

  • 2,334 miles of new 345-kV construction, over 100 projects (CTP Facilities)

  • Expandable design to Scenario 3 (24,859 MW)


What s not and what s next who will build operate the crez transmission l.jpg

New Rule 25.216 (Project 34560)

If CTP Facility is an

Existing facility upgrade: owner will be selected as TSP unless requests otherwise or good cause

New facility: PUC to select TSP

capabilities to finance, license, operate, maintain facility; cost projections; proposed schedule; use of HUBs; track record; project understanding

reduced filing requirements for unopposed CTP Proposals

CREZ TSP Selection Under Way in Docket 35665

Settlement conferences to expedite selection

Initial expressions of interest

competition for large projects

31 owner upgrades

CTP Proposals due 9/12

selections due within 180 days by rule (3/11/09)

Merits hearing 12/1-5

What’s Not and What’s Next:Who Will Build, Operate The CREZ Transmission?


What s not and what s next ccn proceedings for crez transmission l.jpg
What’s Not and What’s Next:CCN Proceedings for CREZ Transmission

  • CREZ CCN applications due:

    • 1 year after order designating CREZ, 25.174(c)(4), but

    • PUC can set or amend schedule, 25.216(g)(1)

  • CREZ CCN applications need not address adequacy of existing service, need for additional service, PURA 39.904(h), PUC Subst. R. 25.174(c)(5)

  • 180-day deadline for decision under PURA 39.203(e) apply, i.e., TM that PUC requires a utility to construct for purpose of meeting renewable energy capacity goal under 39.904(a)?

  • TSP may propose modifications to reduce cost or increase capacity, PUC may direct ERCOT to review

  • PUC to consider level of generator financial commitment, based on …?


What s not and what s next developer 10 deposits in ccn proceedings l.jpg

25.174(c)(6):

45 days after CCN app for CREZ TM improvements, each developer for that CREZ to post LC/collateral

10% of developer’s pro rata share of estimated capital cost of TM improvements covered by CREZ order

Deposit shortfalls may result in reconsidering CREZ designation, CCN denial, replacing defaulting developer, other “appropriate action”

Potentially requires developers to post in range of $ 500 MM collateral to support S2 build-out

Questions:

Which improvements apply, e.g. “ASAP” lines relieving current congestion (RPG v. CREZ)?

Which improvements go with which zones? Must every CREZ developer post in every case?

Who can participate?

Project size to be updated?

10% of what? Developer’s planned CREZ MW ÷ CREZ TM capacity? How to adjust for oversubscription?

Where to address ?s without delay of CCN proceedings?

What’s Not and What’s Next:Developer “10%” Deposits in CCN Proceedings


What s not and what s next dispatch priority l.jpg

CREZ development requires:

Financial commitment to obtain CREZ designation

10% deposit

Investment to be ready to take TM service 1 year after CREZ TM complete

What rights associated with these commitments?

Business case requires some reasonable assurance of access to CREZ TM

CREZ Rule 25.174(e):

PUC may initiate proceeding and limit IC or set dispatch priorities

If aggregate renewable capacity requesting TM service for a CREZ exceeds maximum stated in CREZ order

proposed CREZ wind (20,000+ MW) v. S2 TM capacity (11,553)

Factors may include financial commitment filed to support CREZ designation, deposit

Express, limited authorization to restrict open access

What’s Not and What’s Next:Dispatch Priority


What s not and what s next dispatch priority13 l.jpg

Interim Order in CREZ Docket:

Consistent with open access, wind project located outside a CREZ is not “automatically ineligible to interconnect” with CREZ TM line

In any subsequent DP proceeding, developers within a CREZ who submitted financial commitment evidence in CREZ docket “will likely fare better” than others

Issues (for Project 34577)

Allocating limited export capacity among projects within a CREZ

CREZ project access to CREZ TM v. wind, other generation outside CREZ, e.g., “downstream” interconnectors

Wind curtailment before nuclear, (?) clean coal

DP mechanism must mesh with nodal market

Transferability, duration

What’s Not and What’s Next:Dispatch Priority


What s not and what s next wind integration and reliability l.jpg
What’s Not and What’s Next:Wind Integration and Reliability

  • “ERCOT can and will maintain system reliability under any of the four CREZ scenarios.” (33672 Phase II Brief)

  • GE Ancillary Services Study – existing technology and operations could manage 15000 MW wind in 2008 without radical alterations, at small costs relative to fuel savings from wind; seen to support S2 levels for 2012

  • ERCOT rule changes addressing operational/reliability issues: recent (objective wind forecasts), under consideration in Wind Operations Task Force (IC standards, performance measures, ramp rate limits)

  • Possible venues for further action: PUC/ERCOT CREZ implementation docket, ERCOT Task Force recommendation

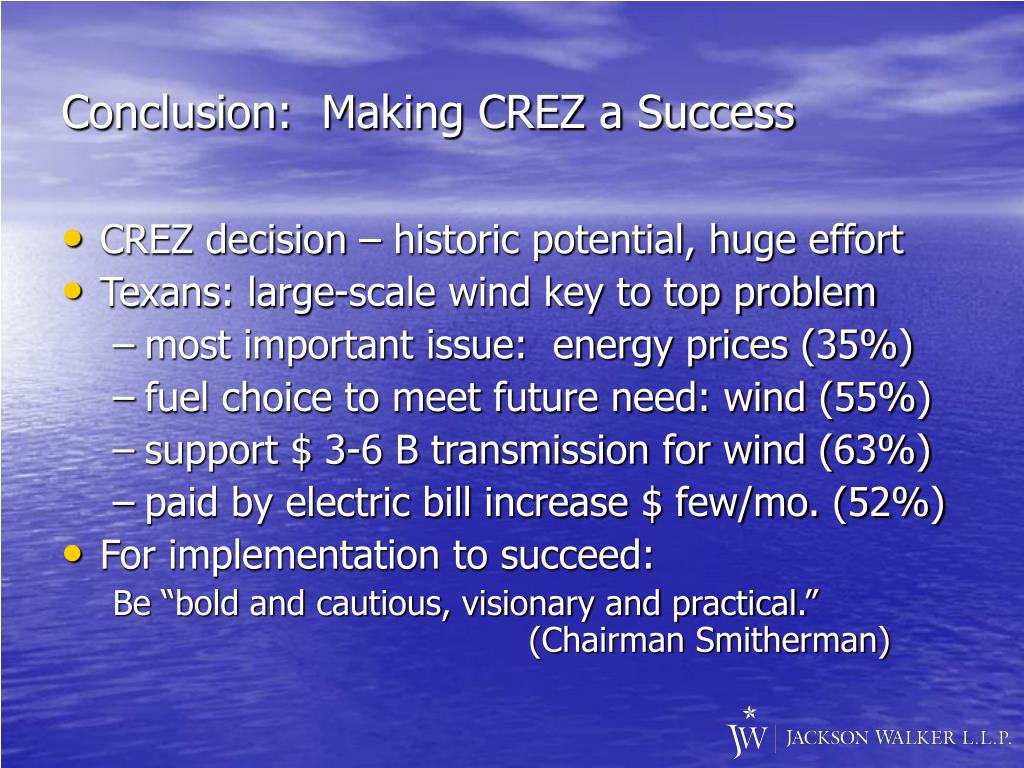

Conclusion making crez a success l.jpg
Conclusion: Making CREZ a Success

  • CREZ decision – historic potential, huge effort

  • Texans: large-scale wind key to top problem

    • most important issue: energy prices (35%)

    • fuel choice to meet future need: wind (55%)

    • support $ 3-6 B transmission for wind (63%)

    • paid by electric bill increase $ few/mo. (52%)

  • For implementation to succeed:

    Be “bold and cautious, visionary and practical.” (Chairman Smitherman)


Appendices l.jpg
Appendices

  • SB 20, 79th Leg., 1st Called Session (2005)

  • CREZ Rule (PUC Subst. R. 25.174)

  • CREZ TSP Selection Rule (PUC Subst. R. 25.216)

    A color copy of this presentation is available for download at www.jw.com/pcowlishaw. For more information, contact Pat Cowlishaw at 214.953.6049 or [email protected]


ad
