DCS Installation & commissioning

DCS Installation & commissioning. Central DCS Detector DCS Status. TB 18 May 06 L.Jirden. DCS commissioning responsibilities. Safety. DSS. Contr Room. CSAM. Global:Jirden. Services. Consoles . Augustinus. Chochula. CR facilities. Electricity. Augustinus. Chochula. Cooling.

kasen
Download Presentation

DCS Installation & commissioning

An Image/Link below is provided (as is) to download presentation Download Policy: Content on the Website is provided to you AS IS for your information and personal use and may not be sold / licensed / shared on other websites without getting consent from its author. Content is provided to you AS IS for your information and personal use only. Download presentation by click this link. While downloading, if for some reason you are not able to download a presentation, the publisher may have deleted the file from their server. During download, if you can't get a presentation, the file might be deleted by the publisher.

E N D

Presentation Transcript


  1. DCS Installation & commissioning • Central DCS • Detector DCS • Status TB 18 May 06 L.Jirden

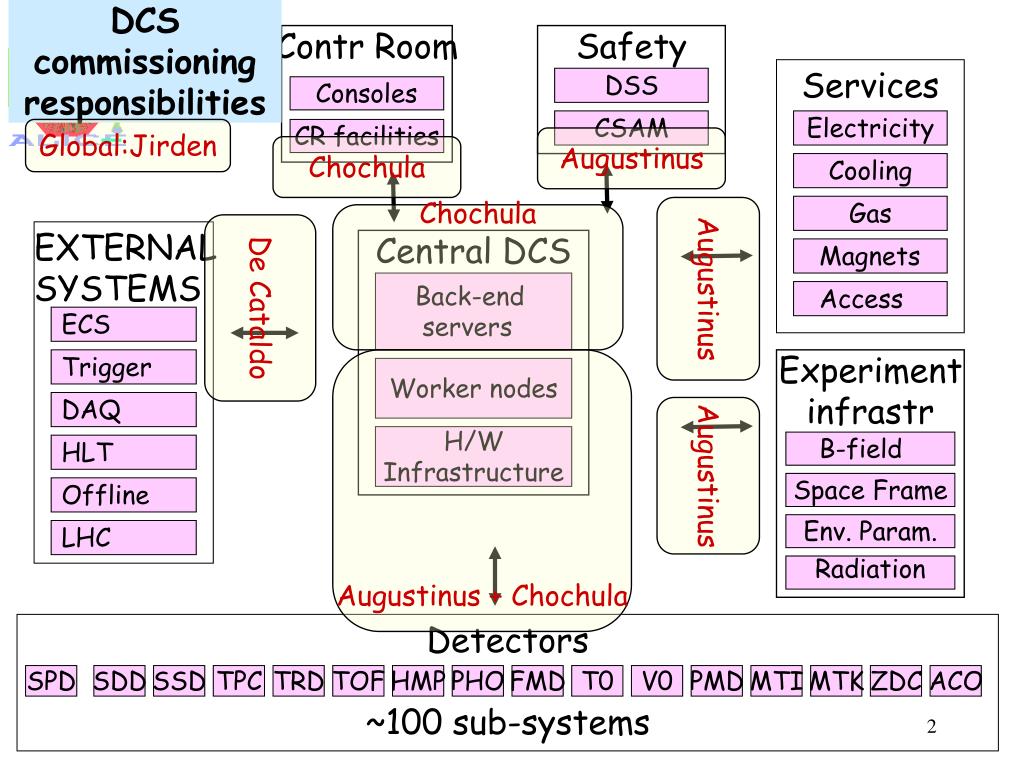

  2. DCS commissioningresponsibilities Safety DSS Contr Room CSAM Global:Jirden Services Consoles Augustinus Chochula CR facilities Electricity Augustinus Chochula Cooling De Cataldo EXTERNAL SYSTEMS ECS Gas Trigger Magnets DAQ Access Augustinus + Chochula HLT Augustinus Offline B-field LHC Space Frame Env. Param. Radiation SPD SDD SSD TPC TRD TOF HMP PHO FMD T0 V0 PMD MTI MTK ZDC ACO Detectors ~100 sub-systems Central DCS Back-end servers Experiment infrastr Worker nodes H/W Infrastructure

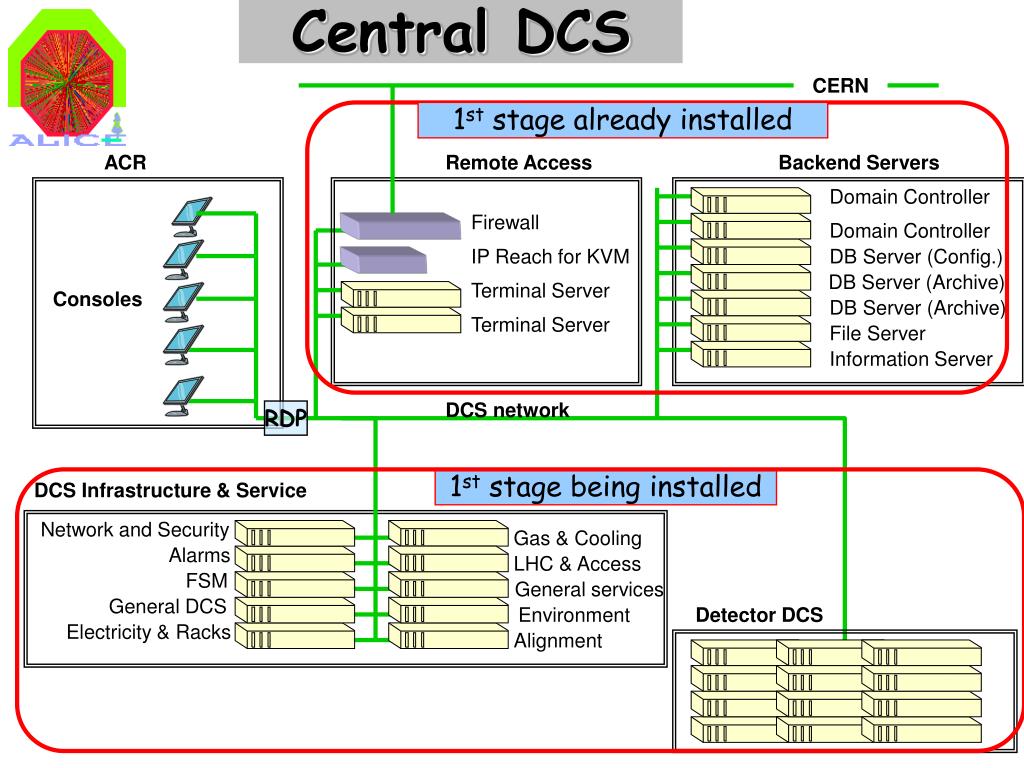

  3. 1st stage already installed 1st stage being installed Central DCS CERN ACR Remote Access Backend Servers Domain Controller Firewall Domain Controller IP Reach for KVM DB Server (Config.) DB Server (Archive) Terminal Server Consoles DB Server (Archive) Terminal Server File Server Information Server DCS network RDP DCS Infrastructure & Service Network and Security Gas & Cooling Alarms LHC & Access FSM General services General DCS Environment Detector DCS Electricity & Racks Alignment

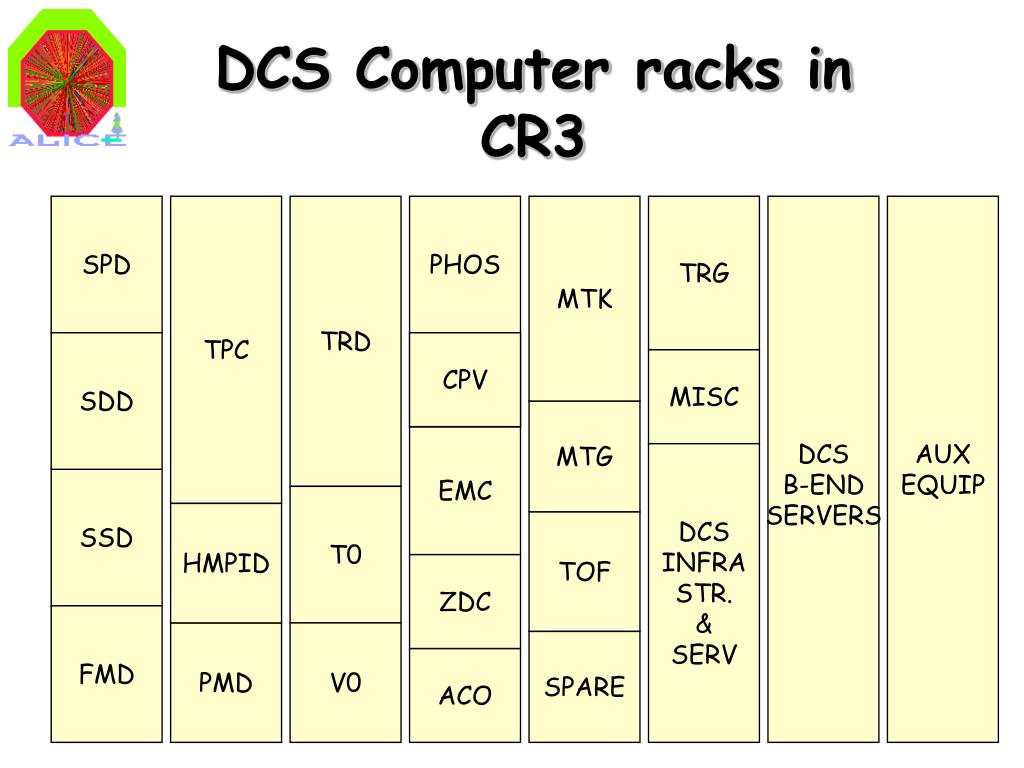

  4. SPD TPC TRD PHOS MTK TRG DCS B-END SERVERS AUX EQUIP SDD CPV MISC MTG EMC DCS INFRA STR. & SERV SSD T0 HMPID TOF ZDC FMD PMD V0 SPARE ACO DCS Computer racks in CR3

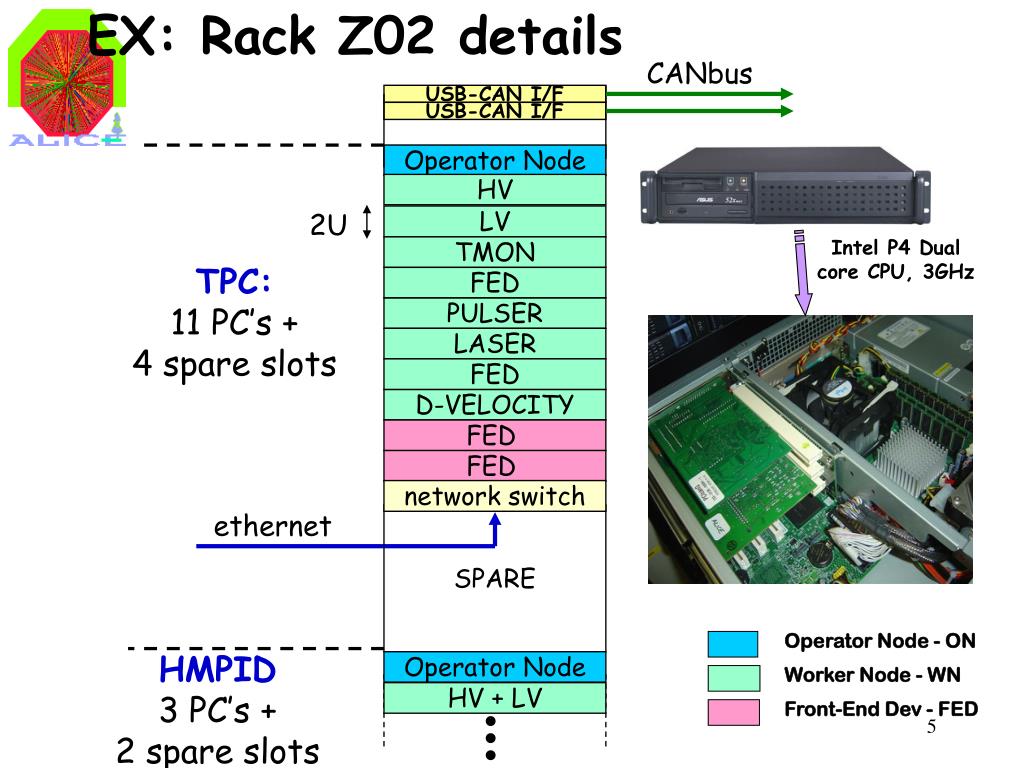

  5. EX: Rack Z02 details Operator Node - ON Worker Node - WN Front-End Dev - FED CANbus USB-CAN I/F USB-CAN I/F Operator Node HV 2U LV Intel P4 Dual core CPU, 3GHz TMON TPC:11 PC’s + 4 spare slots FED PULSER LASER FED D-VELOCITY FED FED network switch ethernet SPARE HMPID3 PC’s +2 spare slots Operator Node HV + LV

  6. Central effort DCS sub-systems 20 Systems SPD SDD SSD TPC TRD TOF HMP PHO CPV MTK MTG FMD T0 V0 PMD ZDC ACO EMC TRG DCS HV HV HV HV HV HV HV HV HV HV HV HV HV HV HV HV HV HV MON ALI LV LV LV LV LV LV LV LV LV LV LV LV LV LV LV LV MON MON MON MON RCK MON standard GAS GAS GAS GAS GAS GAS GAS GAS VME VME VME VME VME VME VME VME VME VME VME VME VME VME COO COO COO COO COO COO COO COO COO COO FEE FEE FEE FEE FEE FEE FEE FEE FEE FEE FEE semi LV VHV MON MON MON THR POS MON MON HVD GMS RAD HVD LAS HAL LIQ LED LED PUL specific NMR LAS COC ~110 sub-systems HVD DVM

  7. 1 2 3 4 Pre-commissioning • All sub-systems to be pre-commissioned before final installation in the pit • At the institute, at CERN, in SXL2 • Stages to be completed for each sub-system: • H/W device defined & low level S/W done • PVSS interface to H/W device established course • Finite State Machines (FSM) implemented course • Configurations done course To be ready 4 weeks before Detector installation • Planning established for each detector

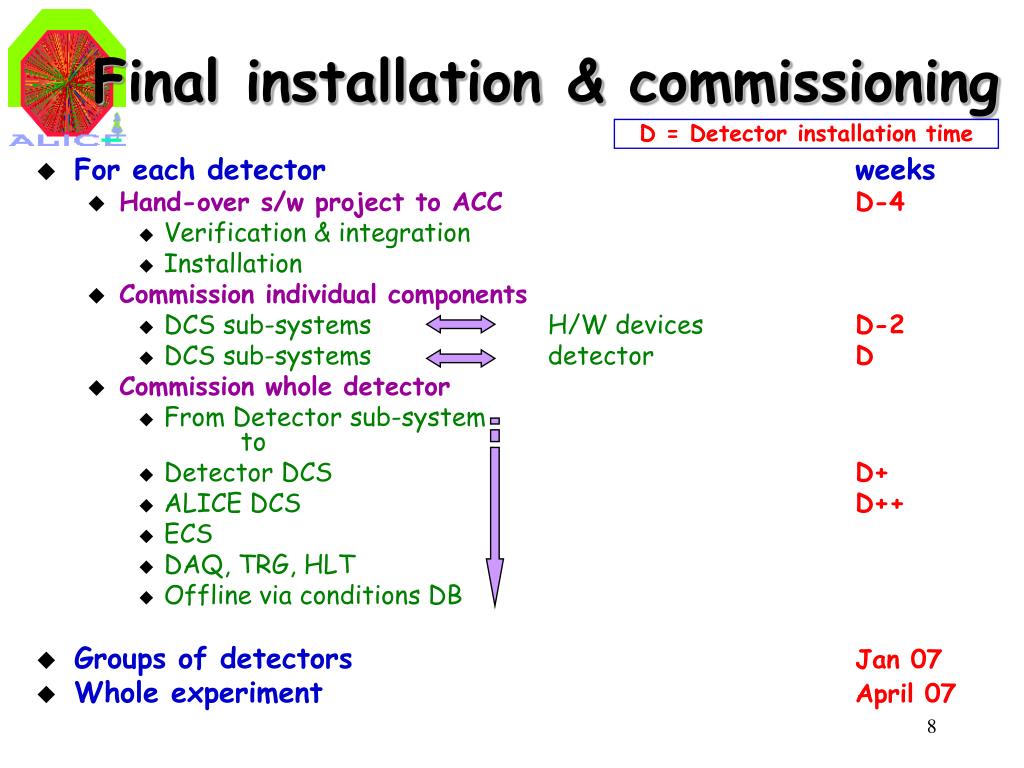

  8. Final installation & commissioning D = Detector installation time • For each detector weeks • Hand-over s/w project to ACC D-4 • Verification & integration • Installation • Commission individual components • DCS sub-systems H/W devices D-2 • DCS sub-systems detector D • Commission whole detector • From Detector sub-system to • Detector DCS D+ • ALICE DCS D++ • ECS • DAQ, TRG, HLT • Offline via conditions DB • Groups of detectors Jan 07 • Whole experiment April 07

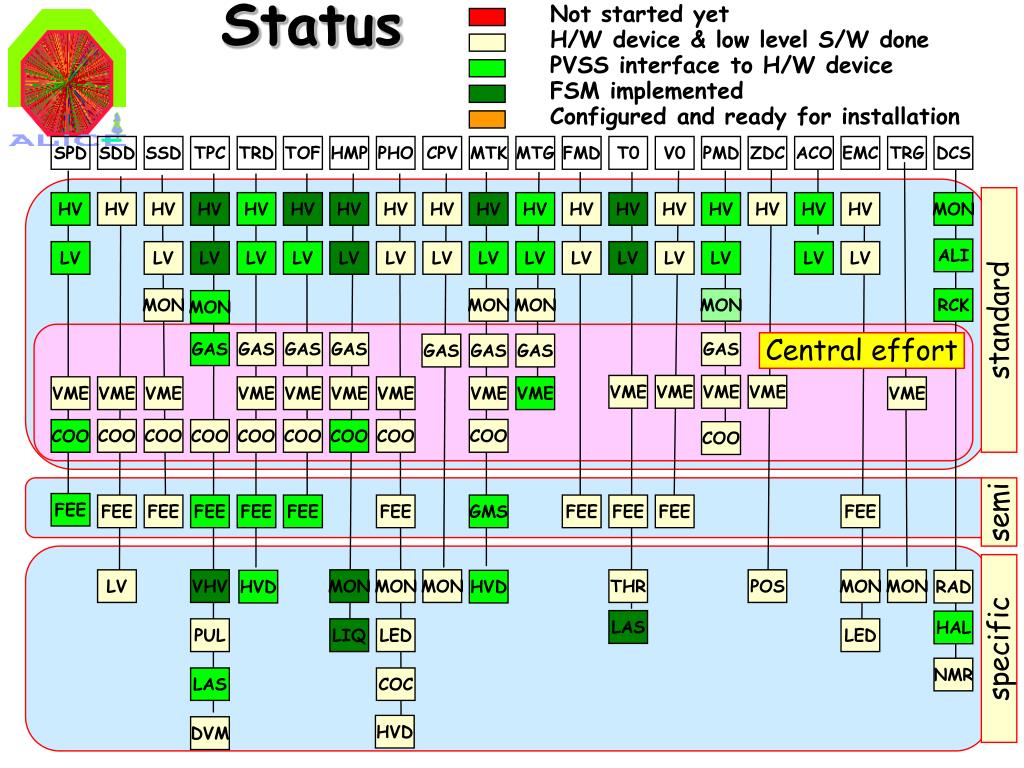

  9. Not started yet H/W device & low level S/W done PVSS interface to H/W device FSM implemented Configured and ready for installation Status SPD SDD SSD TPC TRD TOF HMP PHO CPV MTK MTG FMD T0 V0 PMD ZDC ACO EMC TRG DCS HV HV HV HV HV HV HV HV HV HV HV HV HV HV HV HV HV HV MON ALI LV LV LV LV LV LV LV LV LV LV LV LV LV LV LV LV MON MON MON MON RCK MON standard GAS GAS GAS GAS GAS Central effort GAS GAS GAS VME VME VME VME VME VME VME VME VME VME VME VME VME VME COO COO COO COO COO COO COO COO COO COO FEE semi FEE FEE FEE FEE FEE FEE GMS FEE FEE FEE FEE LV VHV MON MON MON THR POS MON MON HVD HVD RAD LAS HAL PUL LIQ LED LED specific NMR LAS COC HVD DVM

  10. manpower ok - late starters manpower ‘critical’ Started but no PVSS yet PVSS to H/W device Status FSM implemented Configurations implemented SPD SDD SSD TPC TRD TOF HMP PHO CPV MTK MTG FMD T0 V0 PMD ZDC ACO EMC TRG DCS HV HV HV HV HV HV HV HV HV HV HV HV HV HV HV HV HV HV MON ALI LV LV LV LV LV LV LV LV LV LV LV LV LV LV LV LV MON MON MON MON RCK MON standard FEE semi FEE FEE FEE FEE FEE FEE GMS FEE FEE FEE FEE LV VHV MON MON MON THR POS MON MON HVD HVD RAD LAS HAL PUL LIQ LED LED specific NMR LAS COC HVD DVM

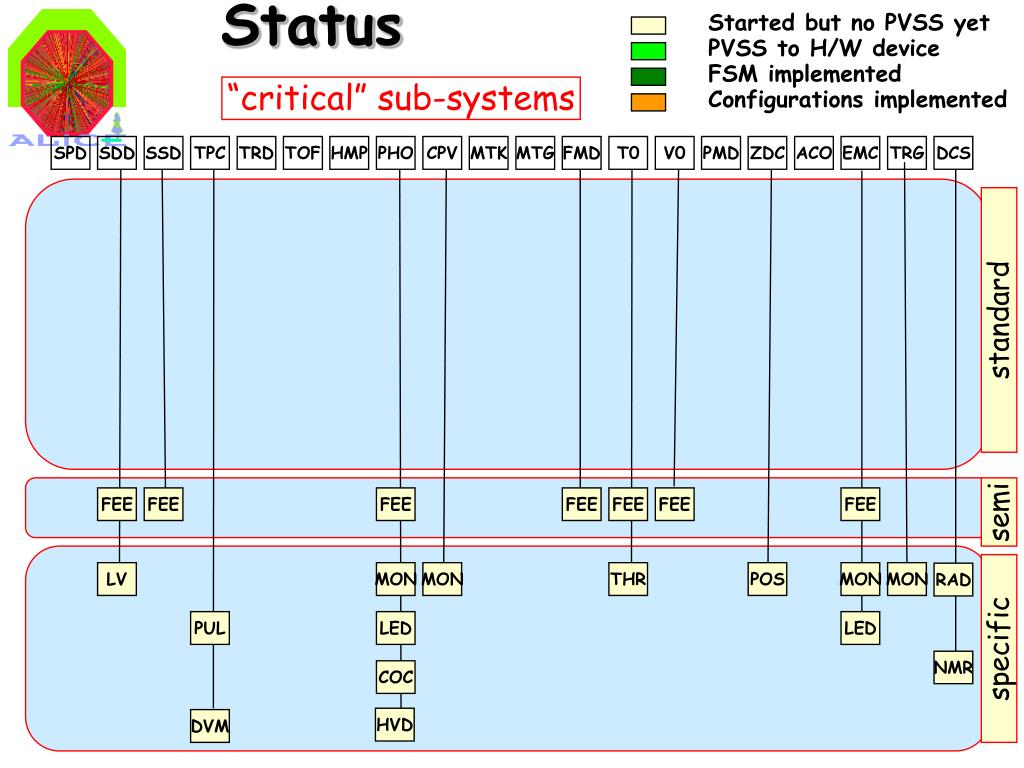

  11. Started but no PVSS yet PVSS to H/W device Status FSM implemented “critical” sub-systems Configurations implemented SPD SDD SSD TPC TRD TOF HMP PHO CPV MTK MTG FMD T0 V0 PMD ZDC ACO EMC TRG DCS standard FEE FEE FEE FEE FEE FEE FEE semi LV MON MON THR POS MON MON RAD PUL LED LED specific NMR COC HVD DVM

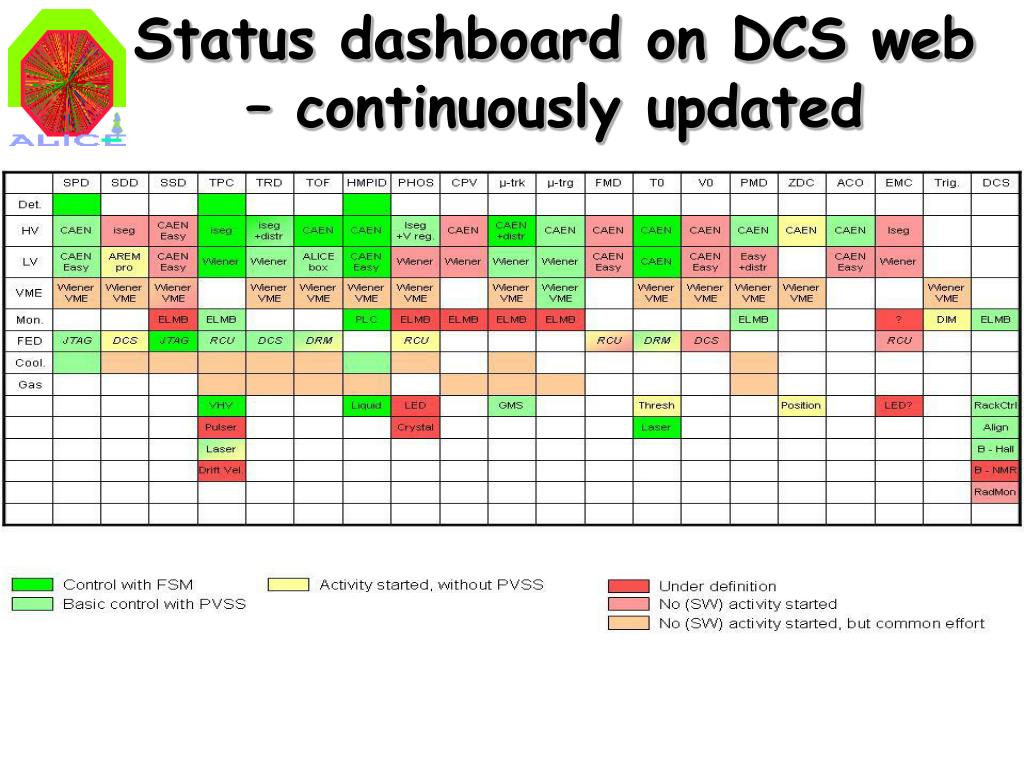

  12. Status dashboard on DCS web – continuously updated

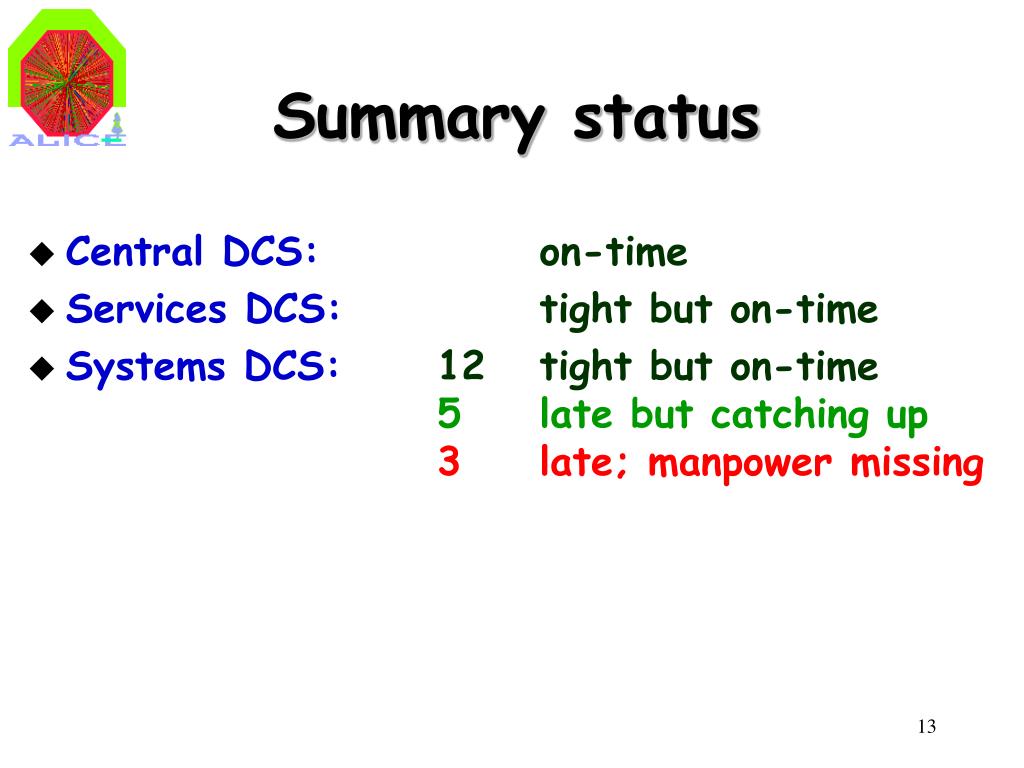

  13. Summary status • Central DCS: on-time • Services DCS: tight but on-time • Systems DCS: 12 tight but on-time5 late but catching up3 late; manpower missing
