Rbgc first transnational roundtable vilnius 24th november 2011

 RBGC First Transnational Roundtable Vilnius

24th November 2011

« Core Corridors and the « Rail Baltica »

James Pond DG MOVE

European Commission


The patchwork today

The patchwork today

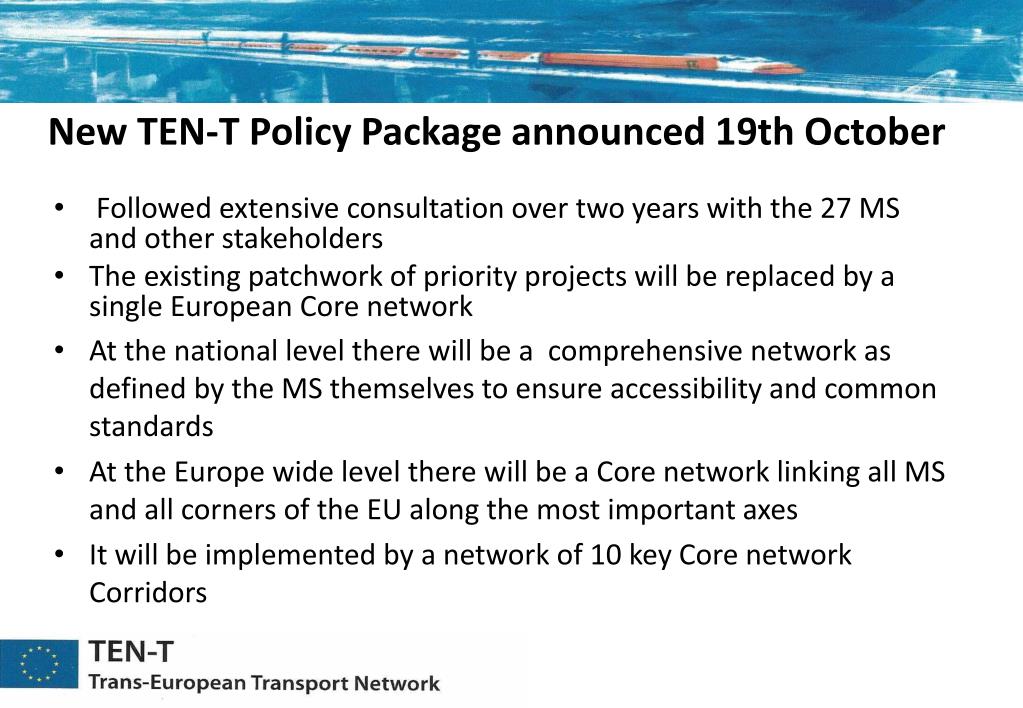

New ten t policy package announced 19th october

New TEN-T Policy Package announced 19th October

 Followed extensive consultation over two years with the 27 MS and other stakeholders

The existing patchwork of priority projects will be replaced by a single European Core network

At the national level there will be a comprehensive network as defined by the MS themselves to ensure accessibility and common standards

At the Europe wide level there will be a Core network linking all MS and all corners of the EU along the most important axes

It will be implemented by a network of 10 key Core network Corridors

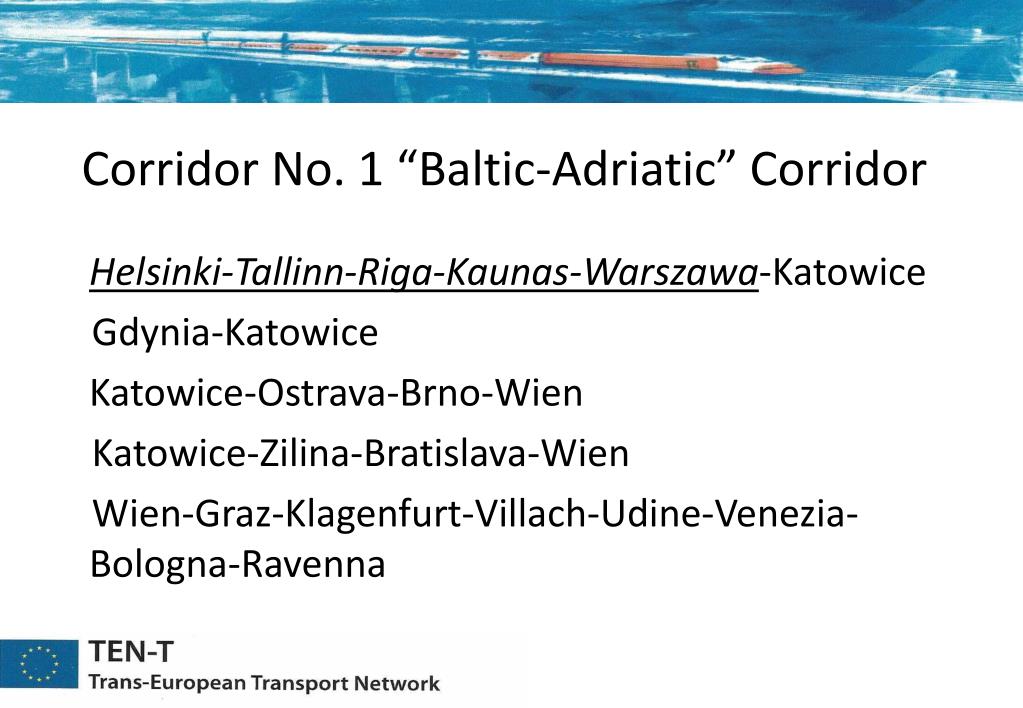

Corridor no 1 baltic adriatic corridor

Corridor No. 1 “Baltic-Adriatic” Corridor

Helsinki-Tallinn-Riga-Kaunas-Warszawa-Katowice

Gdynia-Katowice

Katowice-Ostrava-Brno-Wien

Katowice-Zilina-Bratislava-Wien

Wien-Graz-Klagenfurt-Villach-Udine-Venezia-Bologna-Ravenna

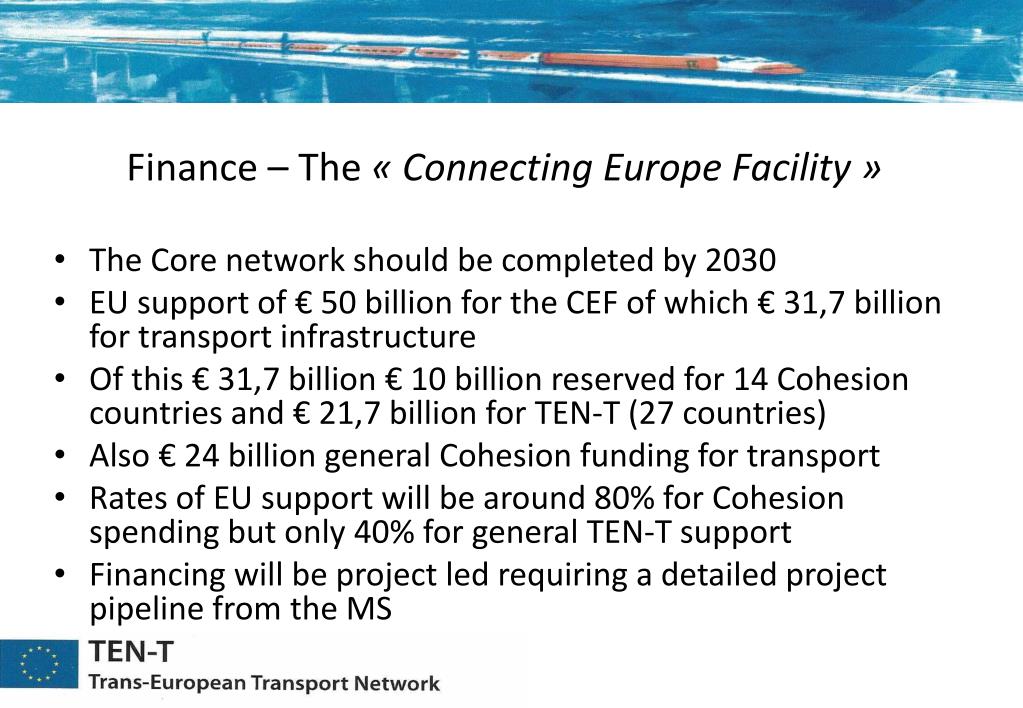

Finance the connecting europe facility

Finance – The « Connecting Europe Facility »

  • The Core network should be completed by 2030

  • EU support of € 50 billion for the CEF of which € 31,7 billion for transport infrastructure

  • Of this € 31,7 billion € 10 billion reserved for 14 Cohesion countries and € 21,7 billion for TEN-T (27 countries)

  • Also € 24 billion general Cohesion funding for transport

  • Rates of EU support will be around 80% for Cohesion spending but only 40% for general TEN-T support

  • Financing will be project led requiring a detailed project pipeline from the MS

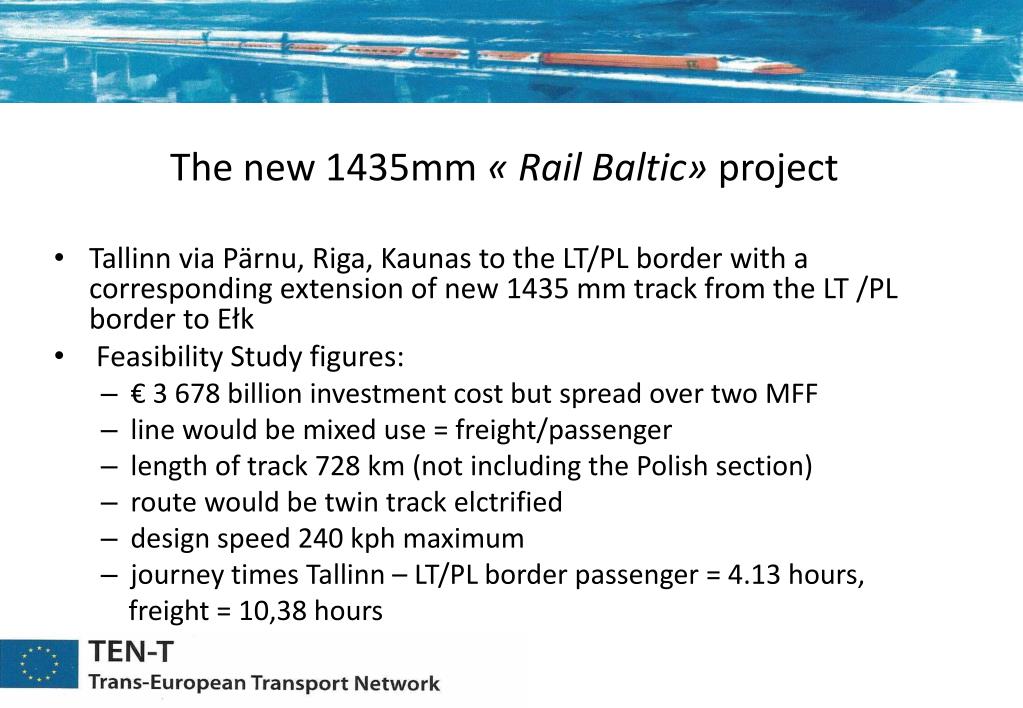

The new 1435mm rail baltic project

The new 1435mm « Rail Baltic» project

  • Tallinn via Pärnu, Riga, Kaunas to the LT/PL border with a corresponding extension of new 1435 mm track from the LT /PL border to Ełk

  • Feasibility Study figures:

    • € 3 678 billion investment cost but spread over two MFF

    • line would be mixed use = freight/passenger

    • length of track 728 km (not including the Polish section)

    • route would be twin track elctrified

    • design speed 240 kph maximum

    • journey times Tallinn – LT/PL border passenger = 4.13 hours,

      freight = 10,38 hours

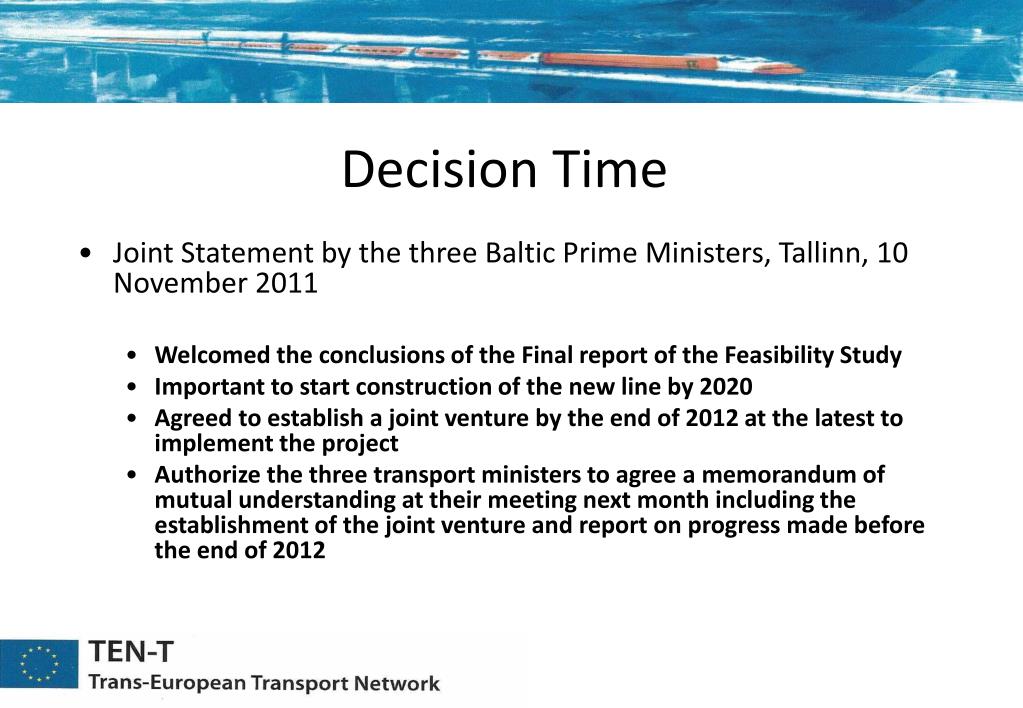

Decision time

Decision Time

  • Joint Statement by the three Baltic Prime Ministers, Tallinn, 10 November 2011

    • Welcomed the conclusions of the Final report of the Feasibility Study

    • Important to start construction of the new line by 2020

    • Agreed to establish a joint venture by the end of 2012 at the latest to implement the project

    • Authorize the three transport ministers to agree a memorandum of mutual understanding at their meeting next month including the establishment of the joint venture and report on progress made before the end of 2012
