1 / 49

RISK MANAGEMENT?

RISK MANAGEMENT?. Presented By: KHURRAM ALI KHAN. EFU Risk Management. Relevance of Losses to (Engineering) Risk Management?. Stages of Risk Management Risk Identification – what can go wrong Risk Quantification – probability and severity

jana-barlow
Download Presentation

RISK MANAGEMENT?

An Image/Link below is provided (as is) to download presentation Download Policy: Content on the Website is provided to you AS IS for your information and personal use and may not be sold / licensed / shared on other websites without getting consent from its author. Content is provided to you AS IS for your information and personal use only. Download presentation by click this link. While downloading, if for some reason you are not able to download a presentation, the publisher may have deleted the file from their server. During download, if you can't get a presentation, the file might be deleted by the publisher.

E N D

Presentation Transcript


  1. RISK MANAGEMENT? Presented By: KHURRAM ALI KHAN EFU Risk Management

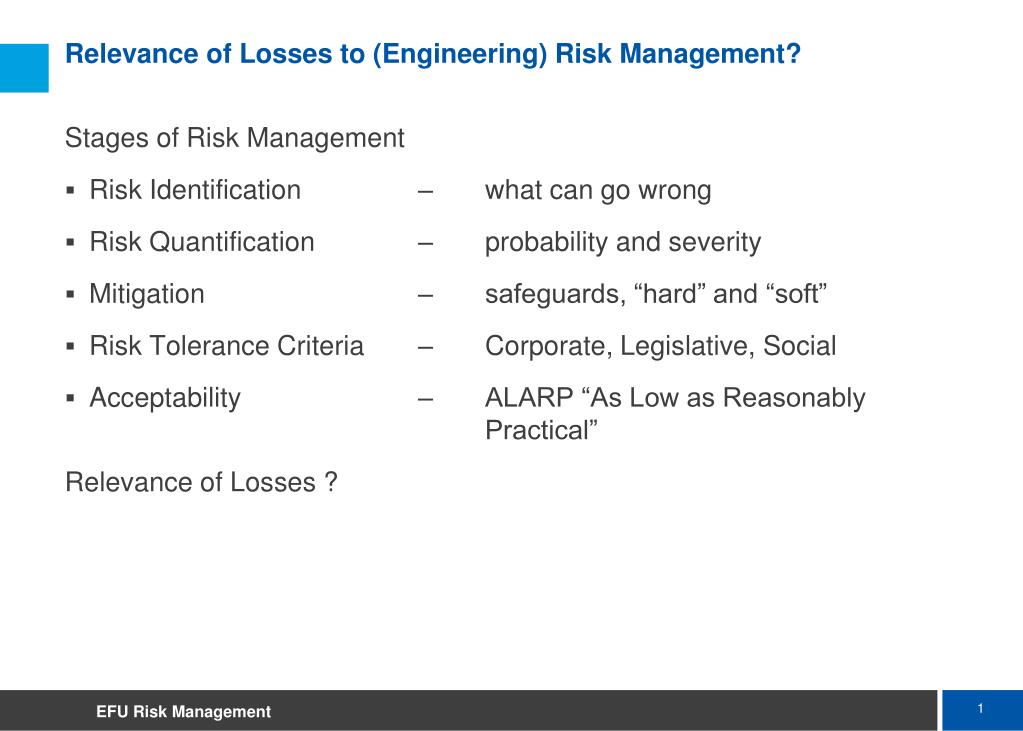

  2. Relevance of Losses to (Engineering) Risk Management? Stages of Risk Management • Risk Identification – what can go wrong • Risk Quantification – probability and severity • Mitigation – safeguards, “hard” and “soft” • Risk Tolerance Criteria – Corporate, Legislative, Social • Acceptability – ALARP “As Low as Reasonably Practical” Relevance of Losses ? EFU Risk Management

  3. Relevance of Losses to (Engineering) Risk Management? • Tolerability criteria and Mitigation requirements, both legislative or corporate, are often based on incident investigations • ASME Boiler codes written in blood spilled in the 19th and 20th centuries. • Hauge street explosion, New York 1850 , 67 dead • SS Pennsylvania, Memphis 1858, 250 dead • Town and son factory, Yorkshire 1869, 15 dead • “Rules for construction of Boilers” issued in 1914 as an act of public service in response to numerous failures and mishaps in ships, factories, steel mills and woodworking shops” • Management of Change procedures – post Flixbrough and 28 fatalities EFU Risk Management

  4. Risk Evaluation – Risk Matrices Frequency of Losses helps quantify probability CONSEQUENCE - People / Reputation / Environment / Assets EFU Risk Management

  5. Does Learning From Losses have a Shelf Life?To help with this question we will examine a 1912 loss, the most famous maritime disaster in history.

  6. Recognise this Ship? EFU Risk Management

  7. Recognise this Ship? The White Star Liner’s The Olympic EFU Risk Management

  8. The Olympic: Commissioned14th June 1911 The Titanic: Commissioned11th April 1912 The White Star Liner Company EFU Risk Management

  9. Sinking of Titanic, 15 April 1912 • Owner: White Star Line • Construction: Harland & Wolff, Belfast EFU Risk Management

  10. Olympic Class of White Star Steamers • Developed by JP Morgan’s White StarShipping Group • Constructed by Harland & Wolff in Belfast included The Olympic, The Titanic and The Britannic • Designed to compete with Cunard & German Shippers on the prestigious Transatlantic English Channel in the early 1900s • Built for affluent travelers offering highspeed luxury • The prized ‘Blue Riband’ was bestowed upon the ship with the fastest crossing. Held by Cunard’s Mauretania 1907-1929 Reference: ‘The Riddle of the Titanic’, Gardiner et. al. Orion, 1998 EFU Risk Management

  11. Details: 882 ft 9 in (269.1 m) long, 92 ft 6 in (28.2 m) wide Gross register tonnage of 46,328 tons Steam from 29 boilers powered two reciprocating steam engines and one low-pressure Parsons turbine, which drove three propellers. Possible top speed of 23 knots (43 km/h). Sinking of Titanic, 15 April 1912 EFU Risk Management

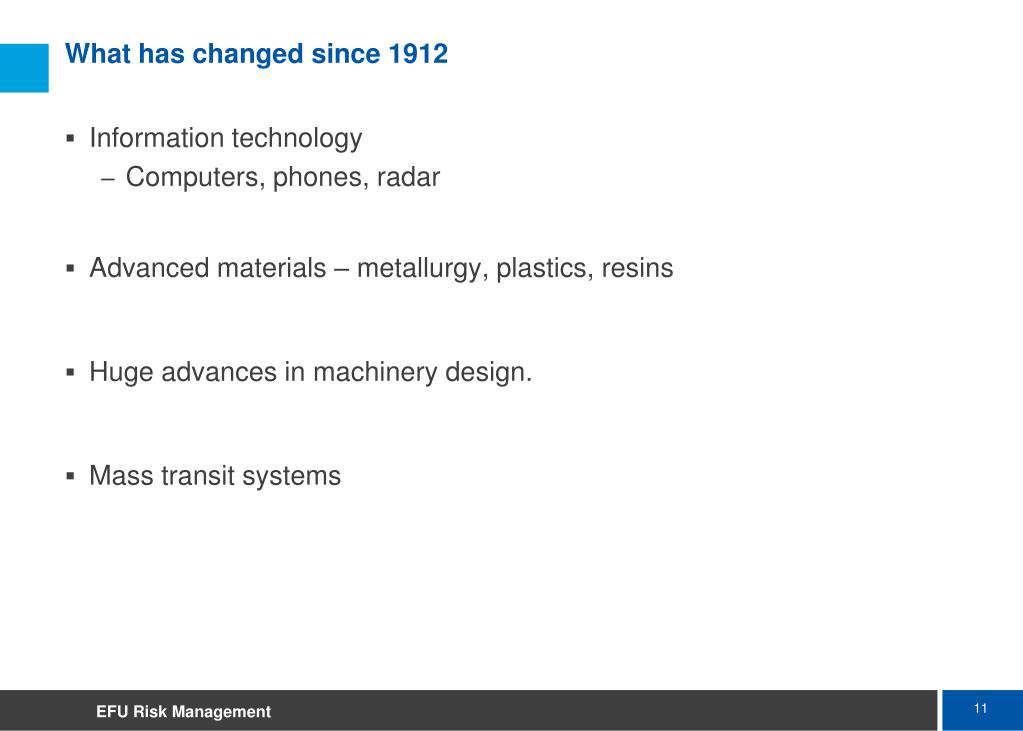

  12. What has changed since 1912 • Information technology • Computers, phones, radar • Advanced materials – metallurgy, plastics, resins • Huge advances in machinery design. • Mass transit systems EFU Risk Management

  13. Timeline • 10 April 12:00 departure Titanic from Southampton on maiden voyage to New York (via Cherbourg and Queenstown) • 12 April, reports of ice fields on course coming in • 14 April, increasing ice field reports, course altered to south, speed maintained at 22 knots • 14 April, night: moonless, clam seas, temperatures just below freezing • 14 April, 23:00, Californian radioed more ice and mentioned it stopped for the night because of pack ice, answer from Marconi radio operator ”shut up, shut up, I’m busy, I’m working Cape Race” EFU Risk Management

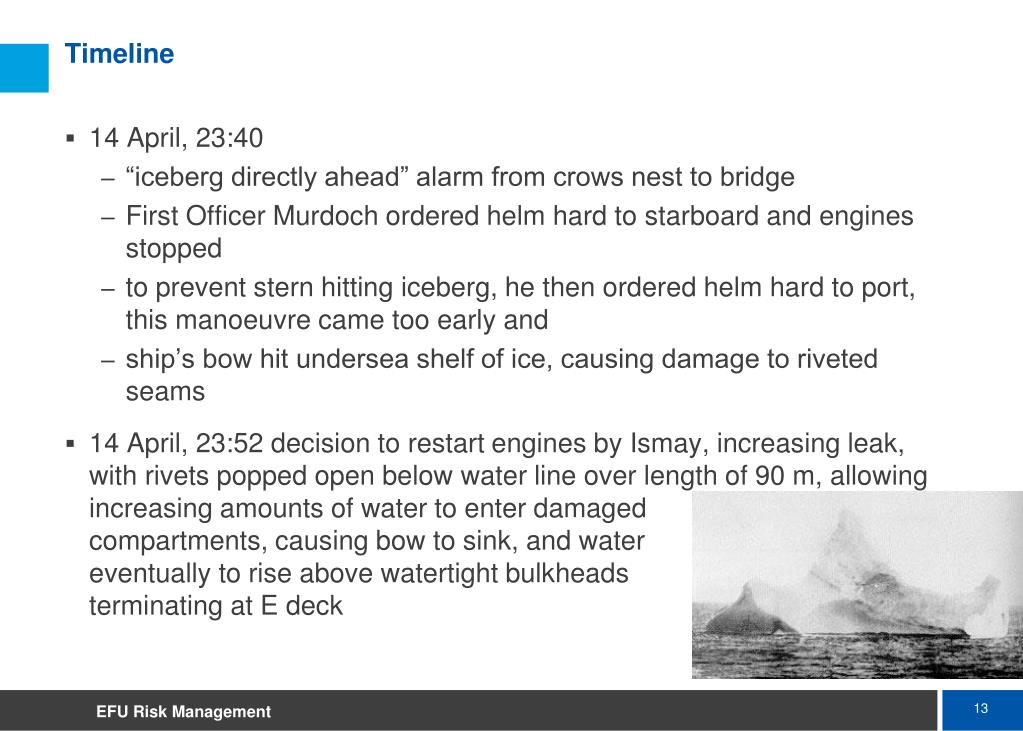

  14. Timeline • 14 April, 23:40 • “iceberg directly ahead” alarm from crows nest to bridge • First Officer Murdoch ordered helm hard to starboard and engines stopped • to prevent stern hitting iceberg, he then ordered helm hard to port, this manoeuvre came too early and • ship’s bow hit undersea shelf of ice, causing damage to riveted seams • 14 April, 23:52 decision to restart engines by Ismay, increasing leak, with rivets popped open below water line over length of 90 m, allowing increasing amounts of water to enter damaged compartments, causing bow to sink, and water eventually to rise above watertight bulkheads terminating at E deck EFU Risk Management

  15. Timeline • 15 April, 00:10 distress calls started (SOS) • 15 April, 00:19 engines stopped for last time • 15 April, 00:27 first lifeboat lowered (with capacity for 65 people, carrying 27) • 15 April, 00:35 distress rockets launched • 15 April, 02:20 Titanic sinks • 15 April, 04:10 Carpathia arrived on scene EFU Risk Management

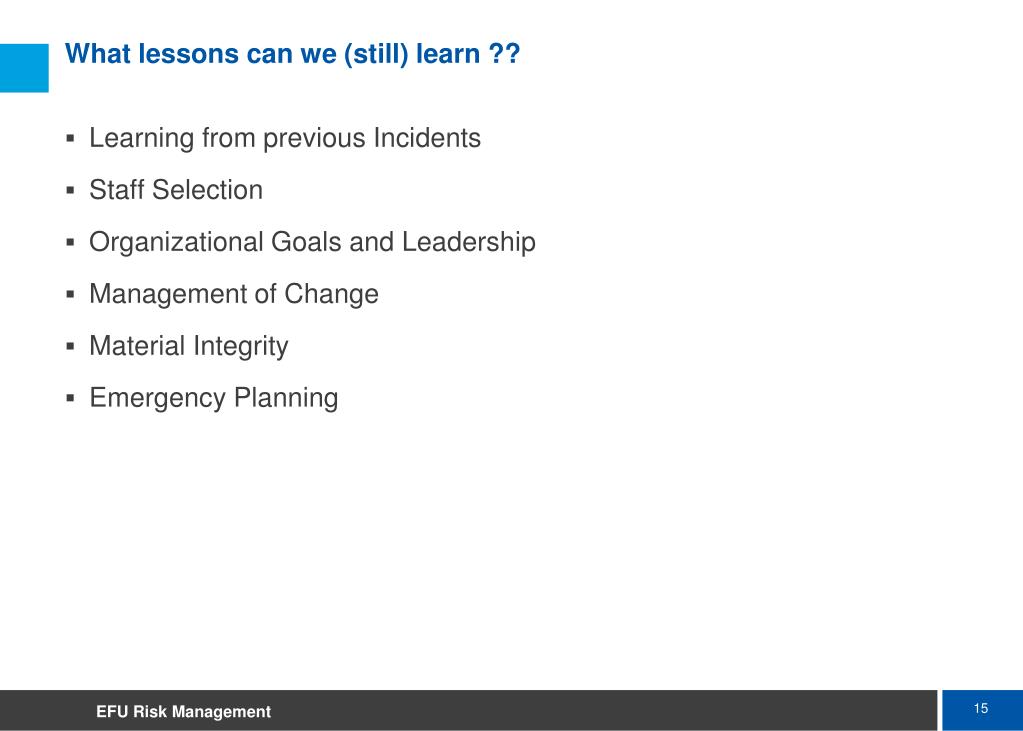

  16. What lessons can we (still) learn ?? • Learning from previous Incidents • Staff Selection • Organizational Goals and Leadership • Management of Change • Material Integrity • Emergency Planning EFU Risk Management

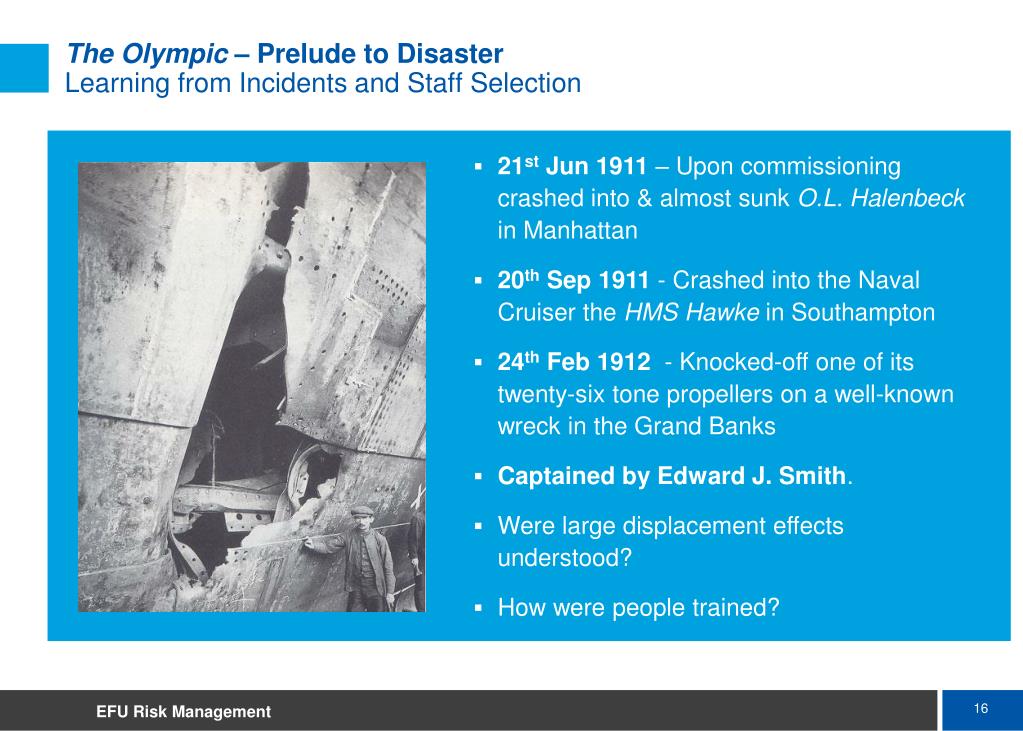

  17. 21st Jun 1911 – Upon commissioning crashed into & almost sunk O.L. Halenbeck in Manhattan • 20th Sep 1911 - Crashed into the Naval Cruiser the HMS Hawke in Southampton • 24th Feb 1912 - Knocked-off one of its twenty-six tone propellers on a well-known wreck in the Grand Banks • Captained by Edward J. Smith. • Were large displacement effects understood? • How were people trained? The Olympic – Prelude to DisasterLearning from Incidents and Staff Selection EFU Risk Management

  18. Regarded as very experienced but….. • 27th Jan 1889 - Ran The Republic aground in New York • 1st Dec 1890 - Ran The Coptic aground in Rio de Janerio • 4th Nov 1909 - Ran The Adriatic aground outside New York History of running ships too fast through narrow passages.. and of not adequately training his officers Captain Smith was commissioned to command the Titanic Staff selection and learning from previous incidents EFU Risk Management

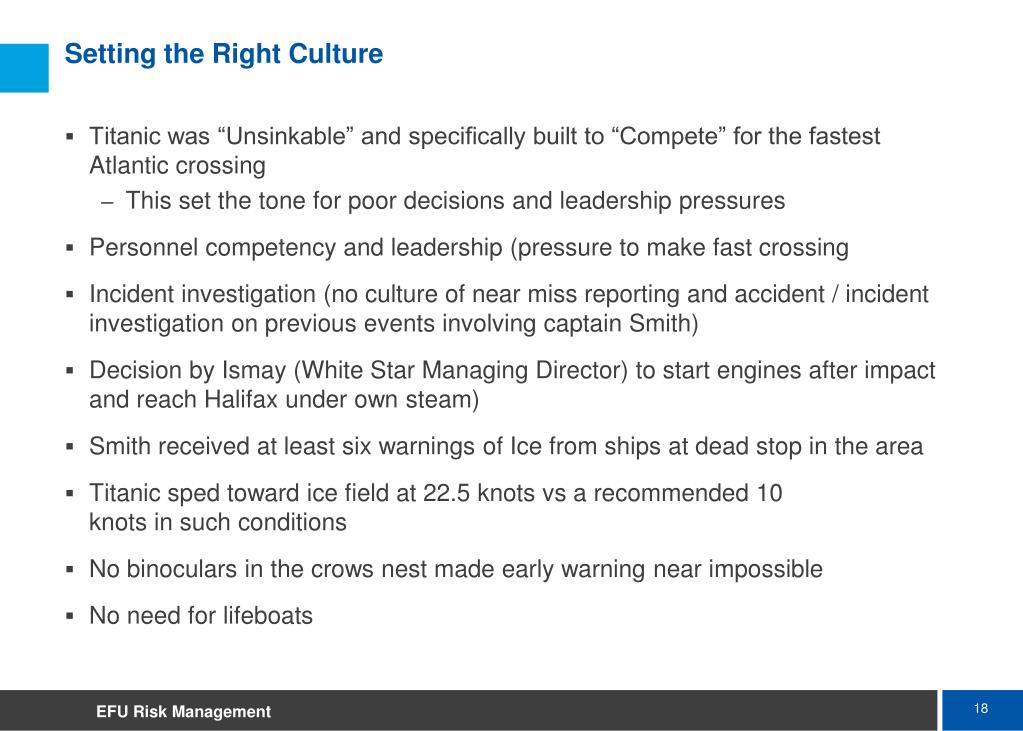

  19. Setting the Right Culture • Titanic was “Unsinkable” and specifically built to “Compete” for the fastest Atlantic crossing • This set the tone for poor decisions and leadership pressures • Personnel competency and leadership (pressure to make fast crossing • Incident investigation (no culture of near miss reporting and accident / incident investigation on previous events involving captain Smith) • Decision by Ismay (White Star Managing Director) to start engines after impact and reach Halifax under own steam) • Smith received at least six warnings of Ice from ships at dead stop in the area • Titanic sped toward ice field at 22.5 knots vs a recommended 10knots in such conditions • No binoculars in the crows nest made early warning near impossible • No need for lifeboats EFU Risk Management

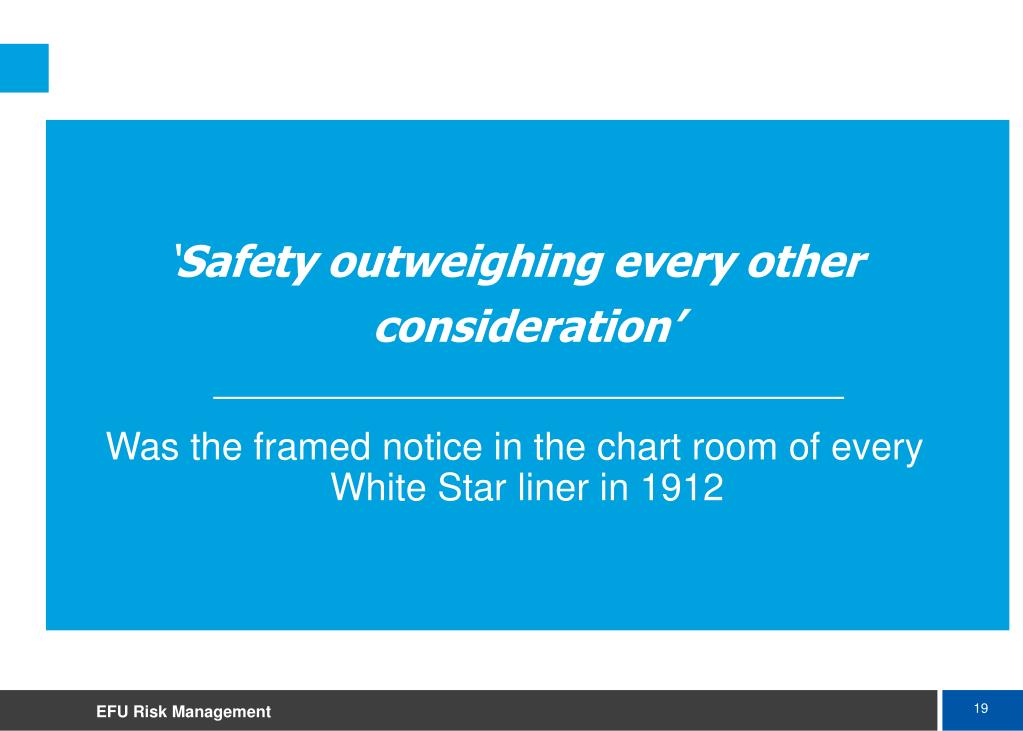

  20. ‘Safety outweighing every other consideration’ Was the framed notice in the chart room of every White Star liner in 1912 EFU Risk Management

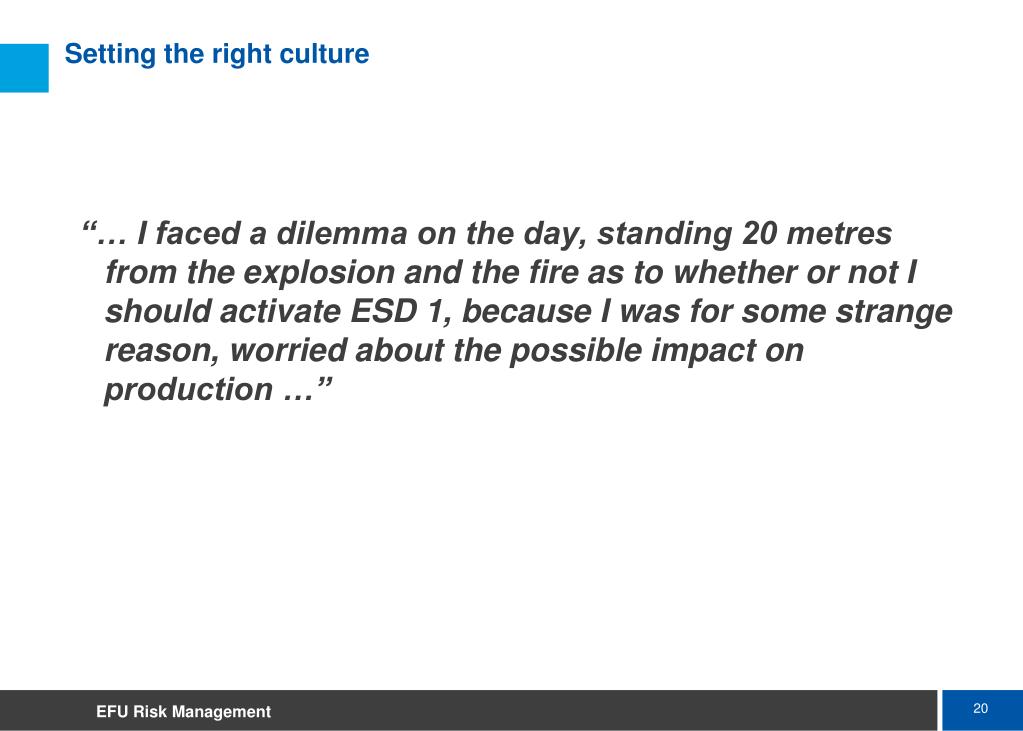

  21. “… I faced a dilemma on the day, standing 20 metres from the explosion and the fire as to whether or not I should activate ESD 1, because I was for some strange reason, worried about the possible impact on production …” Setting the right culture EFU Risk Management

  22. Quality Control and Material Identification • Asset integrity (rivets of best rather than best-best quality with high concentration of slags) • Shortage of skilled riveters • Rivets popping contributed to speed of sinking • Inferior quality of steel alloys is a genuine concern today • Mix-up of materials is a known cause of incidents • 2nd fire at Texas City EFU Risk Management

  23. Quality Control and Material Identification • France: 6,500 faulty Chinese valves in use • N-090925-02 Sud Robinetterie (SRI). Vannes Rigau S.A.S. On September 24, the regional newspaper La Provence reported that it had exclusive information, confirmed by Direction Régionale de l’Environnement, de l’Aménagement et du Logement (DREAL – Regional Administration of Environment, Planning and Housing), that several thousand substandard Chinese-made valves were in use throughout French industry. The valves were reportedly delivered to Vannes Rigau S.A.S., in Lille, on the orders of its parent company in Marseille, Sud Robinetterie. The valves in question were described as “corner or angle valves”, “globe valves”, and “flapper valves”, in carbon steel, and certified by the German TÜV before their entry into France. According to La Provence, the valves have incorrect heat treatment, and are prone to leak at low temperatures. Expected to operate down to -10ºC, they can only be used down to +5ºC. It was alleged that one of these valves may have been involved in an un-reported incident at Total’s Gonfreville site in April, 2009 EFU Risk Management

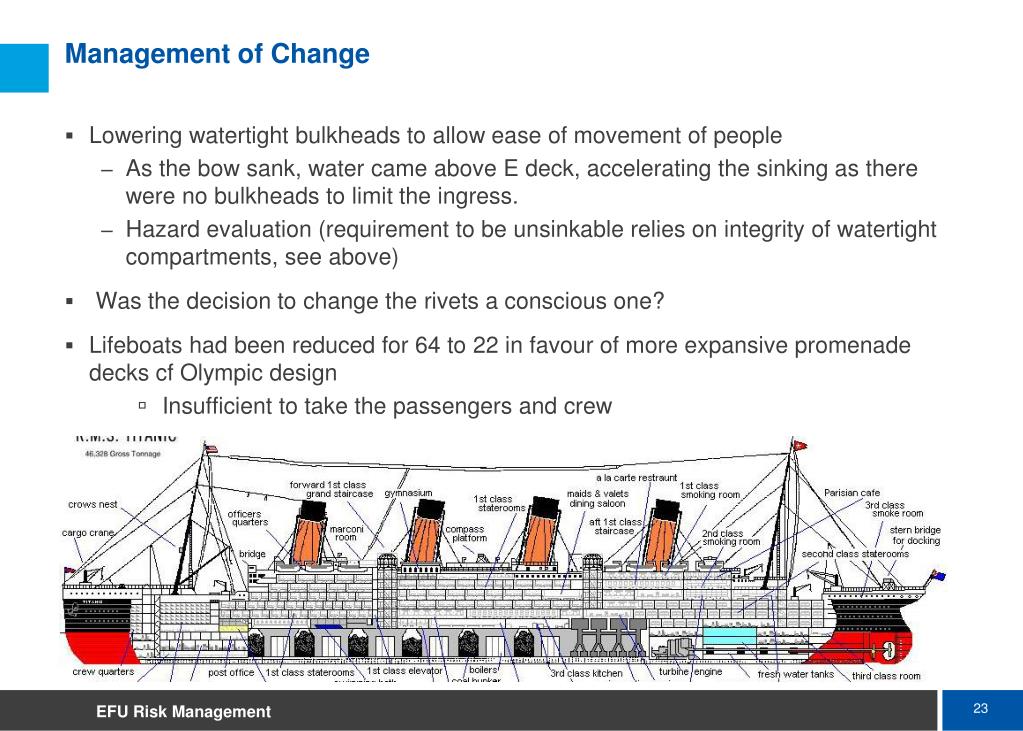

  24. Management of Change • Lowering watertight bulkheads to allow ease of movement of people • As the bow sank, water came above E deck, accelerating the sinking as there were no bulkheads to limit the ingress. • Hazard evaluation (requirement to be unsinkable relies on integrity of watertight compartments, see above) • Was the decision to change the rivets a conscious one? • Lifeboats had been reduced for 64 to 22 in favour of more expansive promenade decks cf Olympic design • Insufficient to take the passengers and crew EFU Risk Management

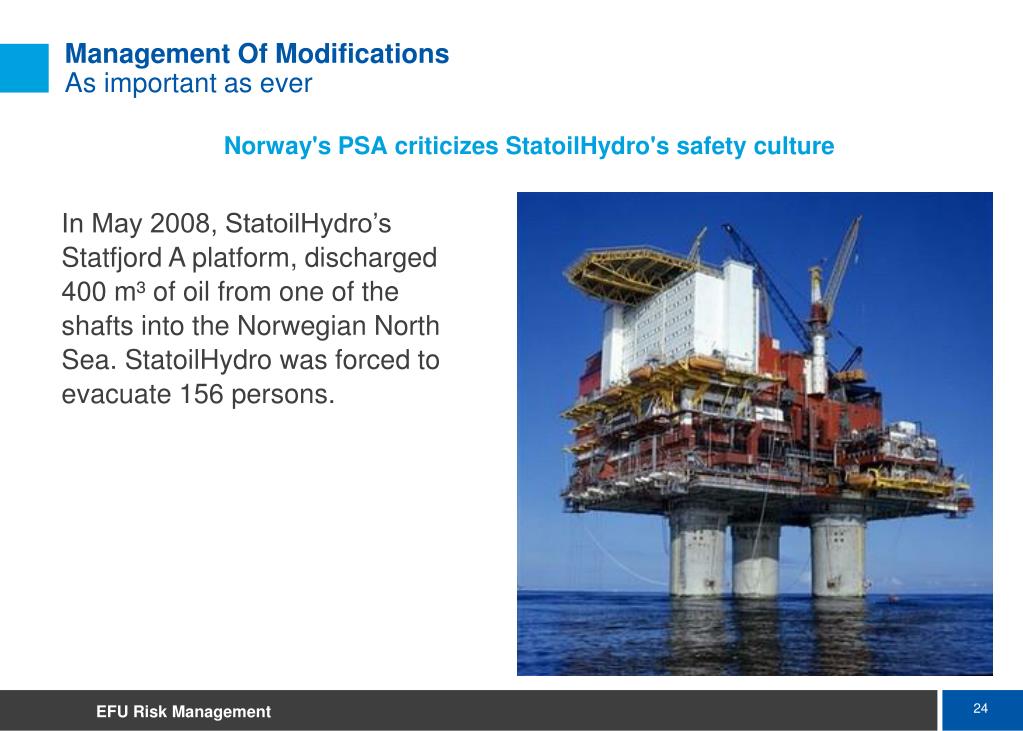

  25. Norway's PSA criticizes StatoilHydro's safety culture Management Of Modifications As important as ever In May 2008, StatoilHydro’s Statfjord A platform, discharged 400 m³ of oil from one of the shafts into the Norwegian North Sea. StatoilHydro was forced to evacuate 156 persons. EFU Risk Management

  26. Management Of Modifications As important as ever Norway's PSA criticises StatoilHydro's safety culture • LONDON, September 27 2008 – Norway’s Petroleum Safety Authority (PSA) has released a report attacking StatoilHydro's safety standards on the Norwegian continental shelf • PSA indicated dissatisfaction with the quality of the risk assessment StatoilHydro and partners Industrikonsult AS (IK) and Aker Solutions AS carried out for the modification work on Statfjord A's utility shaft. It said they had failed to meet regulatory standards • PSA issued an order to StatoilHydro to revamp its procedures for these types of projects by November 1. It also ordered that management of modificationimprovements be appreciably improved by December 1 • PSA also ordered Aker "to identify and implement necessary improvements in the company's management of modification assignments, including identification of risk and use of information about risk in planning and executing hazardous work operations, including the selection of work methods and equipment, and follow-up of subcontractors" EFU Risk Management

  27. Emergency Planning • Major accident potential (worst case scenario sinking) was discounted. • Emergency response arrangements (total lifeboat capacity of 1,172 for maximum number of passengers and crew of 3,547, however complying with regulatory requirements. • Original design had just about enough lifeboats • The officers on board The Titanic had not trained with the lifeboats and were unsure of their holding capacity. • Smith often claimed to have never faced a “near disaster” • Reportedly his performance deteriorated in the last two hours. • Many people could not read the English signs • There was not a standing safety-response plan.. the ‘Women and Children first’ response was a (commendable) reaction more than a previously-agreed plan. EFU Risk Management

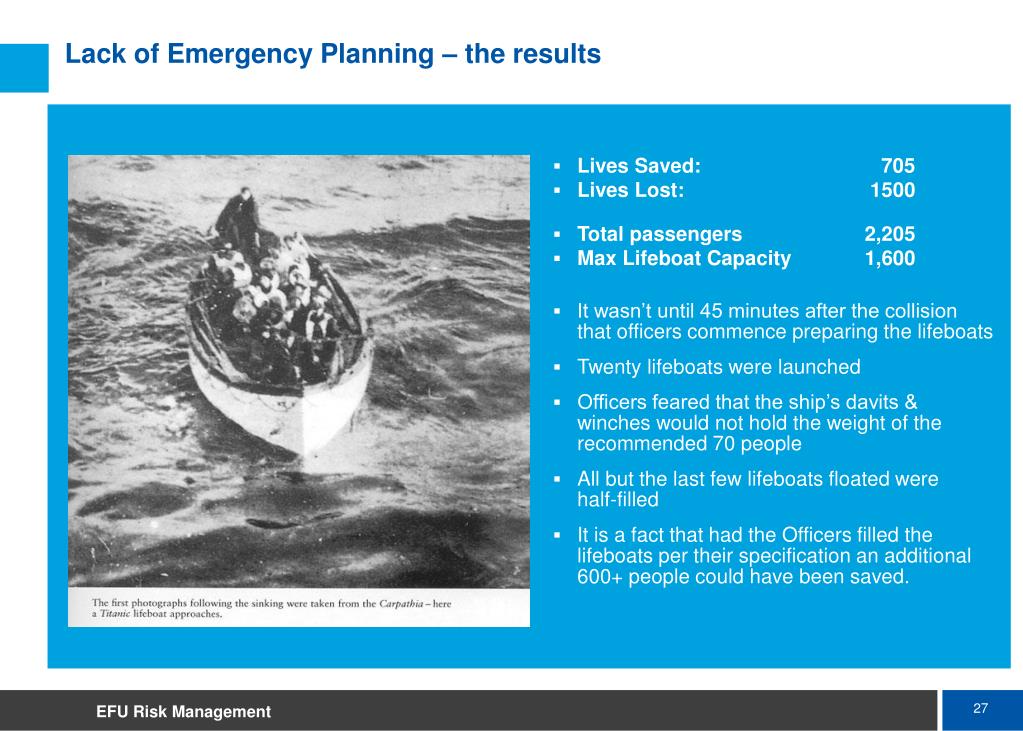

  28. Lives Saved: 705 • Lives Lost: 1500 • Total passengers 2,205 • Max Lifeboat Capacity 1,600 • It wasn’t until 45 minutes after the collision that officers commence preparing the lifeboats • Twenty lifeboats were launched • Officers feared that the ship’s davits & winches would not hold the weight of the recommended 70 people • All but the last few lifeboats floated were half-filled • It is a fact that had the Officers filled the lifeboats per their specification an additional 600+ people could have been saved. Lack of Emergency Planning – the results EFU Risk Management

  29. Does learning have a shelf life? • The lessons from Titanic are still relevant today • There are good lessons which cross between industries • “Can we learn from the past”….the Risk Engineering team would say yes! EFU Risk Management

  30. Learning From Losses – The Insurance Perspective • Much has been written on learning from incidents • Almost all clients have incident reporting systems • Few formal systems for ‘third party’ incidents • Major incidents occur relatively often somewhere • Focus has been mainly on personnel safety • Lessons do not appear to be new • Major incidents continue to occur • Lessons are well documented, but not always learnt by other organisations • A number of possible reasons for this exist EFU Risk Management

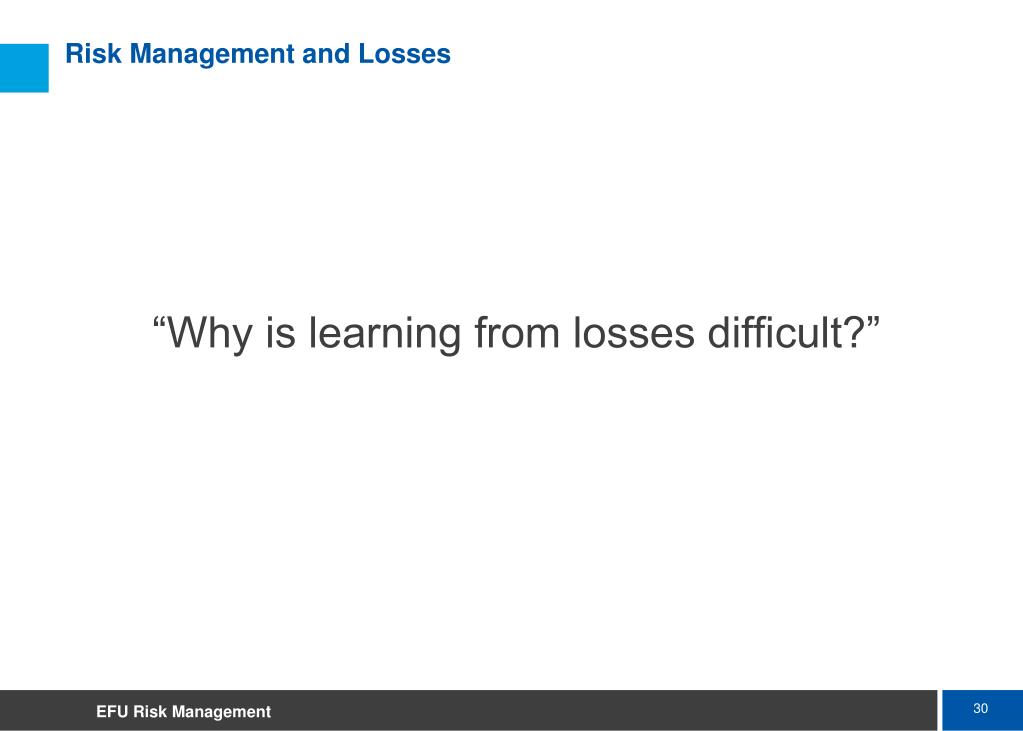

  31. “Why is learning from losses difficult?” Risk Management and Losses EFU Risk Management

  32. (Not) learning from positive results • Learning from Transformer fires ? • See plenty of transformers with no dividing fire walls • See plenty of large transformers with no deluge systems EFU Risk Management

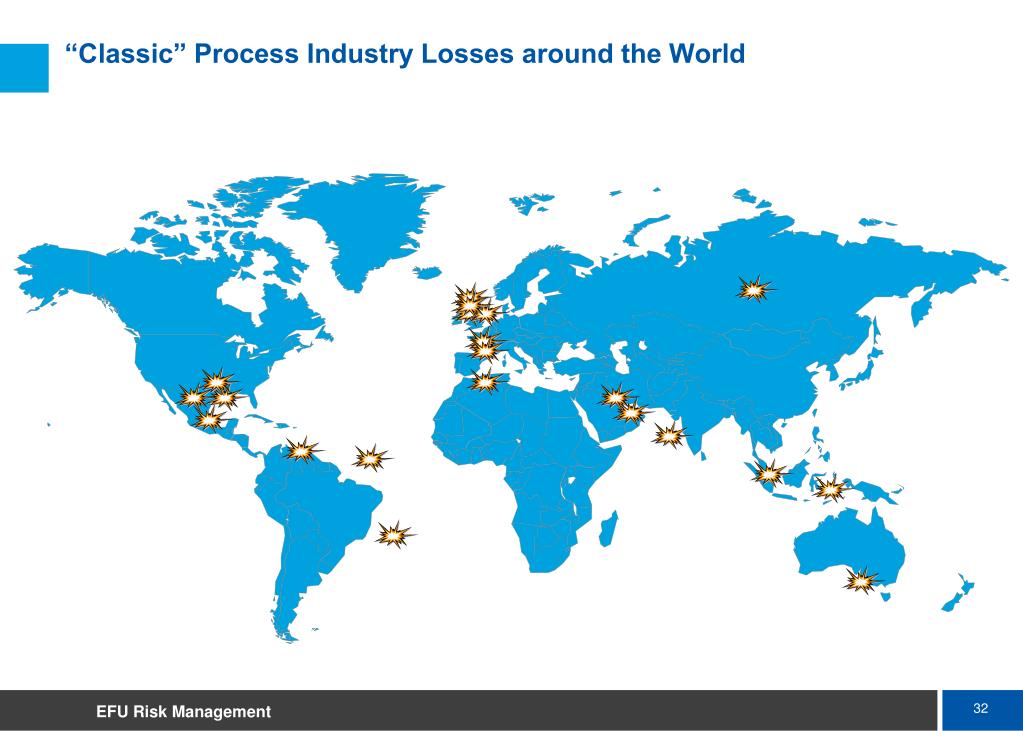

  33. “Classic” Process Industry Losses around the World EFU Risk Management

  34. Date 2004 Country Algeria Fatalities 27 Injuries 80

  35. Date 2005 Country India Fatalities 13 Injuries 300 Financial Loss (PD) USD 380m

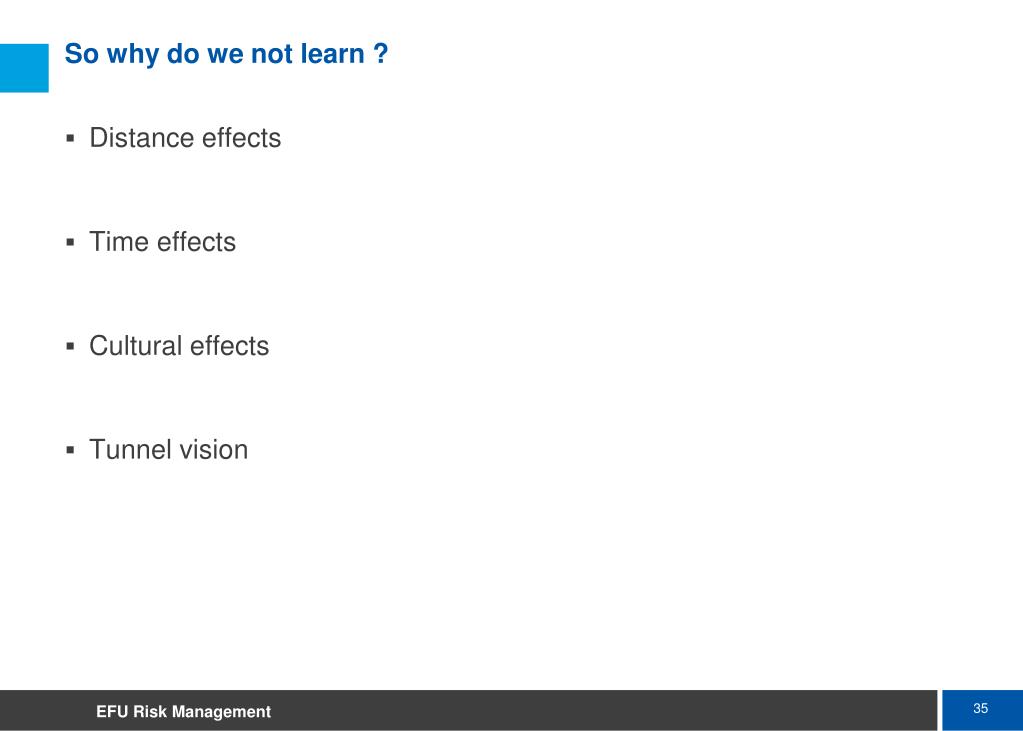

  36. So why do we not learn ? • Distance effects • Time effects • Cultural effects • Tunnel vision EFU Risk Management

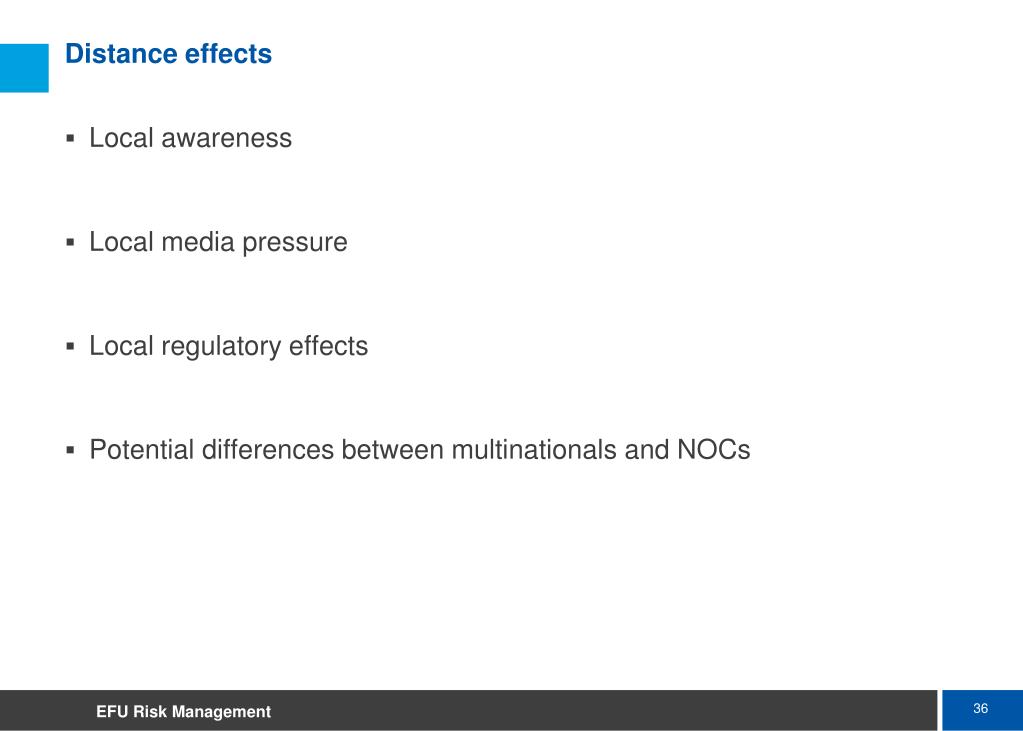

  37. Distance effects • Local awareness • Local media pressure • Local regulatory effects • Potential differences between multinationals and NOCs EFU Risk Management

  38. 1966 France 1975 UAE 1987 UK 1989 Indonesia 1993 Venzuela 2000 Kuwait 2005 USA 1984 Mexico 1988 Brazil 1992 France 1998 Australia 2004 Algeria 2005 UK 1974 UK Incident Timeline EFU Risk Management

  39. Time effects • “Time is a great healer” • Loss of experienced people • Loss of corporate memory • Young companies • Not just in the Middle East • Understanding Risk can change with age of plant • “Has worked fine for 20 years” EFU Risk Management

  40. Losses by Age of Process Unit (excluding Nat Cat.) Only includes losses where age of process plant known (sample size of 79 losses) 65% of losses involve process units >30 years old Typical design life 25-30 years Losses by Age of Process Unit 3,500 3,000 2,500 2,000 Total Loss (USD Millions) 1,500 1,000 500 0 <10yrs 10 to 20yrs 20 to 30yrs >30yrs Source: LIU Loss Database Loss Trends and Analysis EFU Risk Management

  41. Cultural effects • “It has not happened here” • Engineers like to believe things work – not consider failure • Flawed assumptions re “international standards” • Personnel safety vs Process safety • Fear of litigation • Fear of blame • Difficulty in challenging upwards in some cultures EFU Risk Management

  42. Tunnel vision • Within a site • Within a division • Within a company • Within the industry • “Unsinkable”, “built to compete” • Focus is on projects, rationalisation, expansion, staying afloat EFU Risk Management

  43. Date 1966 Country France Fatalities 18 Injuries 18 Extensive damage to nearby village Feyzin, France 1966

  44. FEYZIN 1966 – The Lessons • Design sphere drains / sample points • with fixed valve handles • to discharge outside shadow of sphere • no catch pits under spheres • Improved training about: • importance of correct valve sequence and operating procedures • BLEVE can occur with water sprays and open relief valve • Improved means and training about raising the alarm • Coordination of emergency plans with public authorities to stop public traffic, etc. • Improve fire brigade response times EFU Risk Management

  45. The effect of distance, time, and language ? • Feyzin • French spheres generally good • Japanese spheres poorer • Recent Japanese-designed installations below average • Recent survey found plant with most ball-valve handles removed EFU Risk Management

  46. What was learnt from these 2 incidents? EFU Risk Management

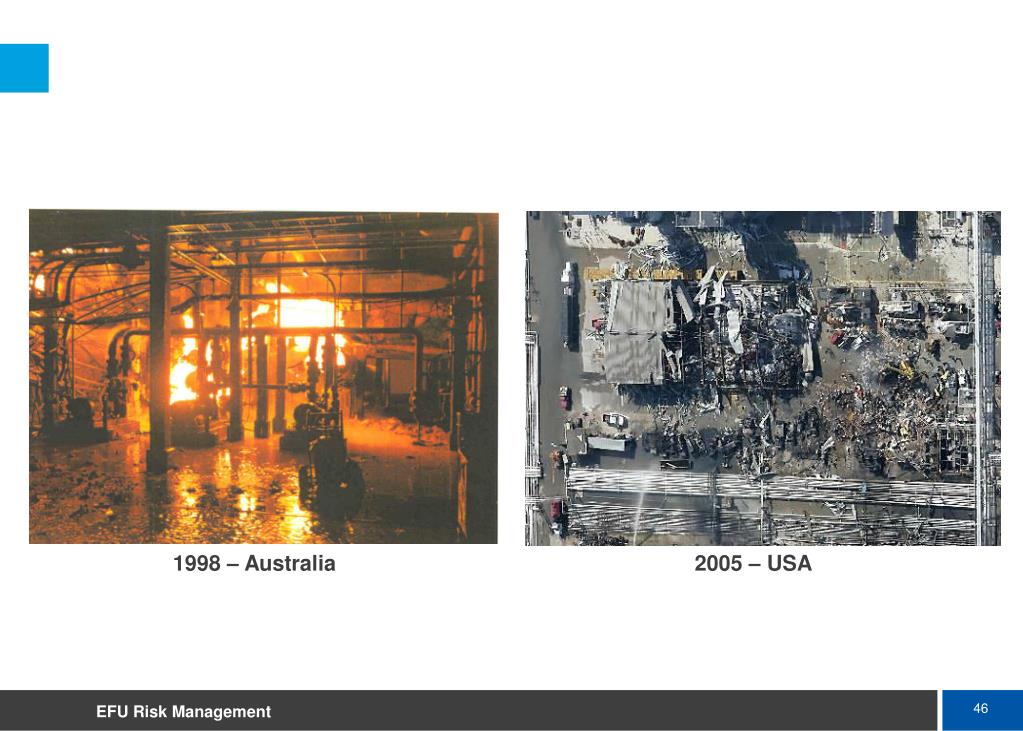

  47. 1998 – Australia 2005 – USA EFU Risk Management

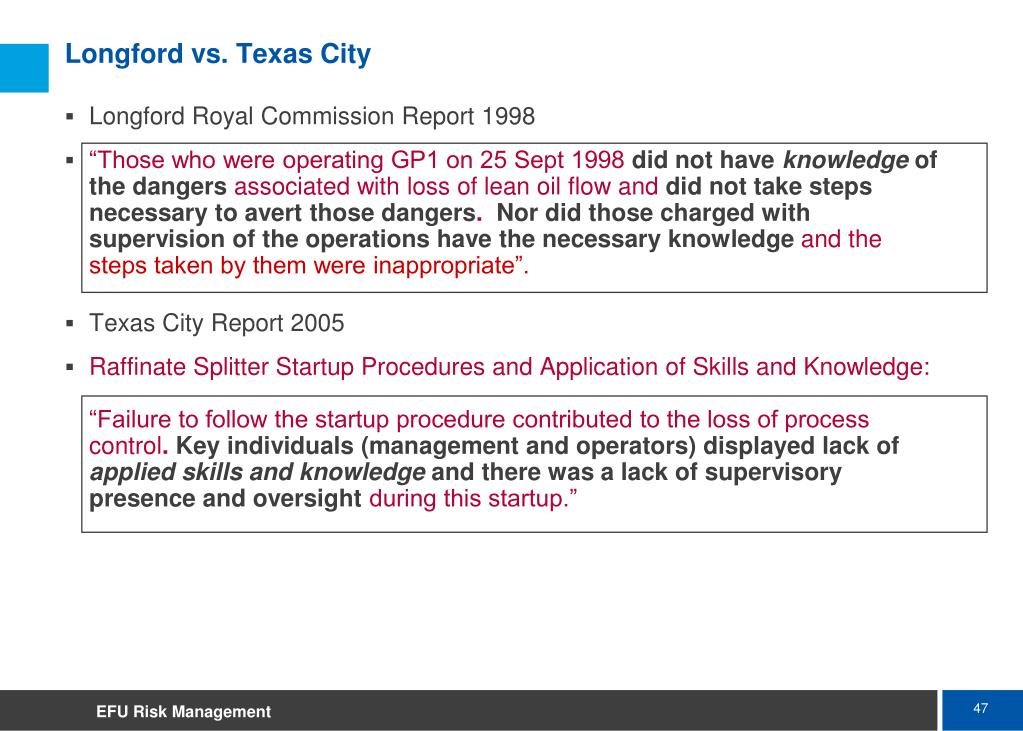

  48. Longford Royal Commission Report 1998 “Those who were operating GP1 on 25 Sept 1998 did not haveknowledgeof the dangers associated with loss of lean oil flow and did not take steps necessary to avert those dangers. Nor did those charged with supervision of the operations have the necessary knowledge and the steps taken by them were inappropriate”. Texas City Report 2005 Raffinate Splitter Startup Procedures and Application of Skills and Knowledge:“Failure to follow the startup procedure contributed to the loss of process control. Key individuals (management and operators) displayed lack of applied skills and knowledge and there was a lack of supervisory presence and oversightduring this startup.” Longford vs. Texas City EFU Risk Management

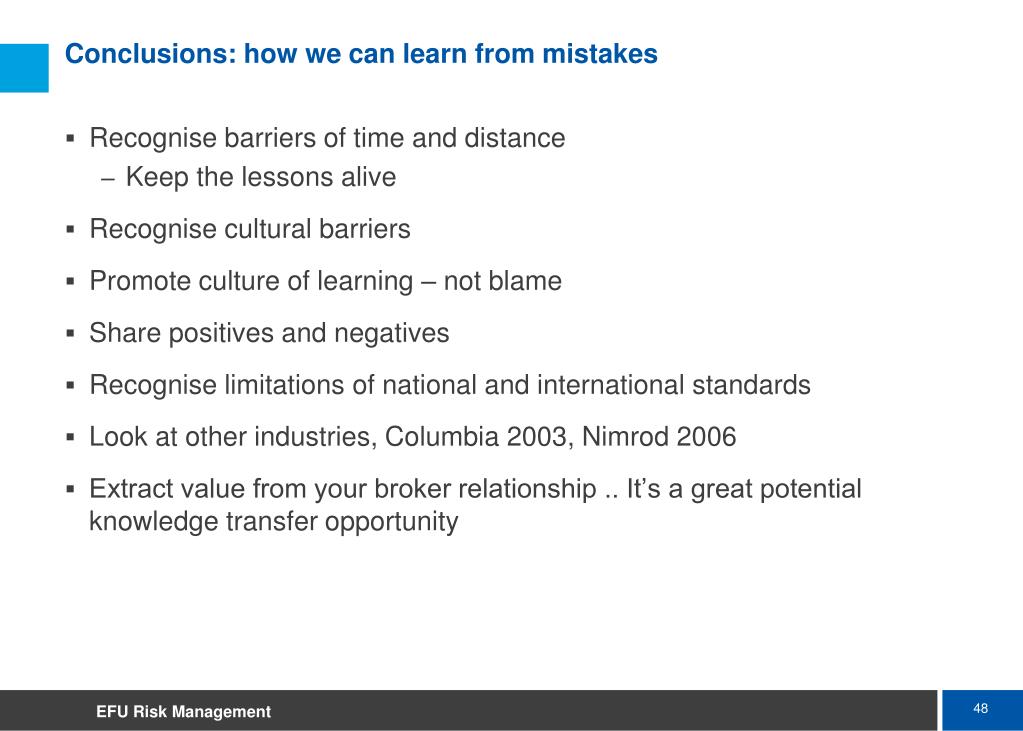

  49. Conclusions: how we can learn from mistakes • Recognise barriers of time and distance • Keep the lessons alive • Recognise cultural barriers • Promote culture of learning – not blame • Share positives and negatives • Recognise limitations of national and international standards • Look at other industries, Columbia 2003, Nimrod 2006 • Extract value from your broker relationship .. It’s a great potential knowledge transfer opportunity EFU Risk Management

More Related
