An Image/Link below is provided (as is) to download presentation Download Policy: Content on the Website is provided to you AS IS for your information and personal use and may not be sold / licensed / shared on other websites without getting consent from its author. Content is provided to you AS IS for your information and personal use only. Download presentation by click this link. While downloading, if for some reason you are not able to download a presentation, the publisher may have deleted the file from their server. During download, if you can't get a presentation, the file might be deleted by the publisher.

E N D

Presentation Transcript


  1. Presentation on Project Review of ONGC’s D1 Well Cum Water Injection Platform

  2. Project General Information

  3. Project General Information (cont…)

  4. Project General Information (cont...)

  5. Project Highlights 1. Project Overall • 5.8% progress achieved against schedule 7.9%. 2. Engineering • 34.7% progress achieved against schedule 35.7%. • All 41 nos. Process deliverables for D1 platform issued for ONGC review / approval, 25 nos. approved and balance are under approval. • For Sagar Lakshmi, 18 nos. Process deliverables against scheduled 15 nos. issued, 5 nos. approved, balance under discussion and approval.

  6. Project Highlights (Contd…) 2. Engineering (contd...) • All 3 equipment layouts for D1 finalized with ONGC. • For D1 platform, 16 nos. Piping deliverables issued against scheduled 17 nos. and 6 nos. approved. For Sagar Lakshmi Modification 6 nos. issued against scheduled 6 nos. and 4 nos. approved. Balance under discussion and approval. • 58 nos. Jacket and Deck Structural deliverables issued against 22 nos. scheduled, 15 nos. approved. Balance are under ONGC review. • 76 nos. MR issued out of 94 nos. scheduled, balance expected to be issued by 31/07/04.

  7. Project Highlights (Contd…) 3. Procurement • 9.4% progress achieved against schedule 14.9% • 46 nos. enquiries issued against 85 nos. scheduled, and order placed for 4 nos. (Main Injection Pumps, Fine Filter, SPM / PLEM and Control Valves). • Pre-Engineering Survey and Third Party Inspection contracts awarded. Bids (5 nos.) for Installation tender under review. Bids for Sagar Lakshmi Modification work due on 30/07/04.

  8. Status of Field Activities 1. Pre-Engineering Survey • For D1 platform, survey work completed, final report issued to ONGC on 05/07/04. • For Sagar Lakshmi Modification, survey work carried out by EIL. Survey report issued for ONGC review on 18/06/2004. ONGC comments received. 2. Procurement by SIME (Sub - Contractor) • Activities pertaining to finalization of MTO and steel procurement in progress. Order for plates placed for fabrication of Conductors and Piles. Detailed fabrication schedule with material delivery interface from SIME under finalization.

  9. Progress Statistics as of 24.07.2004Project Overall - Unit Wise

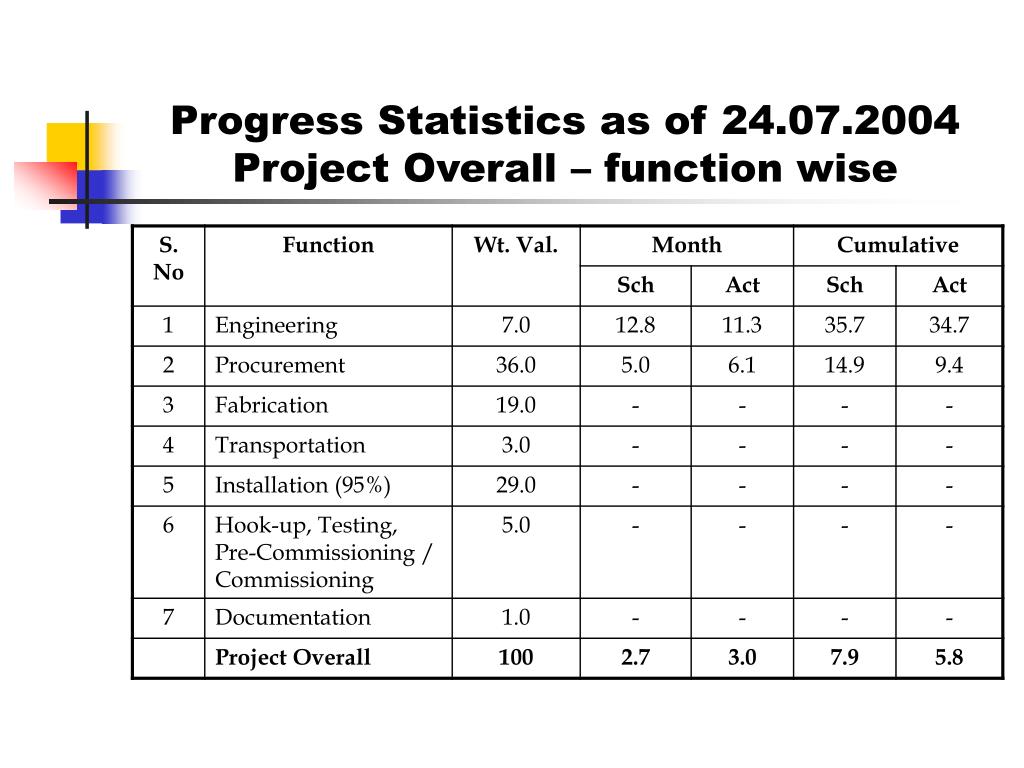

  10. Progress Statistics as of 24.07.2004Project Overall – function wise

  11. Drawings / Documents Summary Status as of 22.07.2004 D1 Platform

  12. Drawings / Documents Status as of 22.07.2004 Sagar Lakshmi / Pipeline / SPM - PLEM

  13. Status of deliverables under Review / Approval

  14. Status of Critical Items as of 24.07.2004

  15. Ordering Status (Sime procured items) as of 22.07.2004 D1 Platform Out of 49 nos. MRs issued, ordering activities for 33 nos. are in progress

  16. Ordering / Tendering Status as of 24.07.2004 Sagar Lakshmi / SPM - PLEM / Pipelines / Tenders

  17. Ordering Catch-up Plan - Sagar Lakshmi

  18. Ordering Catch-up Plan - Sagar Lakshmi

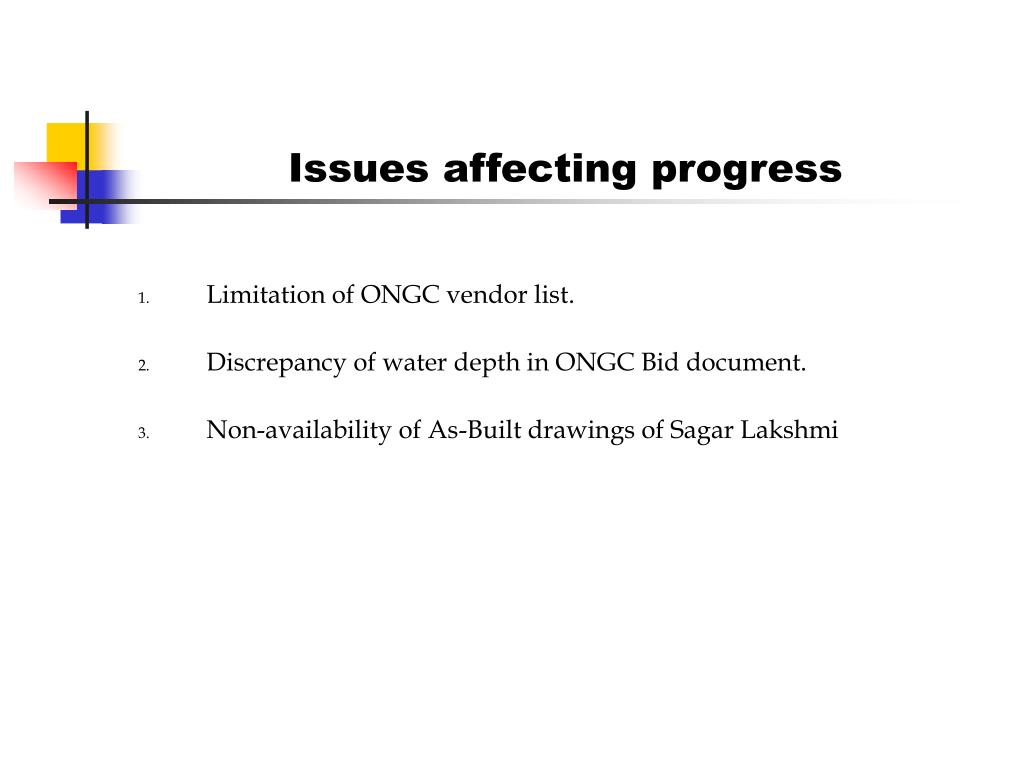

  19. Issues affecting progress • Limitation of ONGC vendor list. • Discrepancy of water depth in ONGC Bid document. • Non-availability of As-Built drawings of Sagar Lakshmi

  20. Support required from ONGC • Signing of ONGC - EIL contract. • Approval of drawings / documents across the table at Design Center. • Identifying interfaces between ONGC and Certification agency.

  21. Thank You
