software project management

Software Project Management

Session 6: MS-Project Intro & Mid-term Exam

Q7503, Principles of Project Management, Fall 2002

today

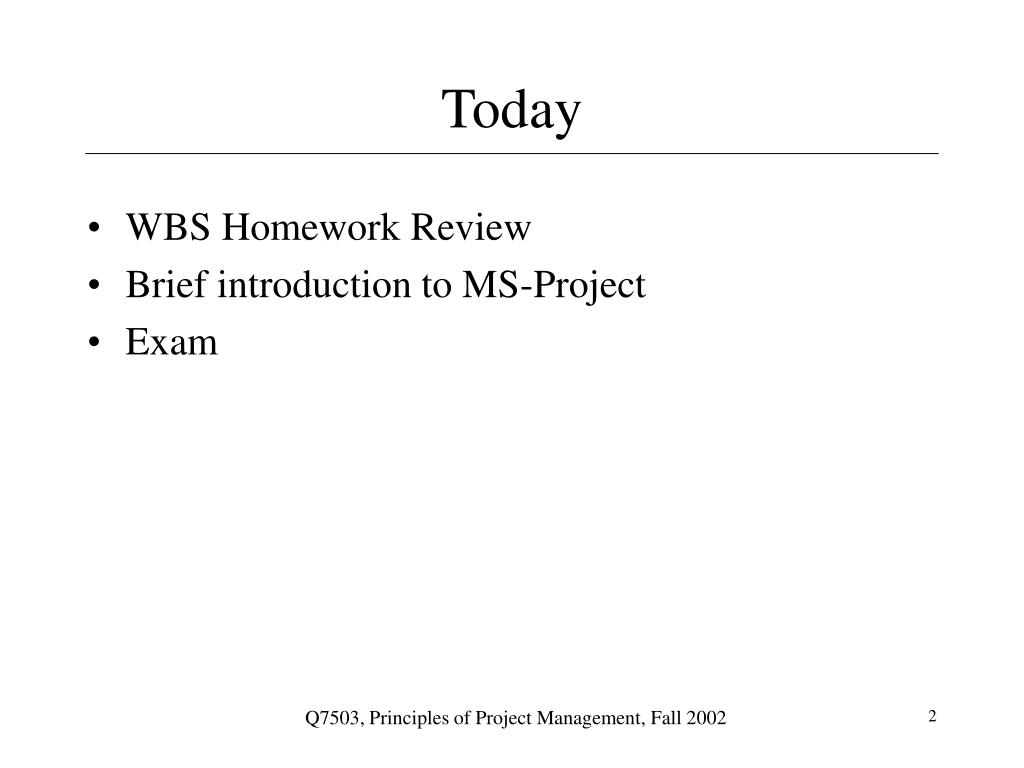

Today
  • WBS Homework Review
  • Brief introduction to MS-Project
  • Exam

Q7503, Principles of Project Management, Fall 2002

wbs review
WBS Review
  • For process approaches
    • It sometimes appears that you think requirements = analysis = design
    • Or that doing a few diagrams (ERD, DFD) = requirements
  • Consistency
    • Consistent use of verb+noun descriptions of activities
  • Language
    • Inclusion of some phases but missing others
      • Some at beginning, some at end
  • Use of a spell checker (spelling counts in project plans too)

Q7503, Principles of Project Management, Fall 2002

wbs review4
WBS Review
  • Disappearing ‘plot lines’
    • Like designing a network or choosing hardware but never implementing
  • Consistency across phases
    • If ‘Development’ includes four major modules, typically ‘Design’ should reflect those same four
  • If using a ‘process’ model, then there should be a visible ‘flow’ to the process
    • Not like this: Systems Engineering, Hardware & Software, Project Management, Test, Training, Site Implementation

Q7503, Principles of Project Management, Fall 2002

wbs review5
WBS Review
  • Some MS-Project plans had all 1 day assignments,
      • That\'s good for this point of process
      • This is prior to estimation
  • Tone & Content
    • Some are very “generic”
      • Tell me nothing about your system
      • Not enough to say \'requirements, analysis, design, etc, done’

Q7503, Principles of Project Management, Fall 2002

wbs review6
WBS Review
  • Some activities overly general \'Control Project‘
  • Forget things at equal level like ‘architecture design’
  • Think all activities through
  • Aim for a consistent level of detail
  • Know the basic order of things: testing doesn’t occur before development
    • Other details: QA is not part of ‘Rollout’
  • I am lenient now but will be less so going forward

Q7503, Principles of Project Management, Fall 2002

ms project
MS-Project
  • Mid-market leader
  • Has approx. 50% overall market share
  • 70-80% MS-Project users never used automated project tracking prior (a “first” tool)
  • Not a mid/high-end tool for EPM (Enterprise Project Mgmt.)

Q7503, Principles of Project Management, Fall 2002

project pros
Project Pros
  • Easy outlining of tasks
  • Resource management
  • Accuracy: baseline vs. actual; various calculations
  • Easy charting and graphics
  • Cost management
  • Capture historical data

Q7503, Principles of Project Management, Fall 2002

project cons

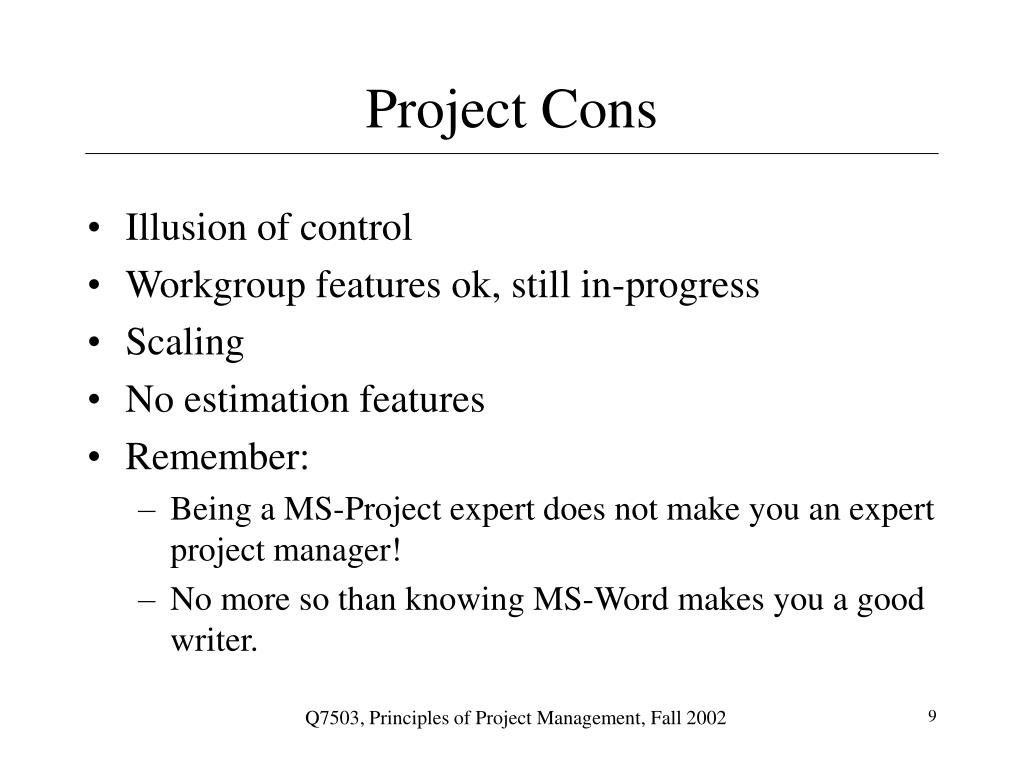

Project Cons
  • Illusion of control
  • Workgroup features ok, still in-progress
  • Scaling
  • No estimation features
  • Remember:
    • Being a MS-Project expert does not make you an expert project manager!
    • No more so than knowing MS-Word makes you a good writer.

Q7503, Principles of Project Management, Fall 2002

the ms project process
The MS-Project Process
  • Move WBS into a Project outline (in Task Sheet)
  • Add resources (team members or roles)
  • Add costs for resources
  • Assign resources to tasks
  • Establish dependencies
  • Refine and optimize
  • Create baseline
  • Track progress (enter actuals, etc.)

Q7503, Principles of Project Management, Fall 2002

project overview
Project Overview
  • This is a ‘quickie’ overview
  • We will return to all of these steps individually over the next few weeks
  • Sample project from McConnell

Q7503, Principles of Project Management, Fall 2002

project ui

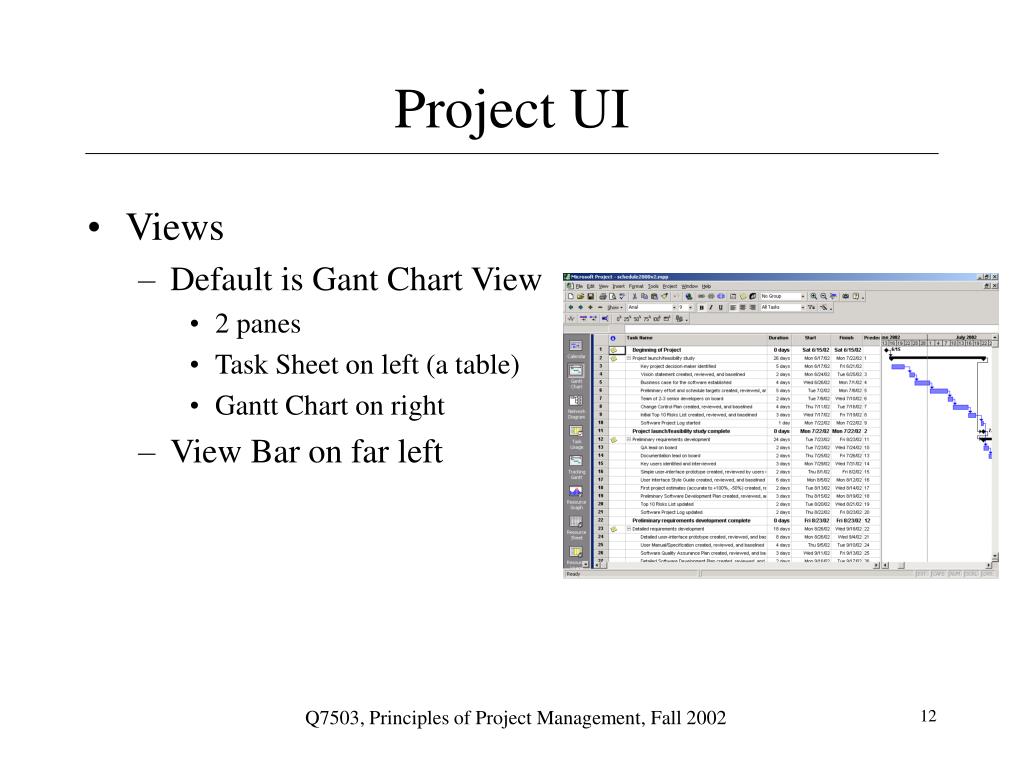

Project UI
  • Views
    • Default is Gant Chart View
      • 2 panes
      • Task Sheet on left (a table)
      • Gantt Chart on right
    • View Bar on far left

Q7503, Principles of Project Management, Fall 2002

project ui13
Project UI

Q7503, Principles of Project Management, Fall 2002

create your project
Create Your Project
  • File/New
  • Setup start date
  • Setup calendar
    • Menu: Project/Project Information
    • Often left with default settings
    • Hours, holidays

Q7503, Principles of Project Management, Fall 2002

enter wbs

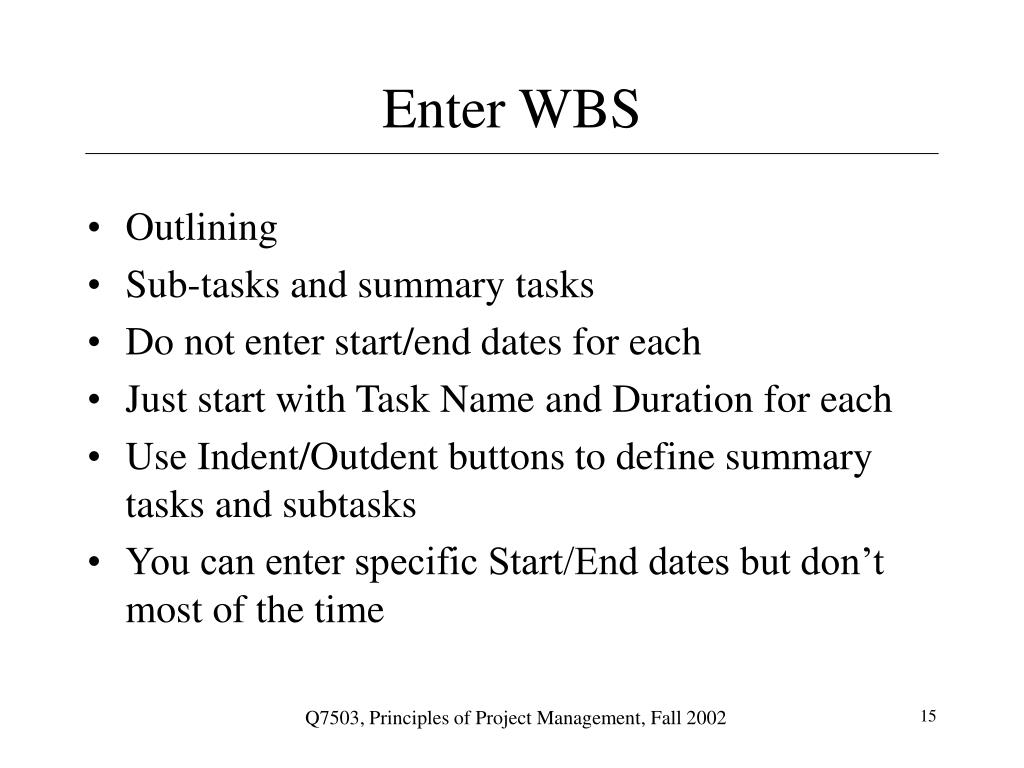

Enter WBS
  • Outlining
  • Sub-tasks and summary tasks
  • Do not enter start/end dates for each
  • Just start with Task Name and Duration for each
  • Use Indent/Outdent buttons to define summary tasks and subtasks
  • You can enter specific Start/End dates but don’t most of the time

Q7503, Principles of Project Management, Fall 2002

establish durations
Establish Durations
  • Know the abbreviations
    • h/d/w/m
    • D is default
  • Can use partial
    • .5d is a half-day task
  • Elapsed durations
  • Estimated durations
    • Put a ‘?’ after duration

Q7503, Principles of Project Management, Fall 2002

add resources
Add Resources
  • Work Resources
    • People
  • Material Resources
    • Things
    • Can be used to track costs
      • Ex: amount of equipment purshased
    • Not used as often in typical software project

Q7503, Principles of Project Management, Fall 2002

resource sheet
Resource Sheet
  • Can add new resources here
    • Or directly in the task entry sheet
      • Beware of mis-spellings (Project will create near-duplicates)
  • Setup costs
    • Such as annual salary (put ‘yr’ after ‘Std. Rate’)

Q7503, Principles of Project Management, Fall 2002

effort driven scheduling
Effort-Driven Scheduling
  • MS-Project default
  • Duration * Units = Work
      • Duration = Work / Units (D = W/U)
      • Work = Duration * Units (W = D*U)
      • Units = Work / Duration (U = W/D)
  • Adding more resources to a task shortens duration
  • Can be changed on a per-task basis
      • In the advanced tab of Task Information dialog box
      • Task Type setting
  • Beware the Mythical Man-month
      • Good for laying bricks, not always so for software development

Q7503, Principles of Project Management, Fall 2002

link tasks
Link Tasks
  • On toolbar: Link & Unlink buttons
    • Good for many at once
  • Or via Gantt chart
    • Drag from one task to another

Q7503, Principles of Project Management, Fall 2002

milestones
Milestones
  • Zero duration tasks
  • Insert task ‘normally’ but put 0 in duration

Q7503, Principles of Project Management, Fall 2002

make assignments
Make Assignments
  • Approach 1. Using Task Sheet
    • Using Resource Names column
    • You can create new ones by just typing-in here
  • 2. Using Assign Resources dialog box
    • Good for multiple resources
    • Highlight task, Tools/Resources or toolbar button
  • 3. Using Task Information dialog
    • Resources tab
  • 4. Task Entry view
    • View/More Views/Task Entry
    • Or Task Entry view on Resource Mgmt. toolbar

Q7503, Principles of Project Management, Fall 2002

save baseline
Save Baseline
  • Saves all current information about your project
    • Dates, resource assignments, durations, costs

Q7503, Principles of Project Management, Fall 2002

fine tune
Fine Tune
  • Then is used later as basis for comparing against “actuals”
  • Menu: Tools/Tracking/Save Baseline

Q7503, Principles of Project Management, Fall 2002

project 2002
Project 2002
  • 3 Editions: Standard, Professional, Server
  • MS Project Server 2002
      • Upgrade of old “Project Central”
      • Includes “Project Web Access”, web-based UI (partial)
      • Workgroup and resource notification features
      • Requires SQL-Server and IIS
      • “Portfolio Analyzer”
        • Drill-down into projects via pivot tables & charts
      • “Portfolio Modeler”
        • Create models and “what-if” scenarios
      • SharePoint Team Services integration

Q7503, Principles of Project Management, Fall 2002

project 200226
Project 2002
  • MS-Project Professional
    • “Build Team” feature
      • Skills-based resource matching
    • Resource Pools: with skill set tracking
    • Resource Substitution Wizard
  • “Project Guide” feature
    • Customizable “process component”

Q7503, Principles of Project Management, Fall 2002

homework
Homework
  • McConnell: 5 “Risk Management”, 14 “Feature-Set Control”
  • Schwalbe: 10, “Project Risk Management”, Appendix A “Guide to Using Microsoft Project 2000” (447-477)
  • Install MS-Project if you haven’t done so already

Q7503, Principles of Project Management, Fall 2002

questions
Questions?

Q7503, Principles of Project Management, Fall 2002
