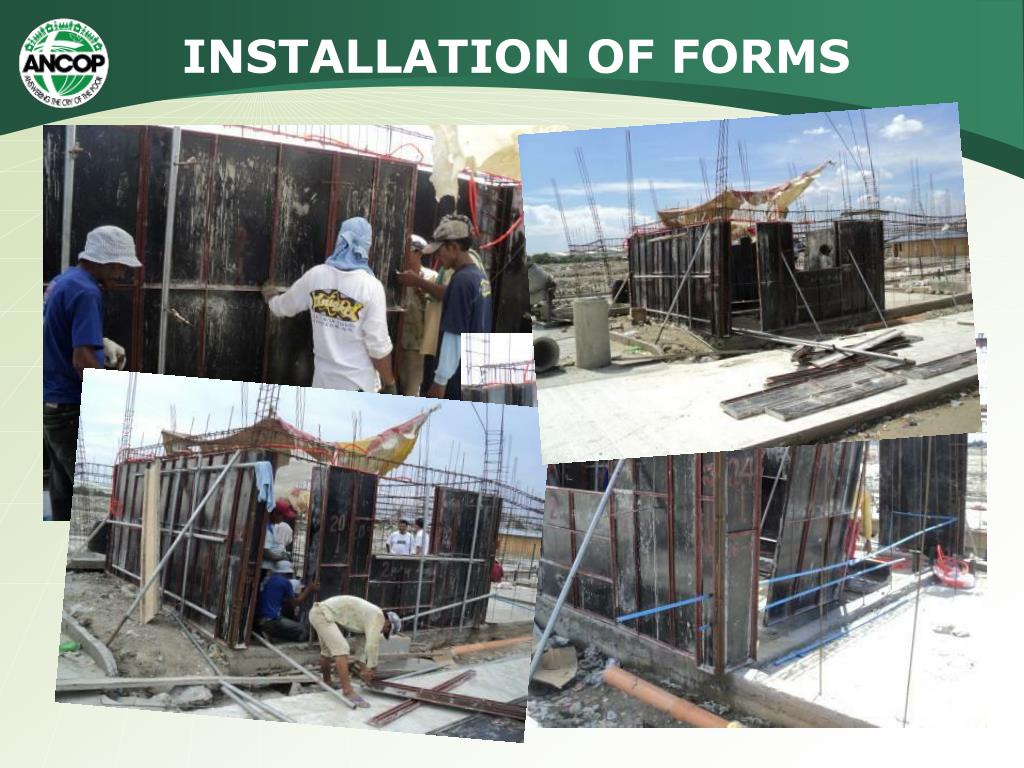

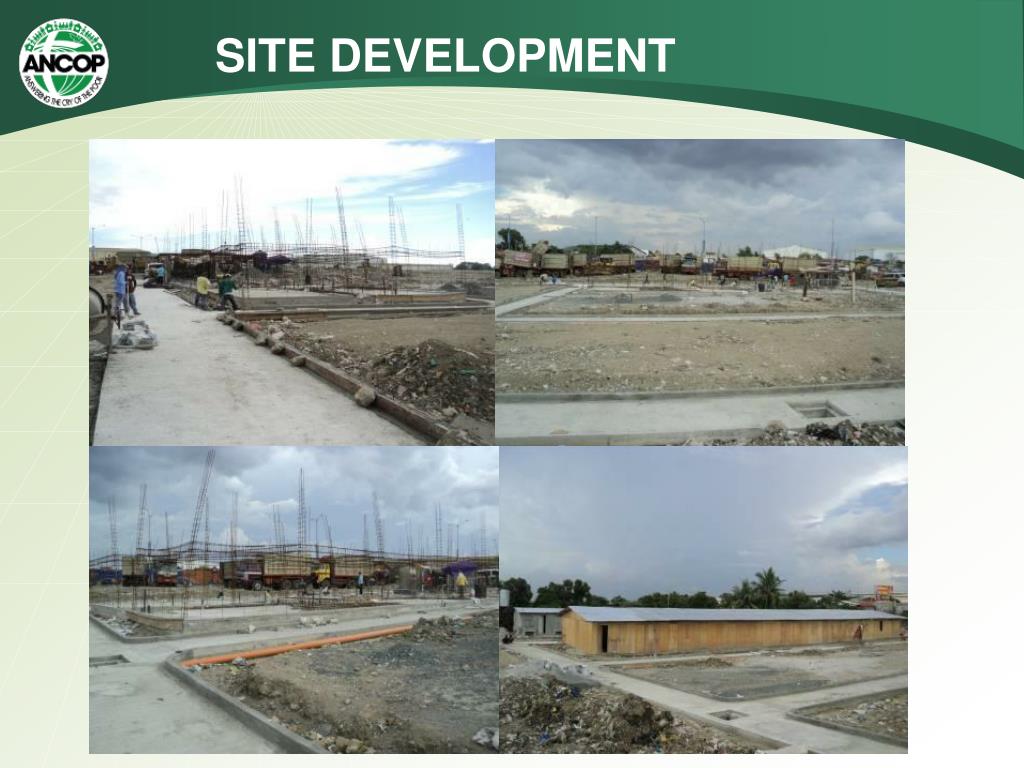

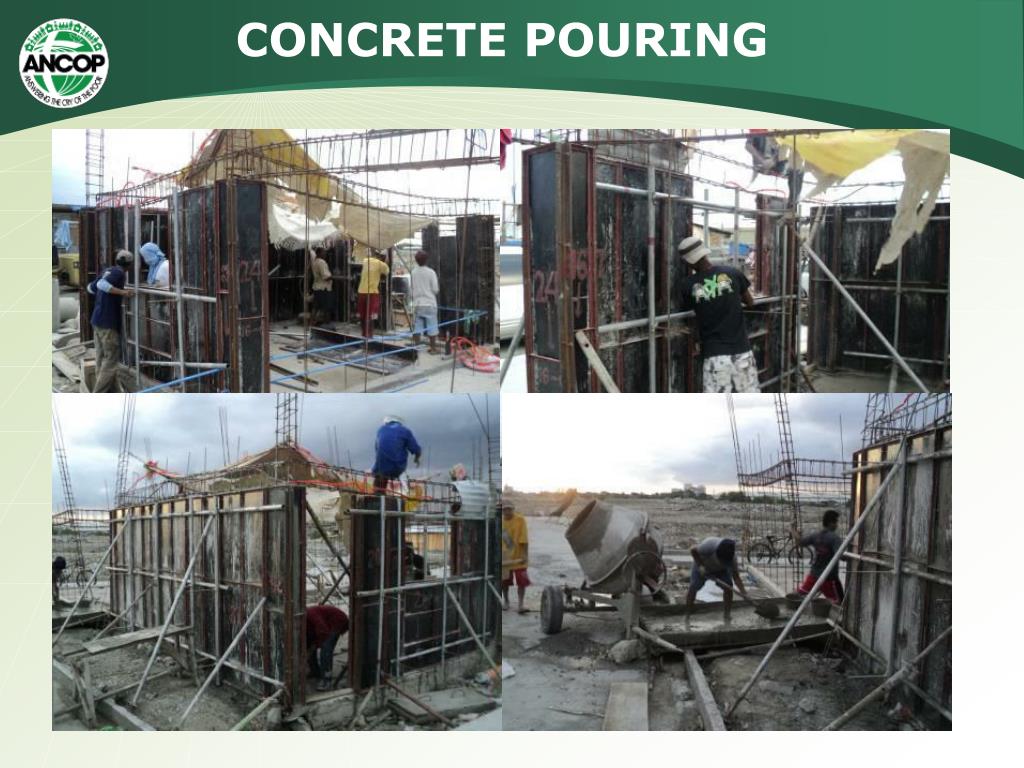

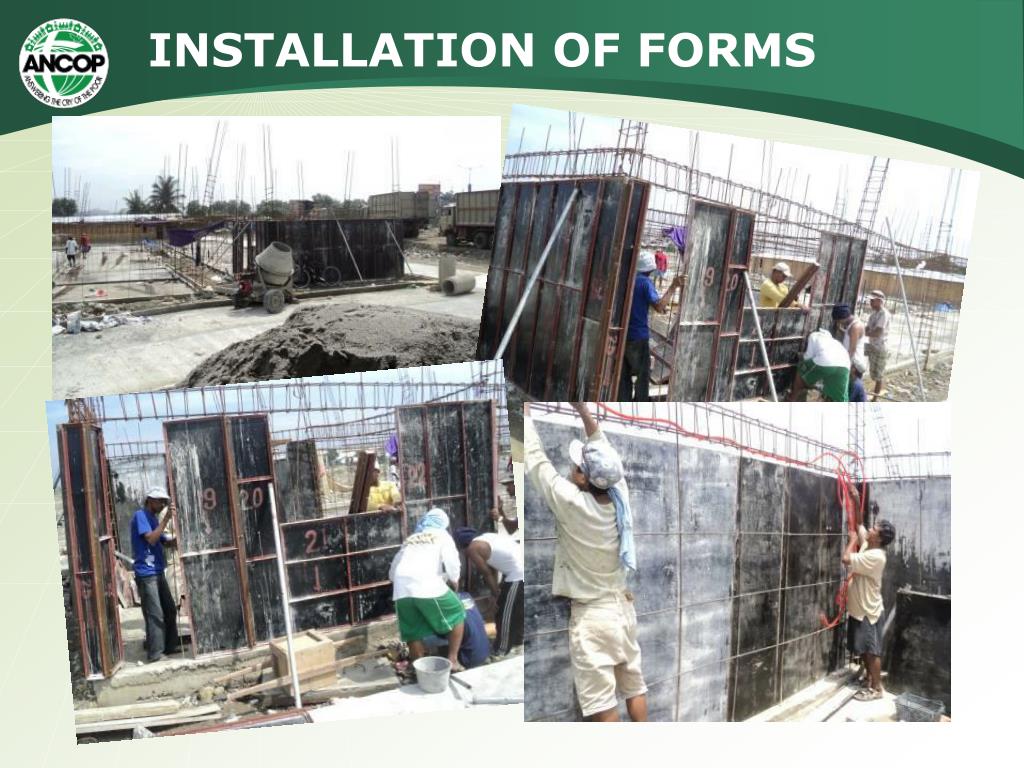

CFC ANCOP ROTARY HOMES. ANswering the Cry of the Poor. Shelter Program. INSTALLATION OF FORMS. INSTALLATION OF FORMS. Progress Report July 18, 2012. First Cluster-Maynilad Funded Houses. CONCRETE POURING. SITE DEVELOPMENT. FACTORS THAT CONSTRIBUTED TO THE DELAY

loader
I am the owner, or an agent authorized to act on behalf of the owner, of the copyrighted work described.
capcha
Download Presentation

PowerPoint Slideshow about ' ANswering the Cry of the Poor' - fifi

An Image/Link below is provided (as is) to download presentation

Download Policy: Content on the Website is provided to you AS IS for your information and personal use and may not be sold / licensed / shared on other websites without getting consent from its author.While downloading, if for some reason you are not able to download a presentation, the publisher may have deleted the file from their server.

- - - - - - - - - - - - - - - - - - - - - - - - - - E N D - - - - - - - - - - - - - - - - - - - - - - - - - -
Presentation Transcript
Answering the cry of the poor

CFC ANCOP ROTARY HOMES

ANswering the Cry of the Poor

Progress report july 18 2012

Progress Report July 18, 2012

First Cluster-Maynilad Funded Houses

  • FACTORS THAT CONSTRIBUTED TO THE DELAY

  • Condition of the site.

  • Difficulty in mobilization considering the simultaneous

  • work going on in the same area (house construction

  • and site development)

  • Lack of power supply.

  • Beneficiaries need to support the financial and material

  • requirements of their family.

  • Weather

  • Suitable site for forms fabrication.

  • Familiarization with the new technology.

What progress have we accomplished after june 18

WHAT PROGRESS HAVE WE ACCOMPLISHED AFTER JUNE 18?

FIRST CLUSTER CONSISTING OF 14 HOUSES

  • Program of works:

  • JULY

  • 3rd week-finish the wall partition for the 2nd floor of the first row.

  • 4th week-finish the walls of the 2nd row.

  • AUGUST

  • 1st week-put the c-parlenes and possibly the long span color roof.

  • 2nd week-fabrication and installation of doors and windows.

  • 3rd week-installing the kitchen zink and labatory and other finishing works.

  • Aug.24-BUILD DAY. (PAINTING)

DAYS WORK/UNIT

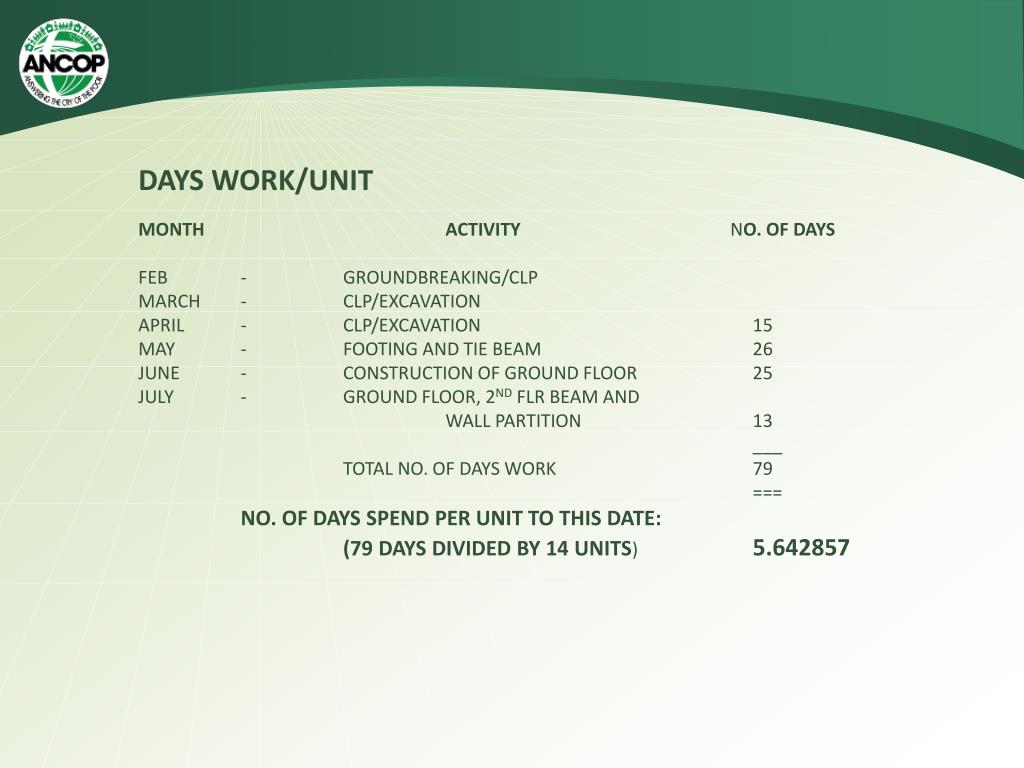

MONTHACTIVITY NO. OF DAYS

FEB - GROUNDBREAKING/CLP

MARCH - CLP/EXCAVATION

APRIL - CLP/EXCAVATION 15

MAY - FOOTING AND TIE BEAM 26

JUNE - CONSTRUCTION OF GROUND FLOOR 25

JULY - GROUND FLOOR, 2ND FLR BEAM AND

WALL PARTITION 13

___

TOTAL NO. OF DAYS WORK 79

===

NO. OF DAYS SPEND PER UNIT TO THIS DATE:

(79 DAYS DIVIDED BY 14 UNITS) 5.642857
