2011-12 winter shutdown preparatory meeting. A.Tauro 6-1-2012. V0.3. 2011-12 winter shutdown. EMC. Shielding. TRD. Shielding. Open L3. Close L3. TRD infrastructure. EMC infrastructure. Beam off: Dec 8 th at 6:00 AM Beam on: Mar 7 th at 18:00 PM.

Download Presentation

2011-12 winter shutdown preparatory meeting

An Image/Link below is provided (as is) to download presentation

Download Policy: Content on the Website is provided to you AS IS for your information and personal use and may not be sold / licensed / shared on other websites without getting consent from its author.While downloading, if for some reason you are not able to download a presentation, the publisher may have deleted the file from their server.


- - - - - - - - - - - - - - - - - - - - - - - - - - E N D - - - - - - - - - - - - - - - - - - - - - - - - - -

Presentation Transcript


2011 12 winter shutdown preparatory meeting

2011-12 winter shutdown preparatory meeting

A.Tauro

6-1-2012

ALICE 2011-12 winter shutdown schedule - A.Tauro


2011 12 winter shutdown

V0.3

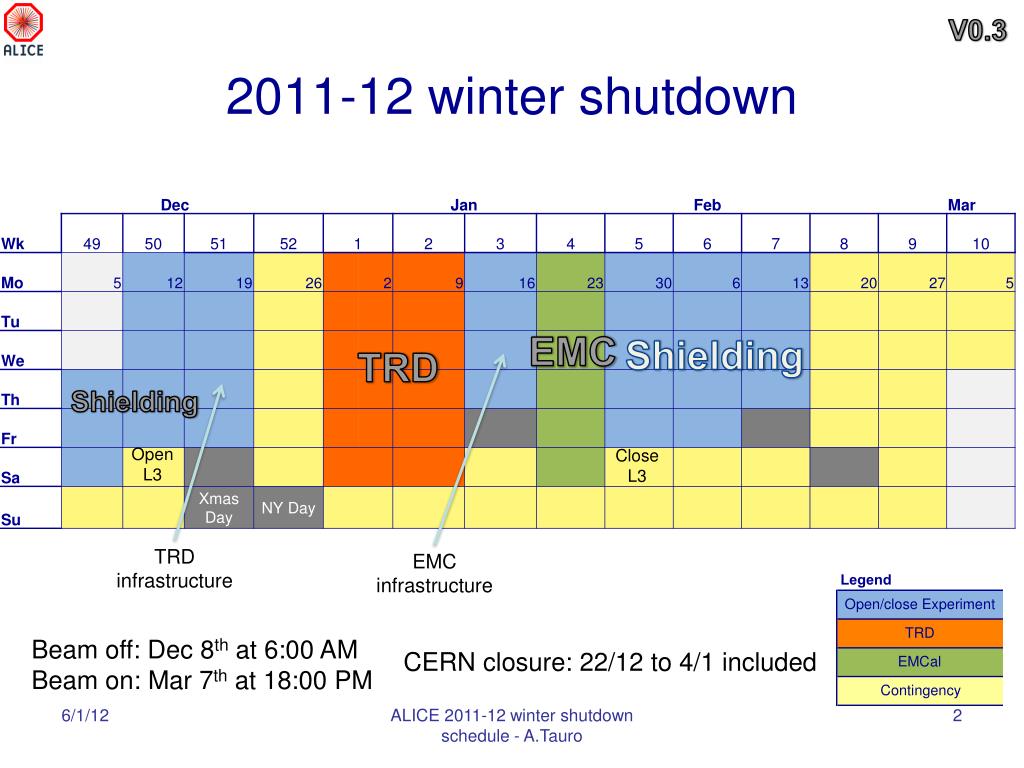

2011-12 winter shutdown

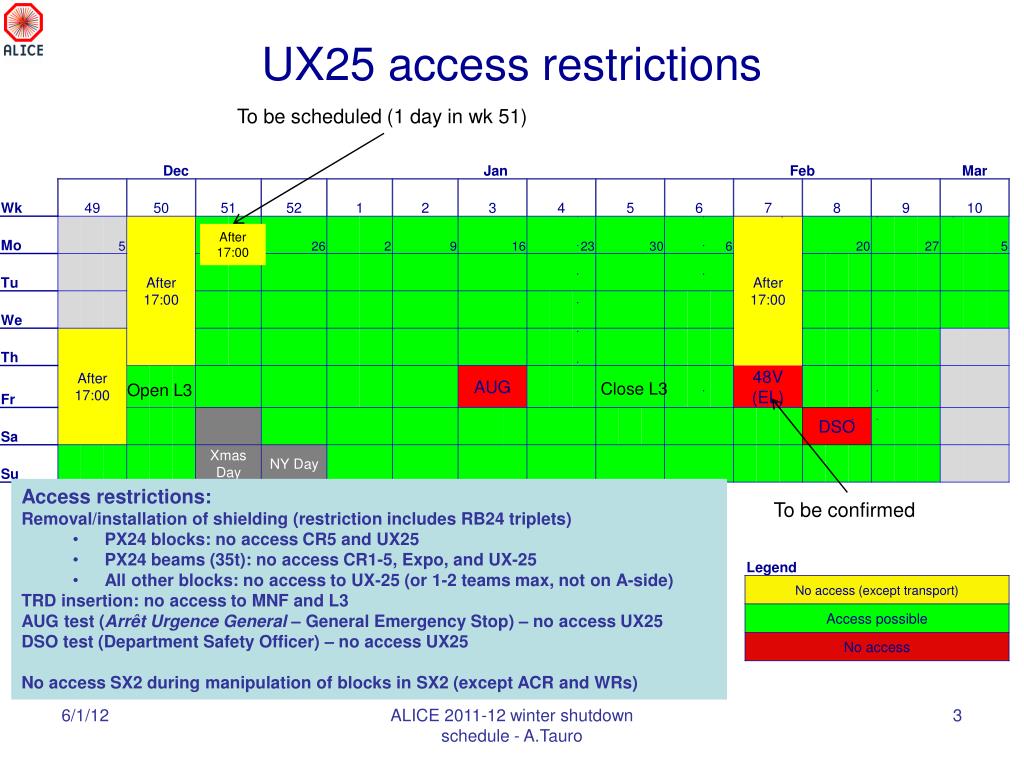

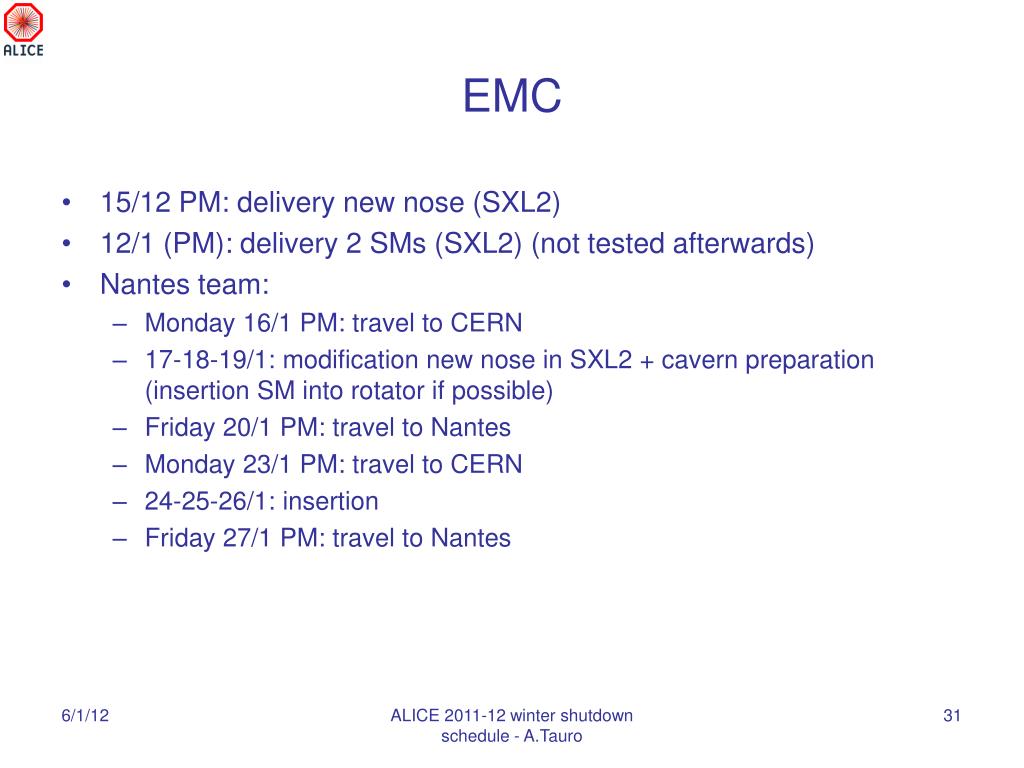

EMC

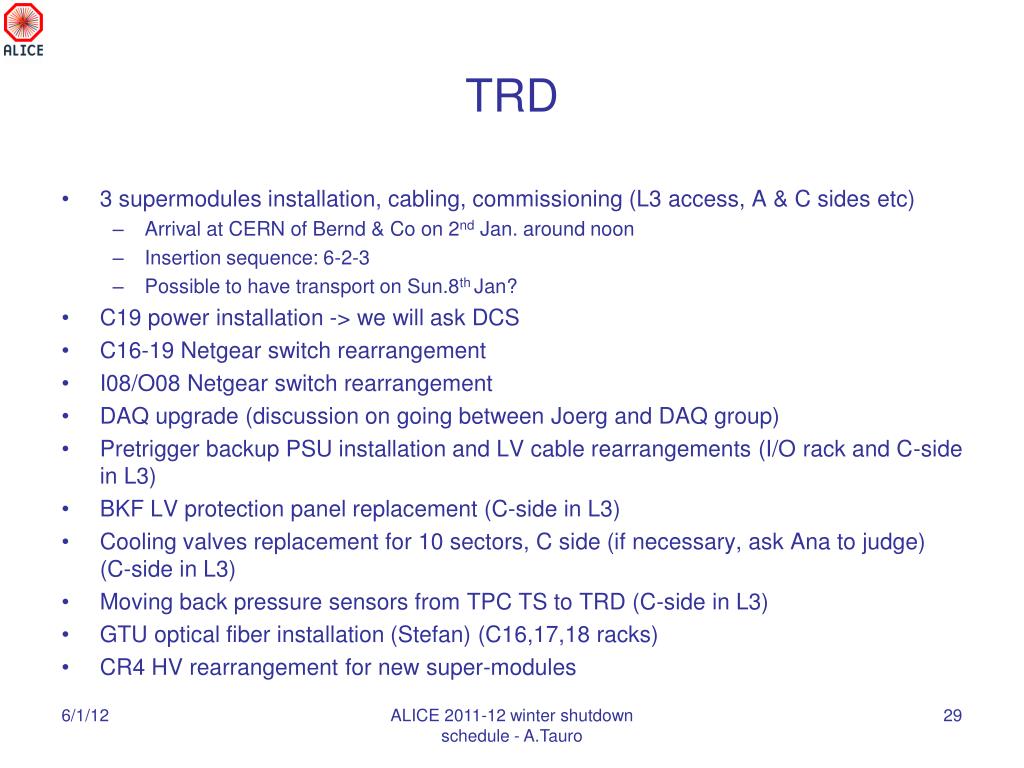

  • Shielding

TRD

Shielding

Open

L3

Close

L3

TRD infrastructure

EMC

infrastructure

Beam off: Dec 8th at 6:00 AM

Beam on: Mar 7th at 18:00 PM

CERN closure: 22/12 to 4/1 included

ALICE 2011-12 winter shutdown schedule - A.Tauro


2011 12 winter shutdown preparatory meeting

UX25 access restrictions

To be scheduled (1 day in wk 51)

After 17:00

Close L3

Open L3

Access restrictions:

Removal/installation of shielding (restriction includes RB24 triplets)

  • PX24 blocks: no access CR5 and UX25

  • PX24 beams (35t): no access CR1-5, Expo, and UX-25

  • All other blocks: no access to UX-25 (or 1-2 teams max, not on A-side)

    TRD insertion: no access to MNF and L3

    AUG test (Arrêt Urgence General – General Emergency Stop) – no access UX25

    DSO test (Department Safety Officer) – no access UX25

    No access SX2 during manipulation of blocks in SX2 (except ACR and WRs)

To be confirmed

ALICE 2011-12 winter shutdown schedule - A.Tauro


2011 12 winter shutdown preparatory meeting

L3 and MNF access restrictions

To be scheduled (1 day in wk 51)

After 17:00

Open L3

Close L3

To be confirmed

  • Wks 49-50 and 7: access in normal hours (e.g. TPC) to be coordinated with TC

  • Wks 1-2: no access inside L3 during TRD SMs insertion

    • When moving from low-beta to insertion platform: no access to MNF

    • When inserting the module: no access L3 and MNF

  • Watcher needed in wks 49-50 and from wk 6 onwards

ALICE 2011-12 winter shutdown schedule - A.Tauro


En he

EN-HE

  • 8th Dec (9:30): reinstall crane (PR-774) electronics

  • 8th Dec (AM): load test cavern cranes (20t)

  • 30th Jan. UX25 crane inspection by Brunnhuber

  • Wk 8: test UJ22 jig + annual maintenance P2 cranes

EN-HE-LM

  • 14th Dec: maintenance lift CR1-4

    • Lift stopped whole day (7:00 – 16:00)

  • Cavern lift has to be stopped as well for one day. Date tbc

ALICE 2011-12 winter shutdown schedule - A.Tauro


Te vsc

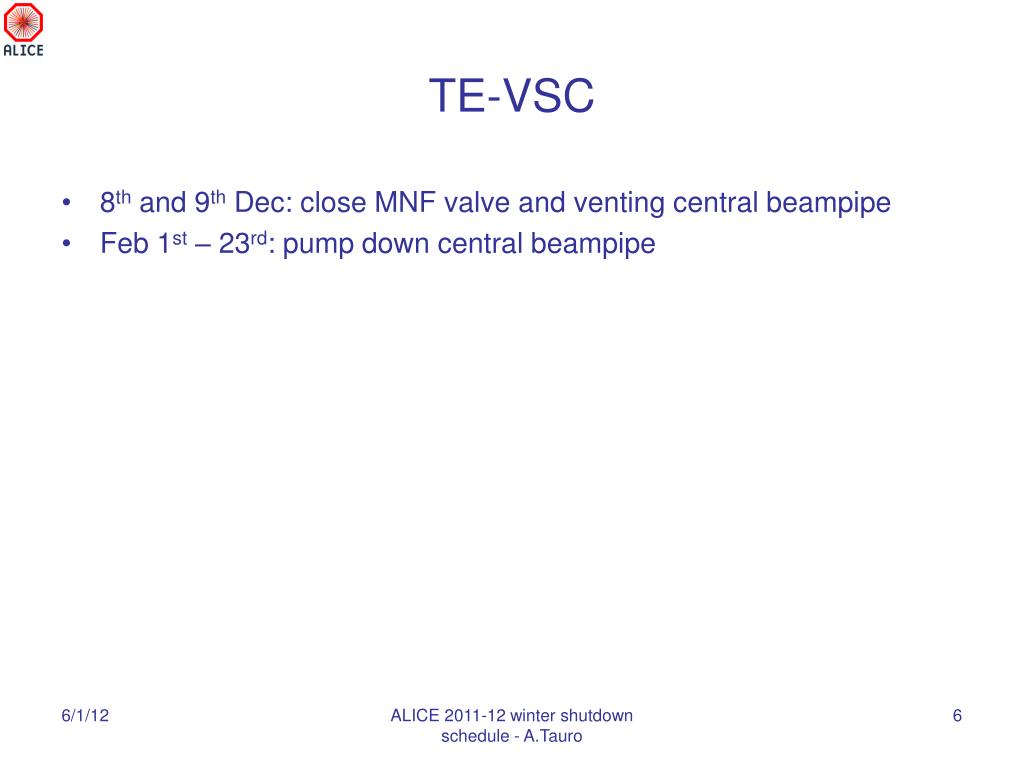

TE-VSC

  • 8th and 9th Dec: close MNF valve and venting central beampipe

  • Feb 1st– 23rd: pump down central beampipe

ALICE 2011-12 winter shutdown schedule - A.Tauro


Gs ase

GS-ASE

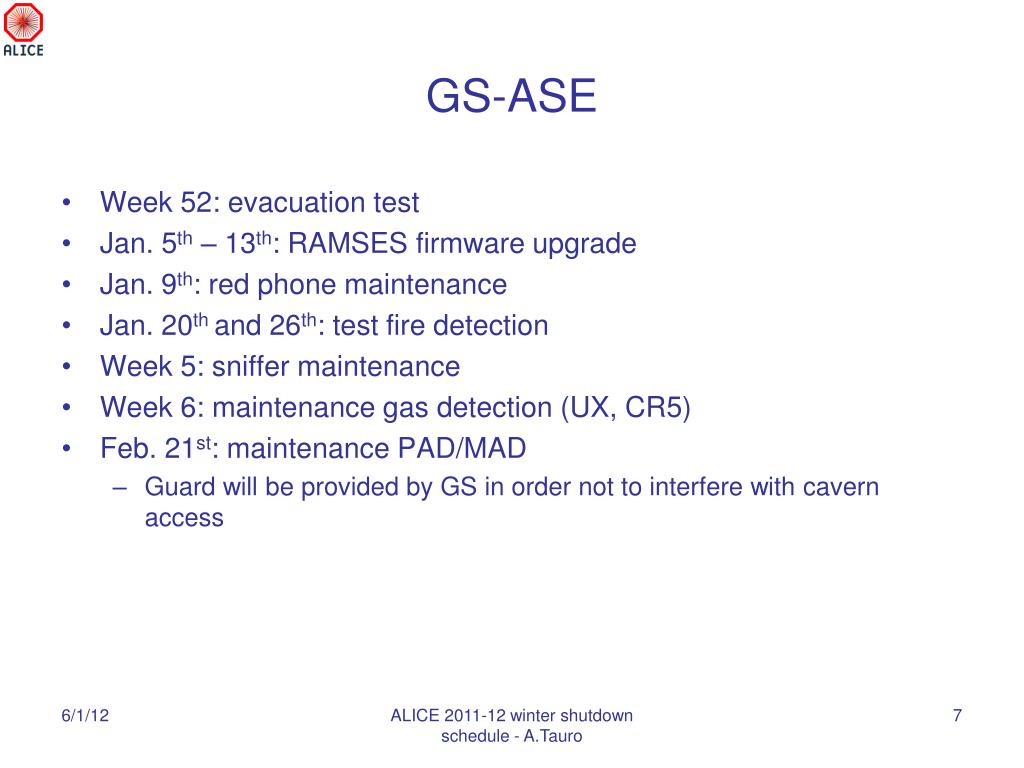

  • Week 52: evacuation test

  • Jan. 5th – 13th: RAMSES firmware upgrade

  • Jan. 9th: red phone maintenance

  • Jan. 20th and 26th: test fire detection

  • Week 5: sniffer maintenance

  • Week 6: maintenance gas detection (UX, CR5)

  • Feb. 21st: maintenance PAD/MAD

    • Guard will be provided by GS in order not to interfere with cavern access

ALICE 2011-12 winter shutdown schedule - A.Tauro


En cv op dec

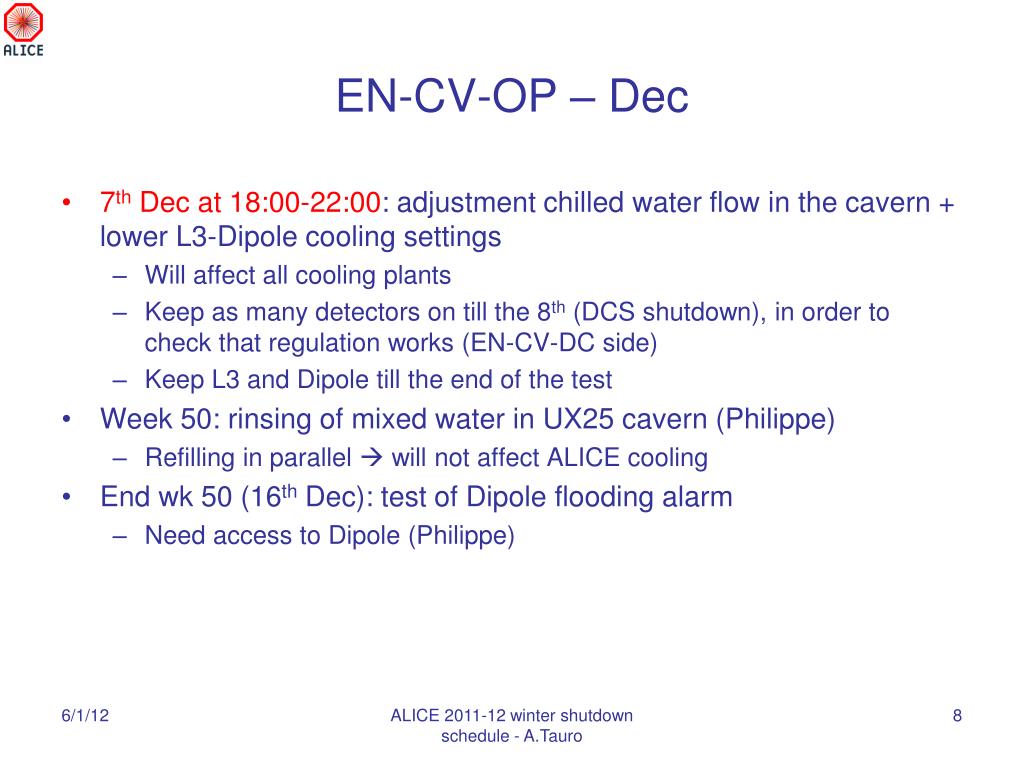

EN-CV-OP – Dec

  • 7th Dec at 18:00-22:00: adjustment chilled water flow in the cavern + lower L3-Dipole cooling settings

    • Will affect all cooling plants

    • Keep as many detectors on till the 8th (DCS shutdown), in order to check that regulation works (EN-CV-DC side)

    • Keep L3 and Dipole till the end of the test

  • Week 50: rinsing of mixed water in UX25 cavern (Philippe)

    • Refilling in parallel  will not affect ALICE cooling

  • End wk 50 (16th Dec): test of Dipole flooding alarm

    • Need access to Dipole (Philippe)

ALICE 2011-12 winter shutdown schedule - A.Tauro


En cv op jan feb

EN-CV-OP – Jan/Feb

  • Tue 2nd and Wed 3rd Jan: Maintenance ITS (old) ventilator in CR5

  • Thu 5th and Fri 6th Jan:maintenance PMD-MTG-MTK ventilation units

  • Fri 6th Jan: stop chilled water (SU2)

    • Therefore stop mixed water (cavern, CRs)

    • Switch tap water into CRs

  • Week 2:

    • Cleaning cooling towers (Mon to Thu)

    • Maintenance L3 injection and UX25 extraction/injection units. Test of alarms

    • New motor L3 ventilation (date tbc)

    • Modification of chilled water pipe for L3 jacket (Mon)

    • Maintenance mixed water pumps PX24 (Mon-Wed) and UW25 (Wed-Thu)

    • Preparation services new ITS dehumidifier

    • Consolidation of automatic switchover to tap water into CRs

  • Week 3:

    • Restart chilled & mixed water (around Wed, tbc)

    • Maintenance L3 extraction unit. Test of alarms

    • Maintenance ventilation unit SG2 (Mon-Tue)  will cut Ar/H2

  • ALICE 2011-12 winter shutdown schedule - A.Tauro


    En cv op

    EN-CV-OP

    • Repair leak FB pipe:

      • 23rd Jan

      • Fernando  compensatory measures

    • Removal unused FB pipe (I-side):

      • 24th-25th Jan

      • Need nacelle

    ALICE 2011-12 winter shutdown schedule - A.Tauro


    En el 1 2

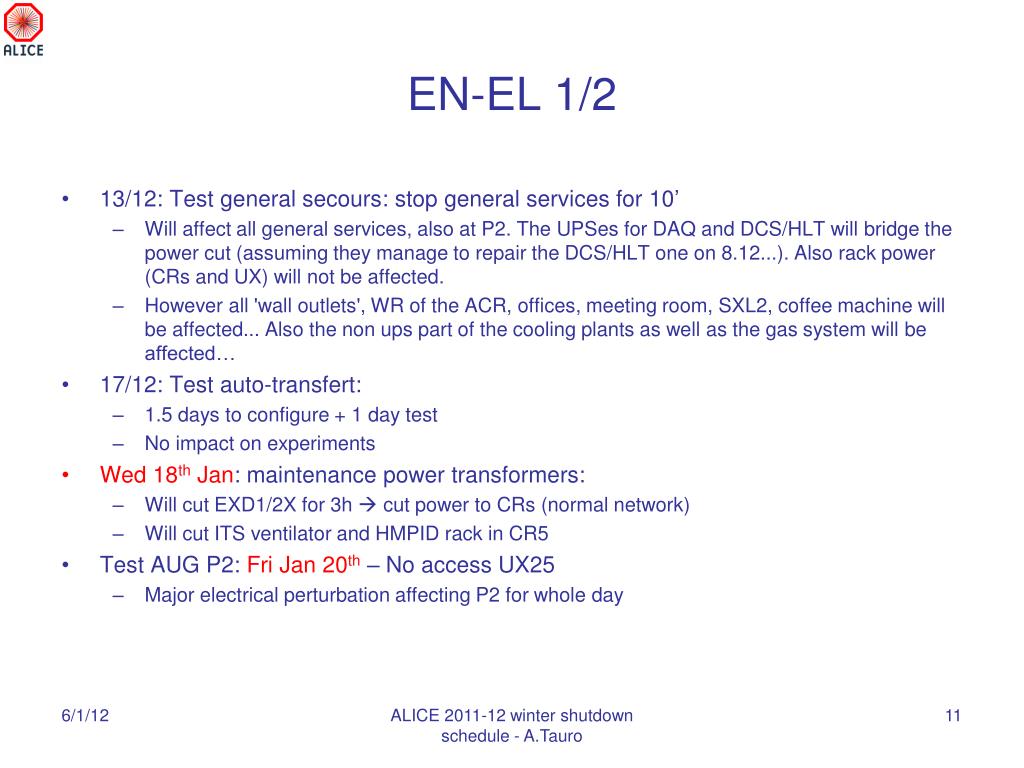

    EN-EL 1/2

    • 13/12: Test general secours: stop general services for 10’

      • Will affect all general services, also at P2. The UPSes for DAQ and DCS/HLT will bridge the power cut (assuming they manage to repair the DCS/HLT one on 8.12...). Also rack power (CRs and UX) will not be affected.

      • However all 'wall outlets', WR of the ACR, offices, meeting room, SXL2, coffee machine will be affected... Also the non ups part of the cooling plants as well as the gas system will be affected…

    • 17/12: Test auto-transfert:

      • 1.5 days to configure + 1 day test

      • No impact on experiments

    • Wed 18th Jan: maintenance power transformers:

      • Will cut EXD1/2X for 3h  cut power to CRs (normal network)

      • Will cut ITS ventilator and HMPID rack in CR5

    • Test AUG P2: Fri Jan 20th– No access UX25

      • Major electrical perturbation affecting P2 for whole day

    ALICE 2011-12 winter shutdown schedule - A.Tauro


    En el 2 2

    EN-EL 2/2

    • Consolidation 48V network (after incident 11th Jan 2011)

      • 1 day no access to UX25  Feb 17th (tbc, K.Foraz)

    • Maintenance power transformer EMT306/2X

      • Feb 17th 6:00 to 10:00

      • Will stop UX25 air extraction and injection (4h) –No access UX25 from 6:00 to 10:00

    ALICE 2011-12 winter shutdown schedule - A.Tauro

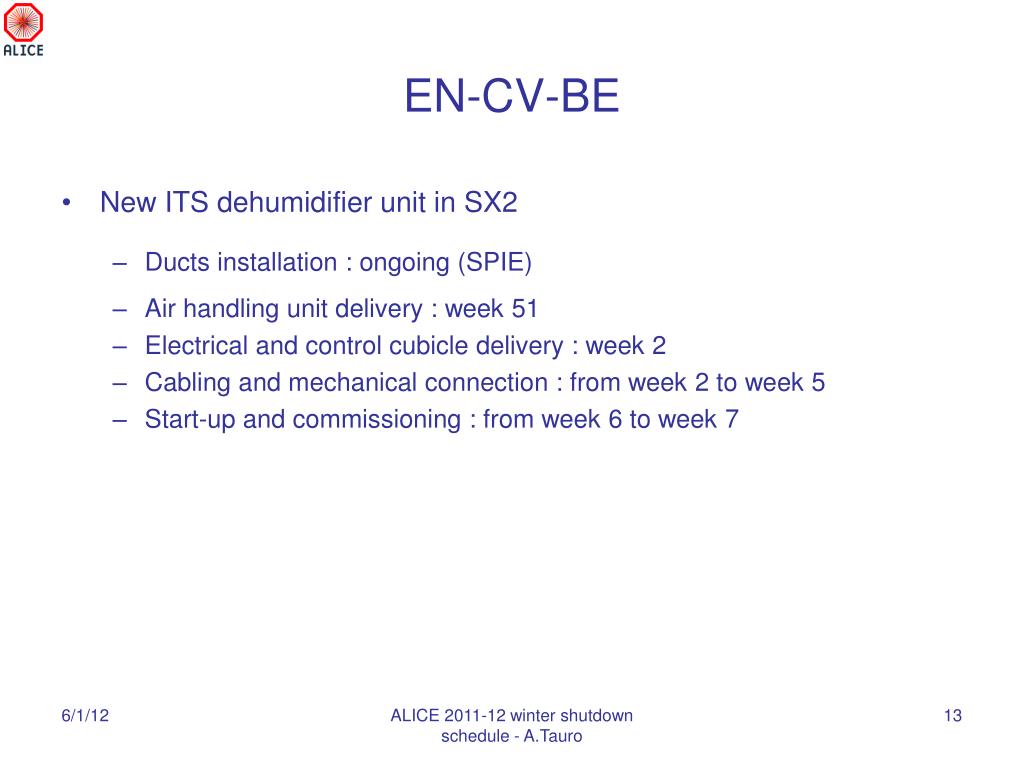

    En cv be

    EN-CV-BE

    • New ITS dehumidifier unit in SX2

      • Ducts installation : ongoing (SPIE)

      • Air handling unit delivery : week 51

      • Electrical and control cubicle delivery : week 2

      • Cabling and mechanical connection : from week 2 to week 5

      • Start-up and commissioning : from week 6 to week 7

    ALICE 2011-12 winter shutdown schedule - A.Tauro

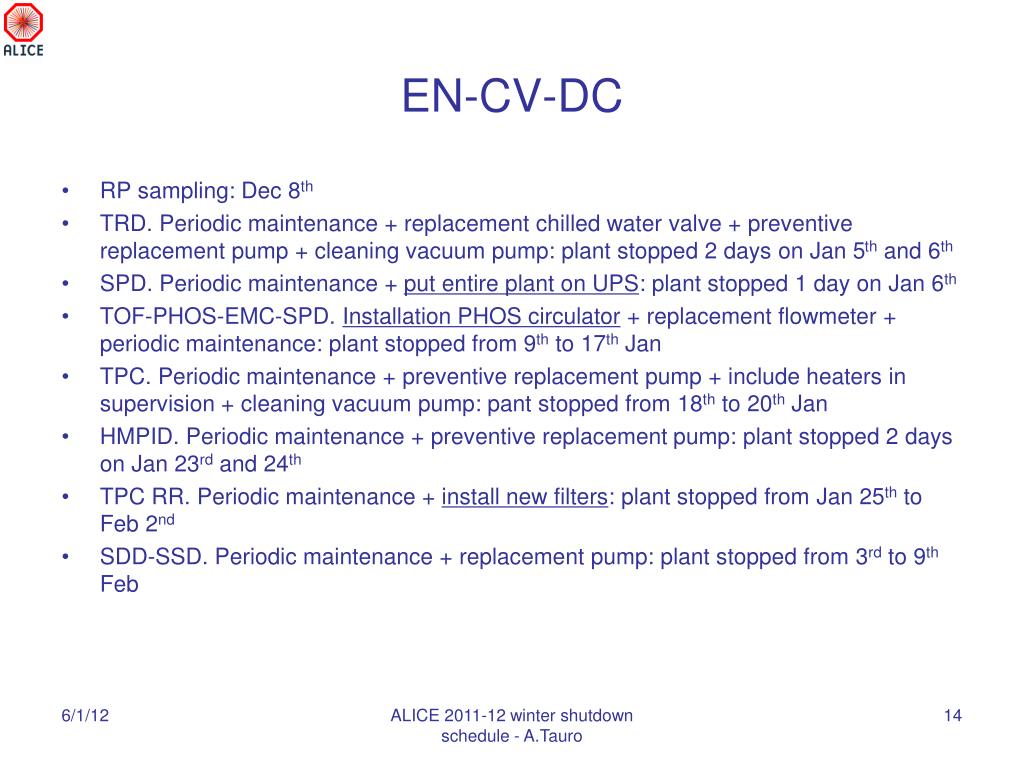

    En cv dc

    EN-CV-DC

    • RP sampling: Dec 8th

    • TRD. Periodic maintenance + replacement chilled water valve + preventive replacement pump + cleaning vacuum pump: plant stopped 2 days on Jan 5th and 6th

    • SPD. Periodic maintenance + put entire plant on UPS: plant stopped 1 day on Jan 6th

    • TOF-PHOS-EMC-SPD. Installation PHOS circulator+ replacement flowmeter + periodic maintenance: plant stopped from 9th to 17th Jan

    • TPC. Periodic maintenance + preventive replacement pump + include heaters in supervision + cleaning vacuum pump: pant stopped from 18th to 20th Jan

    • HMPID. Periodic maintenance + preventive replacement pump: plant stopped 2 days on Jan 23rd and 24th

    • TPC RR. Periodic maintenance + install new filters: plant stopped from Jan 25th to Feb 2nd

    • SDD-SSD. Periodic maintenance + replacement pump: plant stopped from 3rd to 9th Feb

    ALICE 2011-12 winter shutdown schedule - A.Tauro


    Be abp su survey

    BE-ABP-SU (survey)

    • Week 50 (Sat-Sun): with L3 doors open:

      • Zero measurement (SF, TPC feet, MNF valve, MNF)

      • Low Beta network update

      • C-side photogrammetry (EMCal)

    • Weeks 1-2: after each TRD insertion, requiring ½ day on low-beta:

      • MNF valve and MNF

    • Week 4: survey MTG

    • Week 5: at the end of TRD and EMCal, requiring three full days with both doors open:

      • TRD modules, CAL frame photogrammetry, MNF valve, MNF, SF deformation, TPC feet

    • Week 6:V0-FMD1 (Mon) and MTK ST1-2 (Wed-Fri)

    • Week 7:no access (reserve)

    • Weeks 9-10:survey MTK ST3-4-5 and PMD

    ALICE 2011-12 winter shutdown schedule - A.Tauro


    2011 12 winter shutdown preparatory meeting

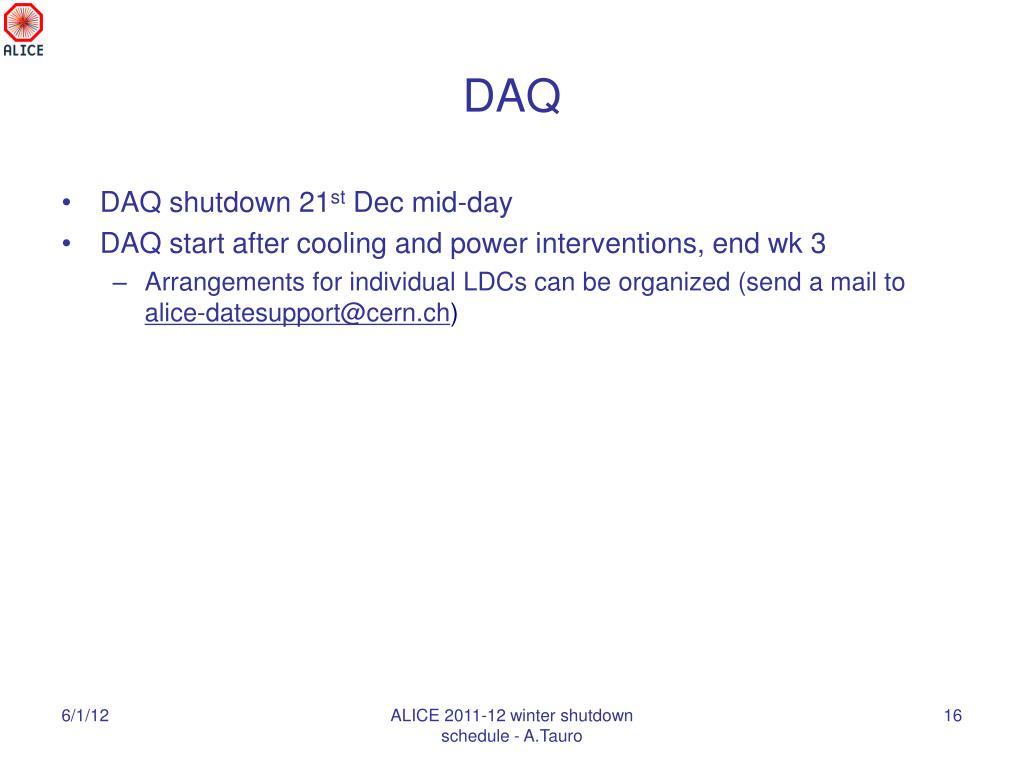

    DAQ

    • DAQ shutdown 21st Dec mid-day

    • DAQ start after cooling and power interventions, end wk 3

      • Arrangements for individual LDCs can be organized (send a mail to [email protected])

    ALICE 2011-12 winter shutdown schedule - A.Tauro


    2011 12 winter shutdown preparatory meeting

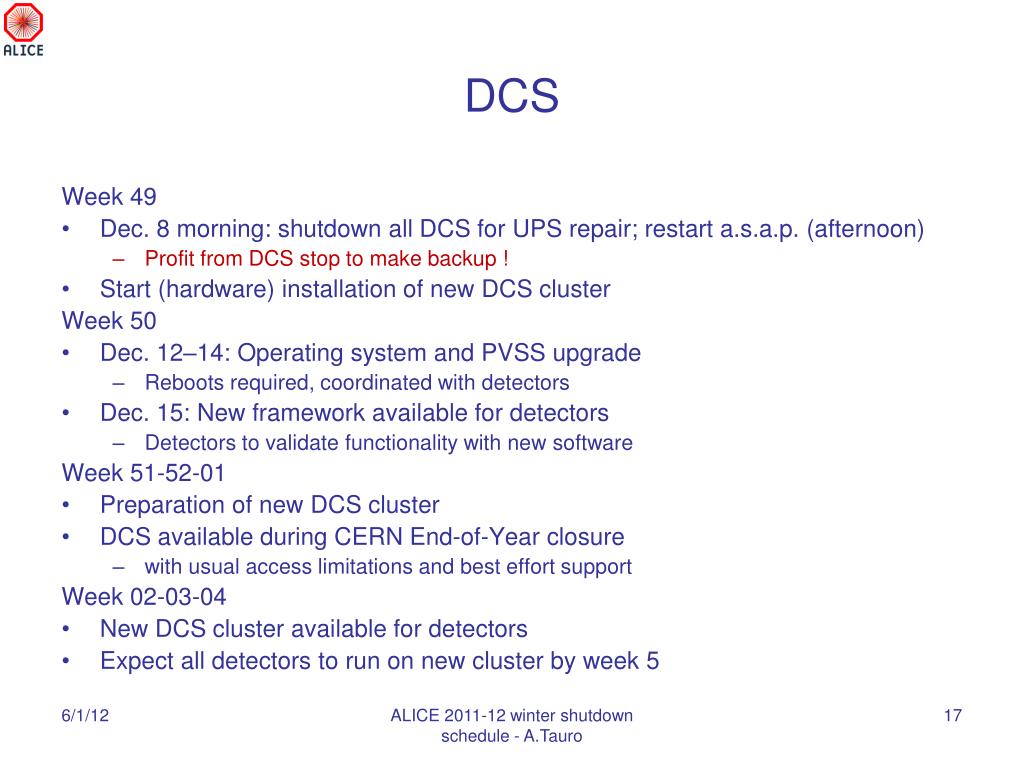

    DCS

    Week 49

    • Dec. 8 morning: shutdown all DCS for UPS repair; restart a.s.a.p. (afternoon)

      • Profit from DCS stop to make backup !

    • Start (hardware) installation of new DCS cluster

      Week 50

    • Dec. 12–14: Operating system and PVSS upgrade

      • Reboots required, coordinated with detectors

    • Dec. 15: New framework available for detectors

      • Detectors to validate functionality with new software

        Week 51-52-01

    • Preparation of new DCS cluster

    • DCS available during CERN End-of-Year closure

      • with usual access limitations and best effort support

        Week 02-03-04

    • New DCS cluster available for detectors

    • Expect all detectors to run on new cluster by week 5

    ALICE 2011-12 winter shutdown schedule - A.Tauro


    2011 12 winter shutdown preparatory meeting

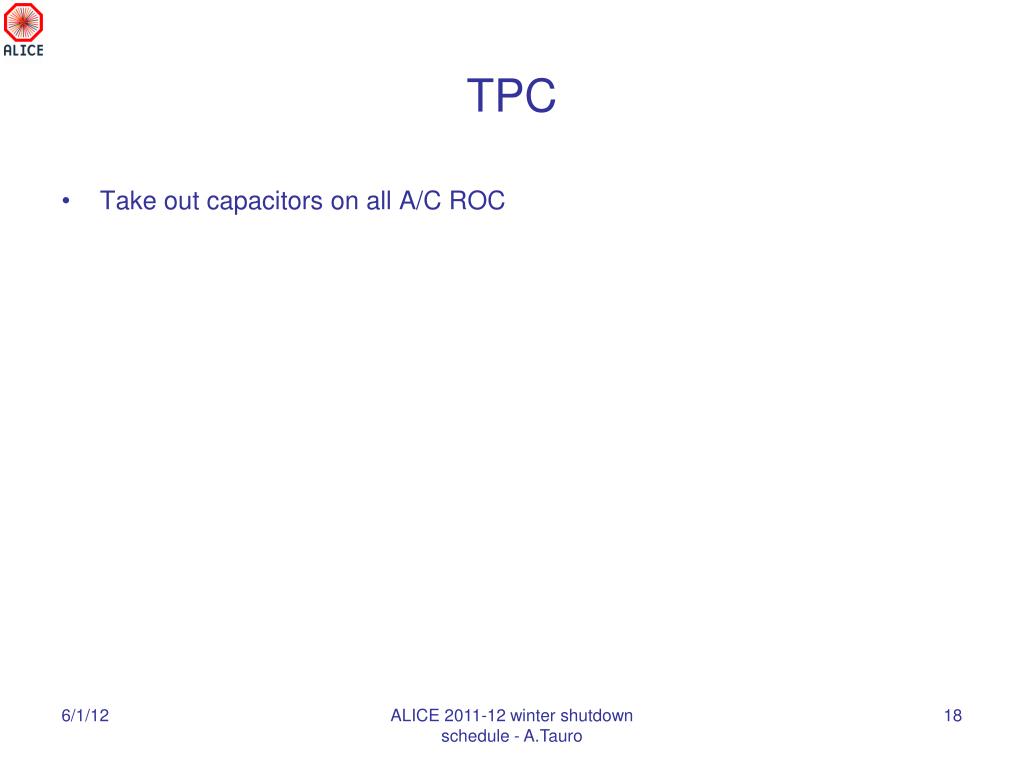

    TPC

    • Take out capacitors on all A/C ROC

    ALICE 2011-12 winter shutdown schedule - A.Tauro


    Tpc heat screen

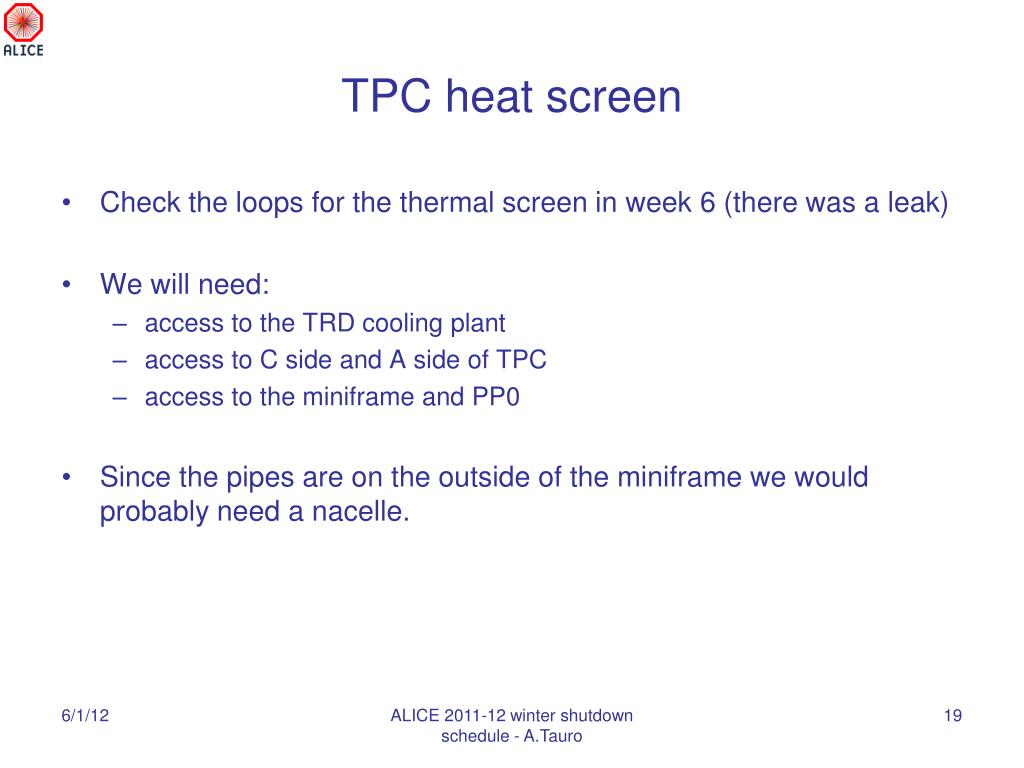

    TPC heat screen

    • Check the loops for the thermal screen in week 6 (there was a leak)

    • We will need:

      • access to the TRD cooling plant

      • access to C side and A side of TPC

      • access to the miniframe and PP0

    • Since the pipes are on the outside of the miniframe we would probably need a nacelle.

    ALICE 2011-12 winter shutdown schedule - A.Tauro


    Removal of fmd2 box

    Removal of FMD2 box

    Cable ends

    Present situation

    Situation without the box. The blue cable tray should stay in place

    ALICE 2011-12 winter shutdown schedule - A.Tauro


    Removal of fmd2 box1

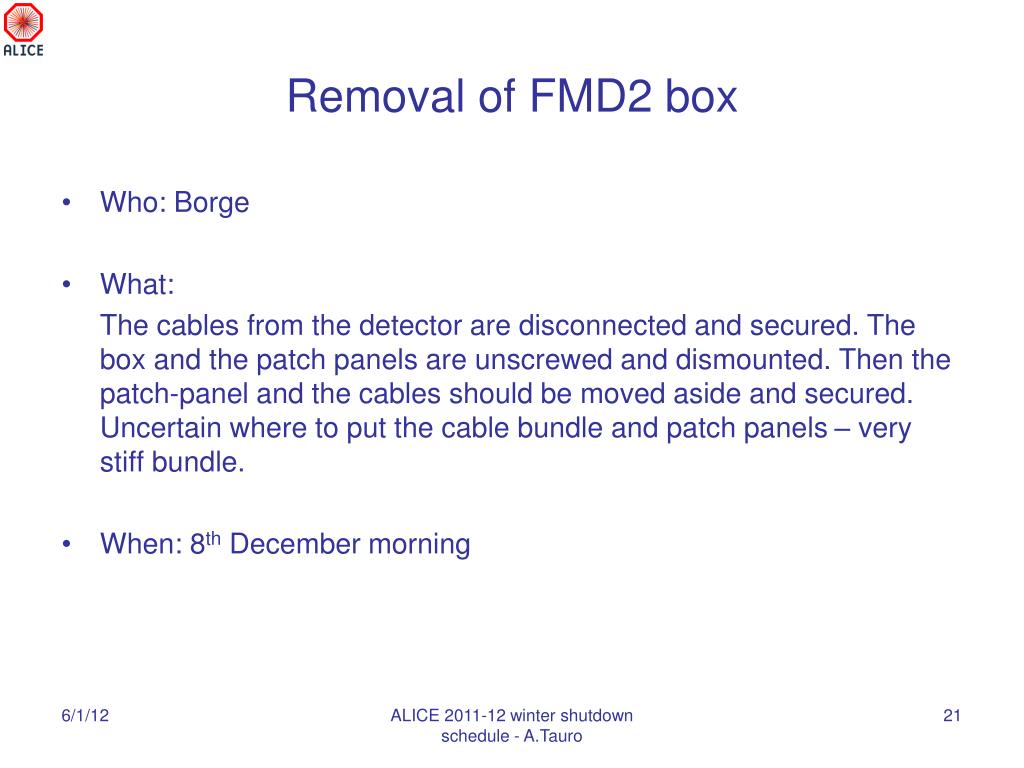

    Removal of FMD2 box

    • Who: Borge

    • What:

      The cables from the detector are disconnected and secured. The box and the patch panels are unscrewed and dismounted. Then the patch-panel and the cables should be moved aside and secured. Uncertain where to put the cable bundle and patch panels – very stiff bundle.

    • When: 8th December morning

    ALICE 2011-12 winter shutdown schedule - A.Tauro


    Removal of ssd spd boxes

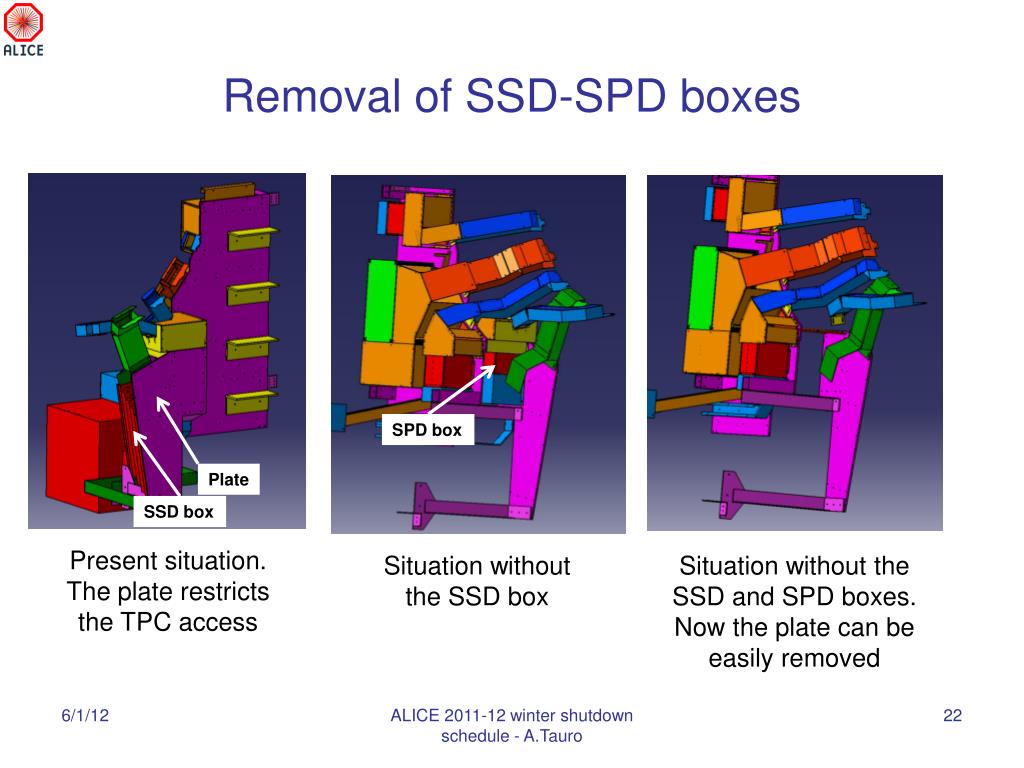

    Removal of SSD-SPD boxes

    SPD box

    Plate

    SSD box

    Present situation. The plate restricts the TPC access

    Situation without the SSD box

    Situation without the SSD and SPD boxes. Now the plate can be easily removed

    ALICE 2011-12 winter shutdown schedule - A.Tauro


    Removal of ssd spd boxes1

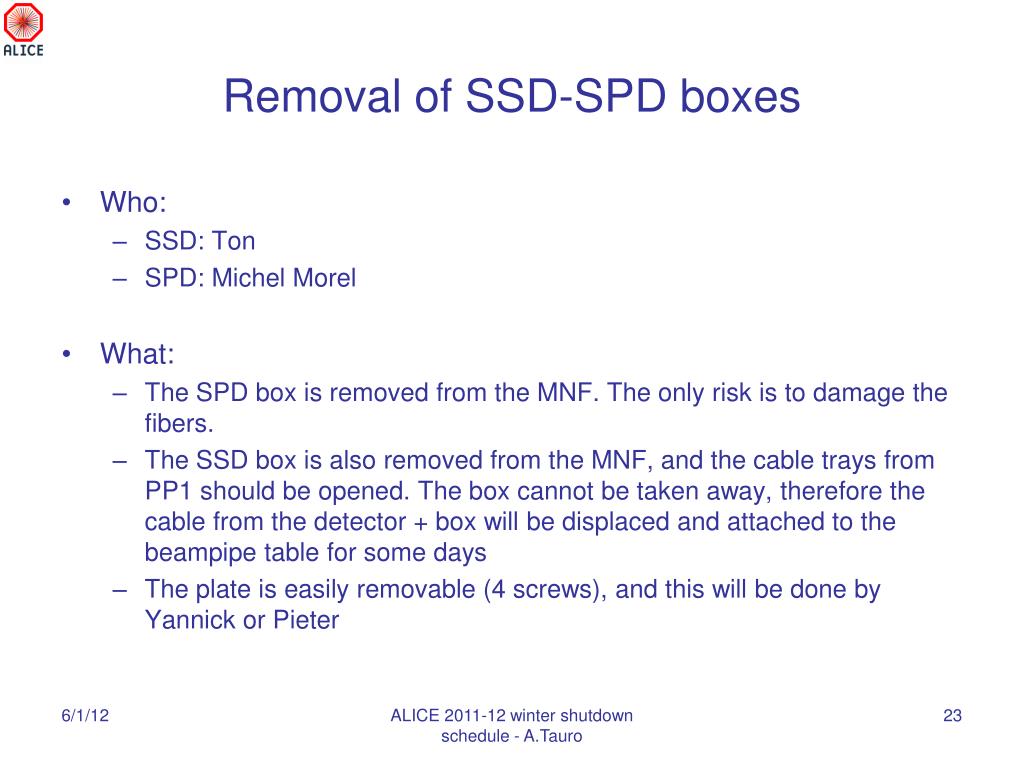

    Removal of SSD-SPD boxes

    • Who:

      • SSD: Ton

      • SPD: Michel Morel

    • What:

      • The SPD box is removed from the MNF. The only risk is to damage the fibers.

      • The SSD box is also removed from the MNF, and the cable trays from PP1 should be opened. The box cannot be taken away, therefore the cable from the detector + box will be displaced and attached to the beampipe table for some days

      • The plate is easily removable (4 screws), and this will be done by Yannick or Pieter

    ALICE 2011-12 winter shutdown schedule - A.Tauro


    Removal of v0 fmd1

    Removal of V0-FMD1

    • Who: Yannick, Pieter, Werner and Borge

    • What: disconnection and displacement of V0-FMD1. The detector will be parked inside the MNF for some days. The removal is a complex but known operation. The main risks for the equipment are related to the beampipe and the naked silicon sensors of FMD1. Both will need temporary protection once the detector is moved out,

    ALICE 2011-12 winter shutdown schedule - A.Tauro


    Schedule

    Schedule

    • Week 49:

      • Thu 8/12: displace FMD2 box. The box can be reinstalled anytime (at latest in week 5)

      • TPC A-14/15 (4 days anytime)

    • Week 3: move PMD to parking position (see next slide)

    • Week 4:

      • Mon 23/1 AM: disconnect and displace SPD box

      • Mon 23/1 PM: disconnect and displace SSD box

      • Tue-Fri: TPC A-11/12 (4 days)

      • Sat: put back and test SSD box

    • Week 5:

      • Mon 30/1: put back and test SPD box

      • Tue: move V0-FMD1 to parking position (PMD already in parking position)

      • Wed-Fri: TPC A-13 (2 1/2 days)

      • Fri-Sat: move back and test V0-FMD1

    • Week 6:

      • Mon 6/2: survey of V0-FMD1

    ALICE 2011-12 winter shutdown schedule - A.Tauro


    2011 12 winter shutdown preparatory meeting

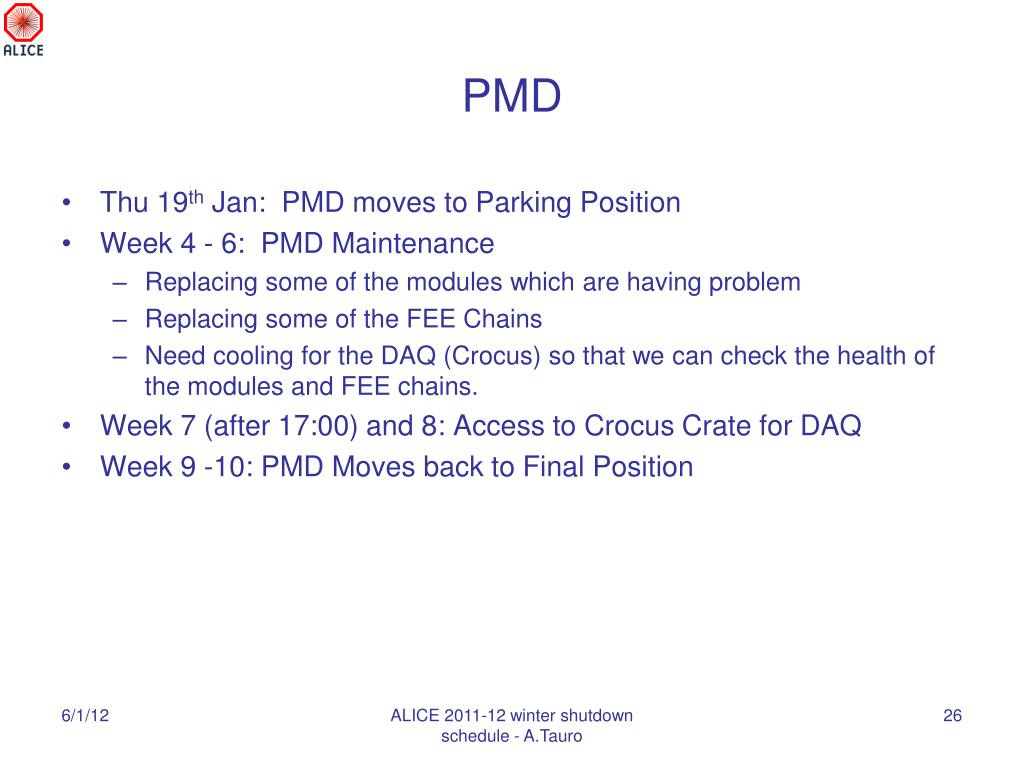

    PMD

    • Thu 19th Jan: PMD moves to Parking Position

    • Week 4 - 6: PMD Maintenance

      • Replacing some of the modules which are having problem

      • Replacing some of the FEE Chains

      • Need cooling for the DAQ (Crocus) so that we can check the health of the modules and FEE chains.

    • Week 7 (after 17:00) and 8: Access to Crocus Crate for DAQ

    • Week 9 -10: PMD Moves back to Final Position

    ALICE 2011-12 winter shutdown schedule - A.Tauro


    2011 12 winter shutdown preparatory meeting

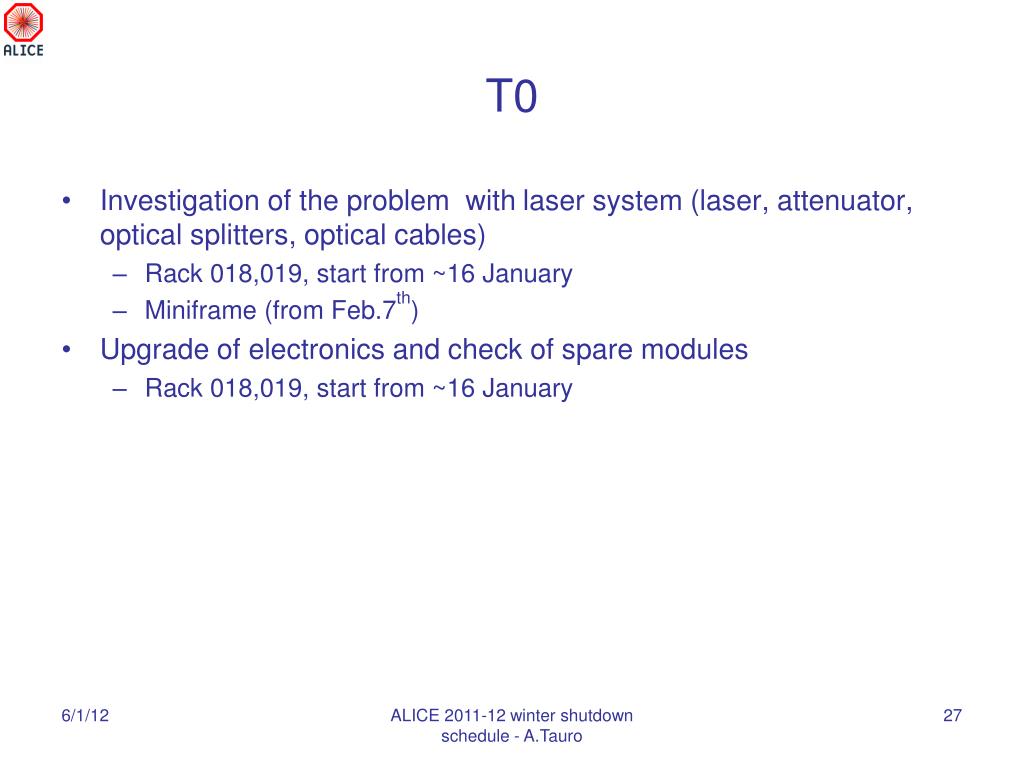

    T0

    • Investigation of the problem with lasersystem (laser, attenuator, optical splitters, optical cables)

      • Rack 018,019, start from ~16 January

      • Miniframe (from Feb.7th)

    • Upgrade of electronics and check of spare modules

      • Rack 018,019, start from ~16 January

    ALICE 2011-12 winter shutdown schedule - A.Tauro

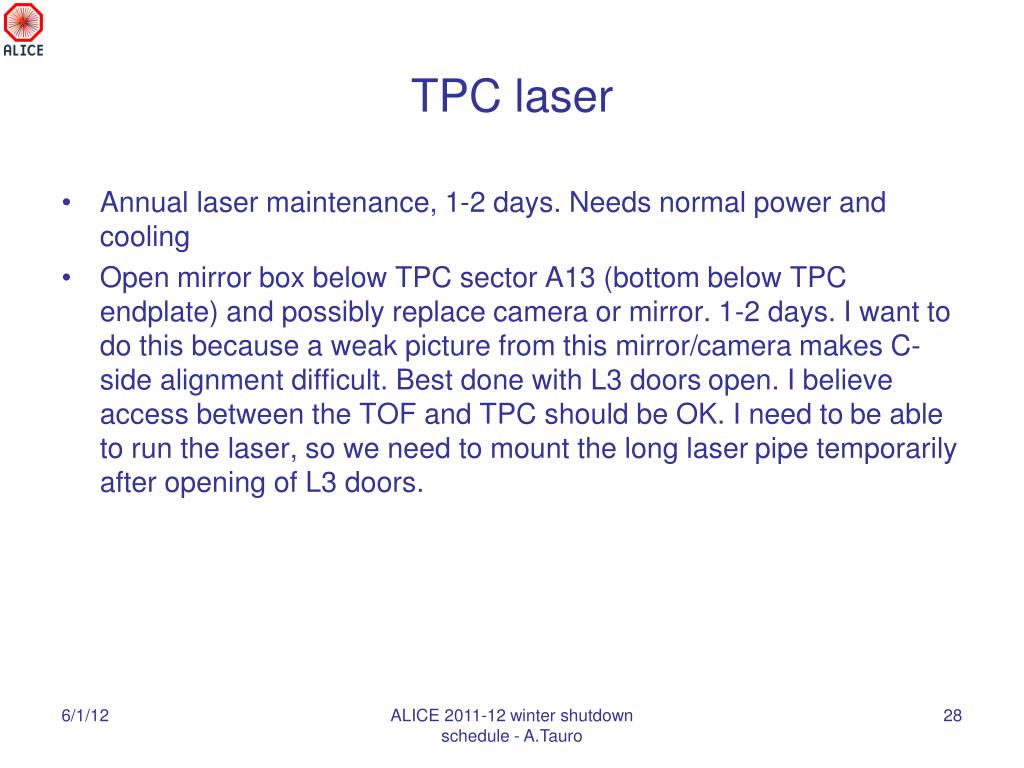

    Tpc laser

    TPC laser

    • Annual laser maintenance, 1-2 days. Needs normal power and cooling

    • Open mirror box below TPC sector A13 (bottom below TPC endplate) and possibly replace camera or mirror. 1-2 days. I want to do this because a weak picture from this mirror/camera makes C-side alignment difficult. Best done with L3 doors open. I believe access between the TOF and TPC should be OK. I need to be able to run the laser, so we need to mount the long laser pipe temporarily after opening of L3 doors.

    ALICE 2011-12 winter shutdown schedule - A.Tauro


    2011 12 winter shutdown preparatory meeting

    TRD

    • 3 supermodules installation, cabling, commissioning (L3 access, A & C sides etc)

      • Arrival at CERN of Bernd & Co on 2nd Jan. around noon

      • Insertion sequence: 6-2-3

      • Possible to have transport on Sun.8th Jan?

    • C19 power installation -> we will ask DCS

    • C16-19 Netgear switch rearrangement

    • I08/O08 Netgear switch rearrangement

    • DAQ upgrade (discussion on going between Joerg and DAQ group)

    • Pretriggerbackup PSU installation and LV cable rearrangements (I/O rack and C-side in L3)

    • BKF LV protection panel replacement (C-side in L3)

    • Cooling valves replacement for 10 sectors, C side (if necessary, ask Ana to judge) (C-side in L3)

    • Moving back pressure sensors from TPC TS to TRD (C-side in L3)

    • GTU optical fiber installation (Stefan) (C16,17,18 racks)

    • CR4 HV rearrangement for new super-modules

    ALICE 2011-12 winter shutdown schedule - A.Tauro


    2011 12 winter shutdown preparatory meeting

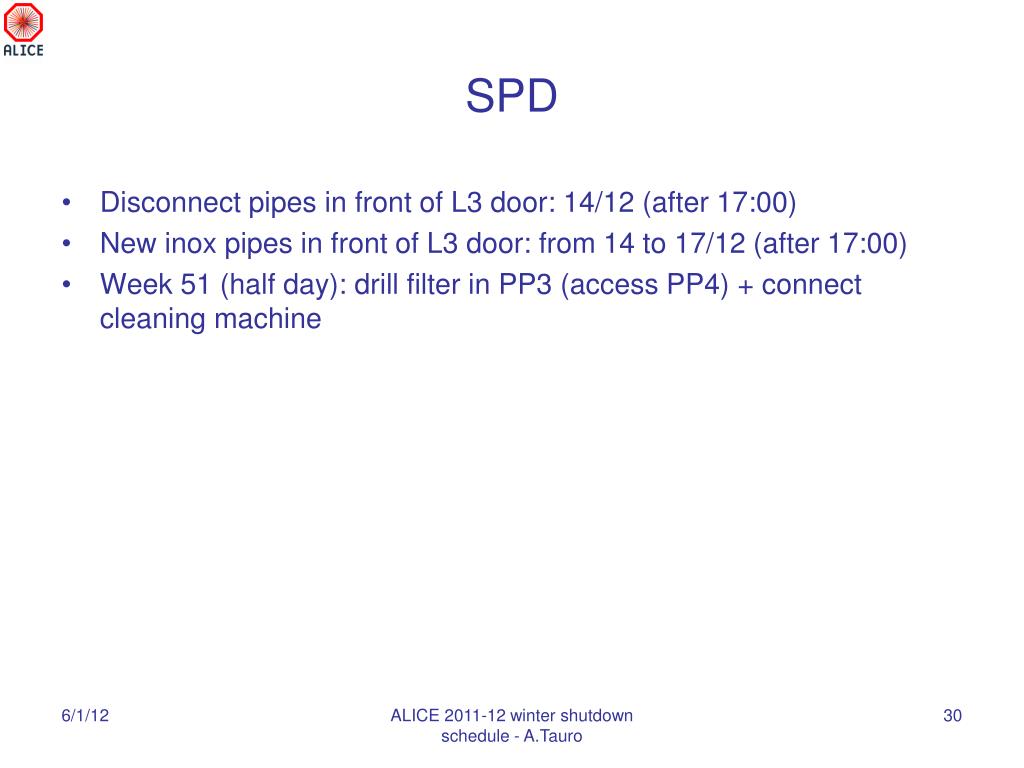

    SPD

    • Disconnect pipes in front of L3 door: 14/12 (after 17:00)

    • New inox pipes in front of L3 door: from 14 to 17/12 (after 17:00)

    • Week 51 (half day): drill filter in PP3 (access PP4) + connect cleaning machine

    ALICE 2011-12 winter shutdown schedule - A.Tauro


    2011 12 winter shutdown preparatory meeting

    EMC

    • 15/12 PM: delivery new nose (SXL2)

    • 12/1 (PM): delivery 2 SMs (SXL2) (not tested afterwards)

    • Nantes team:

      • Monday 16/1 PM: travel to CERN

      • 17-18-19/1: modification new nose in SXL2 + cavern preparation (insertion SM into rotator if possible)

      • Friday 20/1 PM: travel to Nantes

      • Monday 23/1 PM: travel to CERN

      • 24-25-26/1: insertion

      • Friday 27/1 PM: travel to Nantes

    ALICE 2011-12 winter shutdown schedule - A.Tauro


    2011 12 winter shutdown preparatory meeting

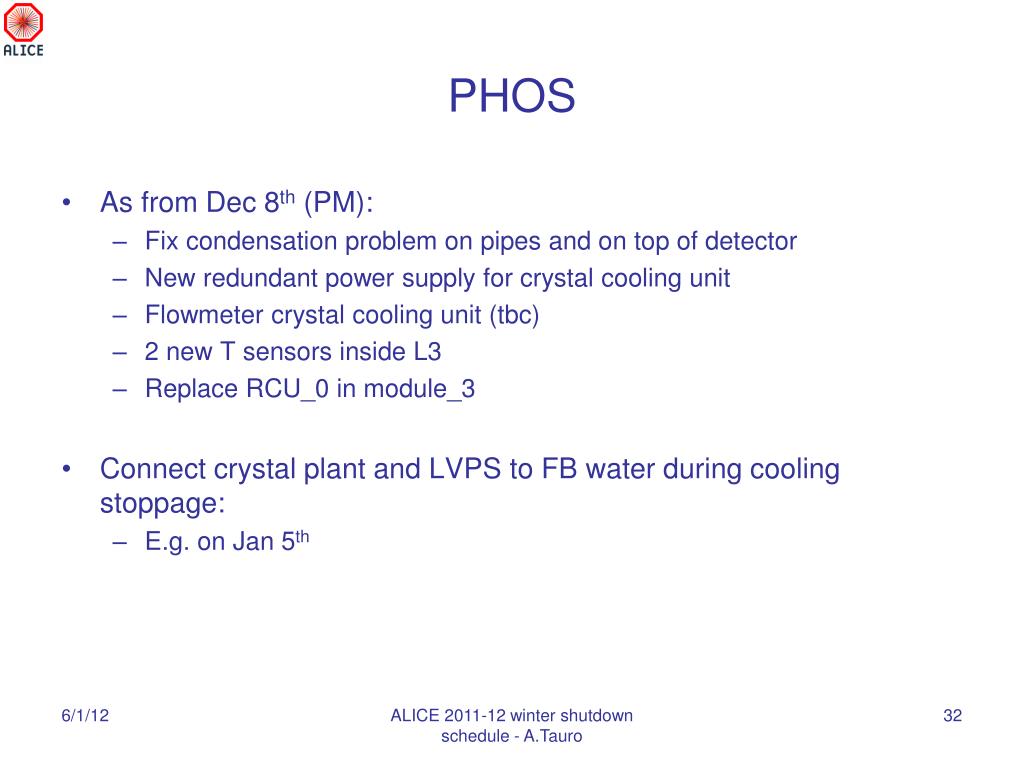

    PHOS

    • As from Dec 8th (PM):

      • Fix condensation problem on pipes and on top of detector

      • New redundant power supply for crystal cooling unit

      • Flowmeter crystal cooling unit (tbc)

      • 2 new T sensors inside L3

      • Replace RCU_0 in module_3

    • Connect crystal plant and LVPS to FB water during cooling stoppage:

      • E.g. on Jan 5th

    ALICE 2011-12 winter shutdown schedule - A.Tauro


    2011 12 winter shutdown preparatory meeting

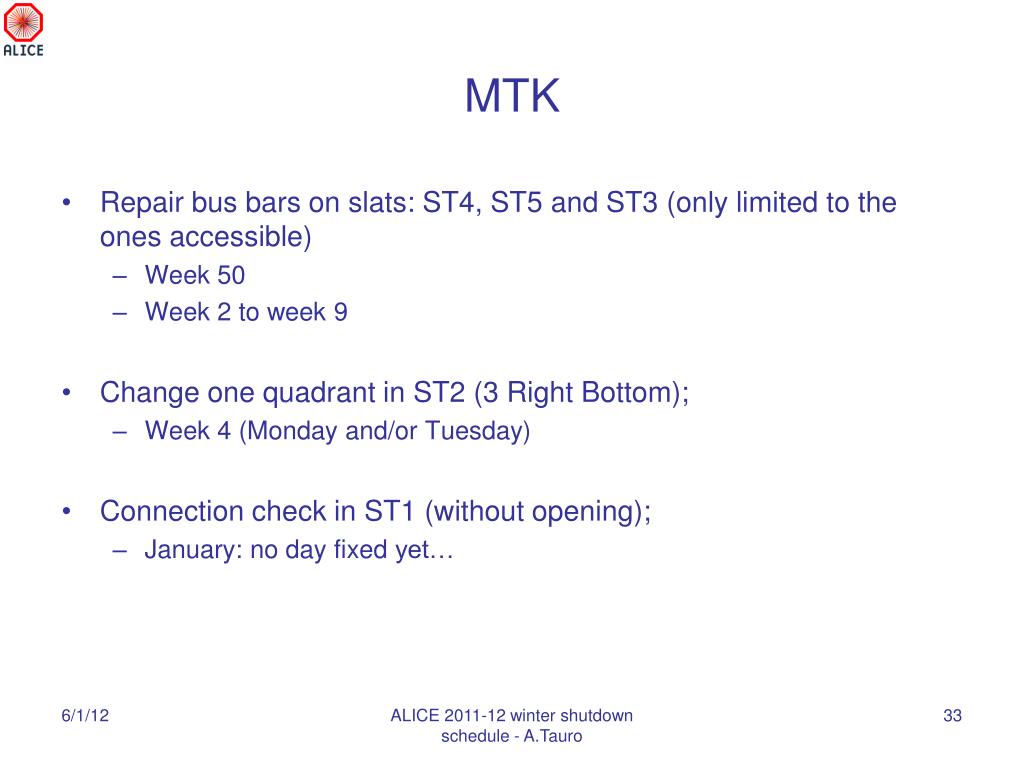

    MTK

    • Repair bus bars on slats: ST4, ST5 and ST3 (only limited to the ones accessible)

      • Week 50

      • Week 2 to week 9

    • Change one quadrant in ST2 (3 Right Bottom);

      • Week 4 (Monday and/or Tuesday)

    • Connection check in ST1 (without opening);

      • January: no day fixed yet…

    ALICE 2011-12 winter shutdown schedule - A.Tauro


    2011 12 winter shutdown preparatory meeting

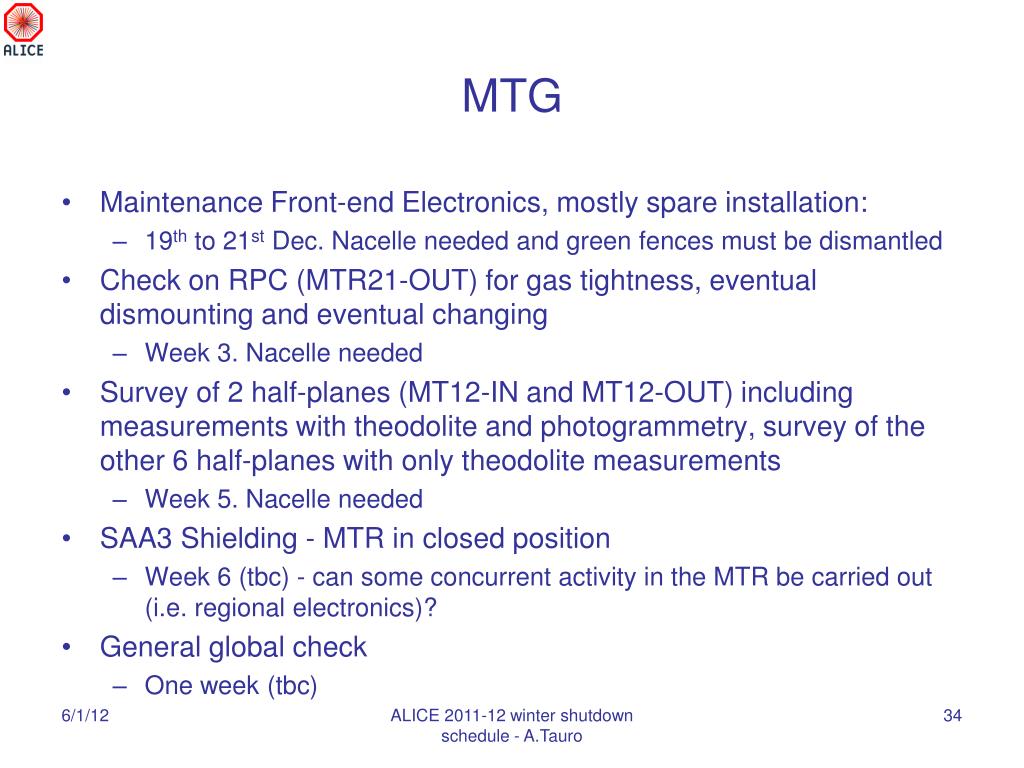

    MTG

    • Maintenance Front-end Electronics, mostly spare installation:

      • 19th to 21st Dec. Nacelle needed and green fences must be dismantled

    • Check on RPC (MTR21-OUT) for gas tightness, eventual dismounting and eventual changing

      • Week 3. Nacelle needed

    • Survey of 2 half-planes (MT12-IN and MT12-OUT) including measurements withtheodolite and photogrammetry, survey of the other 6 half-planes with only theodolite measurements

      • Week 5. Nacelle needed

    • SAA3 Shielding - MTR in closed position

      • Week 6(tbc) - can some concurrent activity in the MTR be carried out (i.e. regional electronics)?

    • General global check

      • One week (tbc)

    ALICE 2011-12 winter shutdown schedule - A.Tauro


    2011 12 winter shutdown preparatory meeting

    ZDC

    • Move detectors by 1.36m towards IP to solve the problem of collimator shadow

    ALICE 2011-12 winter shutdown schedule - A.Tauro


    Status of gas systems during christmas period

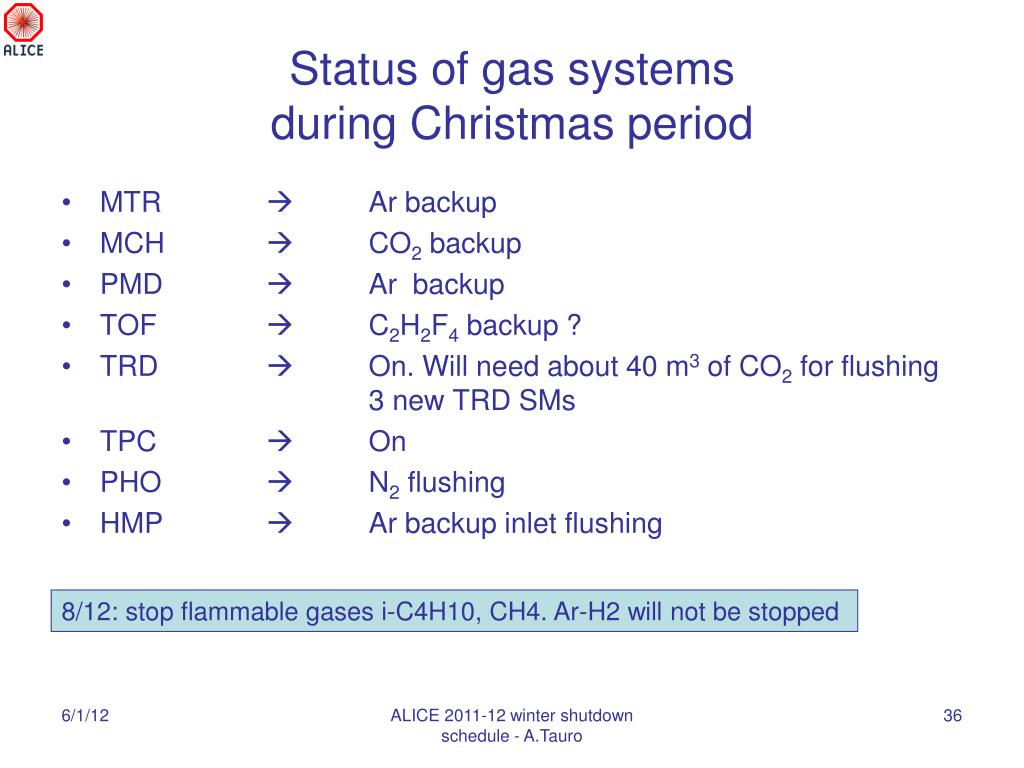

    Status of gas systemsduring Christmas period

    • MTRAr backup

    • MCHCO2 backup

    • PMDArbackup

    • TOFC2H2F4 backup ?

    • TRDOn. Will needabout 40 m3 of CO2 for flushing 3 new TRD SMs

    • TPCOn

    • PHON2 flushing

    • HMPArbackup inletflushing

    8/12: stop flammable gases i-C4H10, CH4. Ar-H2 will not be stopped

    ALICE 2011-12 winter shutdown schedule - A.Tauro


    Other activities

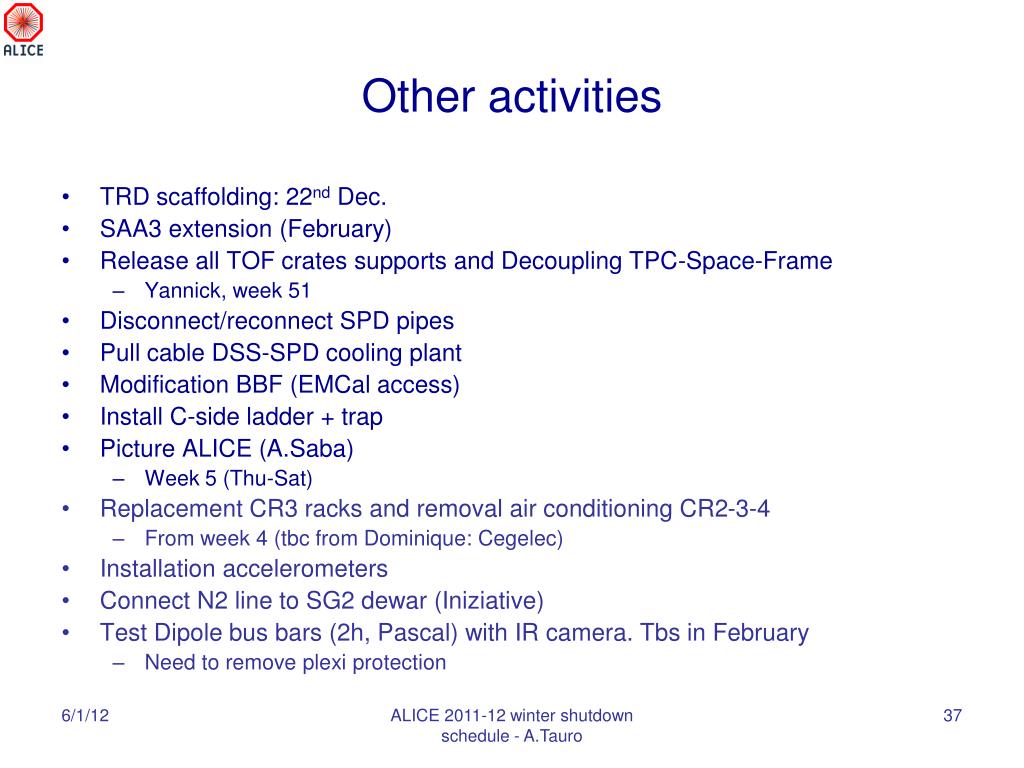

    Other activities

    • TRD scaffolding: 22nd Dec.

    • SAA3 extension (February)

    • Release all TOF crates supports and Decoupling TPC-Space-Frame

      • Yannick, week 51

    • Disconnect/reconnect SPD pipes

    • Pull cable DSS-SPD cooling plant

    • Modification BBF (EMCal access)

    • Install C-side ladder + trap

    • Picture ALICE (A.Saba)

      • Week 5 (Thu-Sat)

    • Replacement CR3 racks and removal air conditioning CR2-3-4

      • From week 4 (tbc from Dominique: Cegelec)

    • Installation accelerometers

    • Connect N2 line to SG2 dewar (Iniziative)

    • Test Dipole bus bars (2h, Pascal) with IR camera. Tbs in February

      • Need to remove plexi protection

    ALICE 2011-12 winter shutdown schedule - A.Tauro


    Day by day schedule december 2011

    Day-by-day scheduleDecember 2011

    ALICE 2011-12 winter shutdown schedule - A.Tauro


    2011 12 winter shutdown preparatory meeting

    It

    H

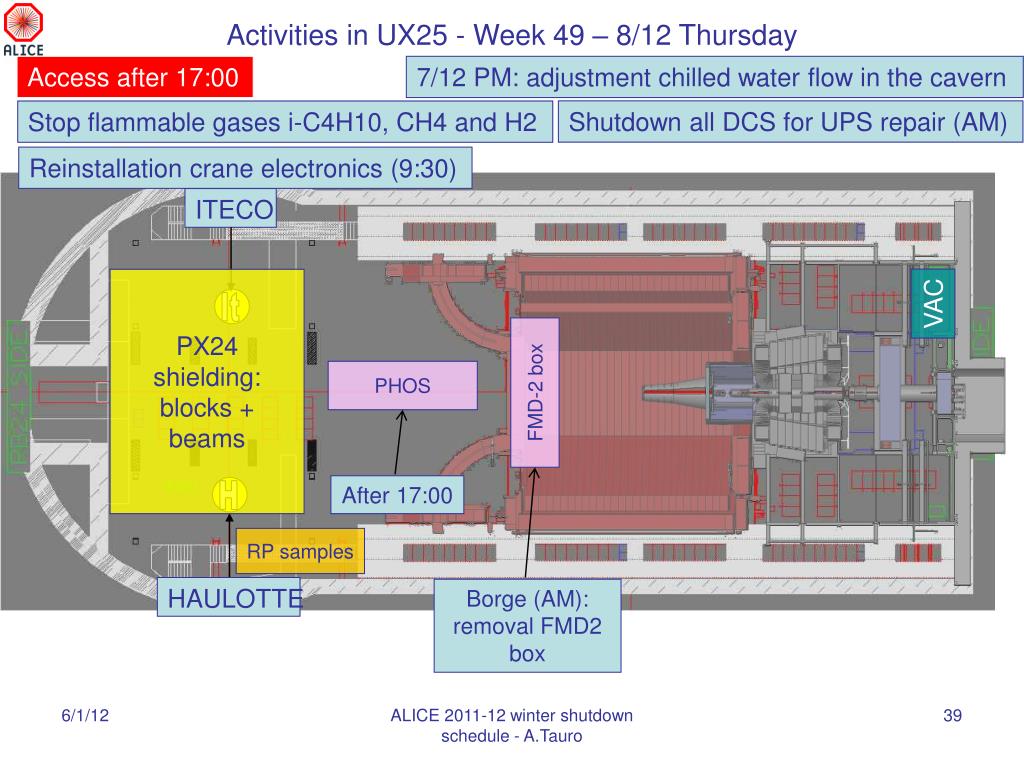

    Activities in UX25 - Week 49 – 8/12 Thursday

    Access after 17:00

    7/12 PM: adjustment chilled water flow in the cavern

    Shutdown all DCS for UPS repair (AM)

    Stop flammable gases i-C4H10, CH4 and H2

    Reinstallation crane electronics (9:30)

    ITECO

    PX24 shielding: blocks + beams

    VAC

    PHOS

    FMD-2 box

    After 17:00

    RP samples

    HAULOTTE

    Borge (AM): removal FMD2 box

    ALICE 2011-12 winter shutdown schedule - A.Tauro


    2011 12 winter shutdown preparatory meeting

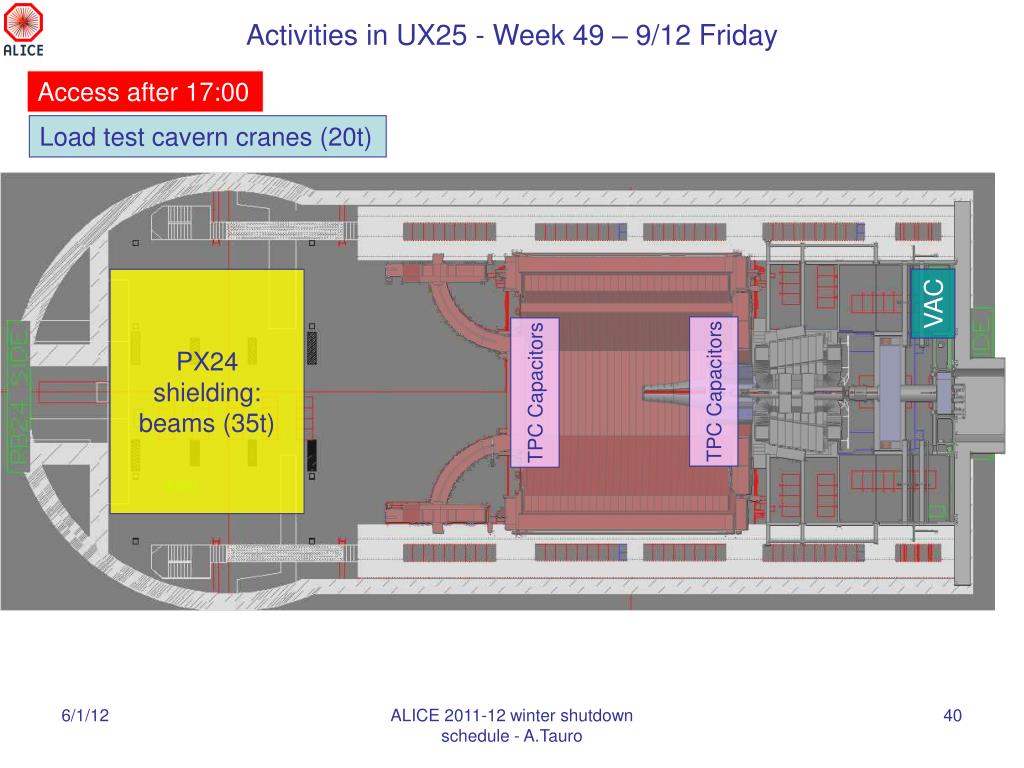

    Activities in UX25 - Week 49 – 9/12 Friday

    Access after 17:00

    Load test cavern cranes (20t)

    PX24 shielding: beams (35t)

    VAC

    TPC Capacitors

    TPC Capacitors

    ALICE 2011-12 winter shutdown schedule - A.Tauro


    2011 12 winter shutdown preparatory meeting

    LV152

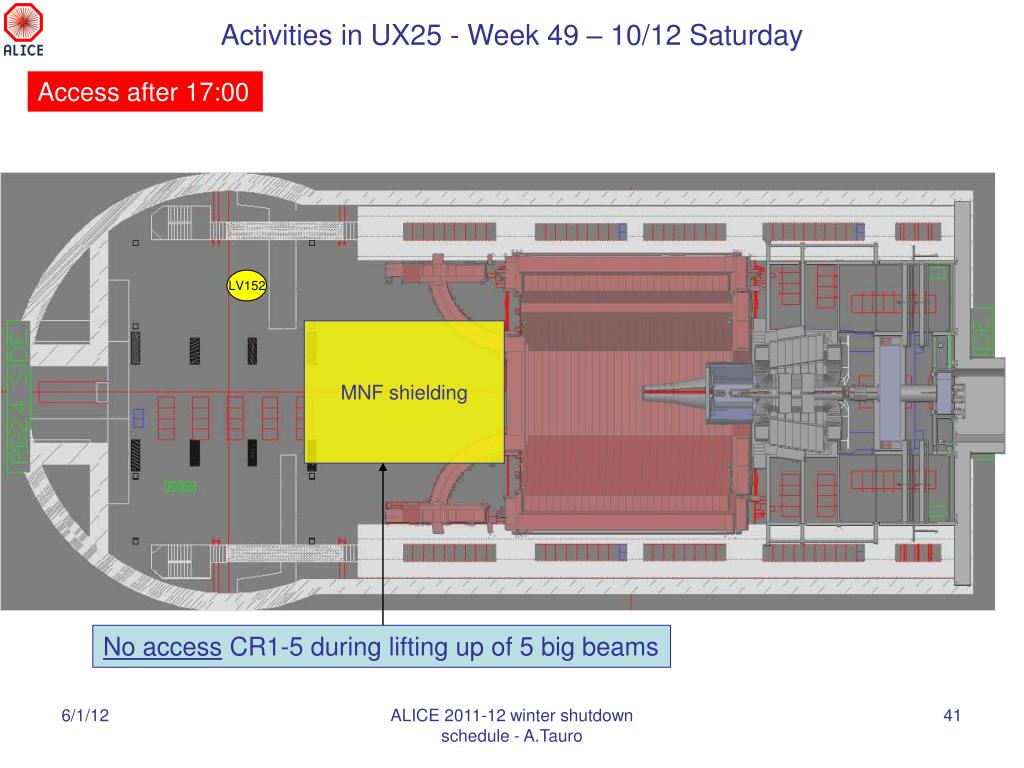

    Activities in UX25 - Week 49 – 10/12 Saturday

    Access after 17:00

    MNF shielding

    No access CR1-5 during lifting up of 5 big beams

    ALICE 2011-12 winter shutdown schedule - A.Tauro


    2011 12 winter shutdown preparatory meeting

    Activities in UX25 - Week 49 – 11/12 Sunday

    PHOS

    ALICE 2011-12 winter shutdown schedule - A.Tauro


    2011 12 winter shutdown preparatory meeting

    It

    H

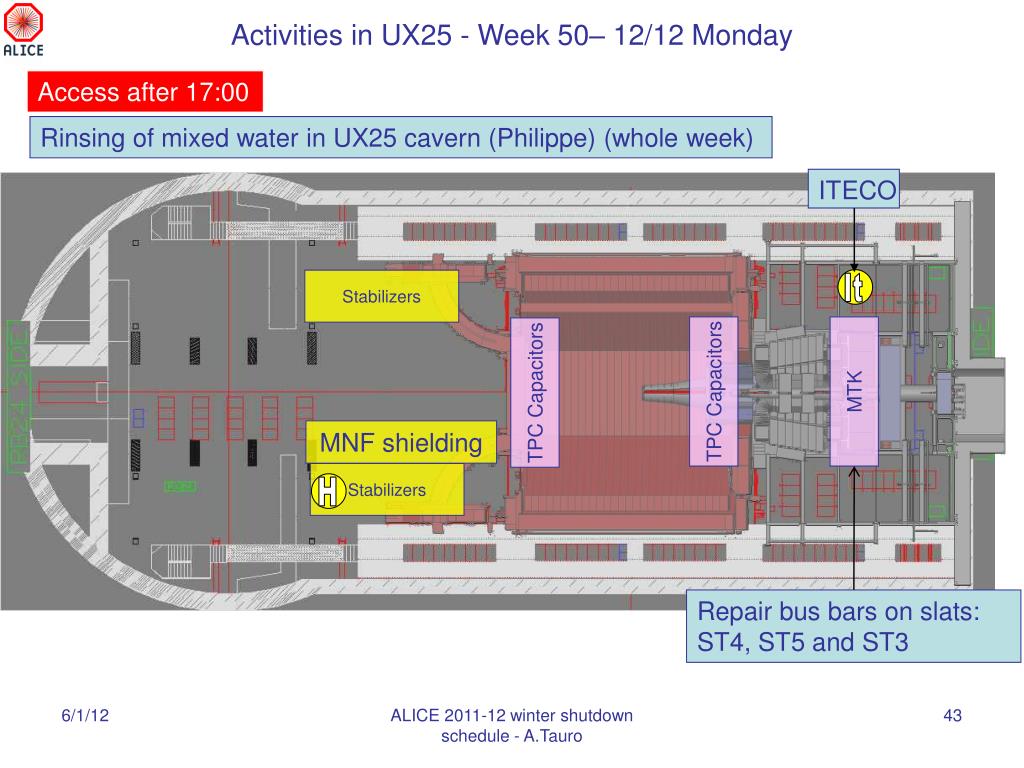

    Activities in UX25 - Week 50– 12/12 Monday

    Access after 17:00

    Rinsing of mixed water in UX25 cavern (Philippe) (whole week)

    ITECO

    Stabilizers

    MTK

    TPC Capacitors

    TPC Capacitors

    MNF shielding

    Stabilizers

    Repair bus bars on slats: ST4, ST5 and ST3

    ALICE 2011-12 winter shutdown schedule - A.Tauro


    2011 12 winter shutdown preparatory meeting

    It

    LV156

    Activities in UX25 - Week 50– 13/12 Tuesday

    Access after 17:00

    Test general secours: stop general services for 10’

    Stop N2 9:00-11:00

    MTK

    TPC Capacitors

    TPC Capacitors

    MNF shielding

    ALICE 2011-12 winter shutdown schedule - A.Tauro


    2011 12 winter shutdown preparatory meeting

    It

    LV156

    Activities in UX25 - Week 50– 14/12 Wednesday

    Access after 17:00

    Remove top elbow in order to install survey tripods

    MNF shielding

    MTK

    L3 ventilation

    SPD

    Disconnect pipes

    • Lifts:

    • Cavern lift maintenance (no access UX25 from 7:00 to 9:00)

    • CR1-4 lift stopped whole day (7:00 – 16:00)

    ALICE 2011-12 winter shutdown schedule - A.Tauro


    2011 12 winter shutdown preparatory meeting

    It

    LV156

    Activities in UX25 - Week 50– 15/12 Thursday

    Access after 17:00

    No access

    MNF shielding (green bridges)

    MTK

    Open I-side door

    SPD

    New inox pipes (after 17:00)

    ALICE 2011-12 winter shutdown schedule - A.Tauro


    2011 12 winter shutdown preparatory meeting

    It

    LV156

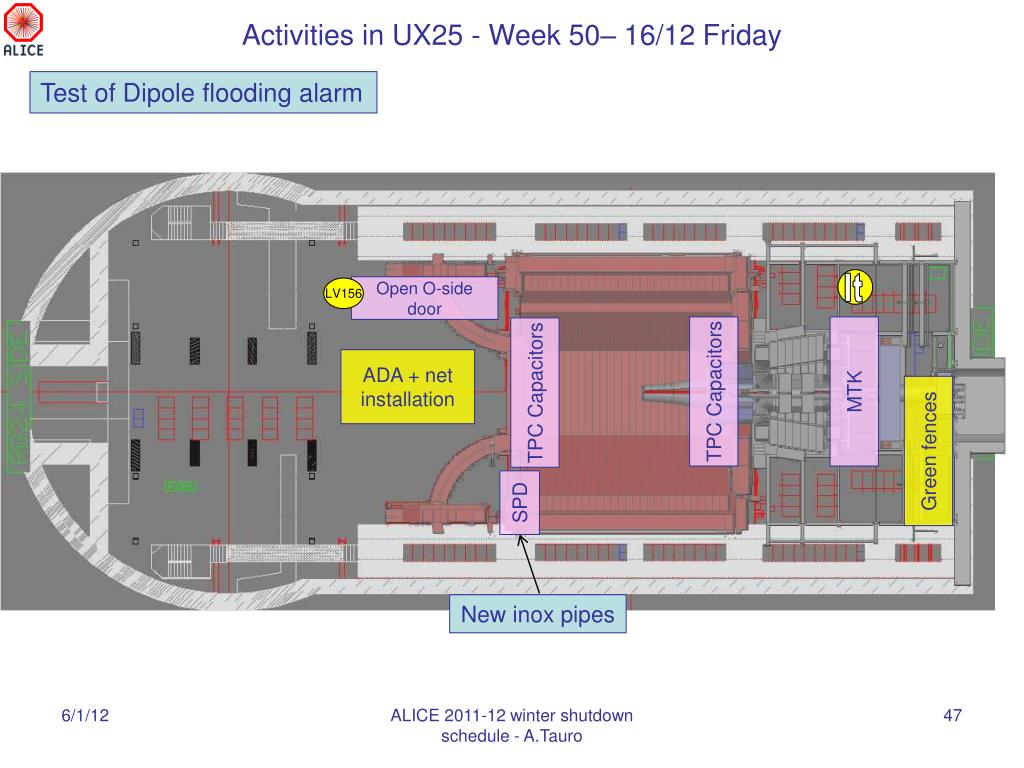

    Activities in UX25 - Week 50– 16/12 Friday

    Test of Dipole flooding alarm

    Open O-side door

    ADA + net installation

    MTK

    TPC Capacitors

    TPC Capacitors

    Green fences

    SPD

    New inox pipes

    ALICE 2011-12 winter shutdown schedule - A.Tauro


    2011 12 winter shutdown preparatory meeting

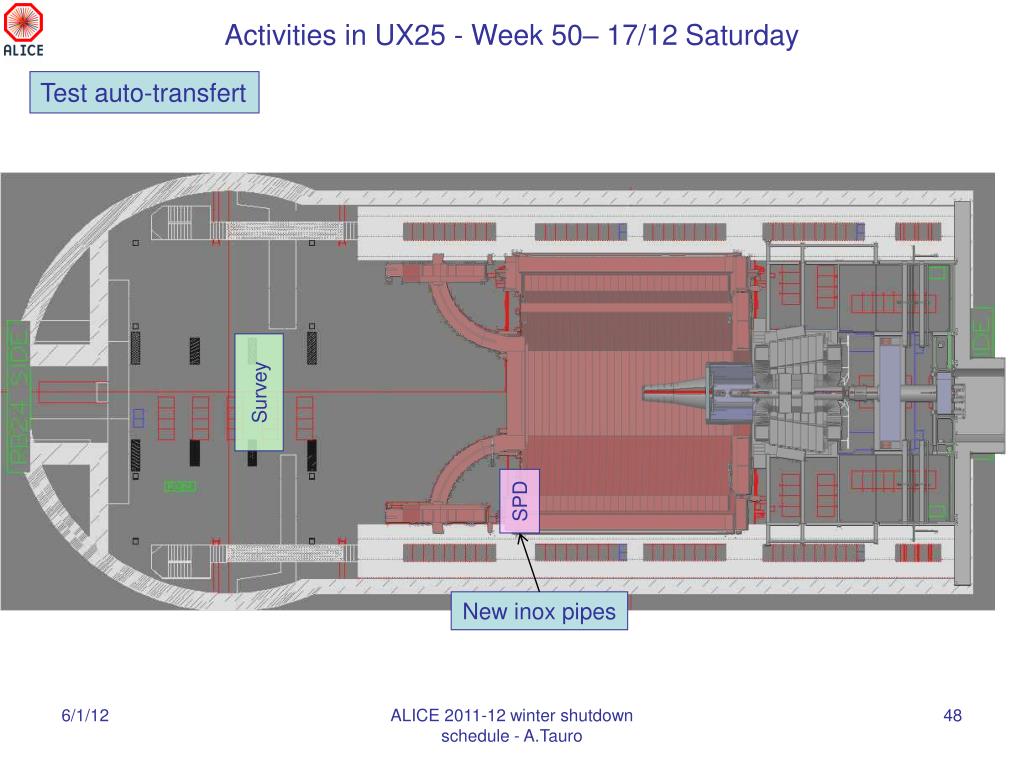

    Activities in UX25 - Week 50– 17/12 Saturday

    Test auto-transfert

    Survey

    SPD

    New inox pipes

    ALICE 2011-12 winter shutdown schedule - A.Tauro


    2011 12 winter shutdown preparatory meeting

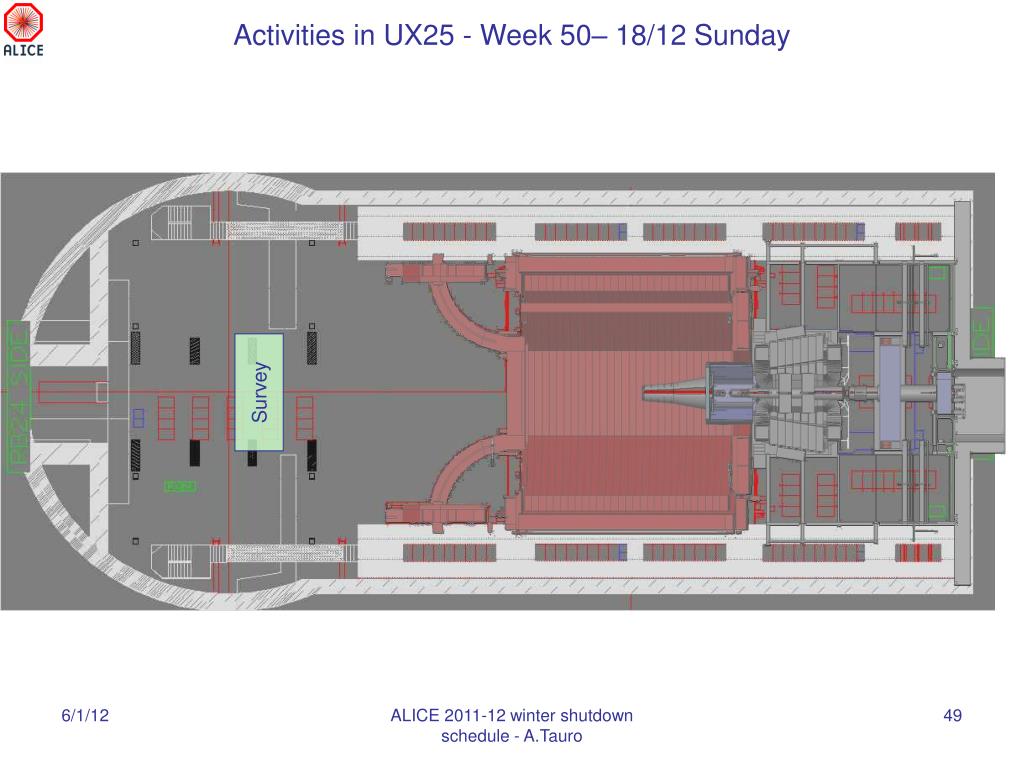

    Activities in UX25 - Week 50– 18/12 Sunday

    Survey

    ALICE 2011-12 winter shutdown schedule - A.Tauro


    2011 12 winter shutdown preparatory meeting

    H

    Activities in UX25 - Week 51– 19/12 Monday

    Access after 17:00 (tbc)

    Maintenance Front-end Electronics

    Release all TOF crates supports (Yannick-Samuel)

    TRD infra.

    MTG

    TPC Capacitors

    TPC Capacitors

    TRD infra.

    SPD

    HAULOTTE

    Drill PP3 filter (1/2 day)

    ALICE 2011-12 winter shutdown schedule - A.Tauro


    2011 12 winter shutdown preparatory meeting

    H

    Activities in UX25 - Week 51– 20/12 Tuesday

    Release all TOF crates supports (Yannick-Samuel)

    MTG

    TPC Capacitors

    TPC Capacitors

    ALICE 2011-12 winter shutdown schedule - A.Tauro


    2011 12 winter shutdown preparatory meeting

    H

    Activities in UX25 - Week 51– 21/12 Wednesday

    DAQ shutdown (PM)

    Decoupling TPC-Space-Frame (Yannick-Samuel)

    MTG

    TPC Capacitors

    TPC Capacitors

    ALICE 2011-12 winter shutdown schedule - A.Tauro


    2011 12 winter shutdown preparatory meeting

    Activities in UX25 - Week 51– 22/12 Thursday

    CERN official holiday

    Decoupling TPC-Space-Frame (Yannick-Samuel)

    TRD

    scaffolding

    ALICE 2011-12 winter shutdown schedule - A.Tauro


    2011 12 winter shutdown preparatory meeting

    Activities in UX25 - Week 51– 23/12 Friday

    CERN official holiday

    Transport TRD6 into cavern

    ALICE 2011-12 winter shutdown schedule - A.Tauro


    Visits dec

    Visits - Dec

    • VIP: StjepanMatin from 24Hours newspaper

      • 9th Dec. (ACR-Exhibition. 10:30 – 11:30). Resp.: S.Tesauri

    • Private visit. 7 people

      • 11th Dec. Resp.: P.Jacobs

    • Private visit. 4 people

      • 12thDec. Resp.: N.Valls

    • ~30 teachers from Czech Republic

      • 16th Dec. (PM). Resp.: K.Safarik

    • Private visit. 7 people

      • 17th Dec. (17:00). Resp.: C.Bortolin

    • 50 students from the University of Bologna Chemistry Department

      • 17th Dec. Resp.: R.Nania

    • Private visit. 2 people

      • 19thDec. (17:00). Resp.: A.Tauro

    • VIP: Kim Steele, New York Times Review

      • 21st Dec. Resp.: D.Hatzifotiadou

    • Private visit. 6 people

      • 21st Dec. Resp.: T.Kugathasan

    ALICE 2011-12 winter shutdown schedule - A.Tauro


    Visits jan 1 3

    Visits – Jan 1/3

    • Private visit (3 people)

      • 5thJan. (15:00). Resp.: T.Morhardt

    • Private visit (2 people)

      • 7th Jan. Resp.: J.Wessels

    • Hungarian Student Group (25 people)

      • 11th January (9:00 to 10:00). Resp.: P.Levai

    • TI operators

      • 11th Jan. (14:00). Resp.: A.Augustinus

    • Private visit (1 people)

      • 12th Jan. (10:00). Resp.: C.Cheshkov

    • 2nd High School of Kozani, Greece. 50 students (not underground)

      • 12th Jan. Resp.: D.Hatzifotiadou

    • Steve Elkins (documentary film-maker) + his video team

      • 12th Jan. at 10:00. Resp.:D.Hatzifotiadou

    • Hungarian Student Group (25 people)

      • 13th Jan. (9:00 to 10:00). Resp.: P.Levai

    • Private visit (x people)

      • 13th Jan. Resp.: D.DeGruttula

    • School visit (25 people)

      • 14th Jan. (13:30 – 15:00). Resp.: W.Riegler

    • Private visit (6 people)

      • 14th Jan. Resp.: C.Bortolin

    ALICE 2011-12 winter shutdown schedule - A.Tauro


    Visits jan 2 3

    Visits – Jan 2/3

    • Private visit (7 people)

      • 15th Jan. Resp.: C.Nygaard

    • Private visit (3 people)

      • 15th Jan. Resp.: N. van der Kolk

    • VIP: Delegation (10 persons). President of the French Centre national de la recherchescientifique (CNRS)

      • 16th Jan. (14:30). Resp.: Y.Schutz

    • Private visit (2 people)

      • 16thJan. Resp.: P.Chochula

    • Private visit (1 people)

      • 17th Jan. (lunch time). Resp.: P.Chochula

    • 5 people from DELL

      • 18thJan. (10:00). Resp.: P.Chochula

    • Private visit (2 people)

      • 18thJan. (lunch time). Resp.: P.Chochula

    • Group of 20 students from a high school in Utrecht, the Netherlands

      • 18th Jan (14:00). Resp. N. van der Kolk

    • Group of Italian students (42 students + 4 teachers)

      • 19th Jan (9:45). Resp.: C.Bortolin

    • Private visit (2 people)

      • 18th (after 16:00) or 19thJan. (PM). Resp.: J.Schukraft

    • Private visit (6 people)

      • 20th Jan. (after 17:00). Resp.: R.Turrisi

    • Private visit (5 people)

      • 20th Jan. (after 18:00). Resp.: F. Bock

    ALICE 2011-12 winter shutdown schedule - A.Tauro


    Visits jan 3 3

    Visits – Jan 3/3

    • Private visit 2 x 15 people (GSI / ALICE members + their partners)

      • 21st and 22nd Jan. Resp.: J.Thaeder

    • Students from Nyon (22 people)

      • 23th Jan. (9:00 – 11:30). Resp.: C.H.Denarie

    • Private visit (2 people)

      • 23rd Jan. Resp.: J.Wessels

    • Filming crew (2 people)

      • 24th Jan. Resp.: D.Hatzifotiadou

    • Group of 46 students from Trieste

      • 26th Jan. Resp.: M.Venaruzzo

    • VIP: Members of the Comitato per ilProgettoCulturale (IT)

      • 26th Jan. (12:15). Resp.: L.Pedroso

    • Group of 40 students + 4 teachers from Cagliari

      • 27th Jan. (9:00). Resp.: C.Cicalo

    • German School Geneva, 9th grade, i.e. 14-15 years old, 15 pupils plus teacher

      • 30th Jan. Resp.: R.Renfordt

    ALICE 2011-12 winter shutdown schedule - A.Tauro


    Visits feb

    Visits –Feb

    • 50 students from university of Tübingen

      • 2nd Feb. Resp.: H-R.Schmidt

    • Private visit 10 people

      • 5th or 11th or 12th Feb. Resp.: S.Boele’

    • 16 students from German school in Geneva

      • 7th and 9th Feb. Resp.: R.Renfordt

    • Visit of danish high school class (1 teacher and 12 students)

      • 9th Feb. Resp. C.Søgaard

    • Vice-Chancellor of Birmingham University and 7 senior figures from industry

      • 15th Feb. (12:00 to 13:00). Resp.: D.Evans

    • Group of 38 students + 4 teachers from Cagliari

      • 21st Feb. Resp.: C.Cicalo

    • 50 students from High-school LiceoScientifico "G. Salvemini" from Bari

      • 27th or 28th Feb. Resp.: V.Manzari

    • Two visitors from Mexican TV (Channel 22)

      • 28th or 29th February. Resp.: G.Herrera Corral

    ALICE 2011-12 winter shutdown schedule - A.Tauro


    2011 12 winter shutdown preparatory meeting

    AOB

    • As from now ADI replaced by IMPACT

      • Please do not submit anymore ADI requests

      • ADI no longer used

      • IMPACT is the new CERN wide tool

      • See Fernando’s tutorial

    ALICE 2011-12 winter shutdown schedule - A.Tauro


  • Login
