Beam-Based Alignment Results

Beam-Based Alignment Results. Henrik Loos, for the LCLS Commissioning Team. Undulator Trajectory Requirements. Beam through undulator rms 2 μ m per gain length Undulator with 33 segments total 100 m Not possible with conventional alignment

elton
Download Presentation

Beam-Based Alignment Results

An Image/Link below is provided (as is) to download presentation Download Policy: Content on the Website is provided to you AS IS for your information and personal use and may not be sold / licensed / shared on other websites without getting consent from its author. Content is provided to you AS IS for your information and personal use only. Download presentation by click this link. While downloading, if for some reason you are not able to download a presentation, the publisher may have deleted the file from their server. During download, if you can't get a presentation, the file might be deleted by the publisher.

E N D

Presentation Transcript

  1. Beam-Based Alignment Results Henrik Loos, for the LCLS Commissioning Team

  2. Undulator Trajectory Requirements • Beam through undulator rms 2 μm per gain length • Undulator with 33 segments total 100 m • Not possible with conventional alignment • Use beam based alignment using set of different energies • RF BPM resolution < 1 μm

  3. Undulator Configuration In/Out BFW Undulator Quad Corr RF BPM K Beam Scan Girder Girder Movers • Undulator, Quad, BPM, BFW move with girder • Beam Finder Wire (BFW) retractable • Horizontal translation of undulator • Complete retract (80 mm) • Undulator K adjustment (± 5 mm)

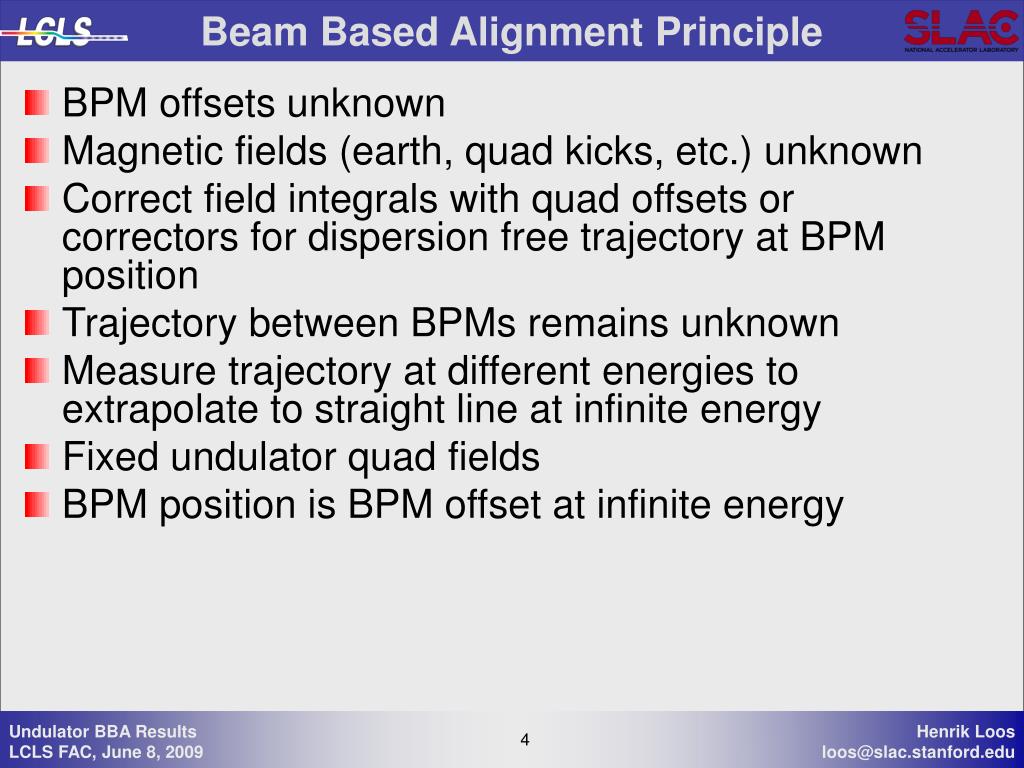

  4. Beam Based Alignment Principle • BPM offsets unknown • Magnetic fields (earth, quad kicks, etc.) unknown • Correct field integrals with quad offsets or correctors for dispersion free trajectory at BPM position • Trajectory between BPMs remains unknown • Measure trajectory at different energies to extrapolate to straight line at infinite energy • Fixed undulator quad fields • BPM position is BPM offset at infinite energy

  5. BBA Measurement Schematic Δb0 Δb1 Δb2 Δb3 Δb0 Δq1 Δq2 Δq3 E2 x,x’ E1 Δy0 Δy1 Δy2 Δy3 Δy4 BPM Offsets Δbi Quad Offsets Δqi E1<E2

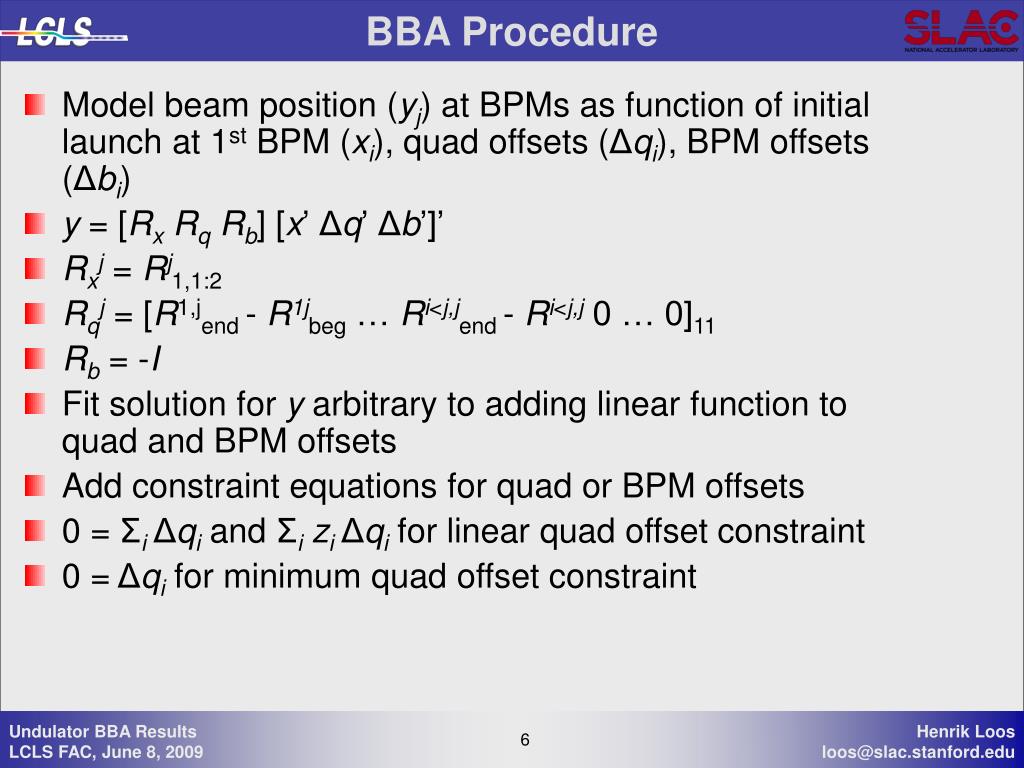

  6. BBA Procedure • Model beam position (yj) at BPMs as function of initial launch at 1st BPM (xi), quad offsets (Δqi), BPM offsets (Δbi) • y = [RxRqRb] [x’Δq’Δb’]’ • Rxj = Rj1,1:2 • Rqj = [R1,jend- R1jbeg … Ri<j,jend- Ri<j,j 0 … 0]11 • Rb = -I • Fit solution for y arbitrary to adding linear function to quad and BPM offsets • Add constraint equations for quad or BPM offsets • 0 = ΣiΔqi and ΣiziΔqi for linear quad offset constraint • 0 = Δqi for minimum quad offset constraint

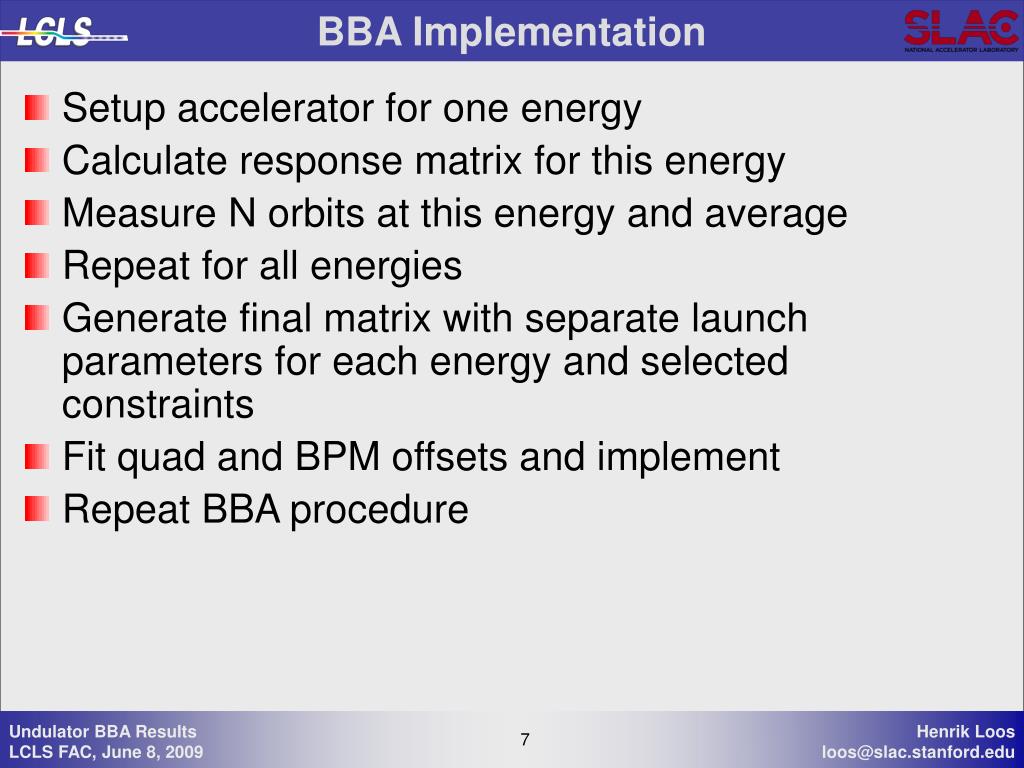

  7. BBA Implementation • Setup accelerator for one energy • Calculate response matrix for this energy • Measure N orbits at this energy and average • Repeat for all energies • Generate final matrix with separate launch parameters for each energy and selected constraints • Fit quad and BPM offsets and implement • Repeat BBA procedure

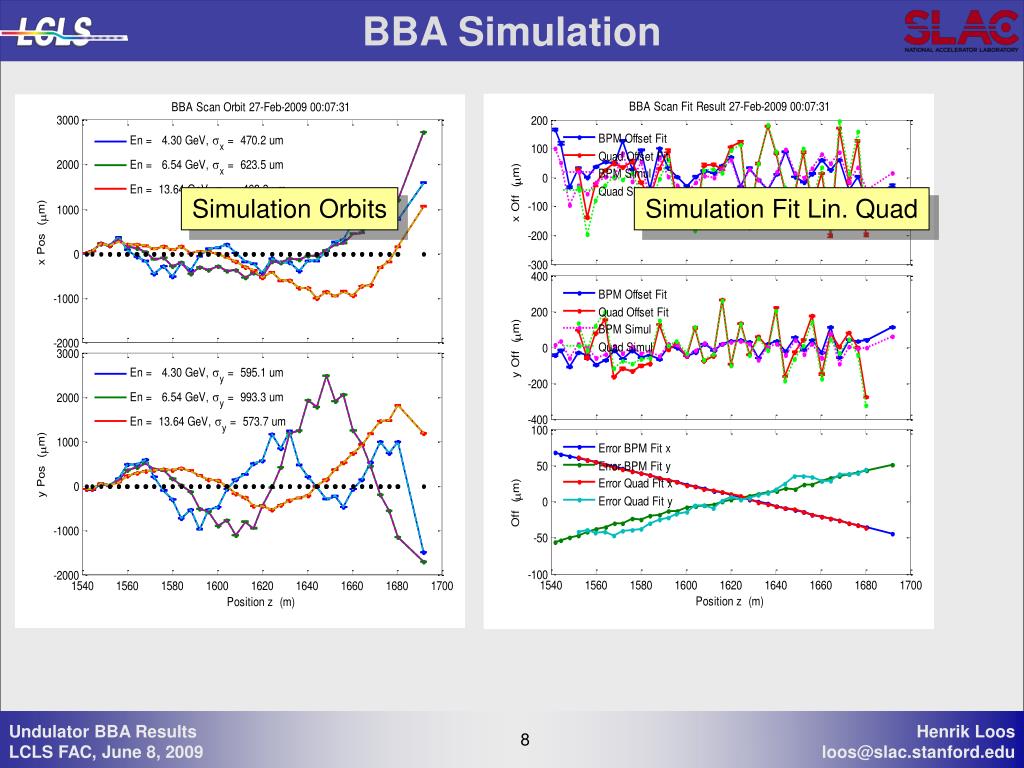

  8. BBA Simulation Simulation Orbits Simulation Fit Lin. Quad

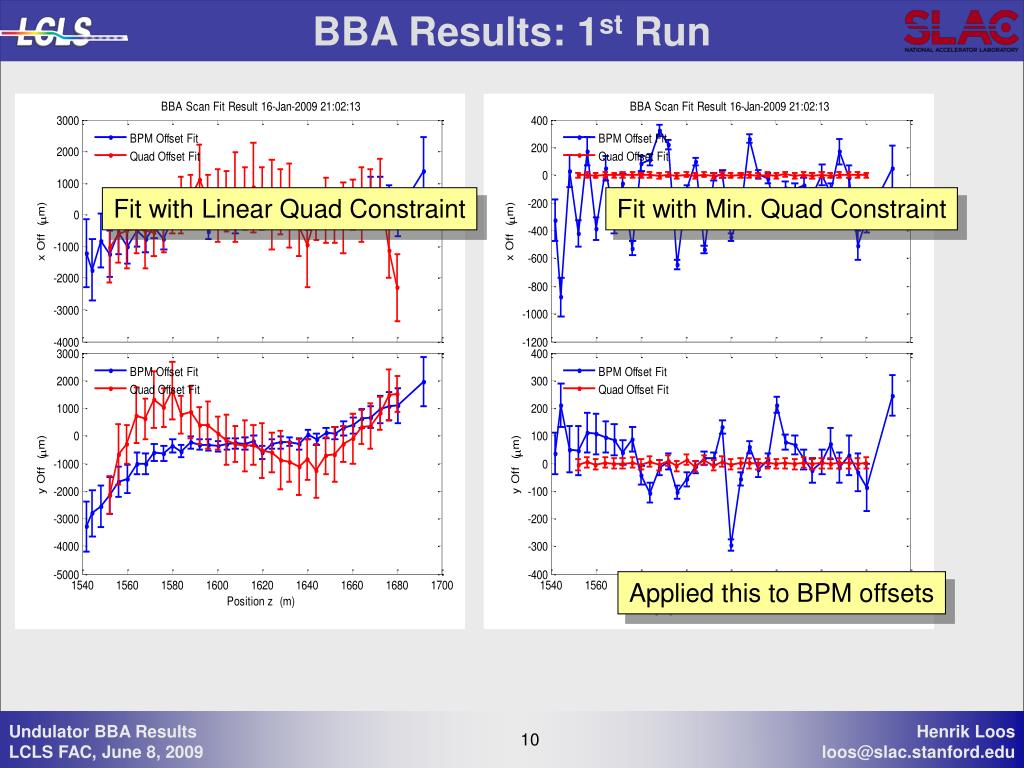

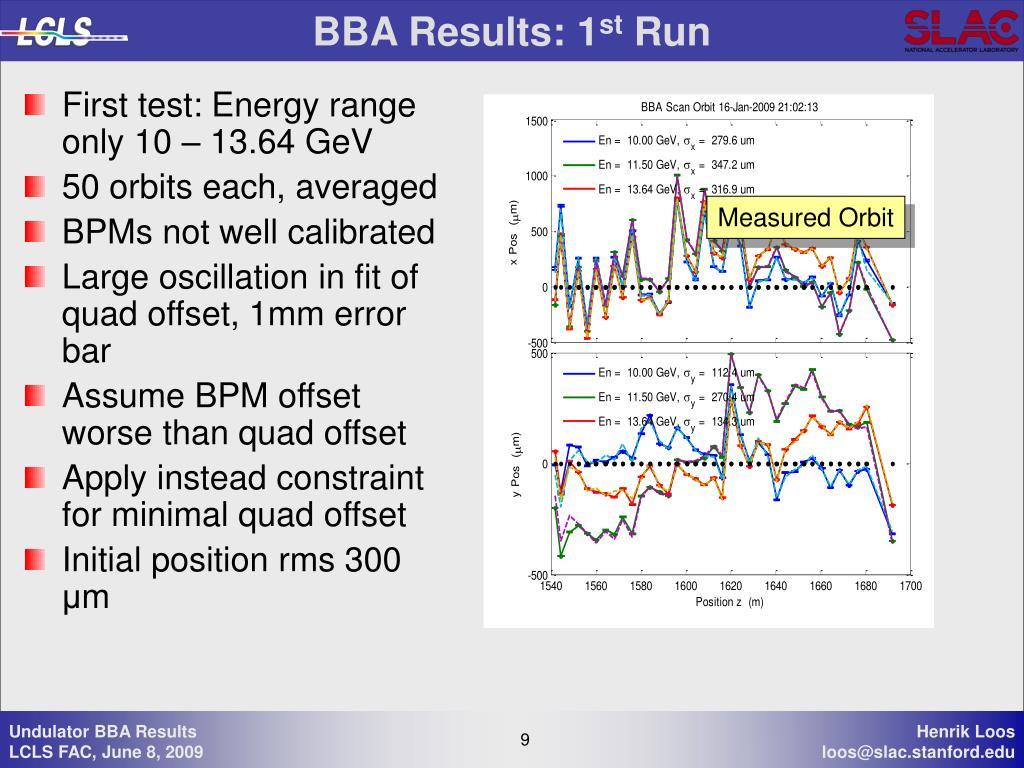

  9. BBA Results: 1st Run • First test: Energy range only 10 – 13.64 GeV • 50 orbits each, averaged • BPMs not well calibrated • Large oscillation in fit of quad offset, 1mm error bar • Assume BPM offset worse than quad offset • Apply instead constraint for minimal quad offset • Initial position rms 300 μm Measured Orbit

  10. BBA Results: 1st Run Fit with Linear Quad Constraint Fit with Min. Quad Constraint Applied this to BPM offsets

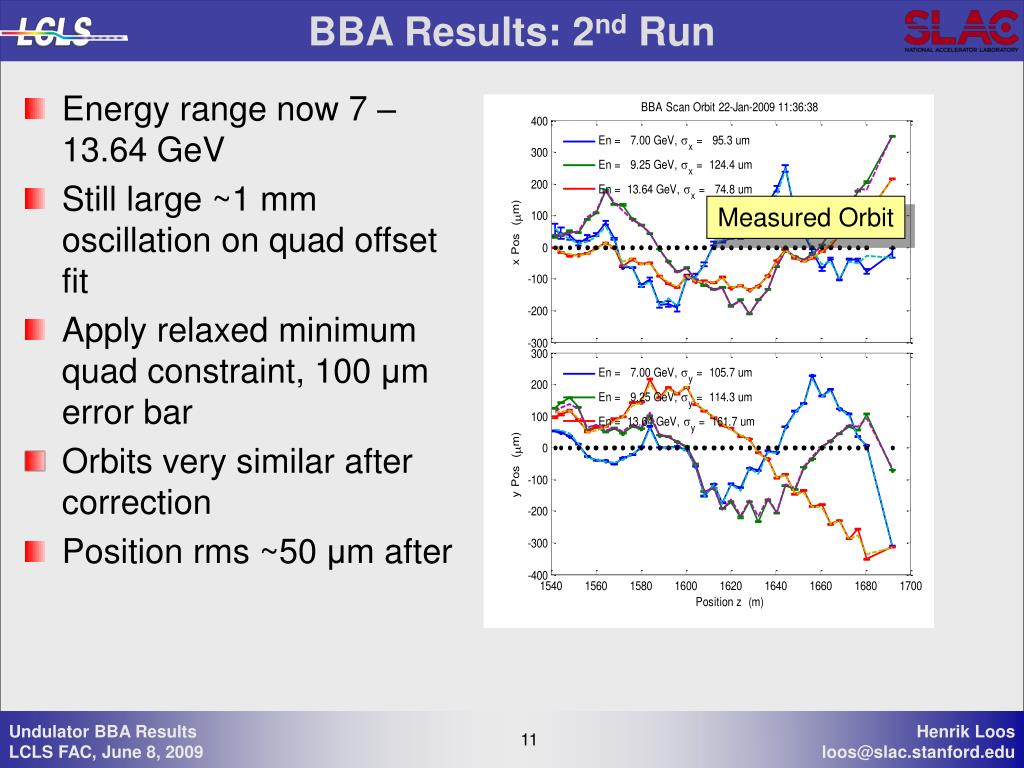

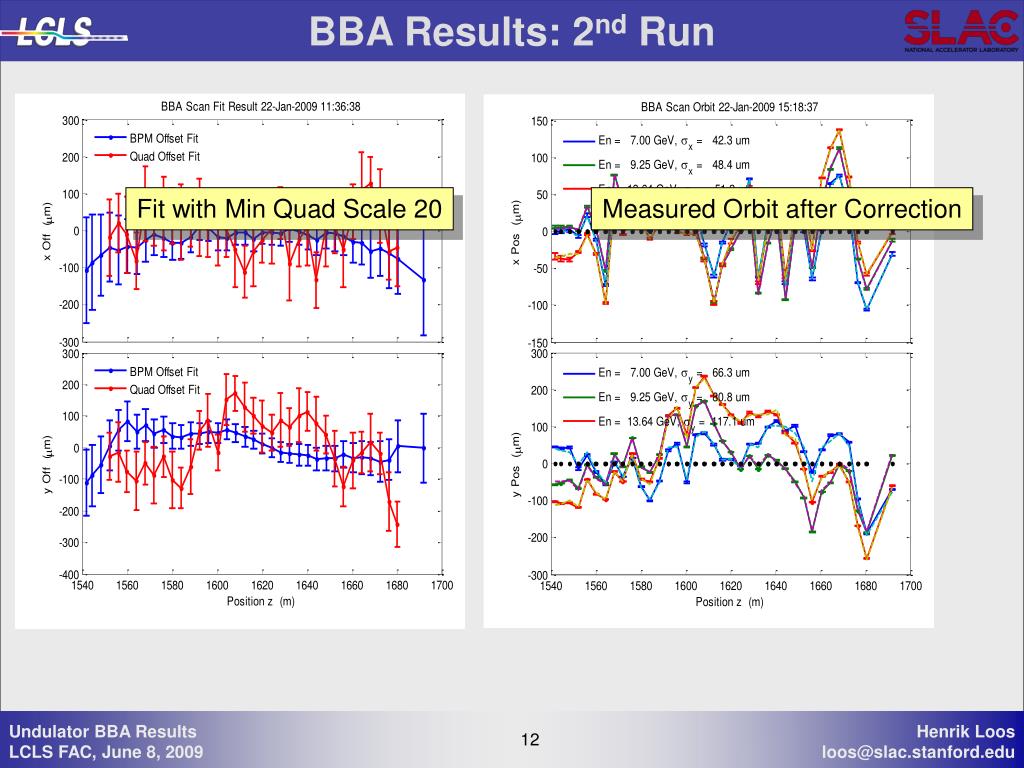

  11. BBA Results: 2nd Run • Energy range now 7 – 13.64 GeV • Still large ~1 mm oscillation on quad offset fit • Apply relaxed minimum quad constraint, 100 μm error bar • Orbits very similar after correction • Position rms ~50 μm after Measured Orbit

  12. BBA Results: 2nd Run Fit with Min Quad Scale 20 Measured Orbit after Correction

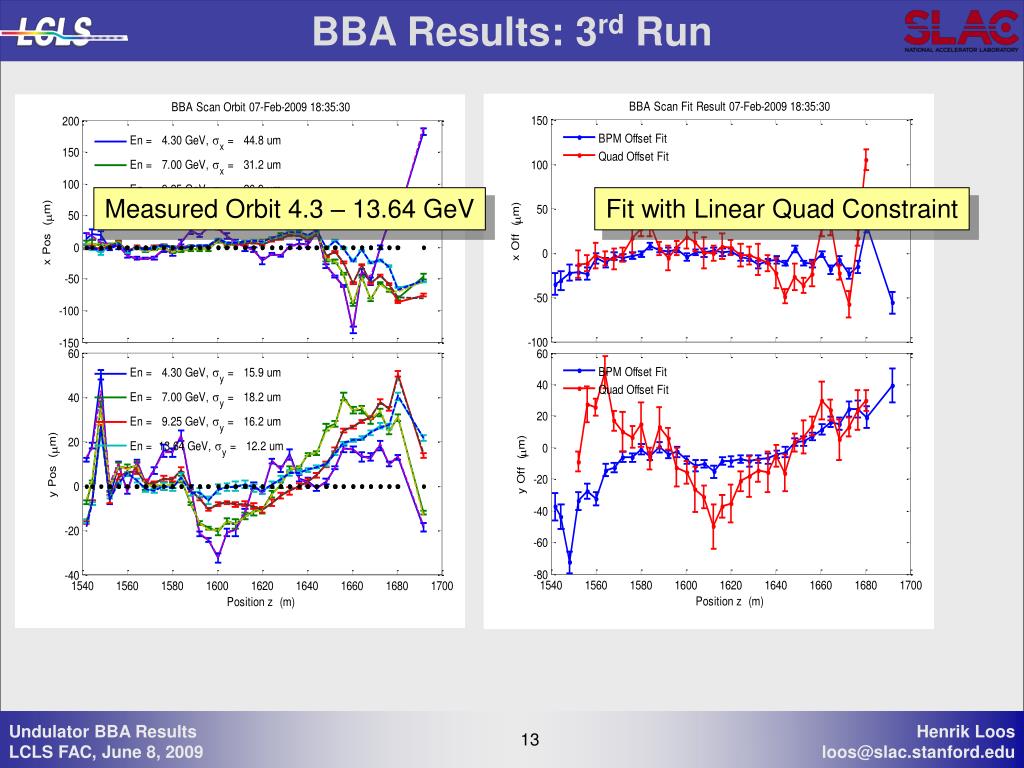

  13. BBA Results: 3rd Run Measured Orbit 4.3 – 13.64 GeV Fit with Linear Quad Constraint

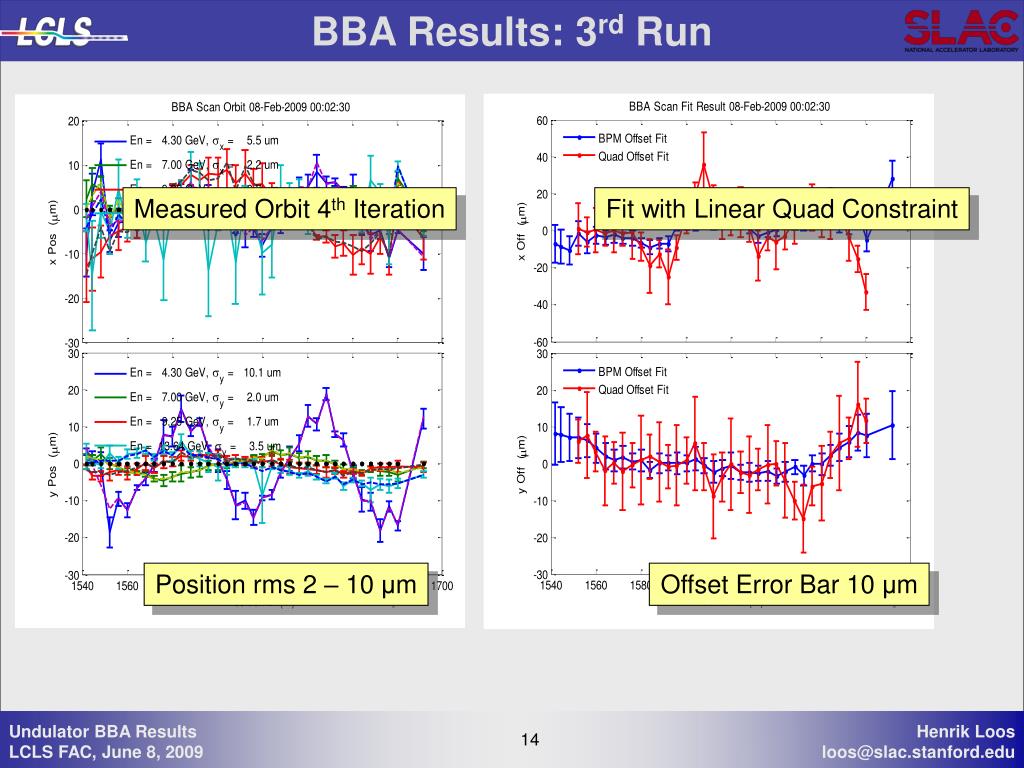

  14. BBA Results: 3rd Run Measured Orbit 4th Iteration Fit with Linear Quad Constraint Position rms 2 – 10 μm Offset Error Bar 10 μm

  15. BBA Results: Best Orbit • Carefully calibrated BPMs • Energy range 4.3 – 13.64 GeV • 4 different energies • Undulator launch feedback on • Average position rms 1 – 2 μm • Betatron jitter ~20 μm

  16. BBA Results: Girder Bump Test 58um bump @ 13.7 GeV & -58um BPM offset -48um bump @ 13.7 GeV BBA procedure finds both quad offsets and BPM offsets

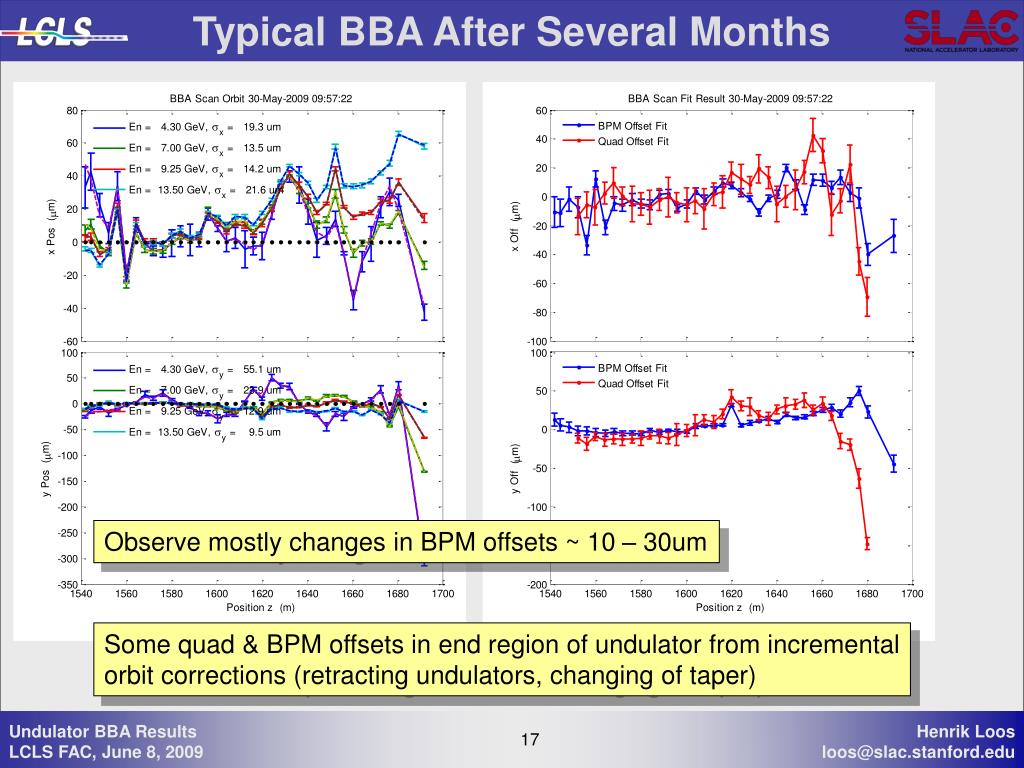

  17. Typical BBA After Several Months Observe mostly changes in BPM offsets ~ 10 – 30um Some quad & BPM offsets in end region of undulator from incremental orbit corrections (retracting undulators, changing of taper)

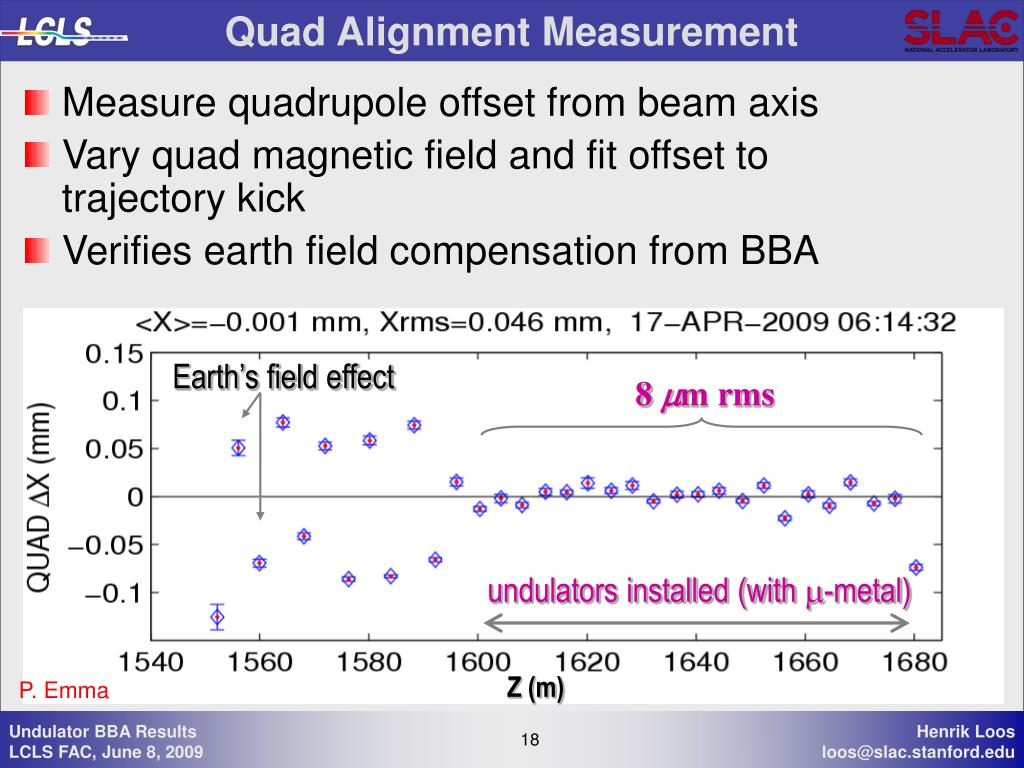

  18. Quad Alignment Measurement Earth’s field effect 8 mm rms undulators installed (with m-metal) Measure quadrupole offset from beam axis Vary quad magnetic field and fit offset to trajectory kick Verifies earth field compensation from BBA Z (m) P. Emma

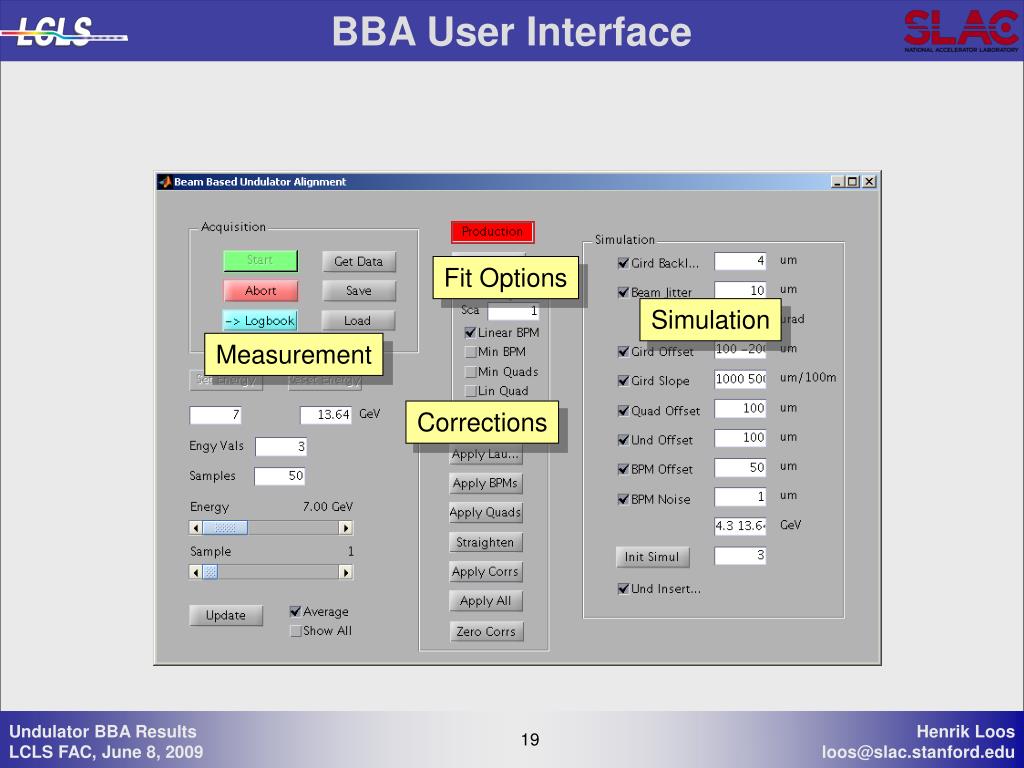

  19. BBA User Interface Fit Options Simulation Measurement Corrections

  20. Fast Linac Energy Change • User interface to run an automated script • Block/unblock beam • Activate saved klystron configuration • Trim saved magnet configuration • Toggles feedbacks • Enables one BBA run in 10 - 15min (at best), ~2 – 4 h (worst)

  21. BBA & Undulator Taper • Orbit effects from undulator motion • No earth field shielding with retracted undulator • Undulator translation (~80 mm) shifts entire girder by ~10 - 100 um (quad & BPM) • Undulator field integral depends on taper • Goal • Straight trajectory for all undulator translations • Strategy • Do BBA at design taper, correct quad position • Compensate field integral change for different taper with corrector coil • Compensate girder shift for retracted undulator with corrector coils and BPM offset

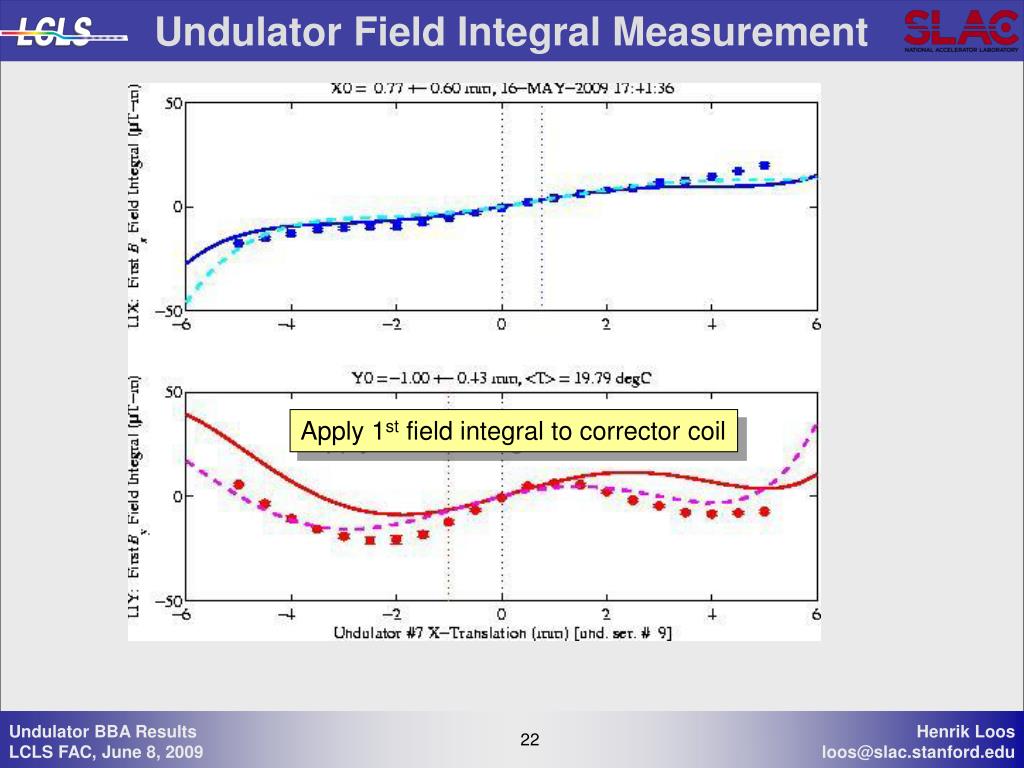

  22. Undulator Field Integral Measurement Apply 1st field integral to corrector coil

  23. Summary • Achieved • BBA procedure successfully implemented • Converges to ~1 μm trajectory rms • Important to have full energy range • Errors on fitted quad offsets decreased from 1 mm to 10 μm with increasing energy range • Fast energy switching 15 min BBA possible • Complemented by measurement of quad offsets by varying quad strength • To Do • Fully automate energy change (Interface to energy management, orbit feedback in linac) • Study BBA at low charge (< 250 pC) • Implement orbit correction from undulator translation • Compare girder position from BBA with alignment diagnostic system (ADS) • Monitor and study BPM offset drifts
