Temporary design changes

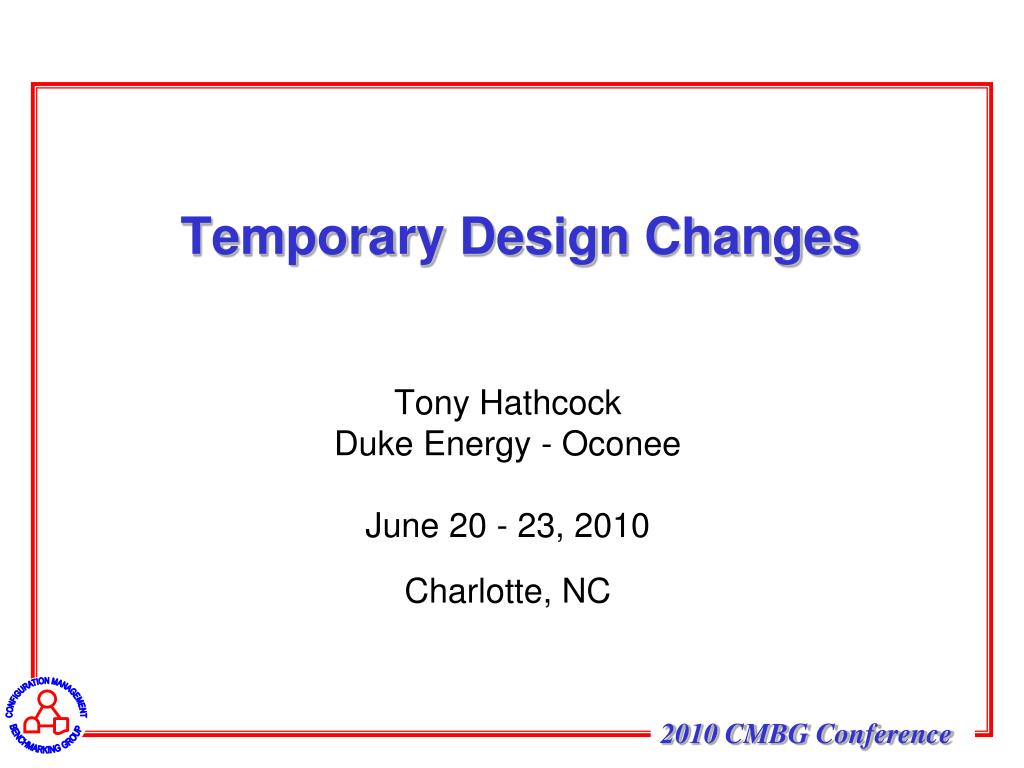

Temporary Design Changes

Tony Hathcock

Duke Energy - Oconee

June 20 - 23, 2010Charlotte, NC


Types of changes

Types of Changes

We all have various methods that allow configuration changes at our sites.

Let’s be sure we’re comparing “apples to apples”.


Types of changes1

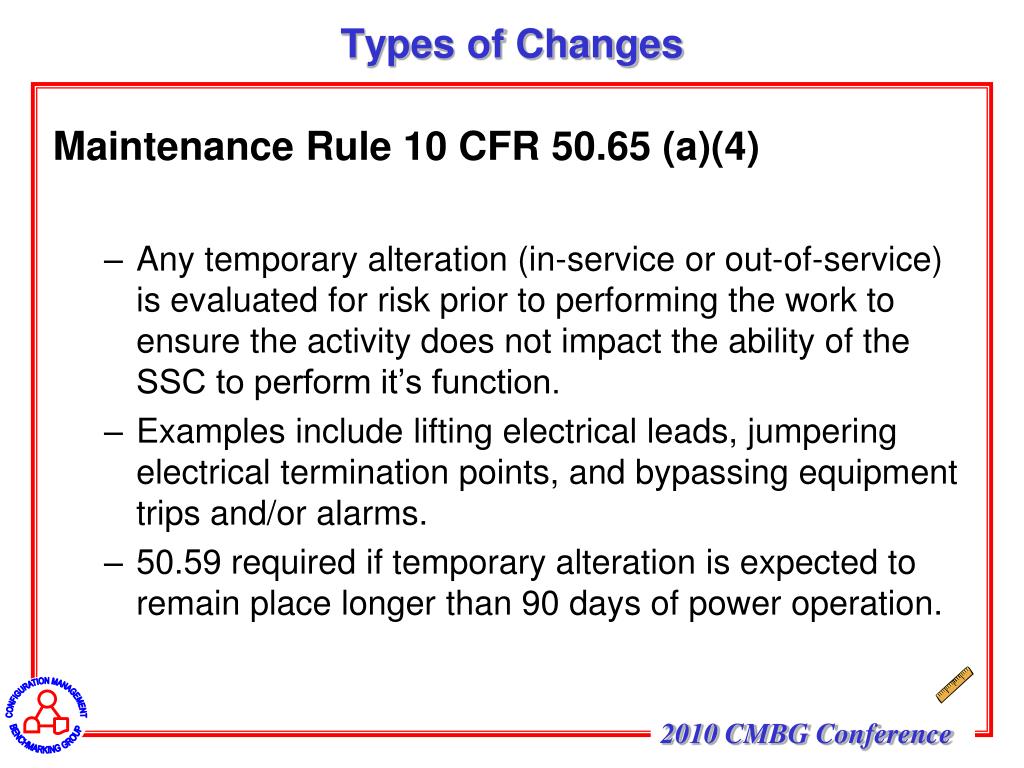

Types of Changes

Maintenance Rule 10 CFR 50.65 (a)(4)

  • Any temporary alteration (in-service or out-of-service) is evaluated for risk prior to performing the work to ensure the activity does not impact the ability of the SSC to perform it’s function.

  • Examples include lifting electrical leads, jumpering electrical termination points, and bypassing equipment trips and/or alarms.

  • 50.59 required if temporary alteration is expected to remain place longer than 90 days of power operation.


Types of changes2

Types of Changes

Temporary Configuration Changes:

  • Pre-approved configuration changes controlled by a procedure or program for simple and routine activities for in-service SSCs.

  • Procedurally controlled configuration changes.


Types of changes3

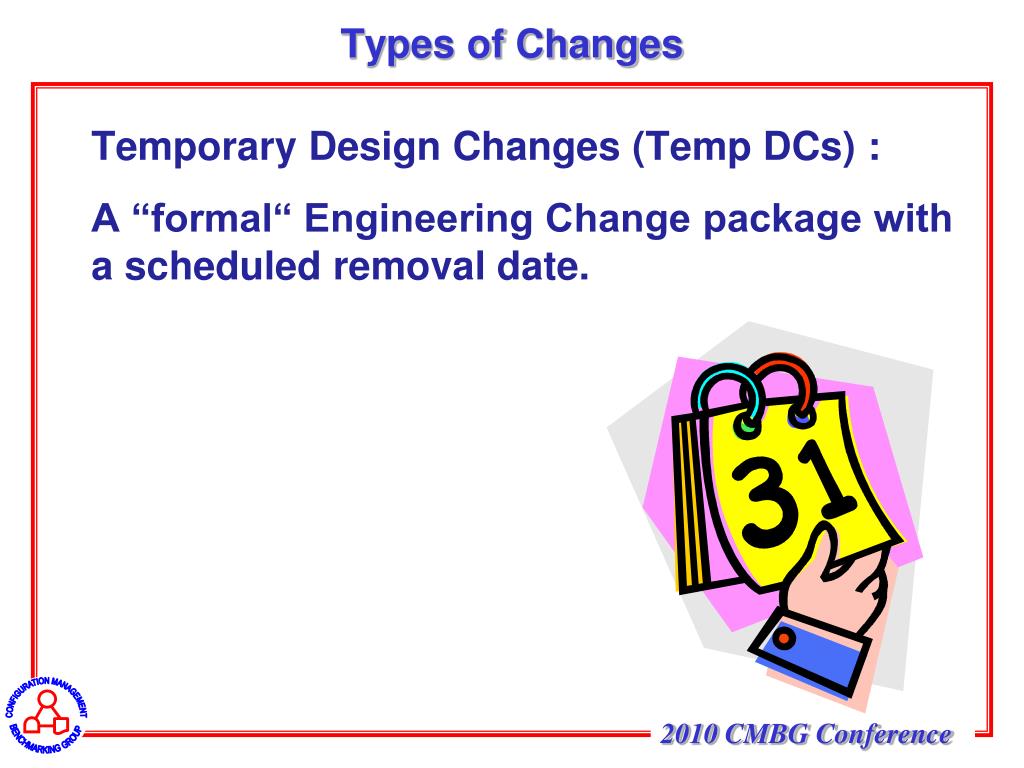

Types of Changes

Temporary Design Changes (Temp DCs) :

A “formal“ Engineering Change package with a scheduled removal date.


Guiding principle

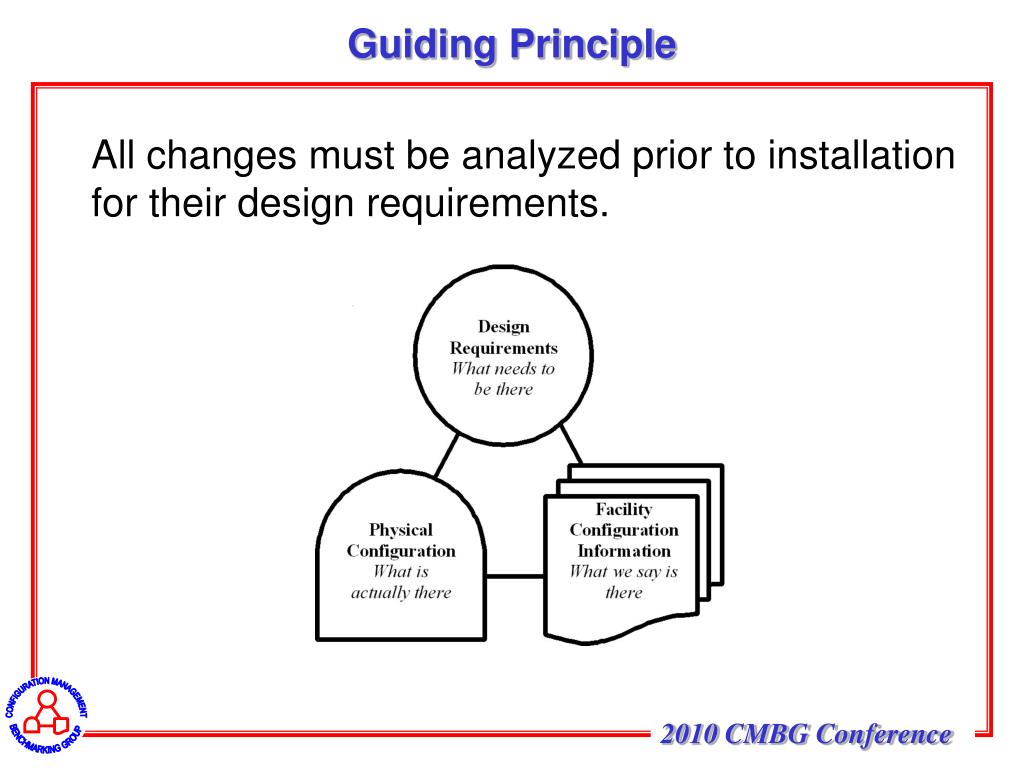

Guiding Principle

All changes must be analyzed prior to installation for their design requirements.

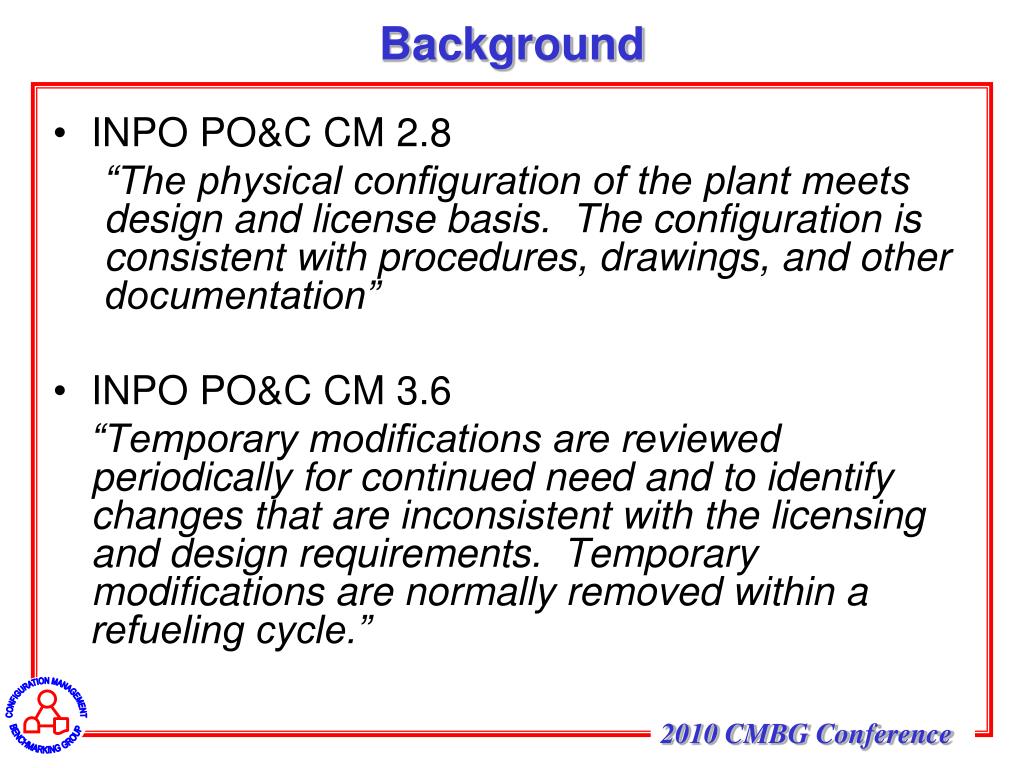

Background

Background

  • INPO PO&C CM 2.8

    “The physical configuration of the plant meets design and license basis. The configuration is consistent with procedures, drawings, and other documentation”

  • INPO PO&C CM 3.6

    “Temporary modifications are reviewed periodically for continued need and to identify changes that are inconsistent with the licensing and design requirements. Temporary modifications are normally removed within a refueling cycle.”


Oconee inpo mid cycle performance deficiency

Oconee INPO Mid-cycle Performance Deficiency

Temp DC is LATE

Five temporary design changes have been installed greater than 18 months (one refueling cycle), resulting in a red CM Performance Indicator. The indicator is based on INPO Performance criterion CM.3-6 "Temporary modifications are normally removed within a refueling cycle."

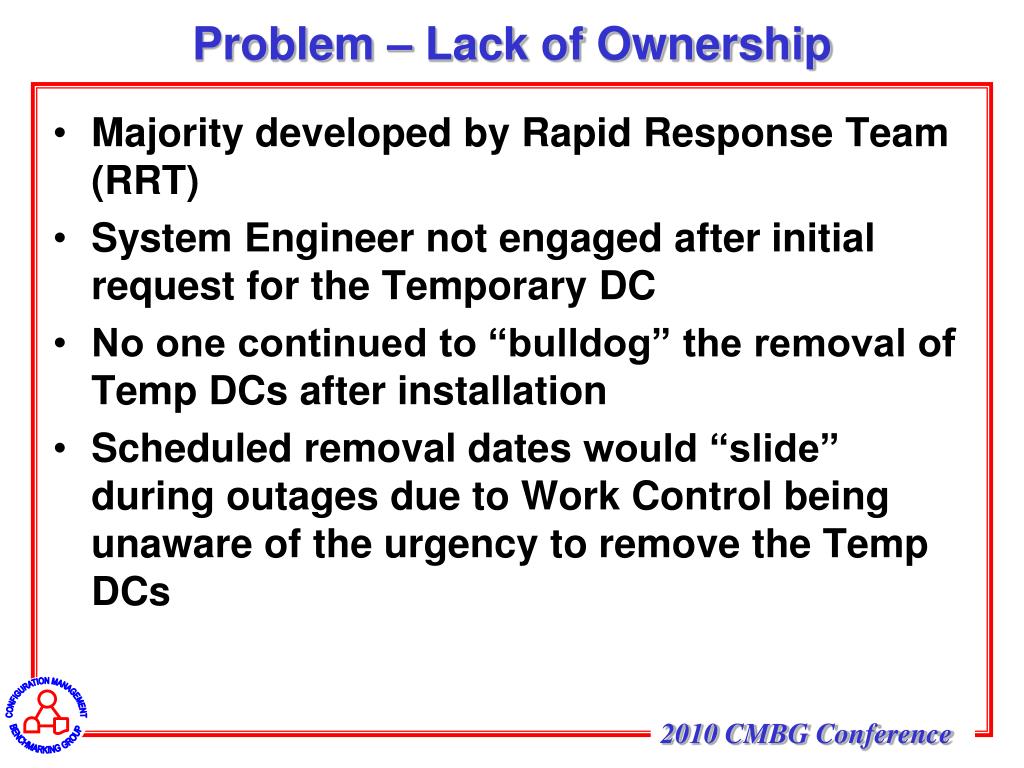

Problem lack of ownership

Problem – Lack of Ownership

  • Majority developed by Rapid Response Team (RRT)

  • System Engineer not engaged after initial request for the Temporary DC

  • No one continued to “bulldog” the removal of Temp DCs after installation

  • Scheduled removal dates would “slide” during outages due to Work Control being unaware of the urgency to remove the Temp DCs

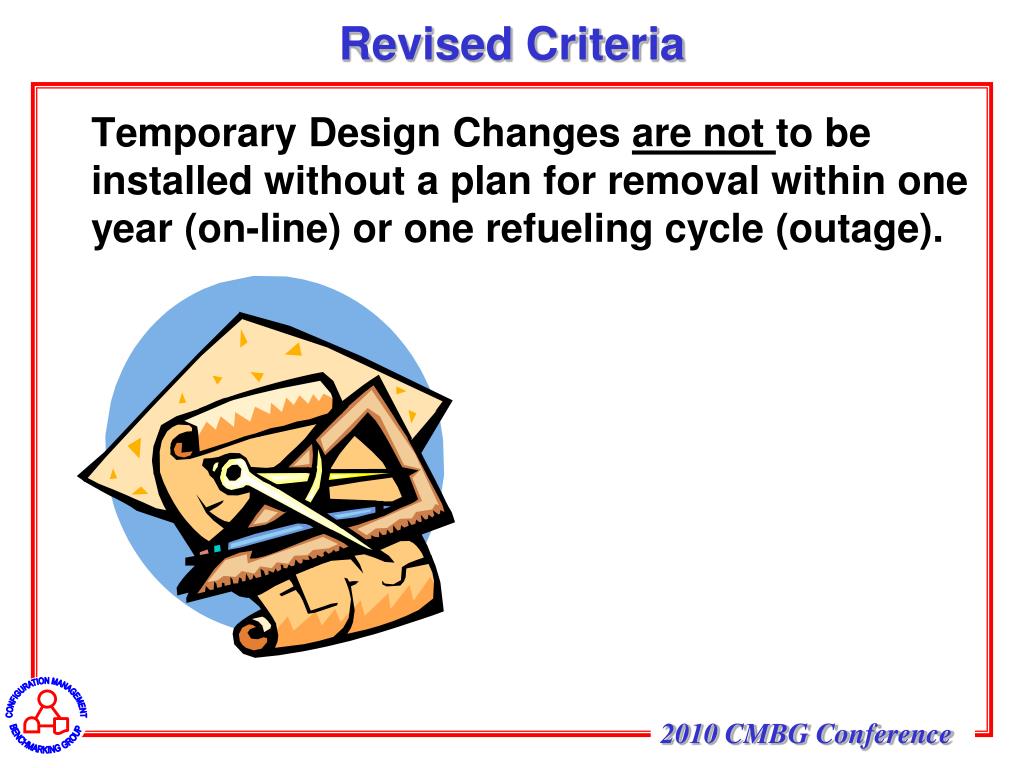

Revised criteria

Revised Criteria

Temporary Design Changes are not to be installed without a plan for removal within one year (on-line) or one refueling cycle (outage).

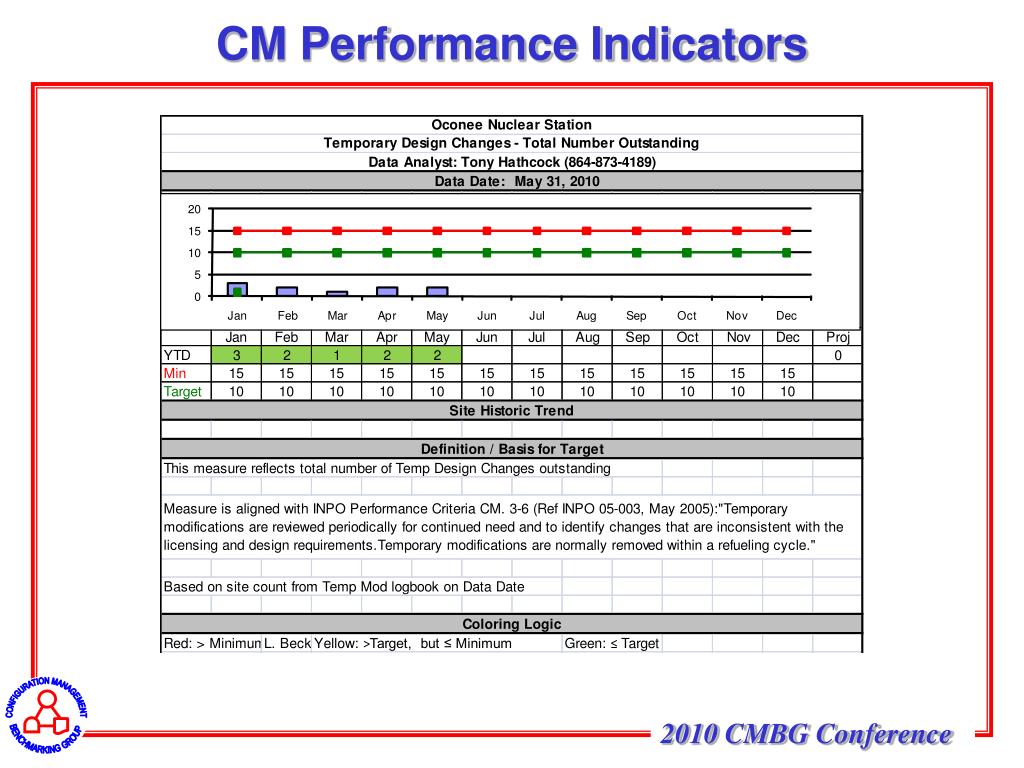

Cm performance indicators

CM Performance Indicators


Cm performance indicators1

CM Performance Indicators

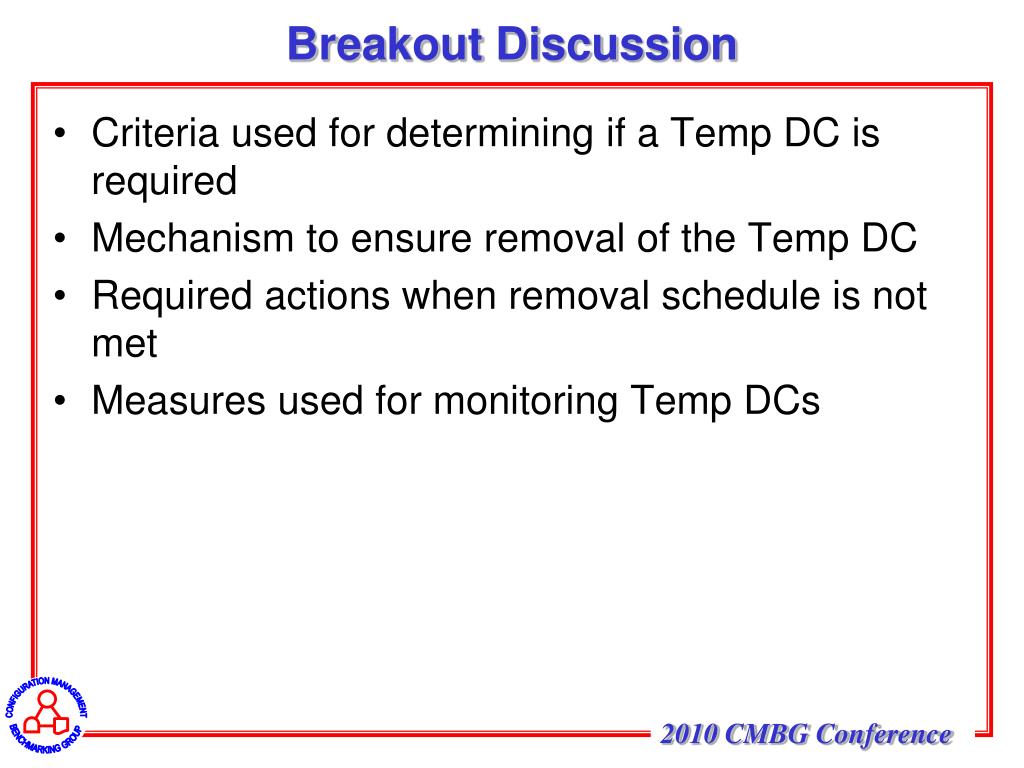

Breakout discussion

Breakout Discussion

  • Criteria used for determining if a Temp DC is required

  • Mechanism to ensure removal of the Temp DC

  • Required actions when removal schedule is not met

  • Measures used for monitoring Temp DCs
