JTEN Reduction Plan

Mr. Steve Kostoff

DD JS J7 JCW

Environment Development

15 February 2012


Abstract

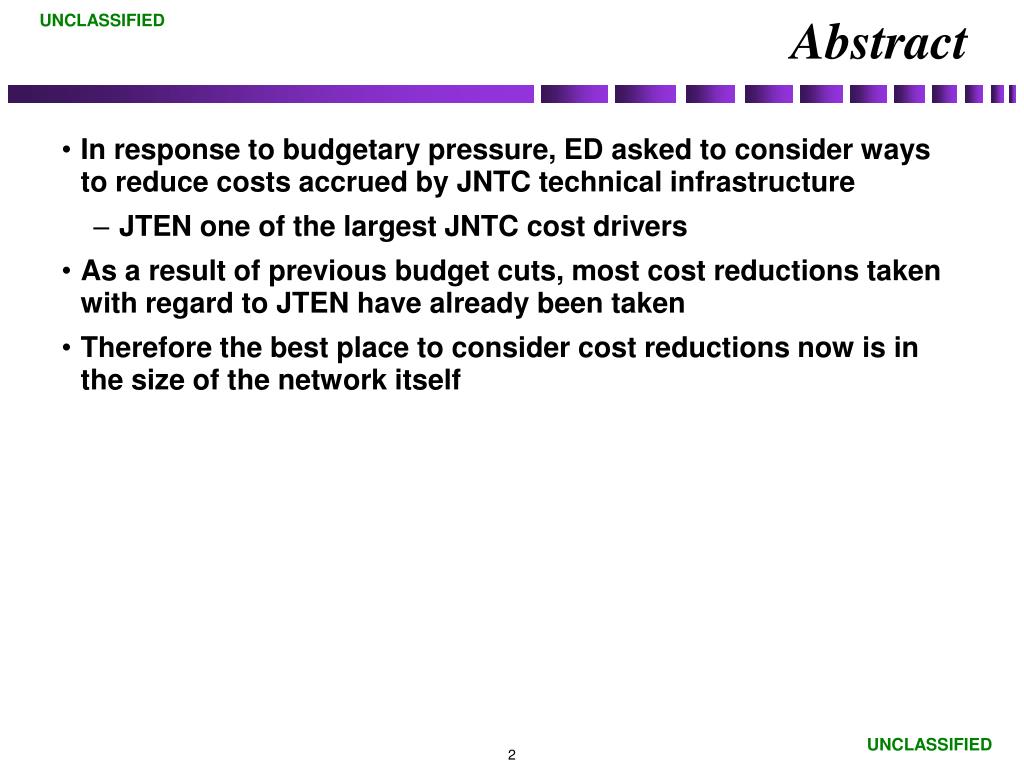

Abstract

  • In response to budgetary pressure, ED asked to consider ways to reduce costs accrued by JNTC technical infrastructure

    • JTEN one of the largest JNTC cost drivers

  • As a result of previous budget cuts, most cost reductions taken with regard to JTEN have already been taken

  • Therefore the best place to consider cost reductions now is in the size of the network itself


Method

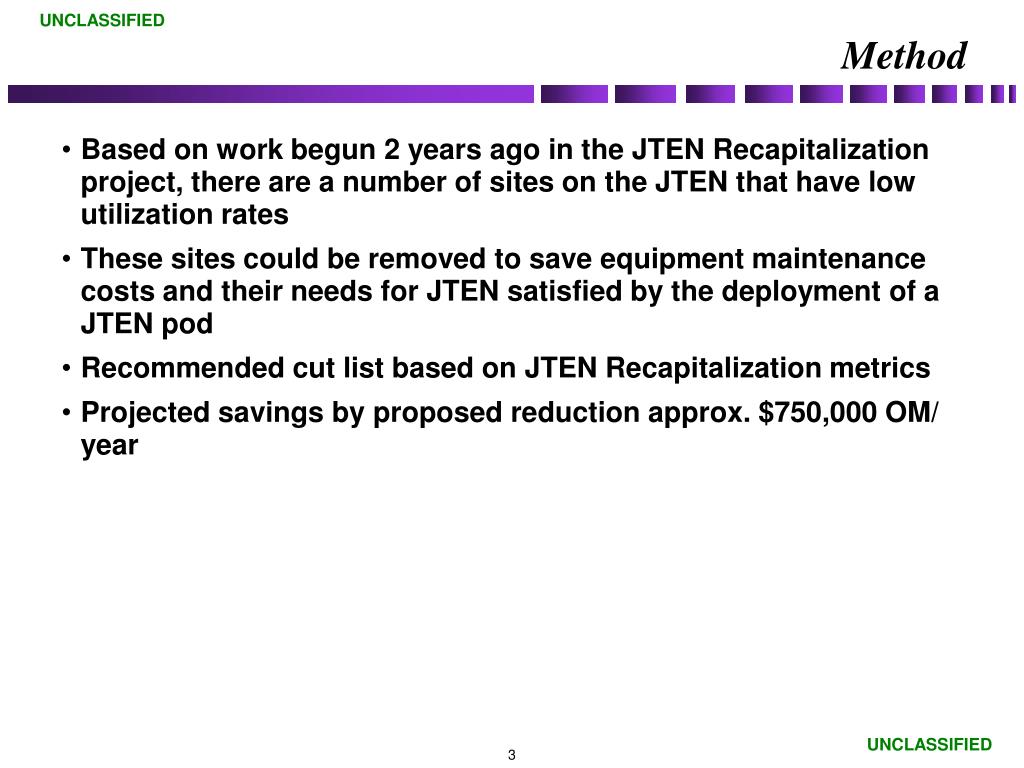

Method

Based on work begun 2 years ago in the JTEN Recapitalization project, there are a number of sites on the JTEN that have low utilization rates

These sites could be removed to save equipment maintenance costs and their needs for JTEN satisfied by the deployment of a JTEN pod

Recommended cut list based on JTEN Recapitalization metrics

Projected savings by proposed reduction approx. $750,000 OM/ year

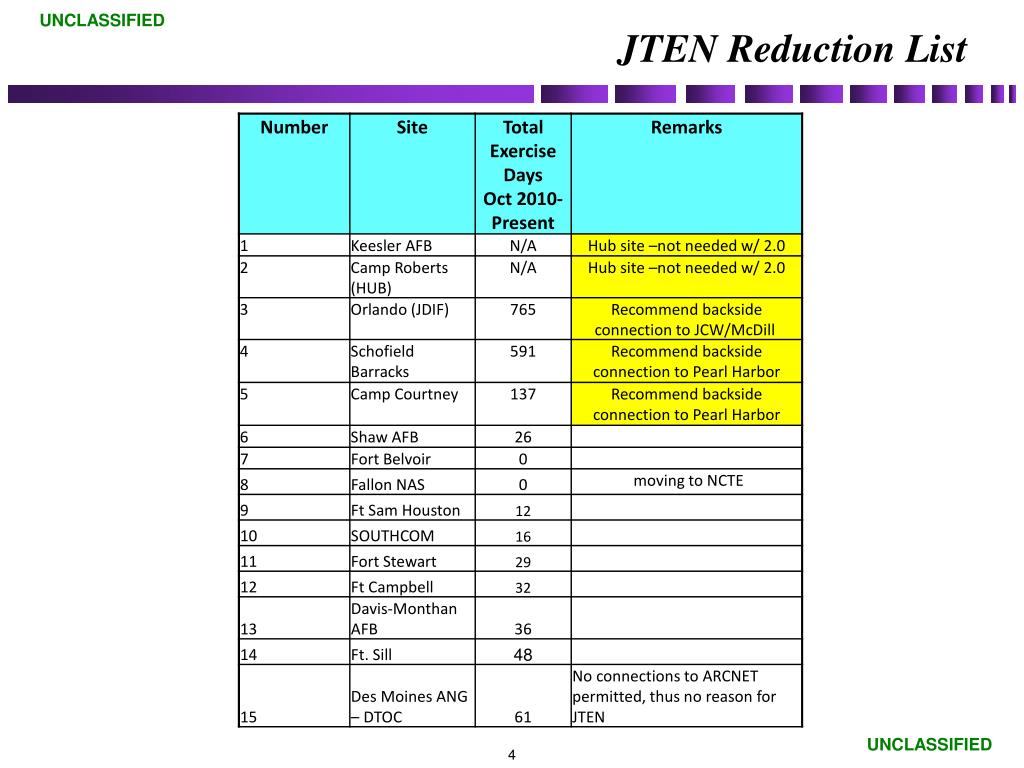

Jten reduction list

JTEN Reduction List


Jten reduction plan

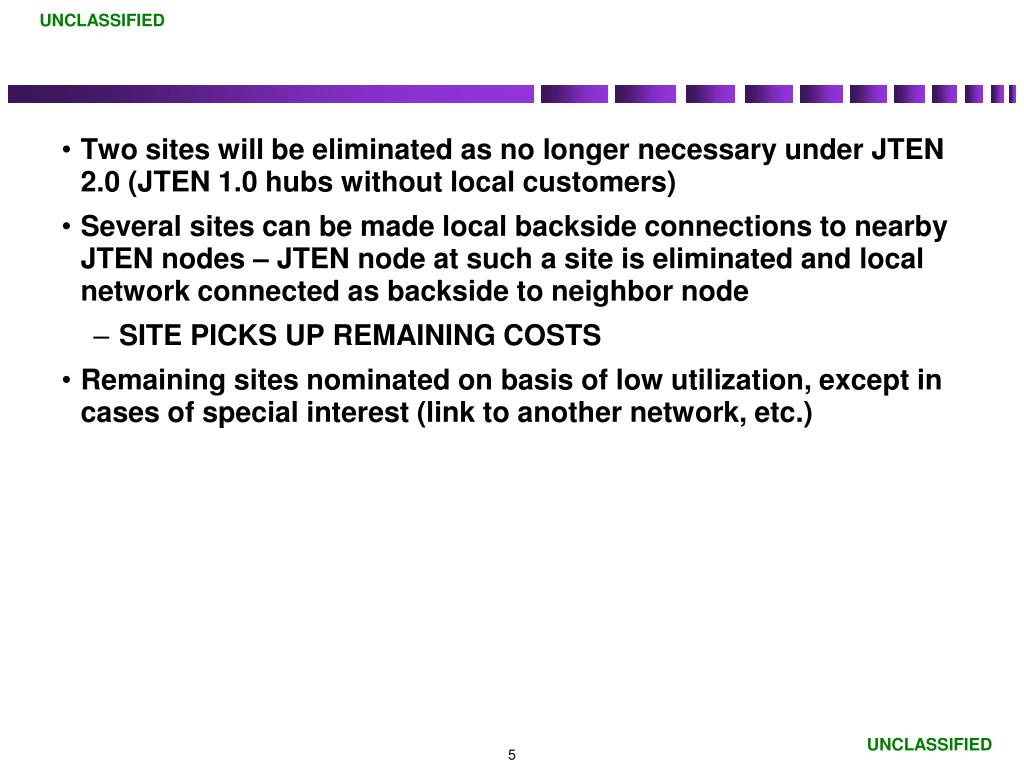

  • Two sites will be eliminated as no longer necessary under JTEN 2.0 (JTEN 1.0 hubs without local customers)

  • Several sites can be made local backside connections to nearby JTEN nodes – JTEN node at such a site is eliminated and local network connected as backside to neighbor node

    • SITE PICKS UP REMAINING COSTS

  • Remaining sites nominated on basis of low utilization, except in cases of special interest (link to another network, etc.)

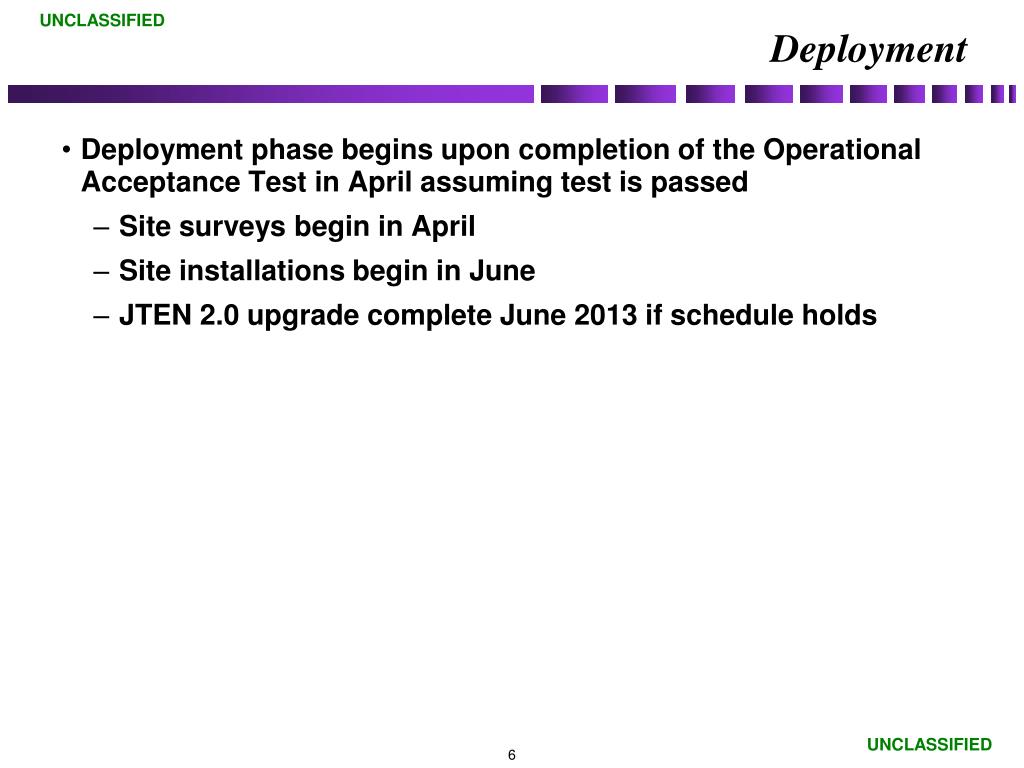

Deployment

Deployment

  • Deployment phase begins upon completion of the Operational Acceptance Test in April assuming test is passed

    • Site surveys begin in April

    • Site installations begin in June

    • JTEN 2.0 upgrade complete June 2013 if schedule holds


  • Login
