Electric Field Instrument (EFI) Schedule

Electric Field Instrument (EFI) Schedule. Schedule (1). Design (Definition and BB) Preamp Mechanical (Aug-Oct ’03; complete). Preamp Electrical (Aug-Oct ’03; complete). BEB (Jul-Oct ’03; complete). BMD (Sep ’03; complete). SPB (Aug ’03 – Jan ’04; 50%). AXB (Jun ’03 – Dec ’03; 50%).

bary
Download Presentation

Electric Field Instrument (EFI) Schedule

An Image/Link below is provided (as is) to download presentation Download Policy: Content on the Website is provided to you AS IS for your information and personal use and may not be sold / licensed / shared on other websites without getting consent from its author. Content is provided to you AS IS for your information and personal use only. Download presentation by click this link. While downloading, if for some reason you are not able to download a presentation, the publisher may have deleted the file from their server. During download, if you can't get a presentation, the file might be deleted by the publisher.

E N D

Presentation Transcript


  1. Electric Field Instrument (EFI) • Schedule

  2. Schedule (1) • Design (Definition and BB) • Preamp Mechanical (Aug-Oct ’03; complete). • Preamp Electrical (Aug-Oct ’03; complete). • BEB (Jul-Oct ’03; complete). • BMD (Sep ’03; complete). • SPB (Aug ’03 – Jan ’04; 50%). • AXB (Jun ’03 – Dec ’03; 50%). • Long-Lead Parts: • AXB stacers (ordered Sep ’03; 12-wk lead time) • SPB wire cable (RFQ issued Oct ’03; 6-wk lead time) • SPB motors (RFQ issued Oct ’03; 13-wk lead time)

  3. Schedule (2) • EM/ETU • SPB • Mach, Nov-Dec ’03; Assy, Dec ’03 – Jan ’04; Test, Feb ’04. • AXB • Mach, Dec ’03 – Jan ’04; Assy, Feb ’04; Test, Feb ’04. • Preamp (Mechanical and Electrical) • Layout/Fab/Assy, Oct ’03 (now!); Test, Nov ’03. • BEB • Layout/Fab, Oct-Nov ’03; Build, Nov ’03; Test, Dec ’03. • BMD • Layout/Fab, Nov ’03; Build, ’03; Test, ’03.

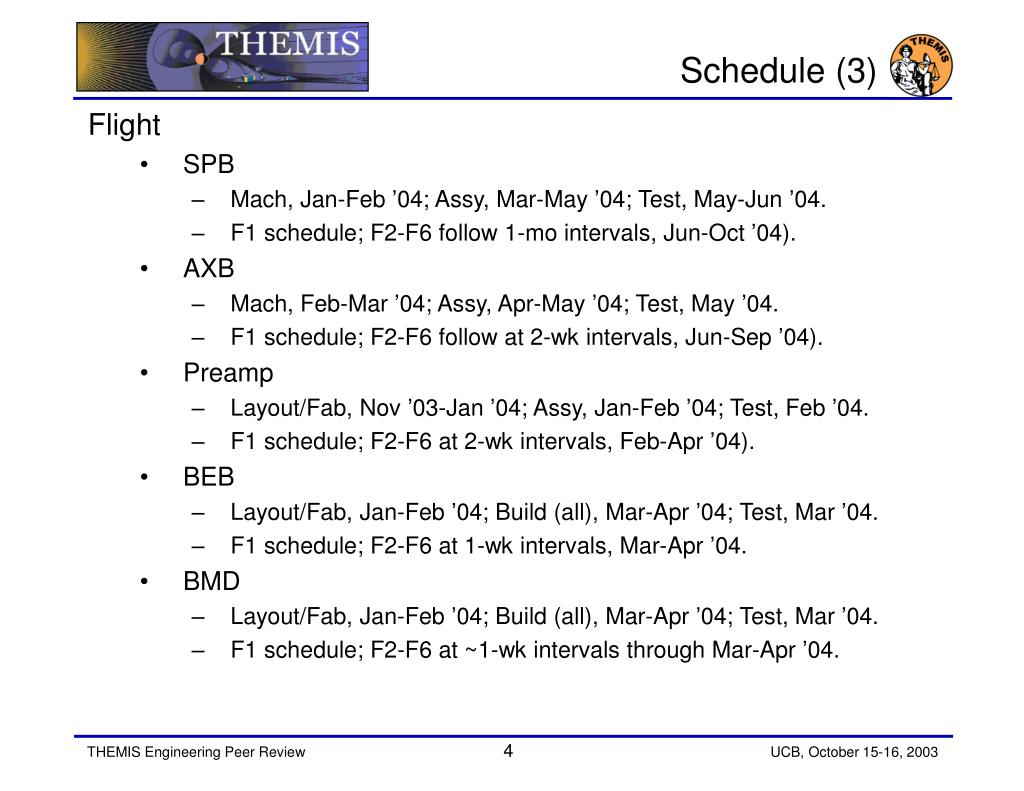

  4. Schedule (3) • Flight • SPB • Mach, Jan-Feb ’04; Assy, Mar-May ’04; Test, May-Jun ’04. • F1 schedule; F2-F6 follow 1-mo intervals, Jun-Oct ’04). • AXB • Mach, Feb-Mar ’04; Assy, Apr-May ’04; Test, May ’04. • F1 schedule; F2-F6 follow at 2-wk intervals, Jun-Sep ’04). • Preamp • Layout/Fab, Nov ’03-Jan ’04; Assy, Jan-Feb ’04; Test, Feb ’04. • F1 schedule; F2-F6 at 2-wk intervals, Feb-Apr ’04). • BEB • Layout/Fab, Jan-Feb ’04; Build (all), Mar-Apr ’04; Test, Mar ’04. • F1 schedule; F2-F6 at 1-wk intervals, Mar-Apr ’04. • BMD • Layout/Fab, Jan-Feb ’04; Build (all), Mar-Apr ’04; Test, Mar ’04. • F1 schedule; F2-F6 at ~1-wk intervals through Mar-Apr ’04.
