  3. Space Reallocation and the Faculty of Arts Responding to the Acquisition of 3465 Durocher

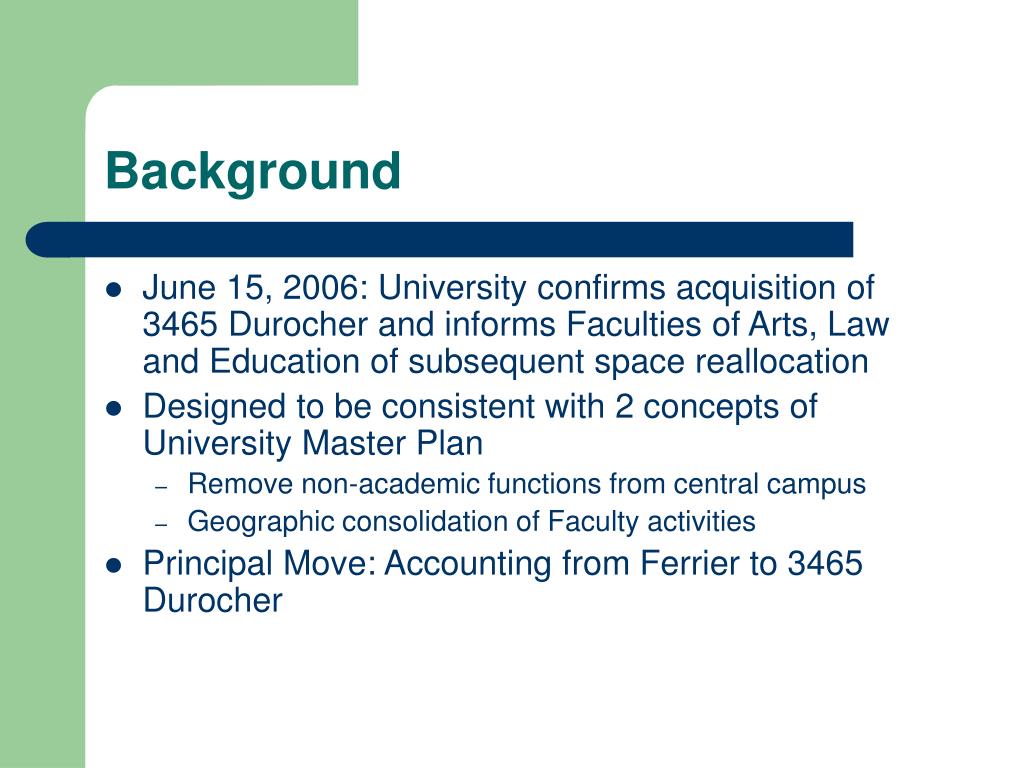

  4. Background • June 15, 2006: University confirms acquisition of 3465 Durocher and informs Faculties of Arts, Law and Education of subsequent space reallocation • Designed to be consistent with 2 concepts of University Master Plan • Remove non-academic functions from central campus • Geographic consolidation of Faculty activities • Principal Move: Accounting from Ferrier to 3465 Durocher

  5. Forgotten Proposals! New Arts Building Renovate Powell Student Services Building Move Anthropology to Peterson Hall Move any department to Peterson Hall Add a new floor to the Redpath Library Building Add two floors to the Redpath Library Building Appoint a new Director of Libraries who does not want any floors added that do not involve only the libraries and last but not least…..

  6. Last but not least…. • Demolish the Leacock Building

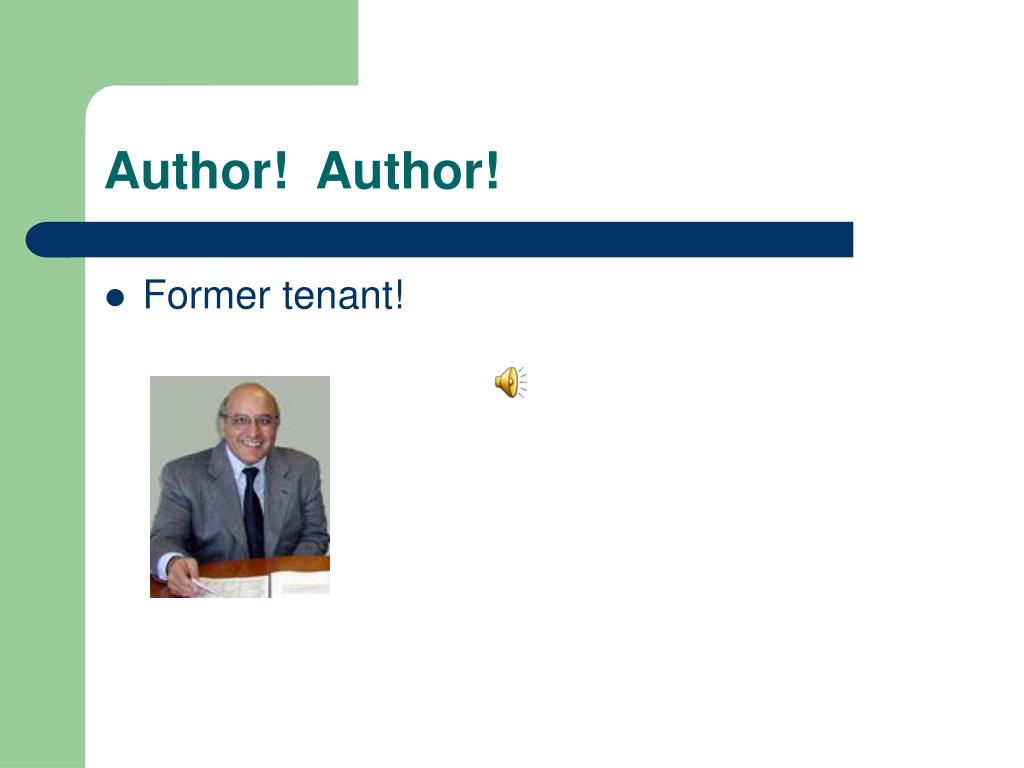

  7. Author! Author! • Former tenant!

  8. Summary of Space Changes to Faculties

  9. Challenges and Opportunities • Immediate Challenge • Relocate current and planned activities from NCDH and 3715 Peel • Determine best use of Ferrier space • Opportunity • Think comprehensively about use of space • Leverage reallocation budgetary envelope to Faculty’s advantage • Principles • Avoid multiple moves • Group units in an intellectually coherent manner

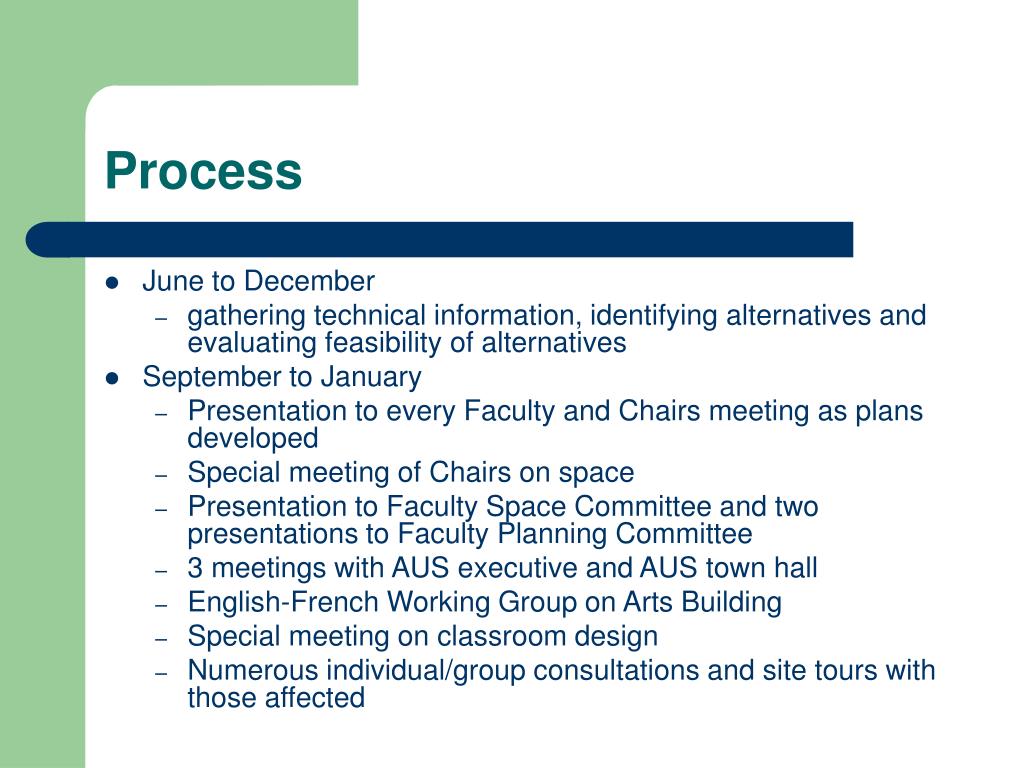

  10. Process • June to December • gathering technical information, identifying alternatives and evaluating feasibility of alternatives • September to January • Presentation to every Faculty and Chairs meeting as plans developed • Special meeting of Chairs on space • Presentation to Faculty Space Committee and two presentations to Faculty Planning Committee • 3 meetings with AUS executive and AUS town hall • English-French Working Group on Arts Building • Special meeting on classroom design • Numerous individual/group consultations and site tours with those affected

  11. Summary of Major Moves • To Peterson • CDAS, IDP Advising, IOWC, STANDD, Indigenous Rights, CIREQ • [Archeology Lab, Technology & Citizenship, Experimental Econ lab, Social Stats lab, QICSS lab] • To Arts • French Department from Peterson • Conversion of classrooms and VRC to offices and common space • To Ferrier 3 • Arts Computer Labs from Leacock • History offices from Leacock and associated projects from NCDH • To Ferrier 2 • Arts Computer Techs from Leacock • AHCS: Associated research projects and VRC from Arts • To Leacock 1 • Classroom capacity from Arts and multi-use student rooms

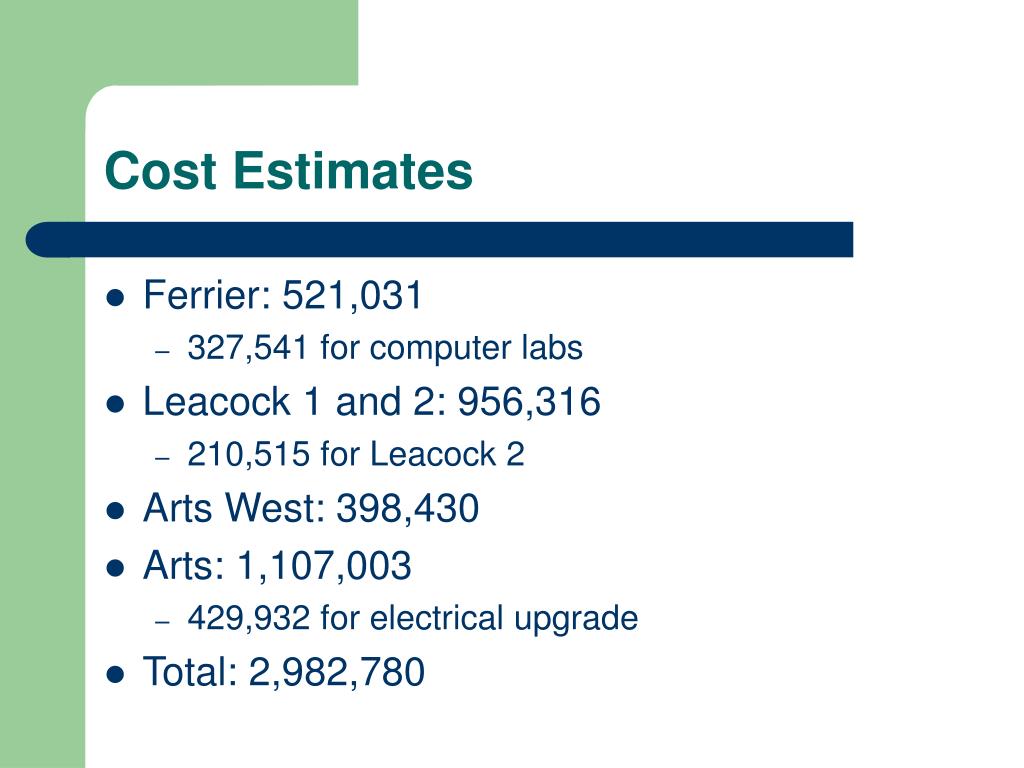

  12. Cost Estimates • Ferrier: 521,031 • 327,541 for computer labs • Leacock 1 and 2: 956,316 • 210,515 for Leacock 2 • Arts West: 398,430 • Arts: 1,107,003 • 429,932 for electrical upgrade • Total: 2,982,780

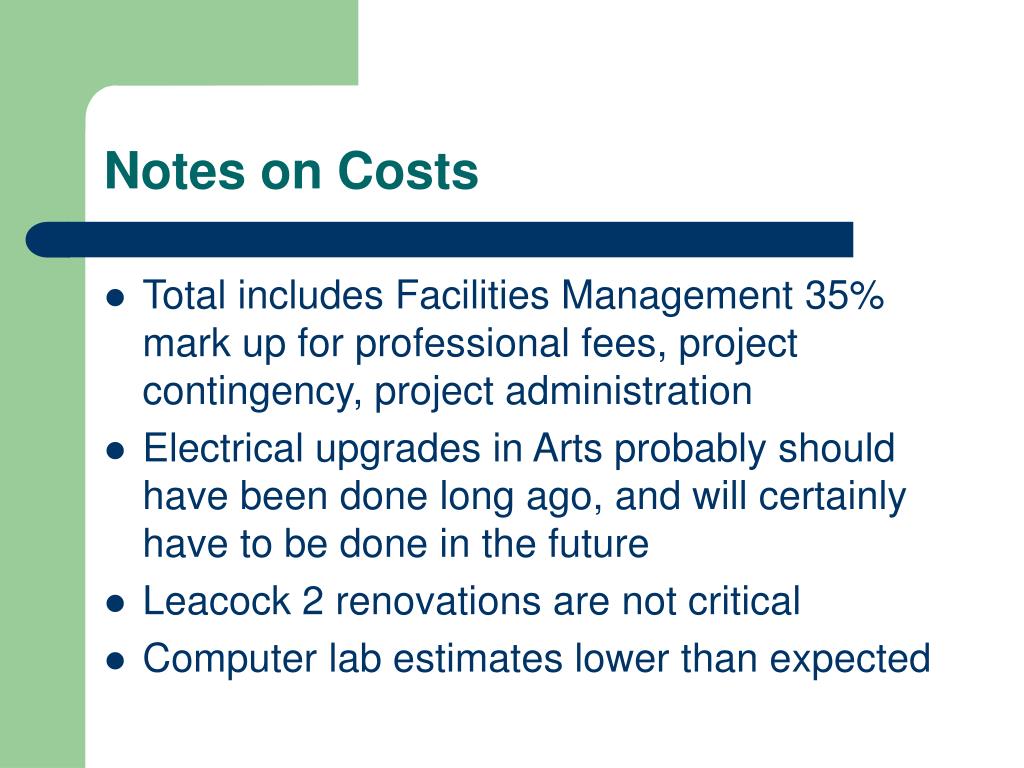

  13. Notes on Costs • Total includes Facilities Management 35% mark up for professional fees, project contingency, project administration • Electrical upgrades in Arts probably should have been done long ago, and will certainly have to be done in the future • Leacock 2 renovations are not critical • Computer lab estimates lower than expected

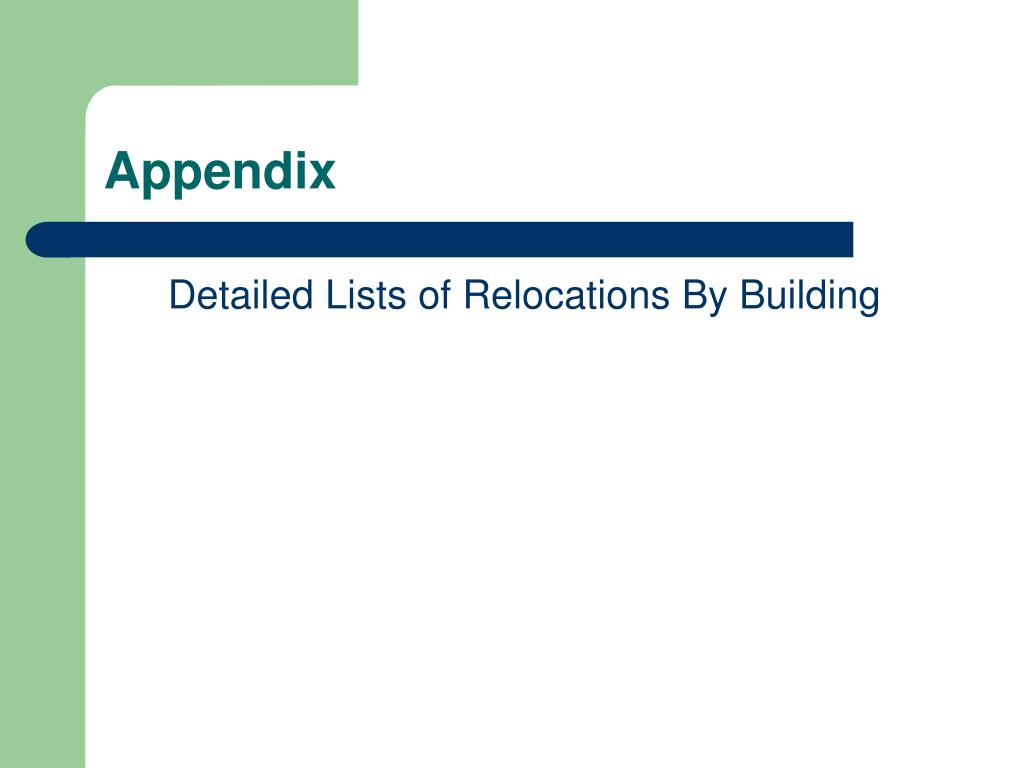

  14. Appendix Detailed Lists of Relocations By Building

  15. Relocation of 3715 Peel

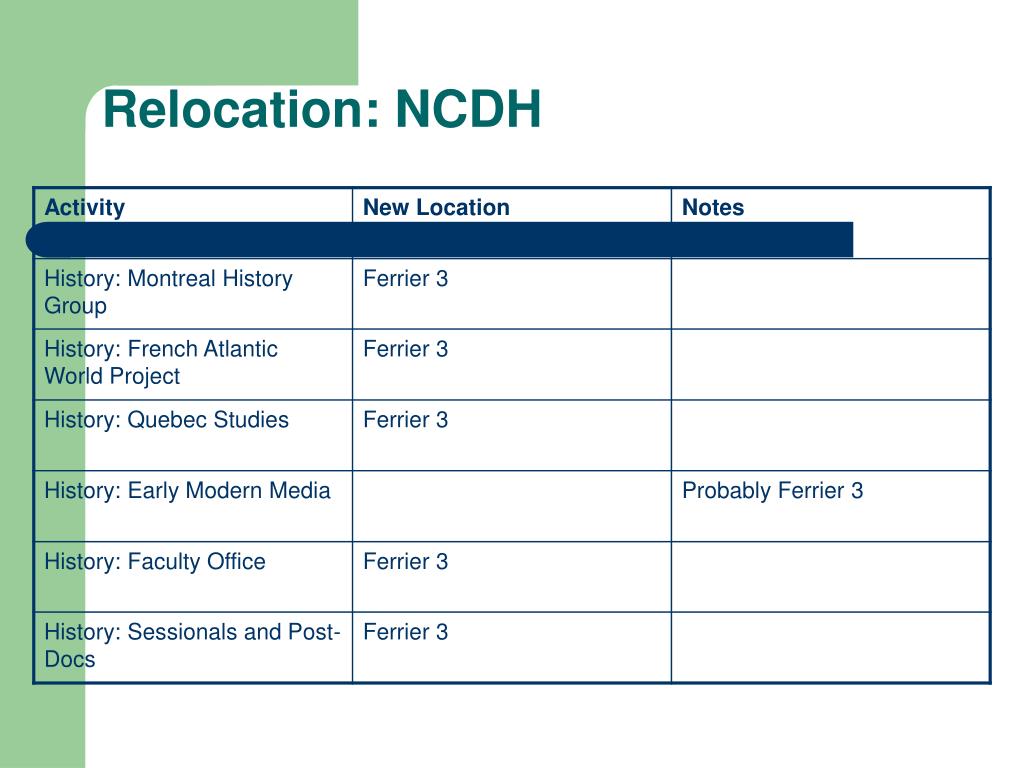

  16. Relocation: NCDH

  17. Relocation: NCDH(Continued)

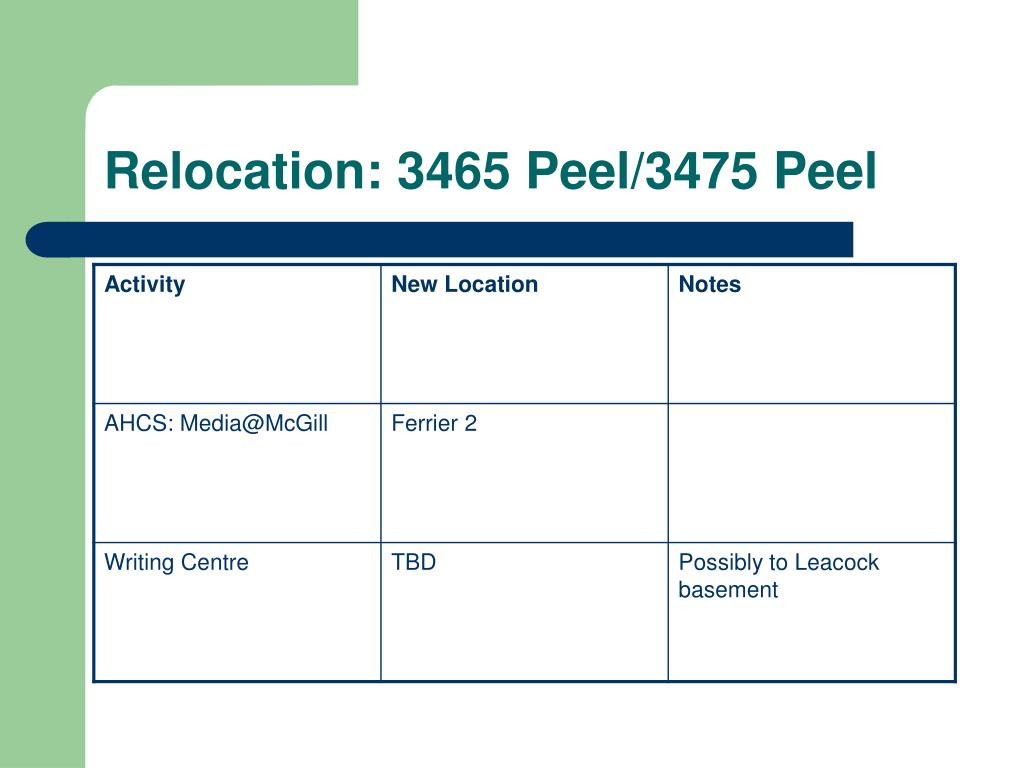

  18. Relocation: 3465 Peel/3475 Peel

  19. Relocation: Peterson

  20. Relocation: Leacock

  21. Relocation: Arts/Dawson

  22. What are the benefits? Departments? • Some badly needed changes to air ventilation in Arts • Relocate one of the most prestigious departments from Peterson to the mainstream Arts corridor (French) • English and French departments to share the main Arts Building • Academic and research interests combined in Peterson • Acquisition of space in Ferrier • In 2008 Arts to obtain first three floors of James

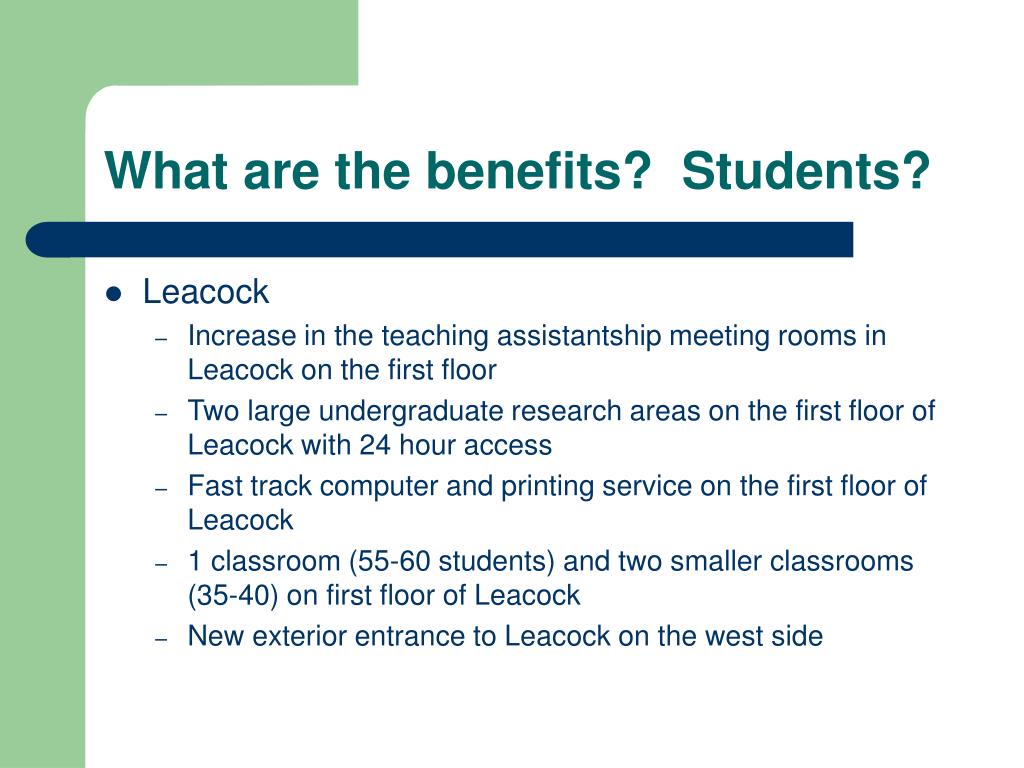

  23. What are the benefits? Students? • Leacock • Increase in the teaching assistantship meeting rooms in Leacock on the first floor • Two large undergraduate research areas on the first floor of Leacock with 24 hour access • Fast track computer and printing service on the first floor of Leacock • 1 classroom (55-60 students) and two smaller classrooms (35-40) on first floor of Leacock • New exterior entrance to Leacock on the west side

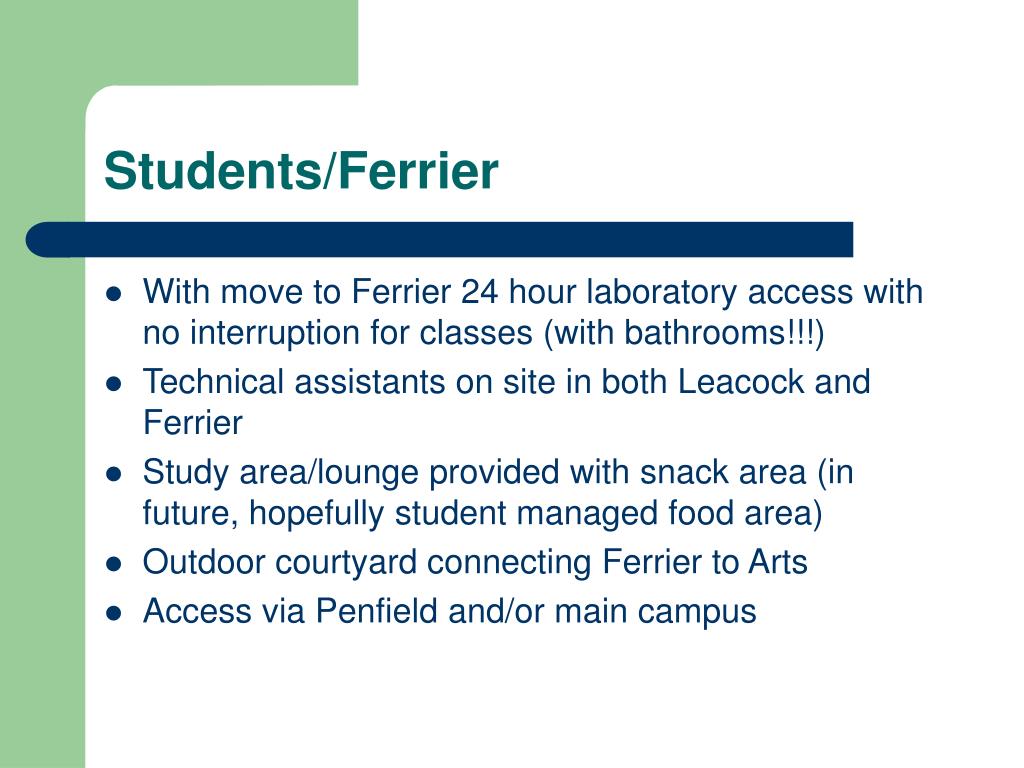

  24. Students/Ferrier • With move to Ferrier 24 hour laboratory access with no interruption for classes (with bathrooms!!!) • Technical assistants on site in both Leacock and Ferrier • Study area/lounge provided with snack area (in future, hopefully student managed food area) • Outdoor courtyard connecting Ferrier to Arts • Access via Penfield and/or main campus

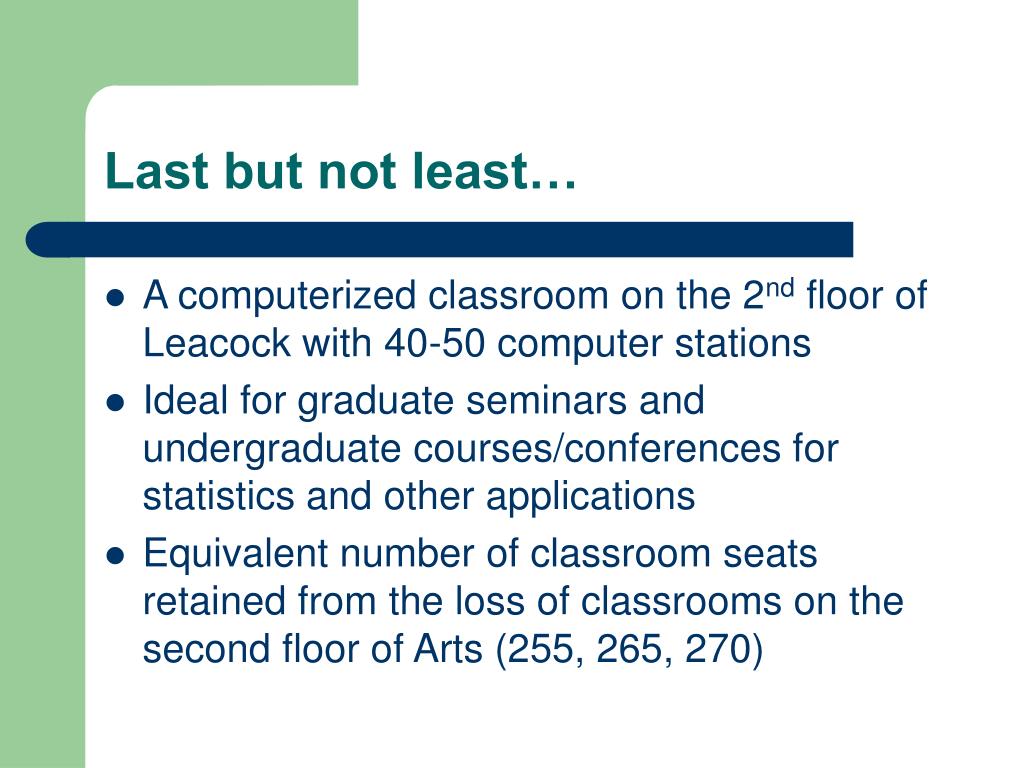

  25. Last but not least… • A computerized classroom on the 2nd floor of Leacock with 40-50 computer stations • Ideal for graduate seminars and undergraduate courses/conferences for statistics and other applications • Equivalent number of classroom seats retained from the loss of classrooms on the second floor of Arts (255, 265, 270)

  26. How does this affect me? • Noise during most of the summer in the Arts Building (1st and 2nd floor) and on the ground floor of Leacock • Possible move of some departments out of current space during this period

  27. Phase 1: April – May 2007 • Renovation of Ferrier (April-May) • Start of renovation to the Arts Building (air ventilation and office construction) • Proposed move of laboratories: June 1st or thereabouts • Possible relocation of affected departments

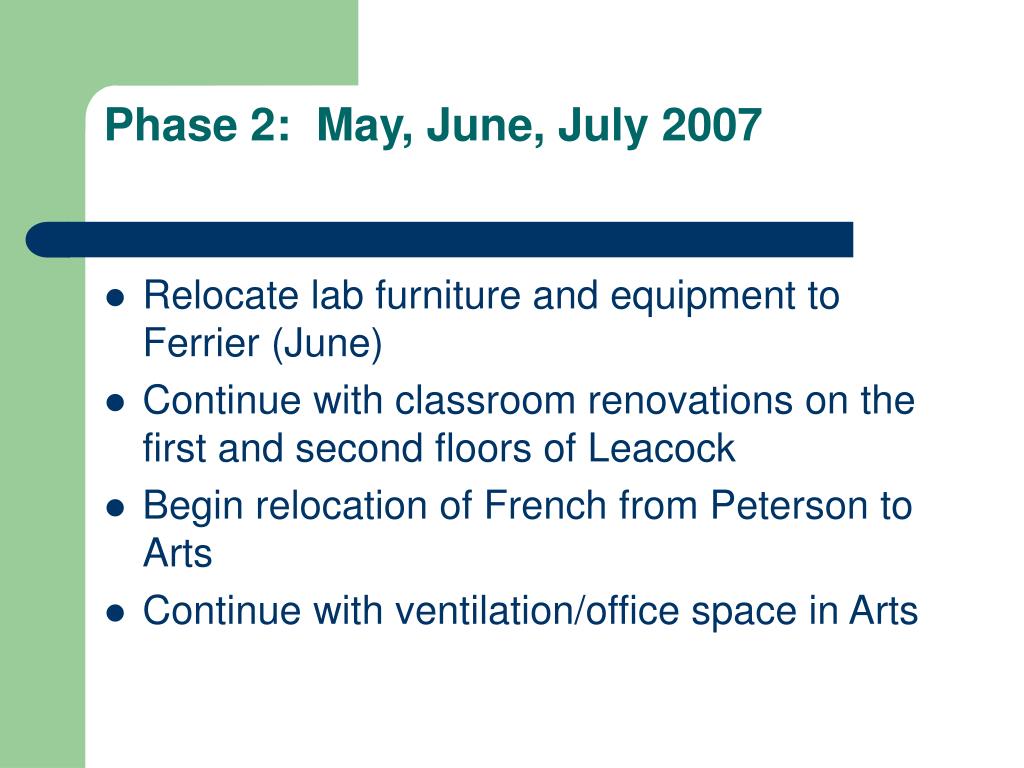

  28. Phase 2: May, June, July 2007 • Relocate lab furniture and equipment to Ferrier (June) • Continue with classroom renovations on the first and second floors of Leacock • Begin relocation of French from Peterson to Arts • Continue with ventilation/office space in Arts

  29. Phase 3 – July, August • Have classrooms in Leacock operational by first week in August • Move French Department to Arts • Move affected departments back to their original space

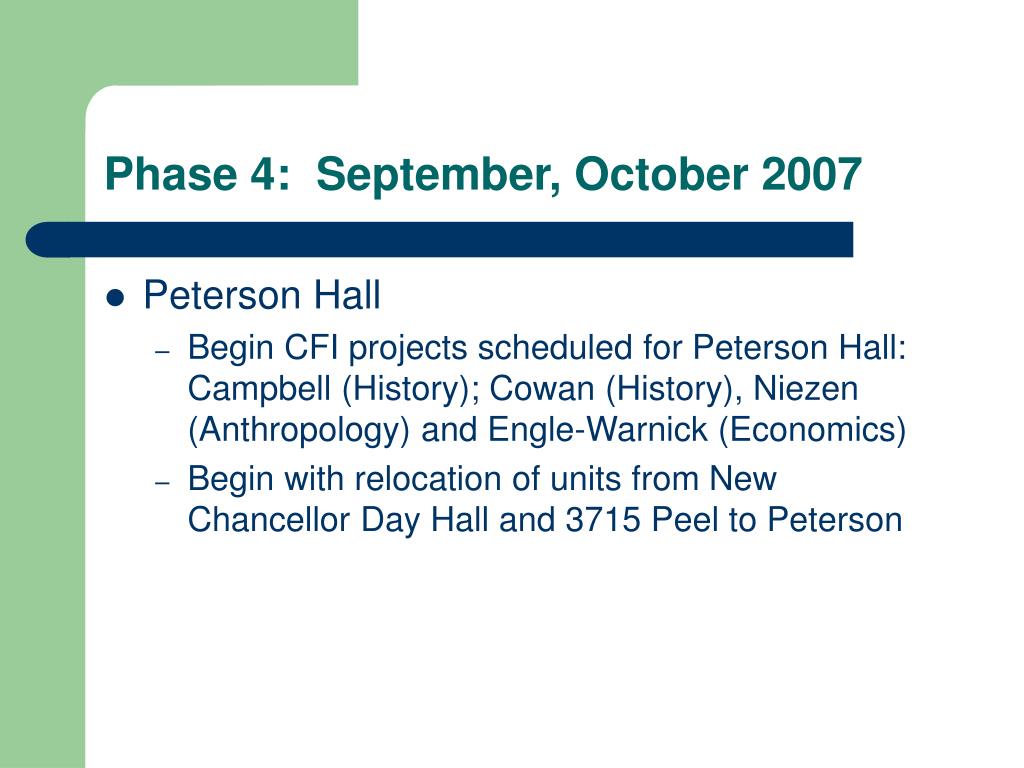

  30. Phase 4: September, October 2007 • Peterson Hall • Begin CFI projects scheduled for Peterson Hall: Campbell (History); Cowan (History), Niezen (Anthropology) and Engle-Warnick (Economics) • Begin with relocation of units from New Chancellor Day Hall and 3715 Peel to Peterson

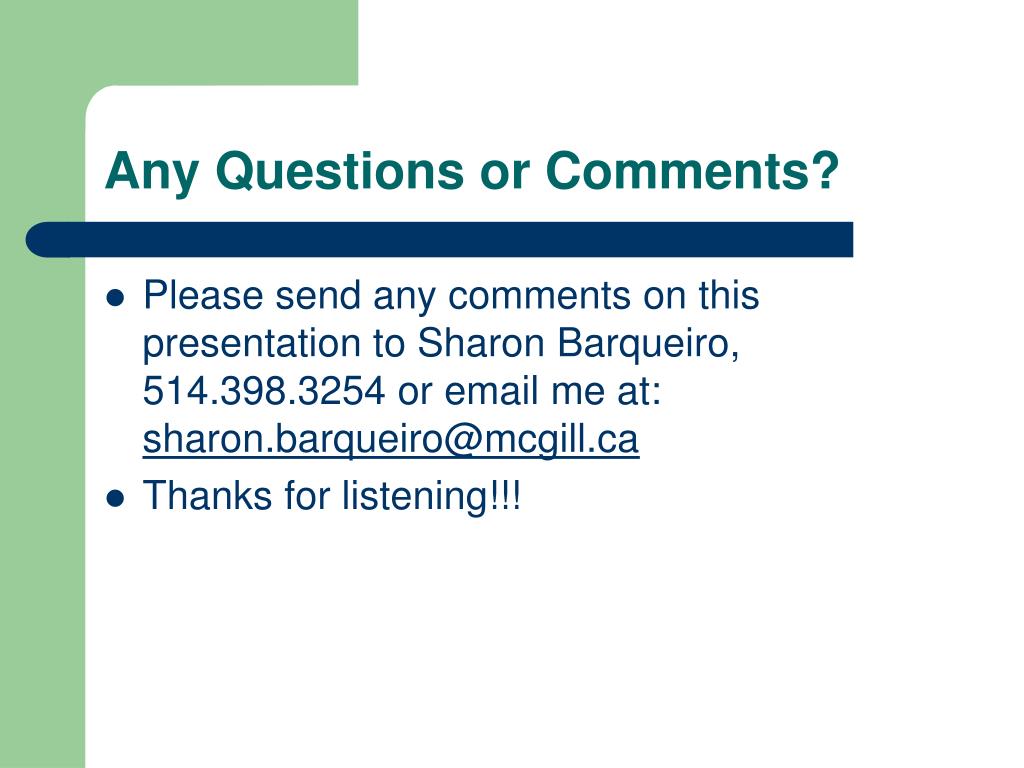

  31. Any Questions or Comments? • Please send any comments on this presentation to Sharon Barqueiro, 514.398.3254 or email me at: sharon.barqueiro@mcgill.ca • Thanks for listening!!!
