1 / 11

Progress of, and prospects for, commercial applications of UHV 1100kV Transmission System in TEPCO

2 nd International Symposium on International Standards for Ultra High Voltage, New Delhi, January 29-30, 2009. Progress of, and prospects for, commercial applications of UHV 1100kV Transmission System in TEPCO. Hiroshi OKAMOTO TEPCO. UHV Transmission Lines in TEPCO.

avari
Download Presentation

Progress of, and prospects for, commercial applications of UHV 1100kV Transmission System in TEPCO

An Image/Link below is provided (as is) to download presentation Download Policy: Content on the Website is provided to you AS IS for your information and personal use and may not be sold / licensed / shared on other websites without getting consent from its author. Content is provided to you AS IS for your information and personal use only. Download presentation by click this link. While downloading, if for some reason you are not able to download a presentation, the publisher may have deleted the file from their server. During download, if you can't get a presentation, the file might be deleted by the publisher.

E N D

Presentation Transcript


  1. 2nd International Symposium on International Standards for Ultra High Voltage, New Delhi, January 29-30, 2009 Progress of, and prospects for, commercial applications of UHV 1100kV Transmission System in TEPCO Hiroshi OKAMOTO TEPCO

  2. UHV Transmission Lines in TEPCO 〈North-South Route〉 [1993] Minami-Nigata Line: 49km×2cct (Total Length: 111km) Nishi-Gunma Line: 138km×2cct 〈East-West Route〉 [1999] Minami-Iwaki Line: 194km×2cct Higashi-Gunma Line: 44km×2cct

  3. High Speed Grounding Switch(HSGS) MOSA, CB with resistor UHV System Design Solution for network problem peculiar to UHV system • Secondary arc extinction for fast reclosing, etc. Insulation design • Rationalization of insulation coordination Transmission line design • Size reduction of UHV transmission tower • Electric and Magnetic field, corona noise, wind noise Substation design • Size reduction of substation equipment • Development of highly reliable equipment

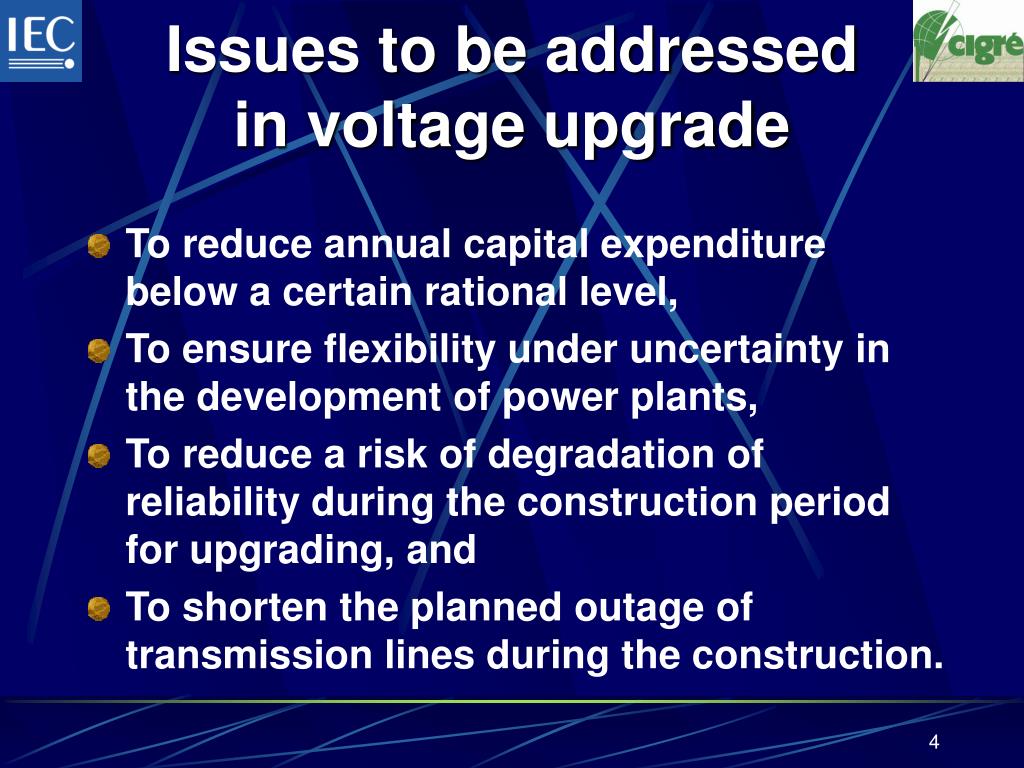

  4. Issues to be addressedin voltage upgrade • To reduce annual capital expenditure below a certain rational level, • To ensure flexibility under uncertainty in the development of power plants, • To reduce a risk of degradation of reliability during the construction period for upgrading, and • To shorten the planned outage of transmission lines during the construction.

  5. Schematic diagram of UHV designed transmission lines

  6. Option 1 Only single circuit will be operated at 1100kV and the other circuit at 550kV in the very first stage of the upgrading.

  7. Studied Issues • switching overvoltage induced in 1100kV and 550kV circuits, • lightning overvoltage in the substations, • short circuit phenomena between 1100kV and 550kV circuits, • necessity of HSGS in the 550kV circuit to extinguish secondary arc current after the fault in the circuit, • operation and maintenance considering outage of equipment, • protection, • TRV and • voltage deviation due to energization and de-energization

  8. Option 2 Simplified bus configuration may be applied as a cost-effective solution for line U1-U5 only if the subsequent upgrade is not expected over the long term.

  9. Switching Overvoltage Analysis U1 U1 U5 U5 double-bus-bar four-bus-tie configuration simplified bus configuration

  10. Option 3 Double T connection at U2 S/S, instead of double p connection, can reduce the installation cost.

  11. Concluding Remarks • TEPCO is now studying the issues for upgrading the operating voltage of the constructed UHV transmission lines from 550kV to 1100kV. • We will finalize technical specification of substation equipment shortly so as to be able to respond quickly and flexibly to future generation developments. • In this context, standardization of the UHV technology is urgently needed.
