WBS 1.7: AFE II Project Cost and Schedule

WBS 1.7: AFE II Project Cost and Schedule. Alan Bross DZero Run IIb AFE II Director’s Review April 13, 2005. AFE II - Cost and Schedule. Full Project Plan Has been updated since the last review. AFE II – Cost and Schedule. Cost M&S:

abra-weber
Download Presentation

WBS 1.7: AFE II Project Cost and Schedule

An Image/Link below is provided (as is) to download presentation Download Policy: Content on the Website is provided to you AS IS for your information and personal use and may not be sold / licensed / shared on other websites without getting consent from its author. Content is provided to you AS IS for your information and personal use only. Download presentation by click this link. While downloading, if for some reason you are not able to download a presentation, the publisher may have deleted the file from their server. During download, if you can't get a presentation, the file might be deleted by the publisher.

E N D

Presentation Transcript


  1. WBS 1.7:AFE II Project Cost and Schedule Alan BrossDZero Run IIb AFE II Director’s ReviewApril 13, 2005

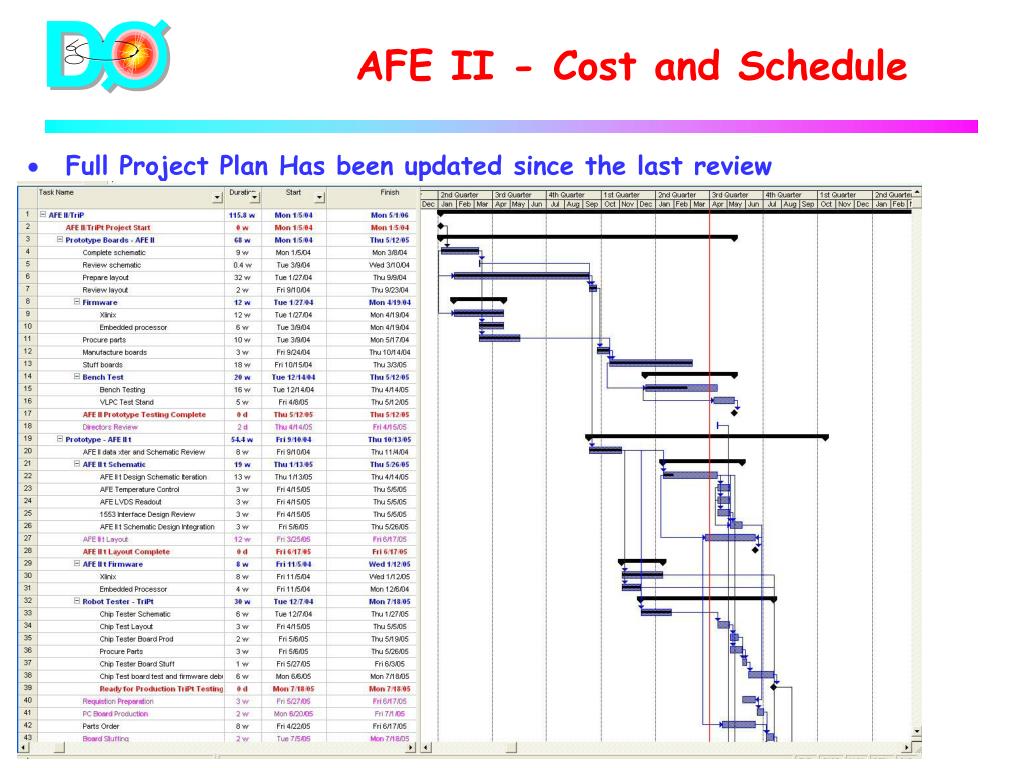

  2. AFE II - Cost and Schedule • Full Project Plan Has been updated since the last review

  3. AFE II – Cost and Schedule • Cost M&S: • Production cost M&S are based on quotes for parts and labor – contingency estimate is grounds up: • Manpower • Estimates from AFE experience (from AFE I and AFE II R&D) • Total Project cost approximately $1.8M • Schedule critical path is AFE IIt prototype board testing • Planning for adiabatic Installation • AFE I and AFEII mixed running • Will need to test compatibility once AFE II prototypes are ready • Installation will be done 16 boards at a time • Credibility of installation plan is dependent on AFE IIt prototype tests • How quickly they come up • Platform test and integration with trigger • Software readiness • Physical Installation can occur quickly

  4. AFE II Milestones • TriPt production submission 5/05 • AFE IIt Prototype testing 7/05 • AFE IIt Platform test 9&12/05 • AFE IIt Pre-production 10/05 • AFE IIt production complete 3/06 • Full Board complement Ready for installation 4/06

  5. AFE II Schedule • Credibility/Underlying Philosophy • AFE IIt boards will not have the “uniqueness” problem of AFE I • All AFE II boards behave identically • Prototype testing to date supports this contention • Recent data shows AFE II Proto behaves the same on bench and on the VLPC Test Cryostat (as close as we can get to the platform for now) • TriPt testing to date supports this contention • Calibration of boards occurs once during board test and the obtained calibration constants are valid under all operating conditions of the board and are stable with time • Time calibration • Cryo and Bias control calibrations • The above assumptions make the testing and installation schedules credible • Will be Validated with a rather large number (»20 + 10 : AFE II / AFE IIt) of prototypes

  6. Issues - Schedule • Bringing up the AFE II prototypes has been harder than expected (Paul has covered this). • But excellent progress has been made and this is nearing completion • STILL - No underlying technical problems have been discovered • FPGA code verified • No uniqueness issues uncovered • No major assembly issues uncovered • Resistor packs on VLPC input need to be changed to discrete components • An additional engineer (Stefano Rapisarda) is now on board for the AFE IIt design • His input has been used to update schedule • More up-front time devoted to schematic review and design • Layout delayed until the above is well along • This re-evaluation has introduced an approximately 1 month delay from previous schedule, but we believe that this approach will yield a final board that can meet our test schedule

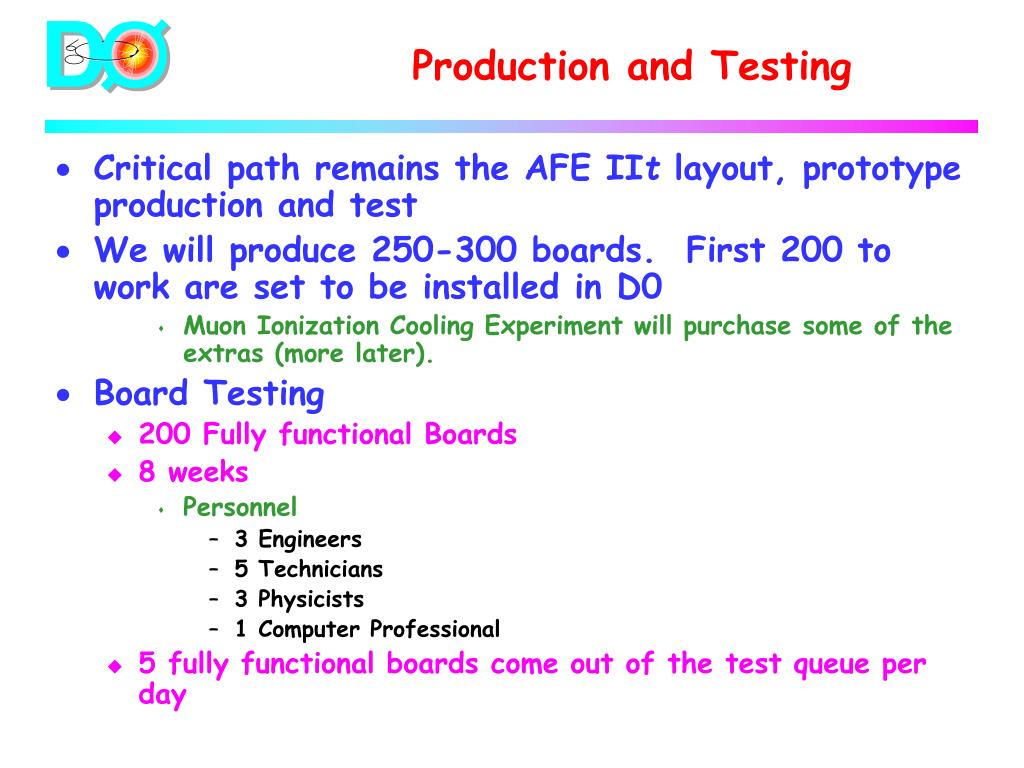

  7. Production and Testing • Critical path remains the AFE IIt layout, prototype production and test • We will produce 250-300 boards. First 200 to work are set to be installed in D0 • Muon Ionization Cooling Experiment will purchase some of the extras (more later). • Board Testing • 200 Fully functional Boards • 8 weeks • Personnel • 3 Engineers • 5 Technicians • 3 Physicists • 1 Computer Professional • 5 fully functional boards come out of the test queue per day

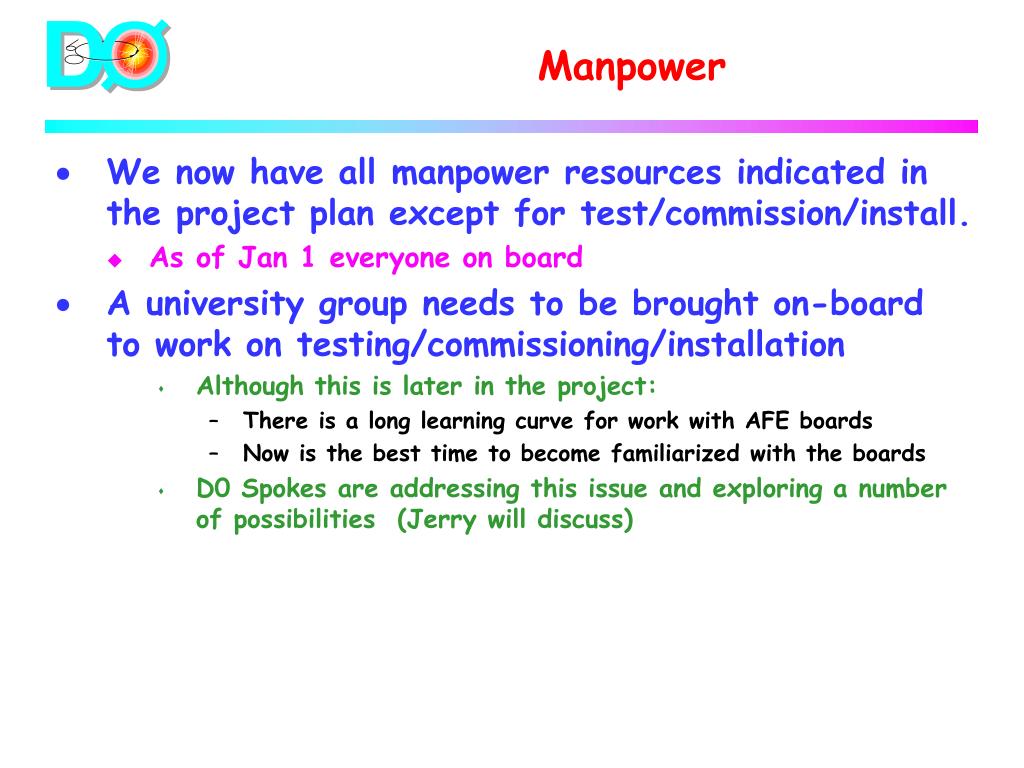

  8. Manpower • We now have all manpower resources indicated in the project plan except for test/commission/install. • As of Jan 1 everyone on board • A university group needs to be brought on-board to work on testing/commissioning/installation • Although this is later in the project: • There is a long learning curve for work with AFE boards • Now is the best time to become familiarized with the boards • D0 Spokes are addressing this issue and exploring a number of possibilities (Jerry will discuss)

  9. Manpower • We have put explicit resources (i.e., names) in for almost all tasks • Tasks have costed manpower resources and a name is now associated with EVERY entry for almost all tasks in the project • Fermilab personnel • University group for Test, Installation, and Commisssioning (ND) • Over-allocation is obvious if one looks at resource graph by name • Effort is now pretty-well leveled • In order to maintain the schedule • Must keep each individual’s peak effort 1-1.5 • Allocation plots that follow are peak effort in the period (Q), so being over 1 is OK so long as it is not constant

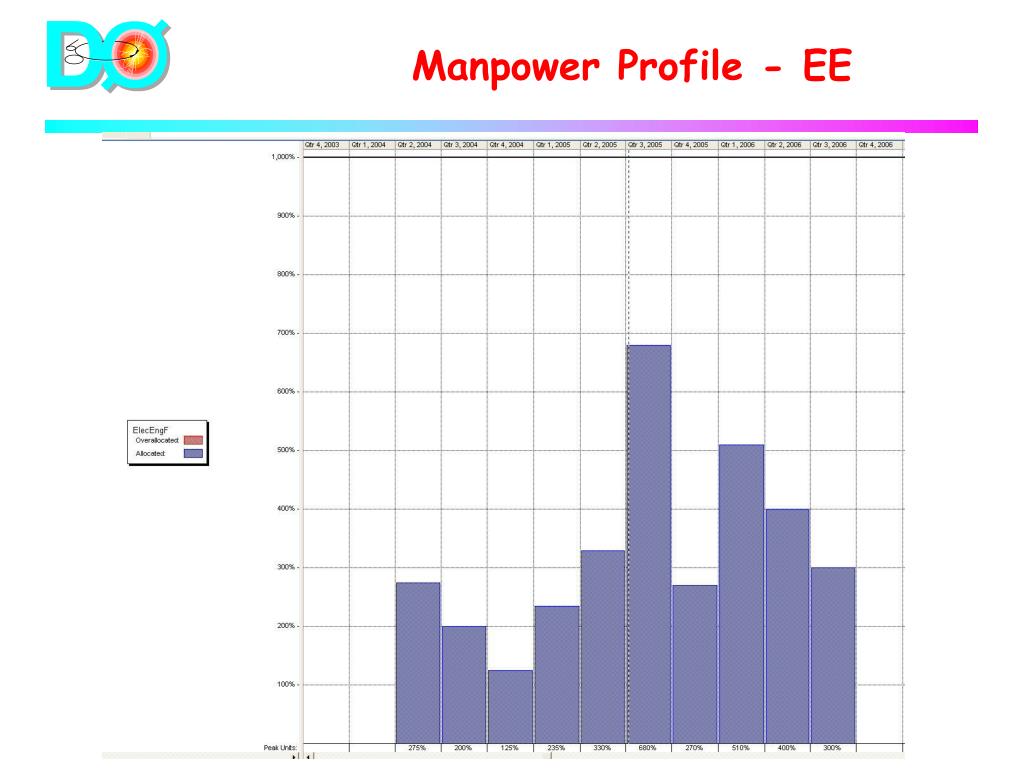

  10. Manpower Profile - EE

  11. Manpower Profile - ET

  12. Manpower Profile - PHF

  13. Manpower – Effort Allocation

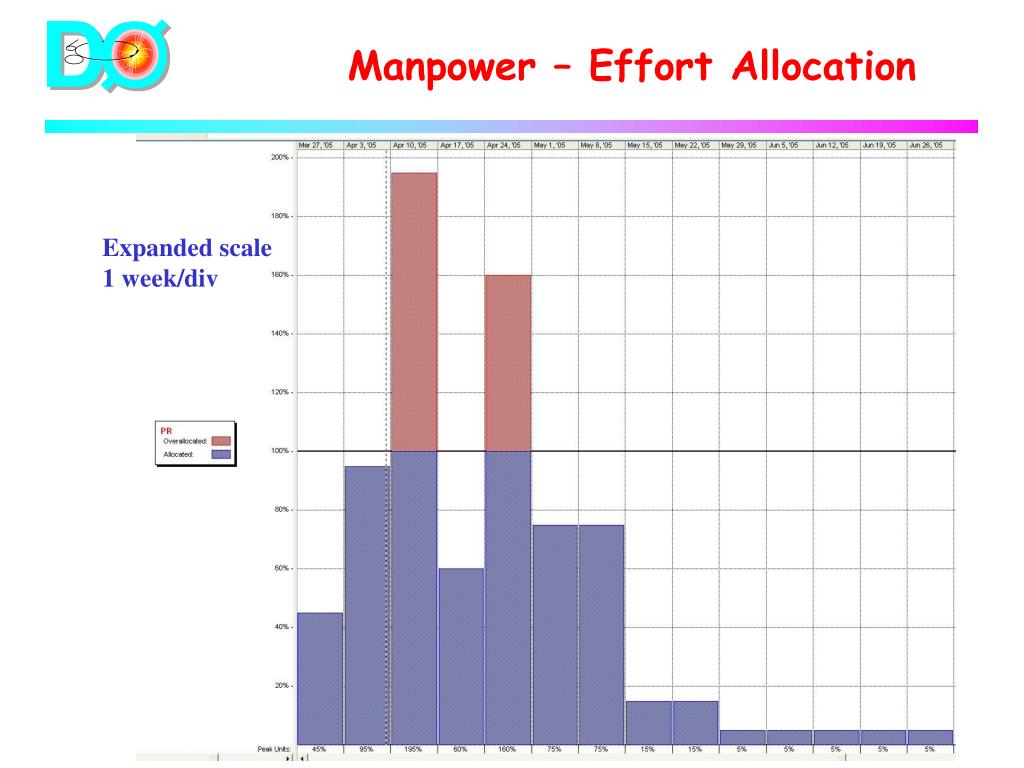

  14. Manpower – Effort Allocation Expanded scale 1 week/div

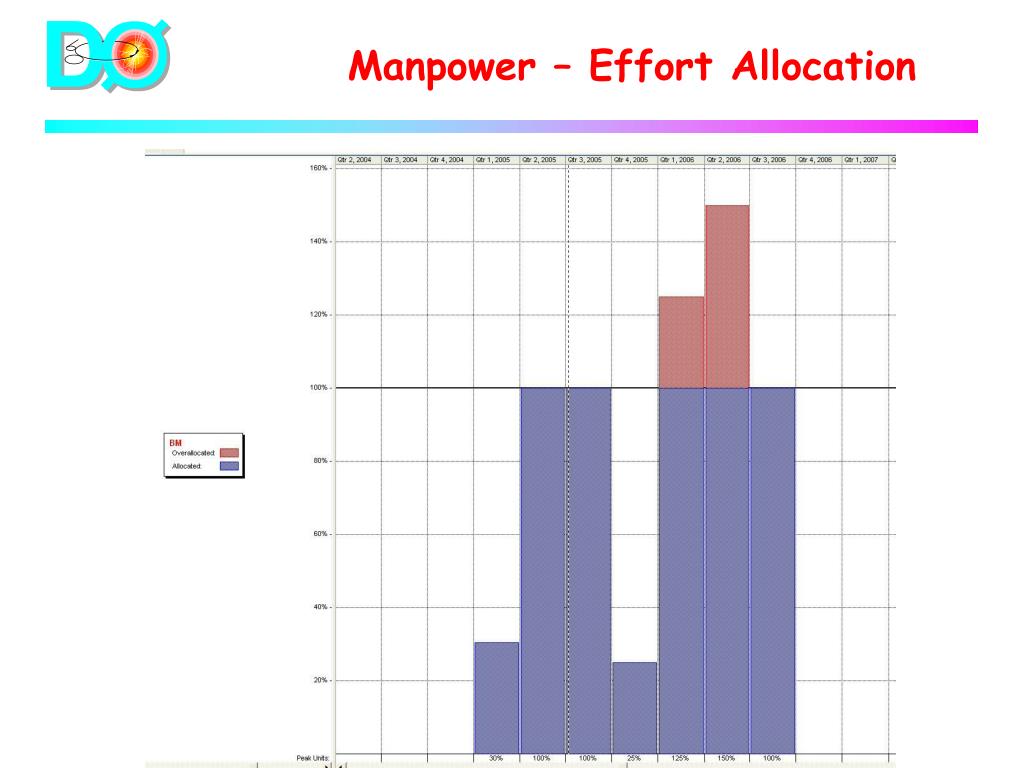

  15. Manpower – Effort Allocation

  16. Manpower Conclusion • Resources are identified and in place • Again except for T/I/C- D0 University involvement • Manpower leveling looks OK • At this time no one appears to be over allocated • At least that we can not deal with • Engineering resources anticipated to remain on the project through commissioning

  17. M & S Profile

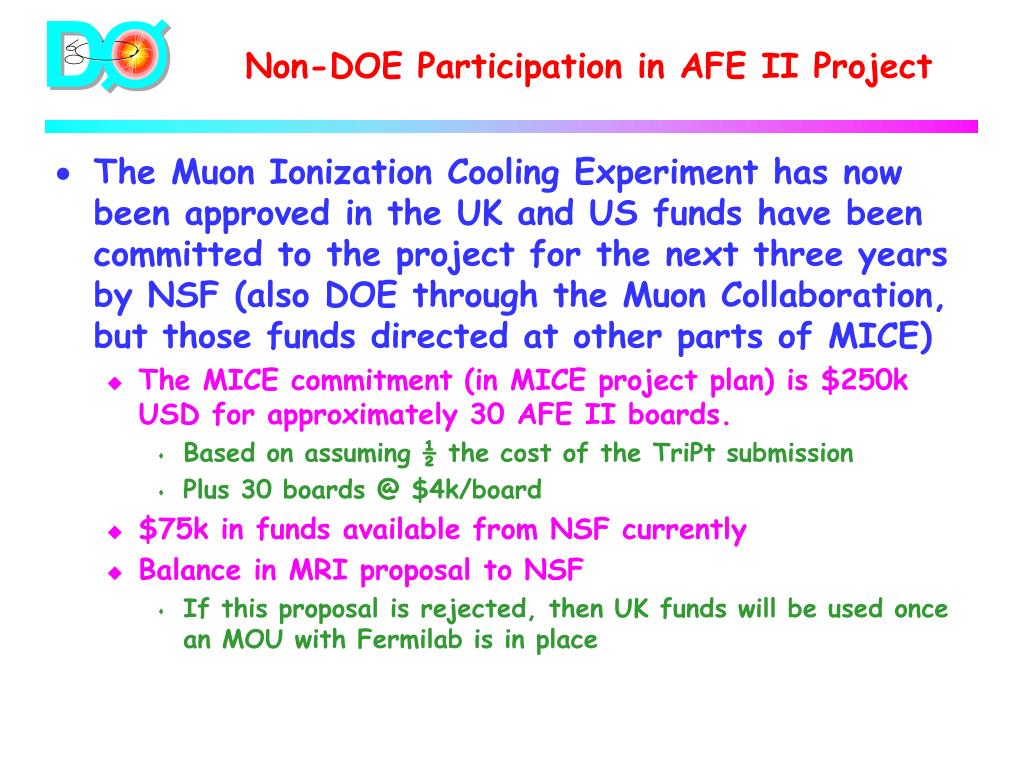

  18. Non-DOE Participation in AFE II Project • The Muon Ionization Cooling Experiment has now been approved in the UK and US funds have been committed to the project for the next three years by NSF (also DOE through the Muon Collaboration, but those funds directed at other parts of MICE) • The MICE commitment (in MICE project plan) is $250k USD for approximately 30 AFE II boards. • Based on assuming ½ the cost of the TriPt submission • Plus 30 boards @ $4k/board • $75k in funds available from NSF currently • Balance in MRI proposal to NSF • If this proposal is rejected, then UK funds will be used once an MOU with Fermilab is in place

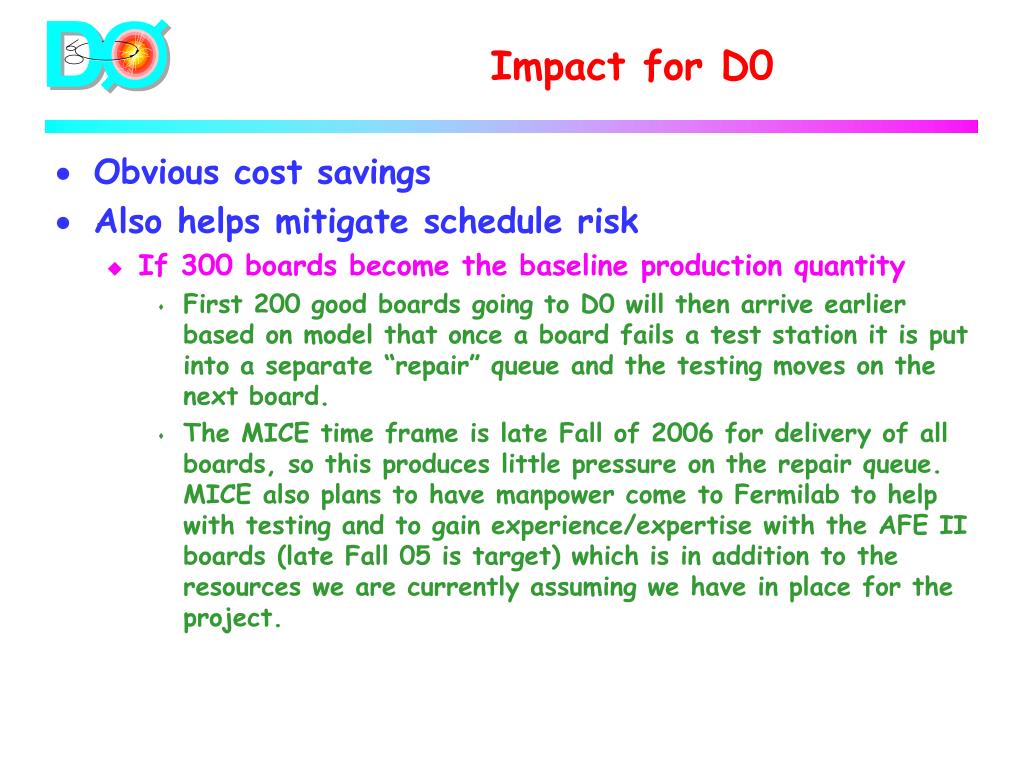

  19. Impact for D0 • Obvious cost savings • Also helps mitigate schedule risk • If 300 boards become the baseline production quantity • First 200 good boards going to D0 will then arrive earlier based on model that once a board fails a test station it is put into a separate “repair” queue and the testing moves on the next board. • The MICE time frame is late Fall of 2006 for delivery of all boards, so this produces little pressure on the repair queue. MICE also plans to have manpower come to Fermilab to help with testing and to gain experience/expertise with the AFE II boards (late Fall 05 is target) which is in addition to the resources we are currently assuming we have in place for the project.

  20. Cost & Schedule - Conclusion • No technical issues have been discovered to date that would impact either cost or schedule • Or our philosophy/model regarding Test and Commissioning • M&S and manpower costs are well understood • The contingency (M&S and manpower) in the project plan is conservative • There is no schedule contingency in the project • 4 w possible if Vendor Qualification of AFE II production is deemed unnecessary • Non-DOE help may be forthcoming • Manpower is on board
