An Image/Link below is provided (as is) to download presentation Download Policy: Content on the Website is provided to you AS IS for your information and personal use and may not be sold / licensed / shared on other websites without getting consent from its author. Content is provided to you AS IS for your information and personal use only. Download presentation by click this link. While downloading, if for some reason you are not able to download a presentation, the publisher may have deleted the file from their server. During download, if you can't get a presentation, the file might be deleted by the publisher.

E N D

Presentation Transcript


  1. Preliminary BaselinePreparations for CD-2 IPR/EIR Jim Yeck, Deputy Project Director NSLS-II PAC Meeting May 24-25, 2007 pp

  2. Outline CD-2 and EIR Requirements Performance Baseline Development Plan WBS Changes Schedule Development Proposed Cost Baseline and Funding Plan Summary & Issues

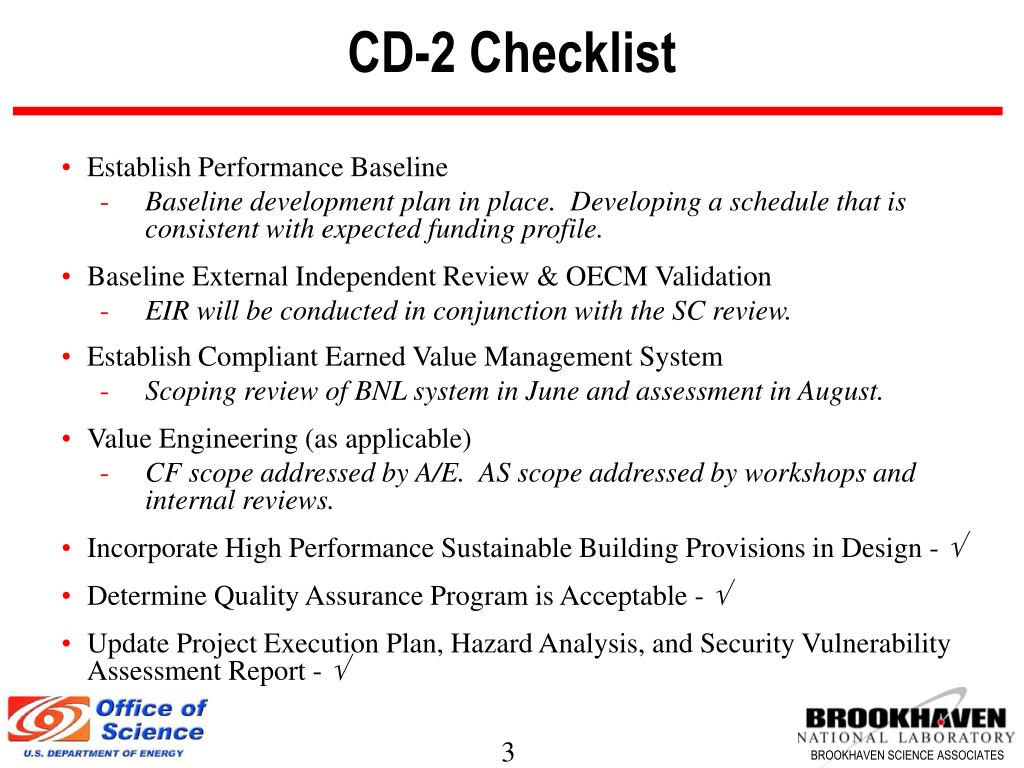

  3. CD-2 Checklist • Establish Performance Baseline -Baseline development plan in place. Developing a schedule that is consistent with expected funding profile. • Baseline External Independent Review & OECM Validation • EIR will be conducted in conjunction with the SC review. • Establish Compliant Earned Value Management System -Scoping review of BNL system in June and assessment in August. • Value Engineering (as applicable) -CF scope addressed by A/E. AS scope addressed by workshops and internal reviews. • Incorporate High Performance Sustainable Building Provisions in Design -  • Determine Quality Assurance Program is Acceptable -  • Update Project Execution Plan, Hazard Analysis, and Security Vulnerability Assessment Report - 

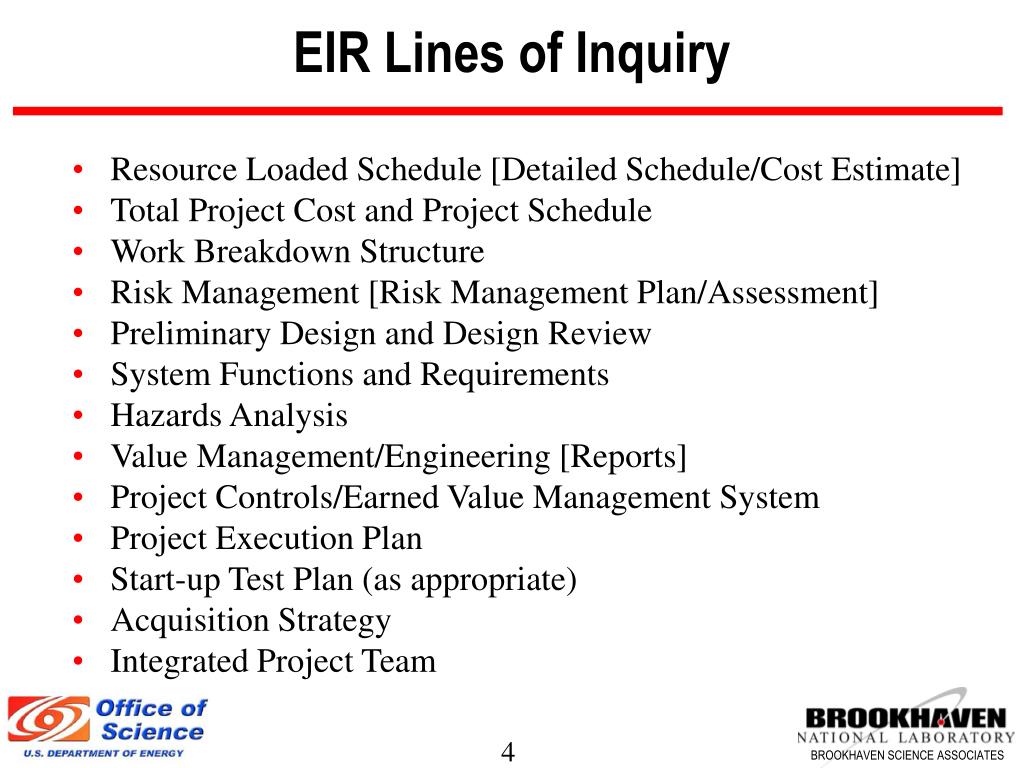

  4. EIR Lines of Inquiry • Resource Loaded Schedule [Detailed Schedule/Cost Estimate] • Total Project Cost and Project Schedule • Work Breakdown Structure • Risk Management [Risk Management Plan/Assessment] • Preliminary Design and Design Review • System Functions and Requirements • Hazards Analysis • Value Management/Engineering [Reports] • Project Controls/Earned Value Management System • Project Execution Plan • Start-up Test Plan (as appropriate) • Acquisition Strategy • Integrated Project Team

  5. CD-2 Baseline Development Plan • Complete WBS & Scope Changes March 30 • Complete Lattice Design Change (Footprint) May 4 • Complete Integrated Schedule & Start Cost Update May 18 • SC Status Review, Confirm CD-2 Review Plans May 22 • Review Performance Measurement Baseline (PMB) Aug. 24 • Conduct Final Review of the NSLS-II PMB September 21 • Start CD-2 Review Preparation October 1 • Establish Performance Baseline October 12 • CD-2 Review & EIR November 6-9

  6. Revised WBS Structure

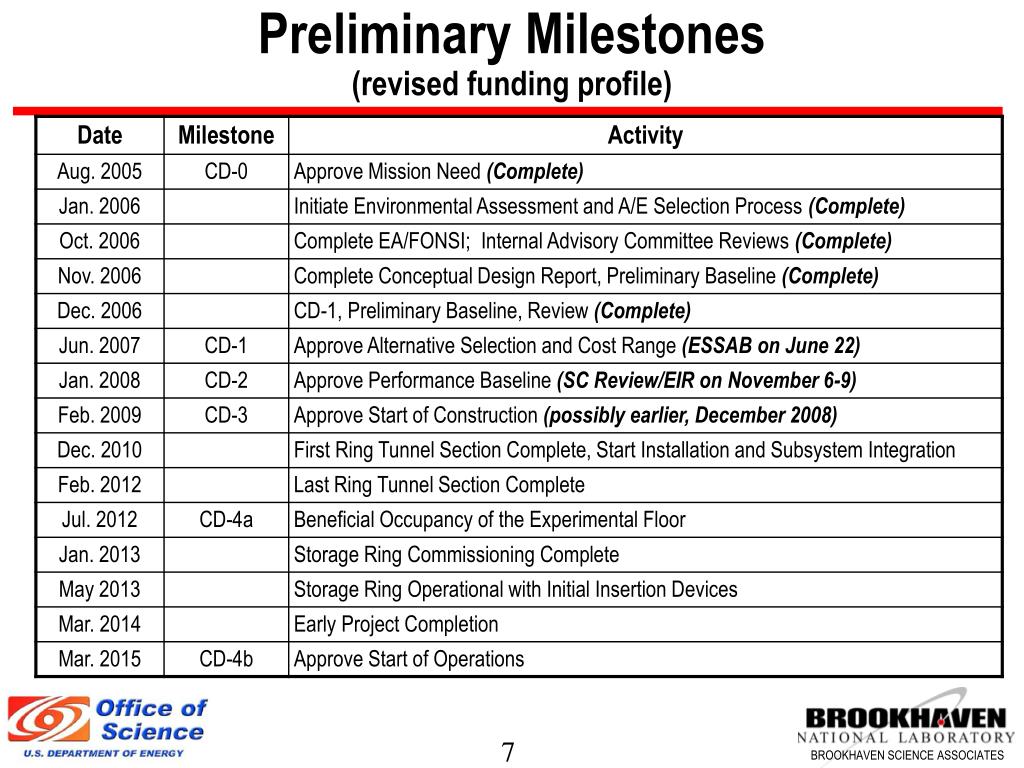

  7. Preliminary Milestones(revised funding profile)

  8. Completion Milestones • Critical Decision 4a, Approve Beneficial Occupancy of the Experimental Floor • Approval of CD-4a authorizes the beneficial occupancy of the experimental floor for the purposes of installing and commissioning beamlines and equipment, and starting initial operation of the NSLS-II storage ring following its commissioning. CD-4a is approved by the PSO. • Critical Decision 4b, Approve Start of Operations • Project completion (CD-4b) will be accomplished when the commissioning goals, which will be developed to support approval of CD-2, have been achieved. Prior to operations, a period of commissioning and performance testing for NSLS-II will be completed as technical systems and facilities are installed. When all capital facilities necessary to achieve the Project Completion Performance Parameters listed in Table 4.4.1 have been installed and certified to operate properly and safely, the project and DOE managers will recommend facility acceptance. CD-4b is approved by the SAE.

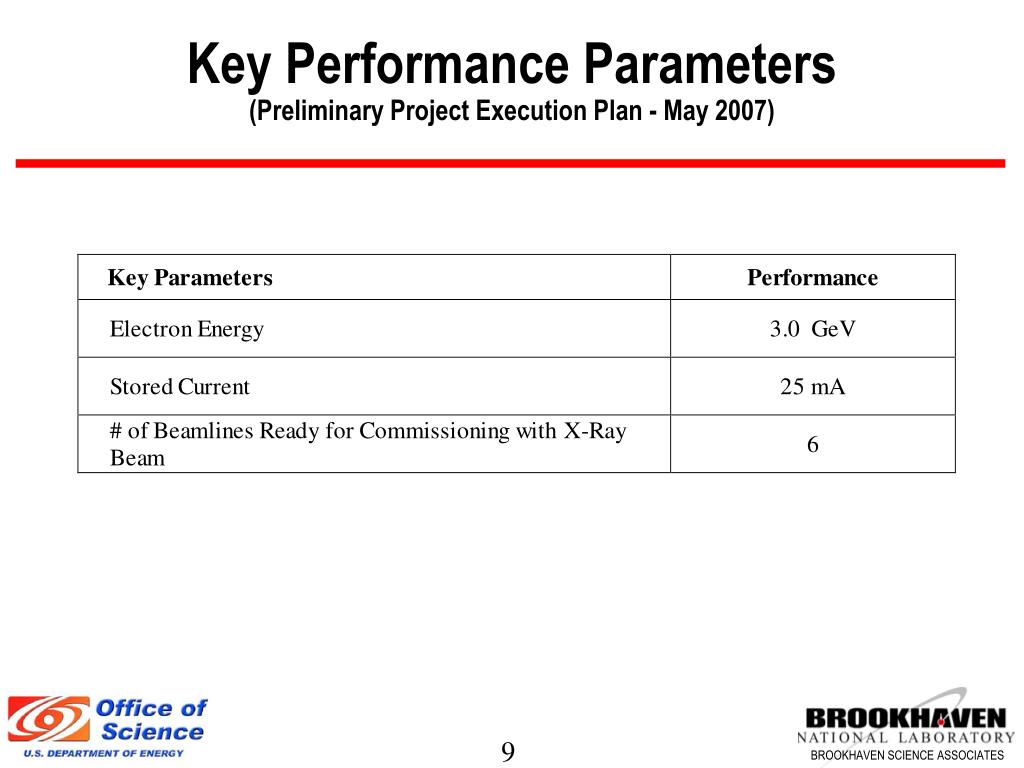

  9. Key Performance Parameters(Preliminary Project Execution Plan - May 2007)

  10. Summary Schedule(revised funding profile)

  11. Preliminary Cost Estimate(revised funding profile) Cost ($ millions)

  12. Revised Funding Profile

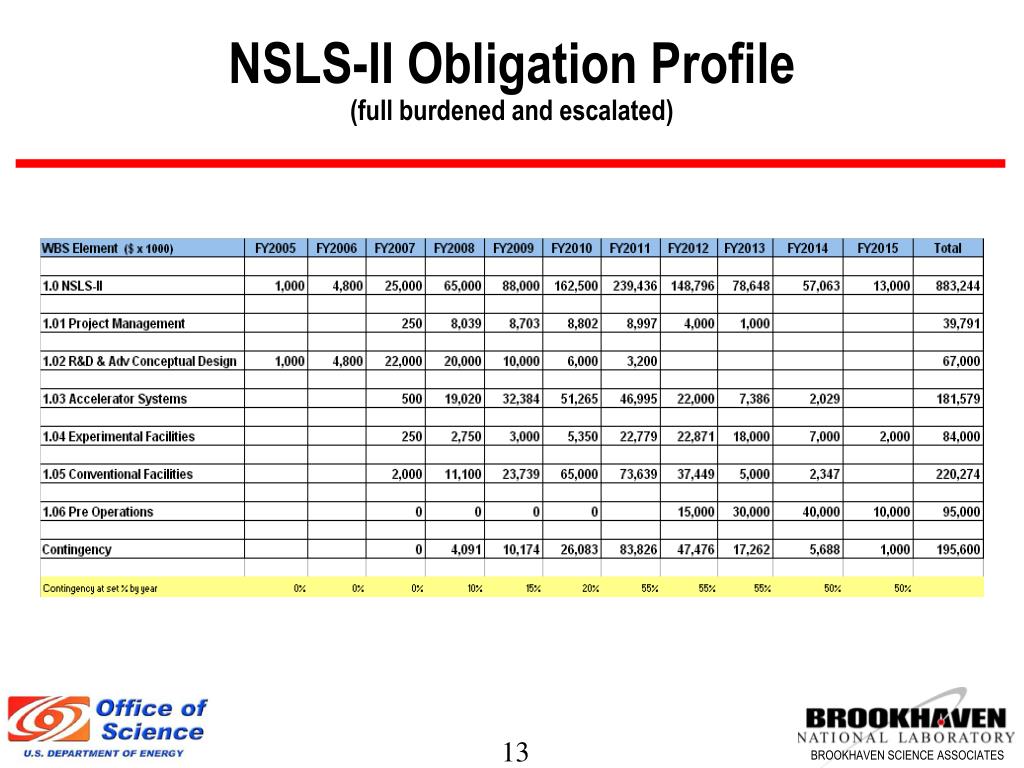

  13. NSLS-II Obligation Profile(full burdened and escalated)

  14. Summary/Issues • Aggressive Schedule for Establishing the NSLS-II PMB • Preliminary design timeline shortened due to FY2007 CR and timeline for FY2009 construction budget submission • PMB will be defined at less than 5% complete • NSLS-II Team will prepare a solid PMB for the CD-2/EIR reviews • Relatively stable technical baseline at an early stage • Experienced team in place • Robust contingency and schedule float • Issues • Additional changes and value engineering following establishment of the PMB and the CD-2 review • Construction activities must start in FY2009 as currently planned
